Caldwell Presbyterian Hearth Project January 2021 Update

caldwell presbyterian hearth project n.w
1 / 8
Embed
Share

Stay updated on the progress of the Caldwell Presbyterian Hearth Project with the latest activities, schedules, completed tasks, upcoming plans, and opportunities to participate in decision-making. View images, timelines, and join the Hearth Committee to get involved in material, fabric, and color choices. Stay informed and engaged with the project by accessing on-site cameras and contacting project leads for questions or to join the committee.

  • Caldwell Presbyterian
  • Hearth Project
  • Update
  • Decision Making
  • Progress

Uploaded on | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. CALDWELL PRESBYTERIAN HEARTH PROJECT JANUARY 2021 UPDATE

  2. WEST ELEVATION AS SEEN FROM PARK DRIVE

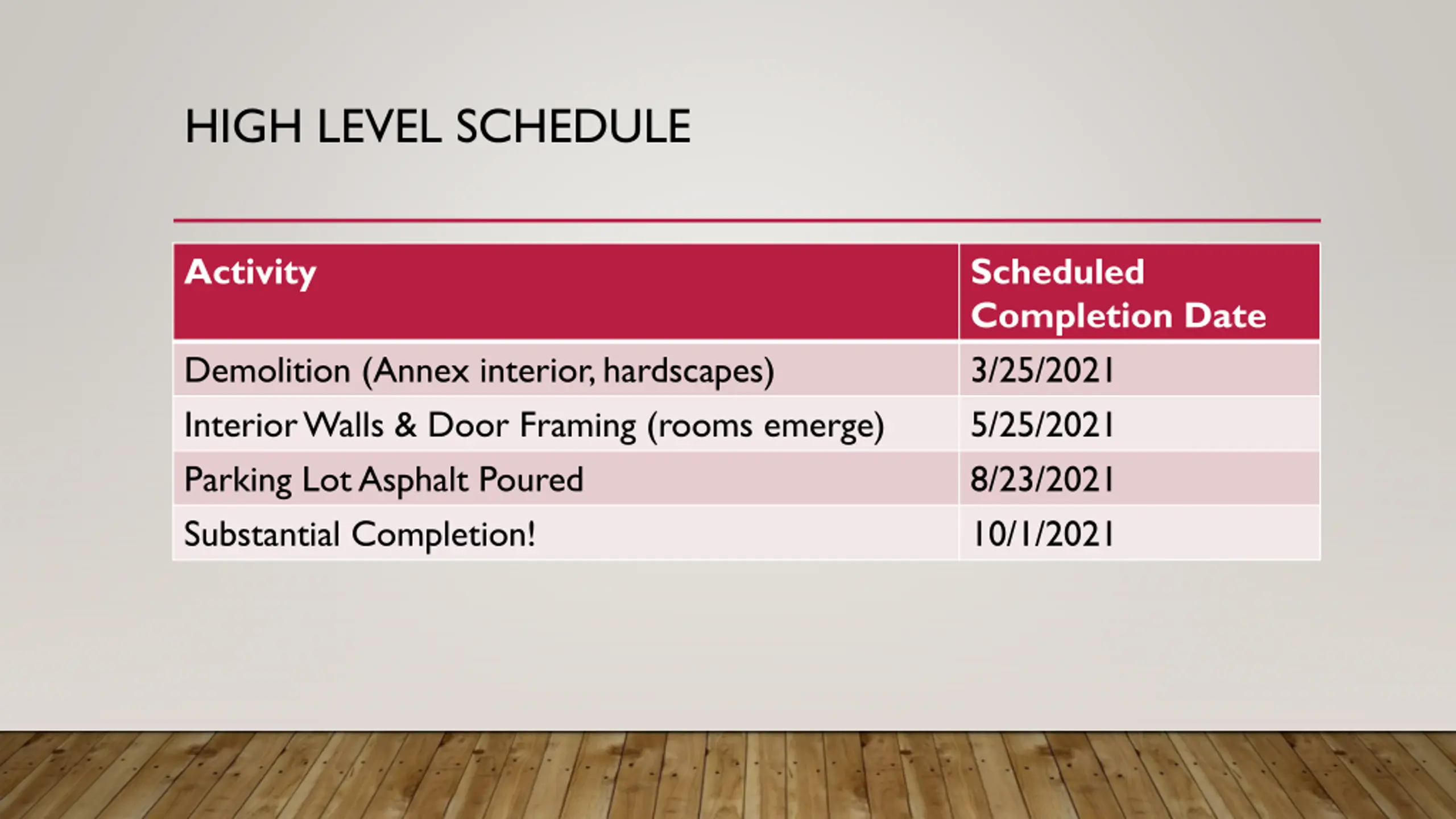

  3. HIGH LEVEL SCHEDULE Activity Scheduled Completion Date 3/25/2021 5/25/2021 8/23/2021 10/1/2021 Demolition (Annex interior, hardscapes) Interior Walls & Door Framing (rooms emerge) Parking Lot Asphalt Poured Substantial Completion!

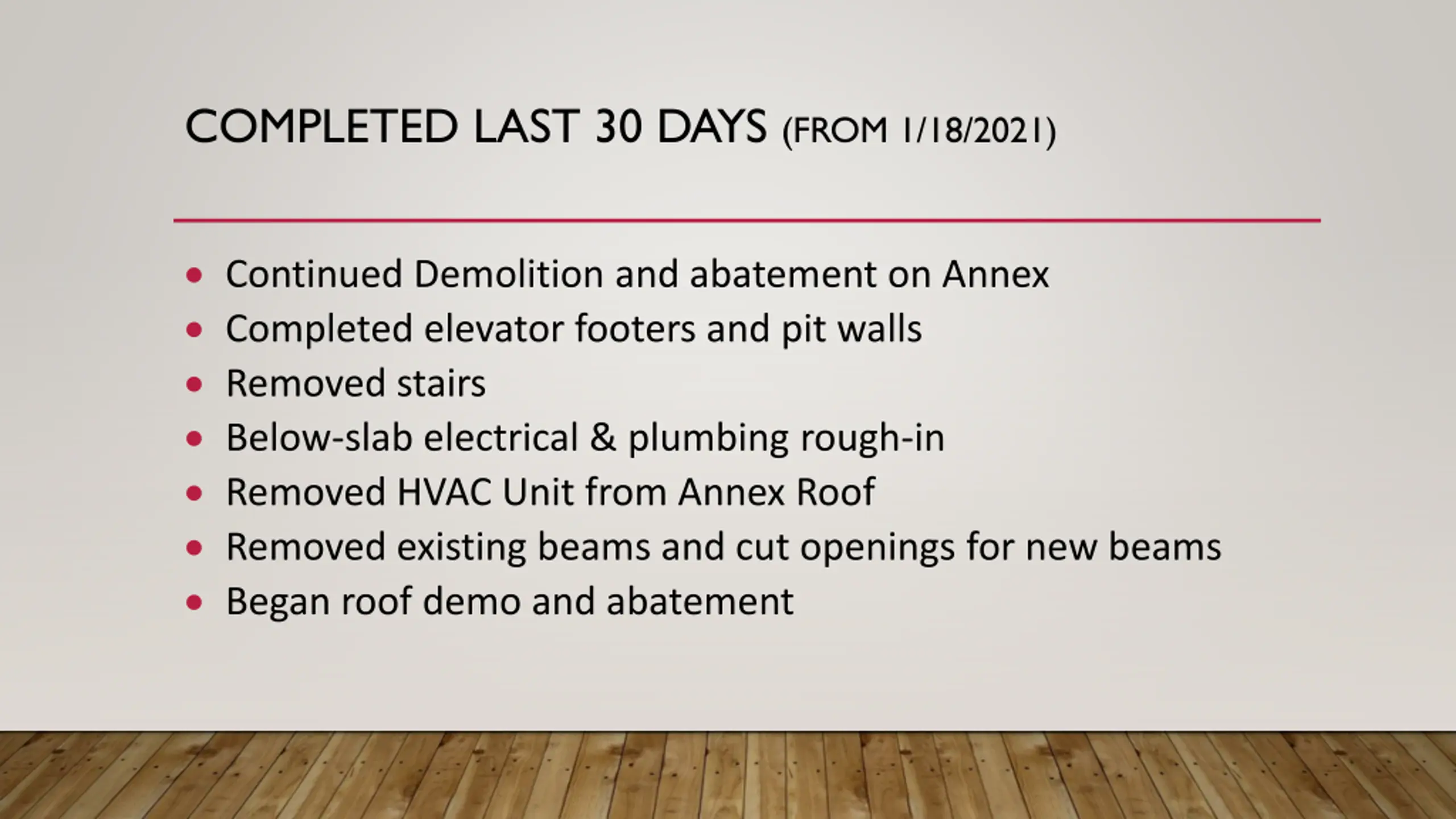

  4. COMPLETED LAST 30 DAYS (FROM 1/18/2021) Continued Demolition and abatement on Annex Completed elevator footers and pit walls Removed stairs Below-slab electrical & plumbing rough-in Removed HVAC Unit from Annex Roof Removed existing beams and cut openings for new beams Began roof demo and abatement

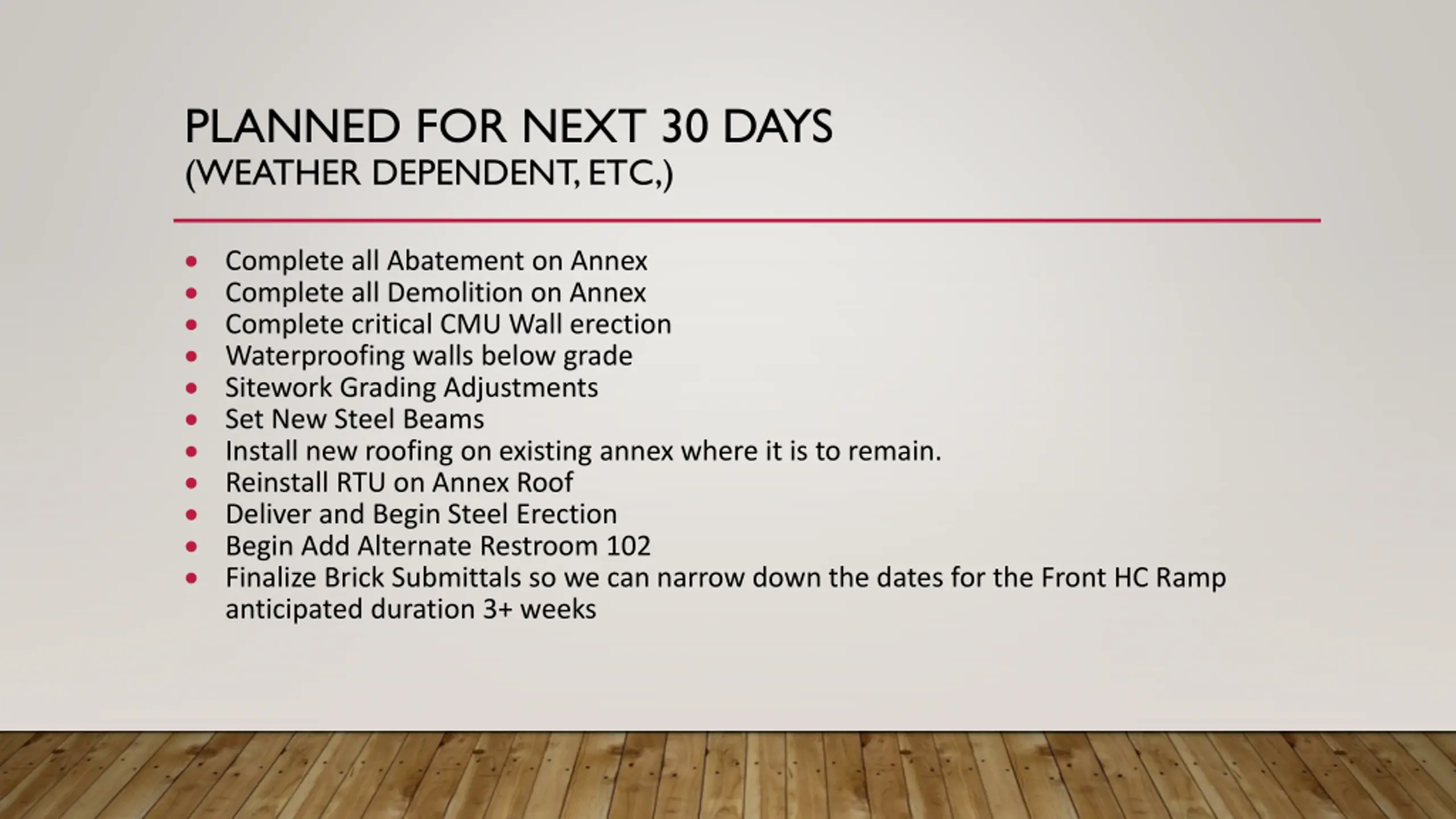

  5. PLANNED FOR NEXT 30 DAYS (WEATHER DEPENDENT, ETC,) Complete all Abatement on Annex Complete all Demolition on Annex Complete critical CMU Wall erection Waterproofing walls below grade Sitework Grading Adjustments Set New Steel Beams Install new roofing on existing annex where it is to remain. Reinstall RTU on Annex Roof Deliver and Begin Steel Erection Begin Add Alternate Restroom 102 Finalize Brick Submittals so we can narrow down the dates for the Front HC Ramp anticipated duration 3+ weeks

  6. KITCHEN

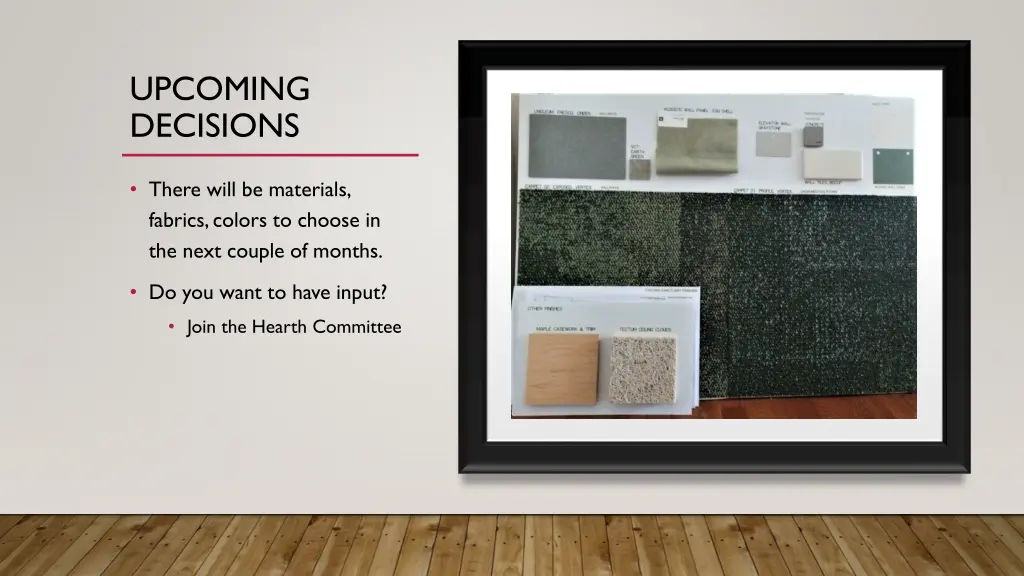

  7. UPCOMING DECISIONS There will be materials, fabrics, colors to choose in the next couple of months. Do you want to have input? Join the Hearth Committee

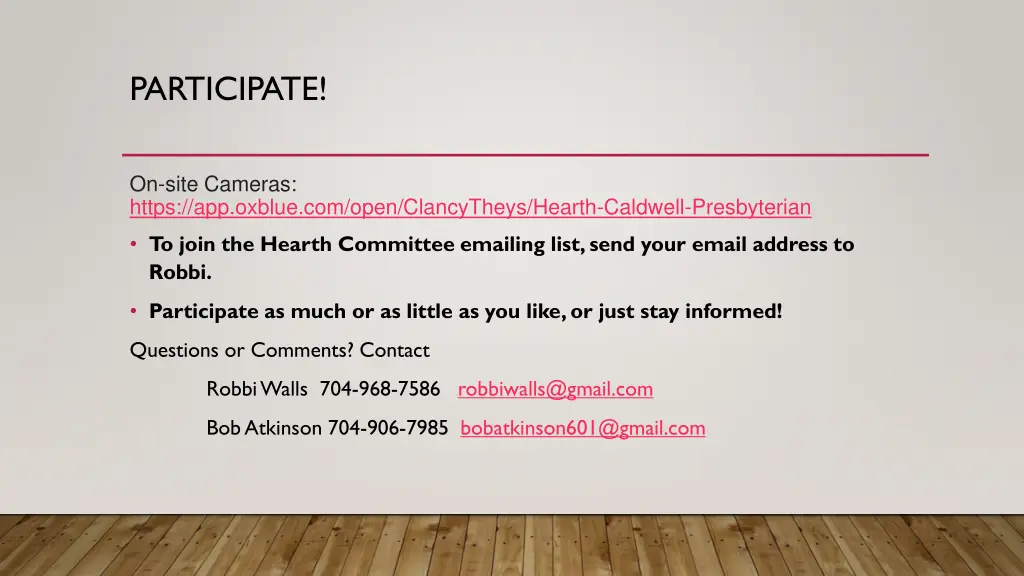

  8. PARTICIPATE! On-site Cameras: https://app.oxblue.com/open/ClancyTheys/Hearth-Caldwell-Presbyterian To join the Hearth Committee emailing list, send your email address to Robbi. Participate as much or as little as you like, or just stay informed! Questions or Comments? Contact Robbi Walls 704-968-7586 robbiwalls@gmail.com Bob Atkinson 704-906-7985 bobatkinson601@gmail.com
