Core Projects and Building Upgrades Summary

Core Projects and Building Upgrades Summary
Slide Note
Embed
Share

This document outlines the core projects and selected building facts at the university, highlighting buildings with high student impact and deferred maintenance costs. It also details the inclusive upgrades planned for major building systems, fire and life safety measures, technology infrastructure, energy efficiency, and more. Additionally, it provides information on colleges, deans, and project updates along with the renovation schedule for specific buildings.

  • Projects
  • Building Upgrades
  • University
  • Maintenance
  • Renovation

Uploaded on Mar 16, 2025 | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. CORE PROJECTS JULY 27, 2018

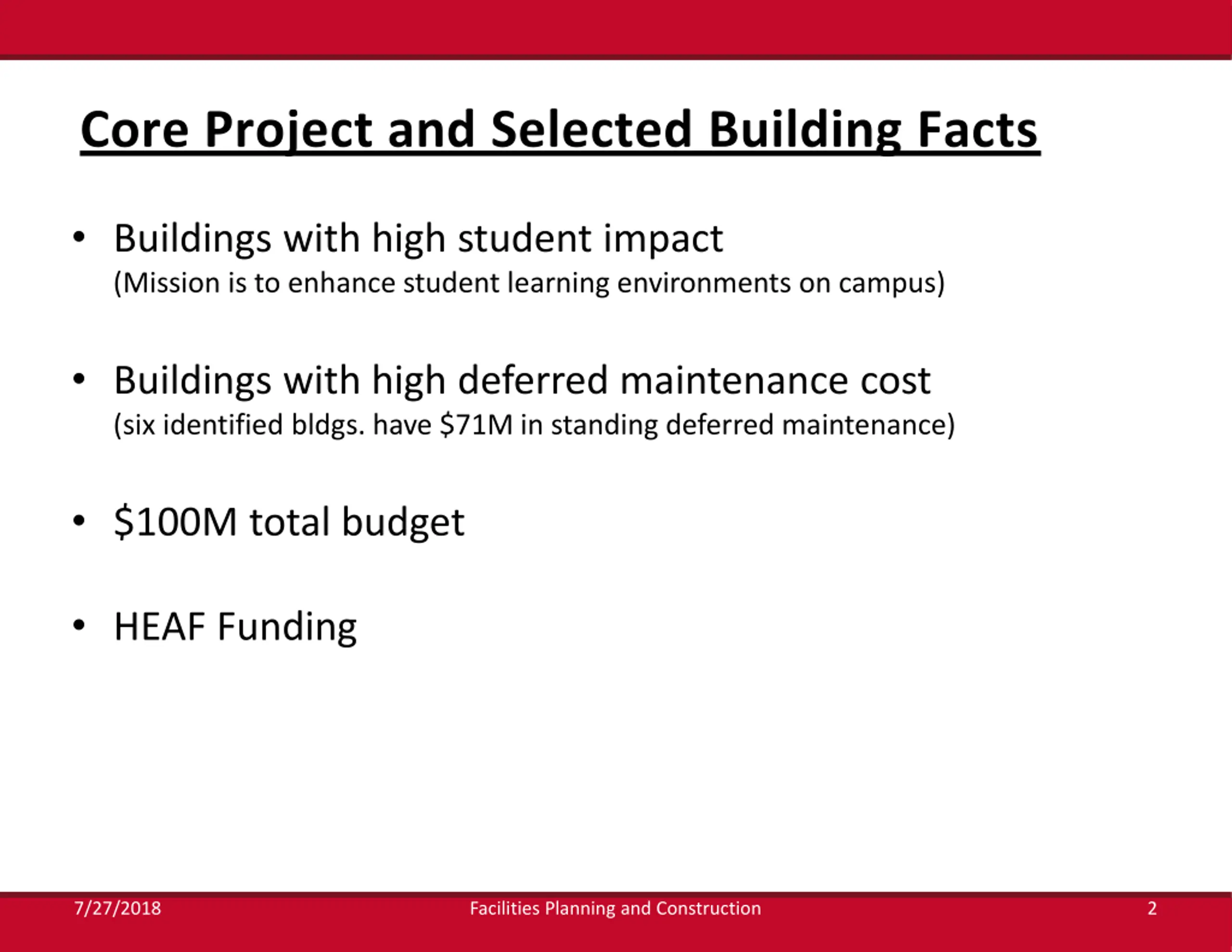

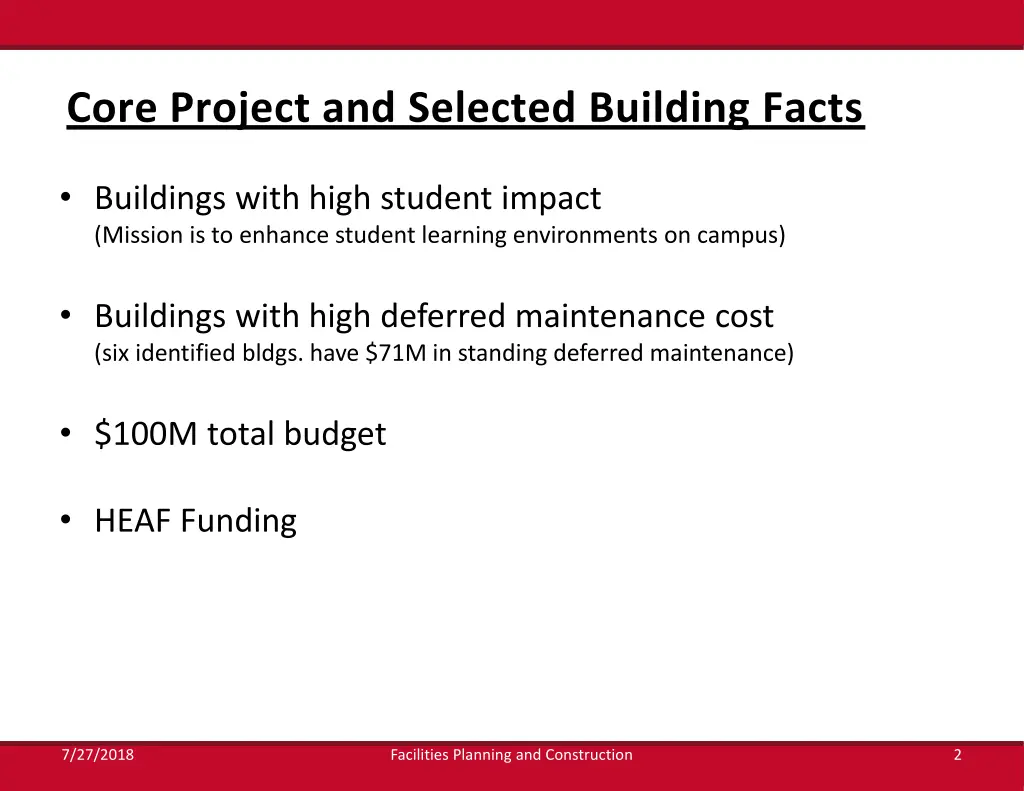

  2. Core Project and Selected Building Facts Buildings with high student impact (Mission is to enhance student learning environments on campus) Buildings with high deferred maintenance cost (six identified bldgs. have $71M in standing deferred maintenance) $100M total budget HEAF Funding 7/27/2018 Facilities Planning and Construction 2

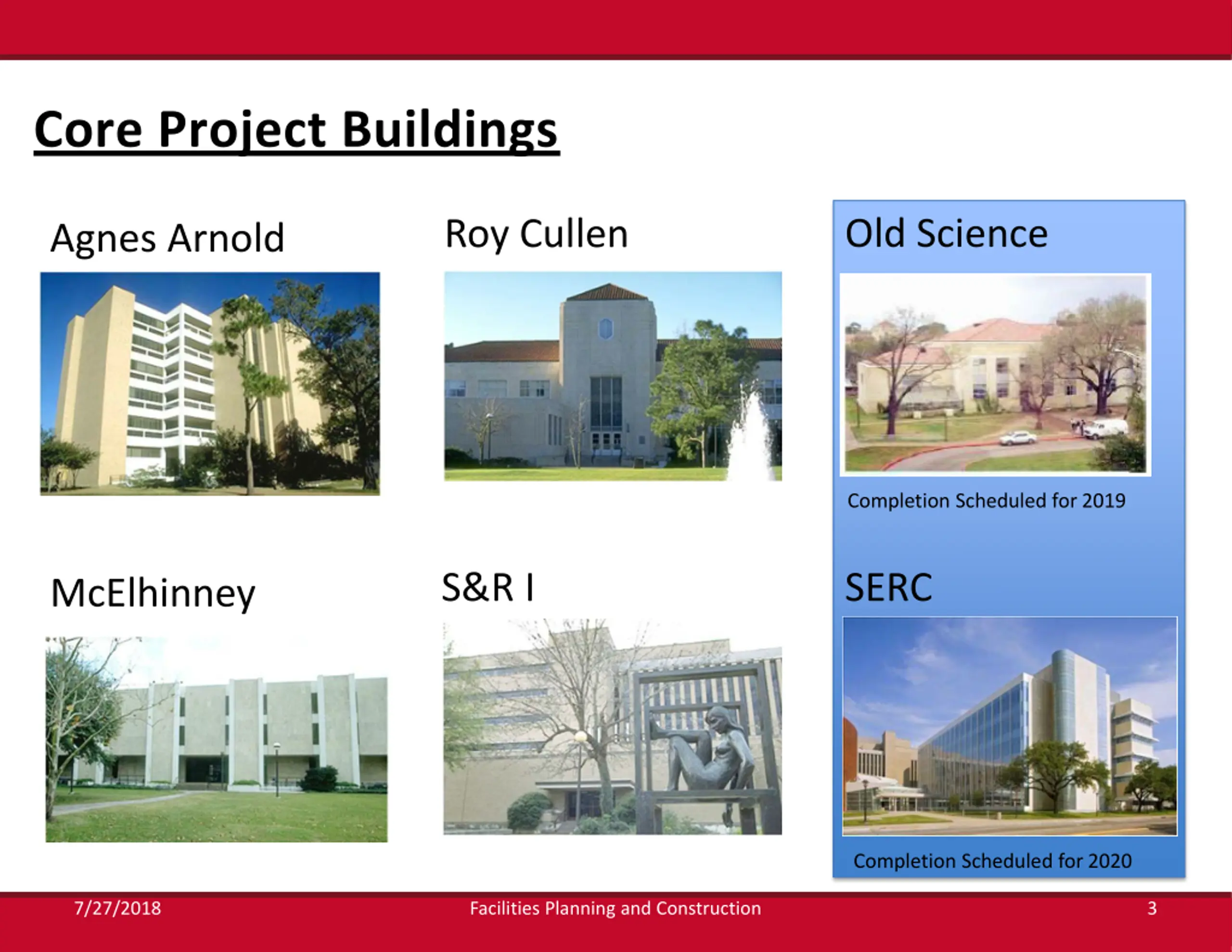

  3. Core Project Buildings Old Science Roy Cullen Agnes Arnold Completion Scheduled for 2019 S&R I SERC McElhinney Completion Scheduled for 2020 7/27/2018 Facilities Planning and Construction 3

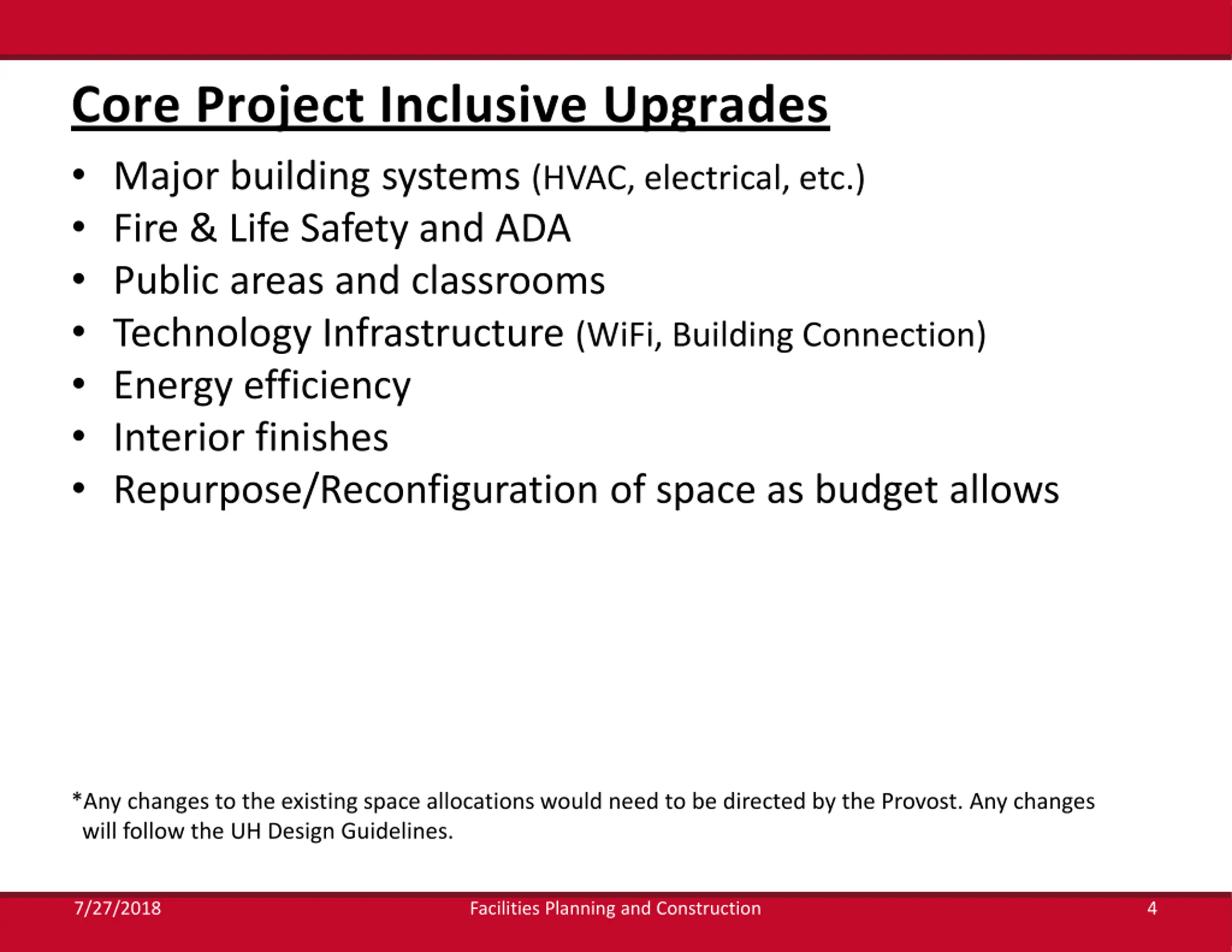

  4. Core Project Inclusive Upgrades Major building systems (HVAC, electrical, etc.) Fire & Life Safety and ADA Public areas and classrooms Technology Infrastructure (WiFi, Building Connection) Energy efficiency Interior finishes Repurpose/Reconfiguration of space as budget allows *Any changes to the existing space allocations would need to be directed by the Provost. Any changes will follow the UH Design Guidelines. 7/27/2018 Facilities Planning and Construction 4

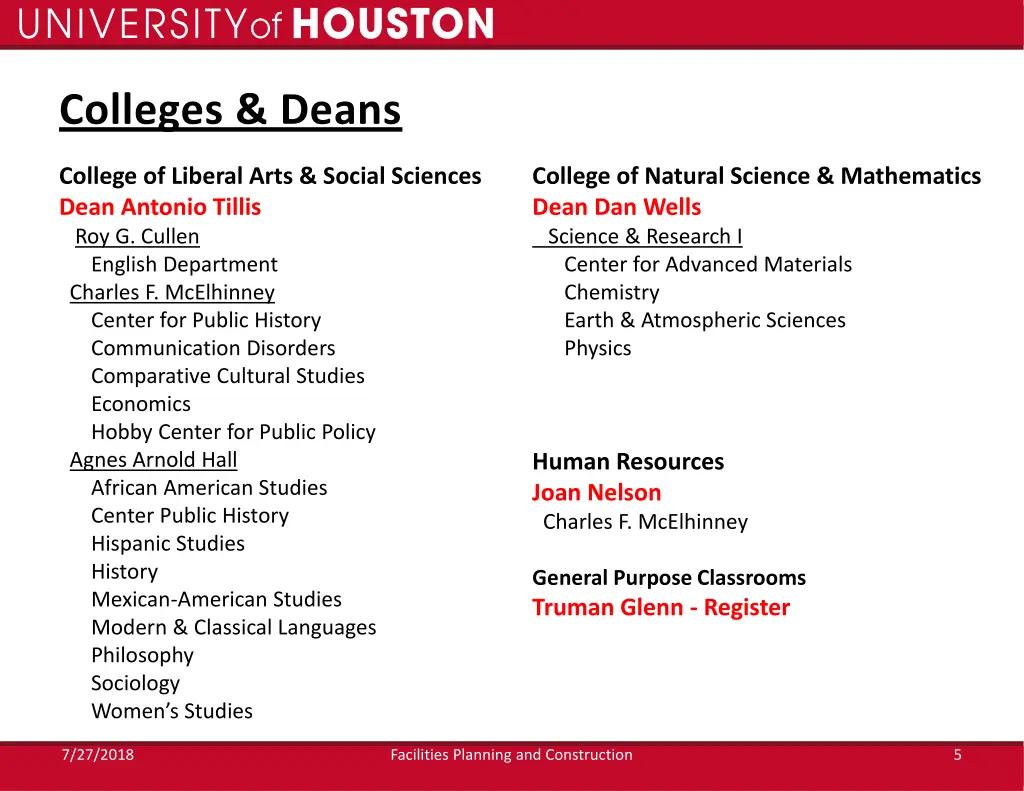

  5. Colleges & Deans College of Liberal Arts & Social Sciences Dean Antonio Tillis Roy G. Cullen English Department Charles F. McElhinney Center for Public History Communication Disorders Comparative Cultural Studies Economics Hobby Center for Public Policy Agnes Arnold Hall African American Studies Center Public History Hispanic Studies History Mexican-American Studies Modern & Classical Languages Philosophy Sociology Women s Studies College of Natural Science & Mathematics Dean Dan Wells Science & Research I Center for Advanced Materials Chemistry Earth & Atmospheric Sciences Physics Human Resources Joan Nelson Charles F. McElhinney General Purpose Classrooms Truman Glenn - Register 7/27/2018 Facilities Planning and Construction 5

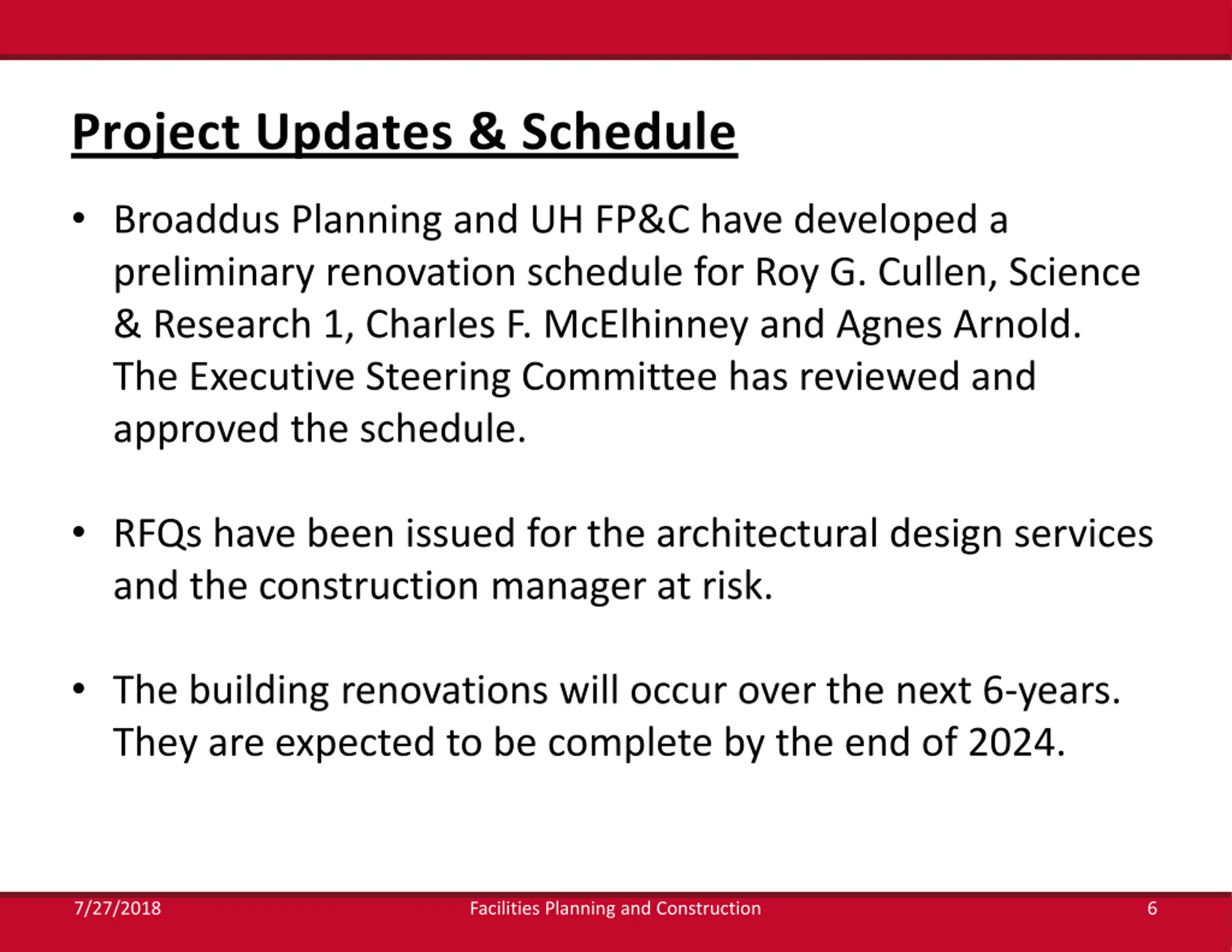

  6. Project Updates & Schedule Broaddus Planning and UH FP&C have developed a preliminary renovation schedule for Roy G. Cullen, Science & Research 1, Charles F. McElhinney and Agnes Arnold. The Executive Steering Committee has reviewed and approved the schedule. RFQs have been issued for the architectural design services and the construction manager at risk. The building renovations will occur over the next 6-years. They are expected to be complete by the end of 2024. 7/27/2018 Facilities Planning and Construction 6

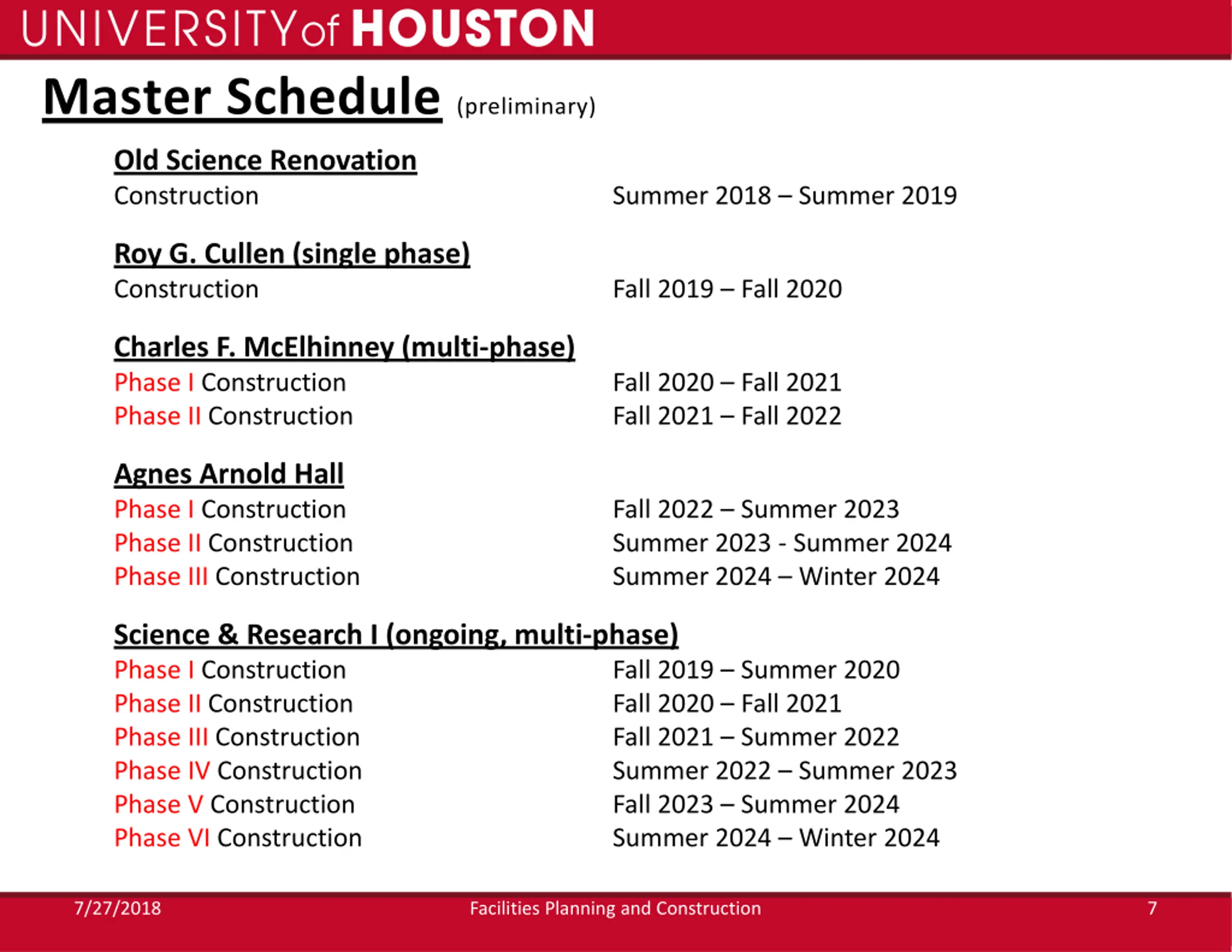

  7. Master Schedule(preliminary) Old Science Renovation Construction Summer 2018 Summer 2019 Roy G. Cullen (single phase) Construction Fall 2019 Fall 2020 Charles F. McElhinney (multi-phase) Phase I Construction Phase II Construction Fall 2020 Fall 2021 Fall 2021 Fall 2022 Agnes Arnold Hall Phase I Construction Phase II Construction Phase III Construction Fall 2022 Summer 2023 Summer 2023 - Summer 2024 Summer 2024 Winter 2024 Science & Research I (ongoing, multi-phase) Phase I Construction Phase II Construction Phase III Construction Phase IV Construction Phase V Construction Phase VI Construction Fall 2019 Summer 2020 Fall 2020 Fall 2021 Fall 2021 Summer 2022 Summer 2022 Summer 2023 Fall 2023 Summer 2024 Summer 2024 Winter 2024 7/27/2018 Facilities Planning and Construction 7
