Create Your Own First Aid Kit with Essential Items

calorimeter installation overview n.w
1 / 7
Embed
Share

Dive into creating your personalized first aid kit to tackle various medical emergencies effectively. Select essential first aid items tailored to your needs and scenarios. Imagine the scenarios where each item comes in handy and build a comprehensive kit for emergency preparedness.

  • First Aid
  • Emergency Preparedness
  • Medical Emergencies
  • First Aid Kit
  • Essential Items

Uploaded on | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. Calorimeter Installation: Overview S. Miscetti, LNF 14 October 2020 Mu2e Italy Assembly/Installation meeting

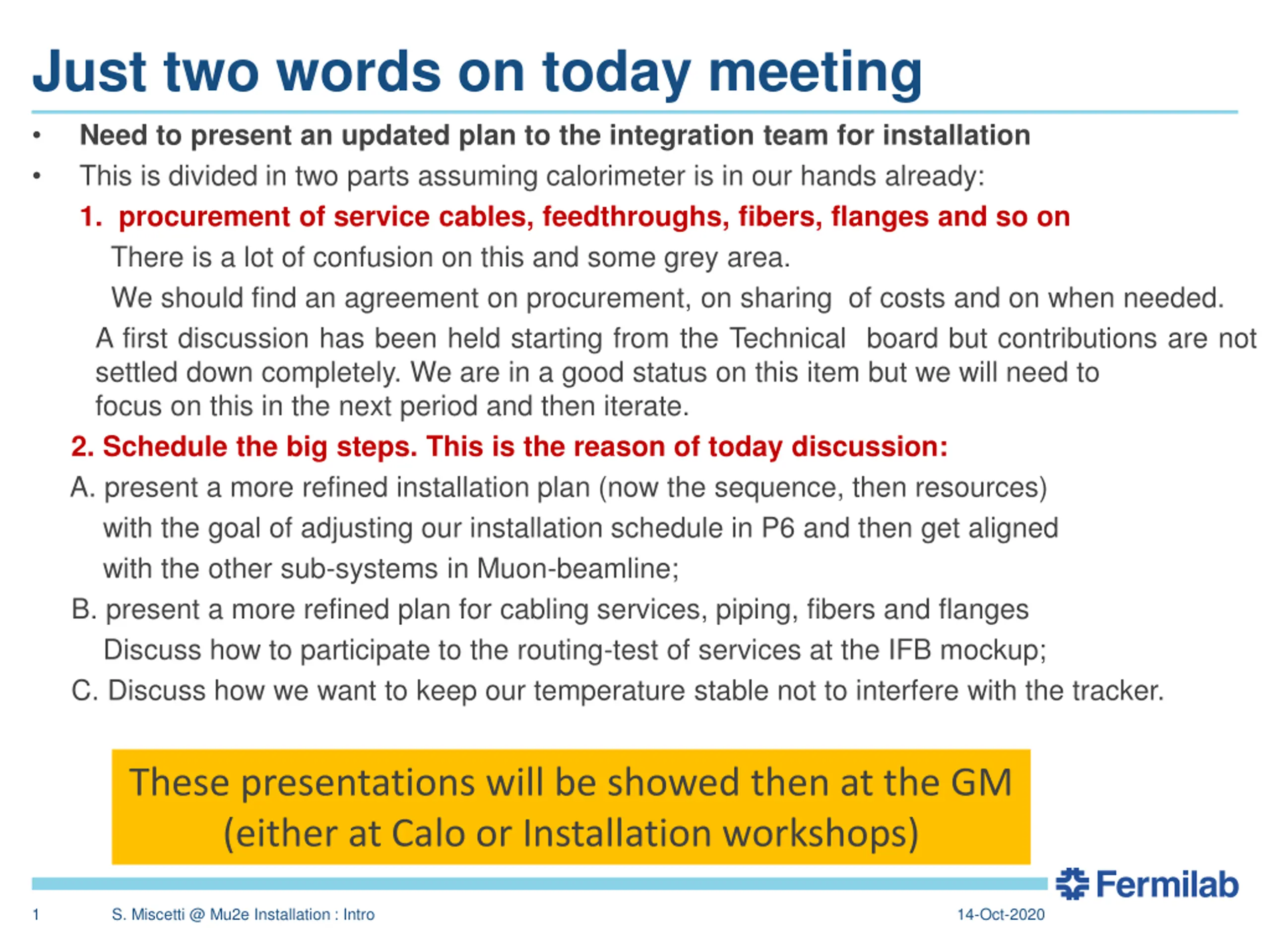

  2. Just two words on today meeting Need to present an updated plan to the integration team for installation This is divided in two parts assuming calorimeter is in our hands already: 1. procurement of service cables, feedthroughs, fibers, flanges and so on There is a lot of confusion on this and some grey area. We should find an agreement on procurement, on sharing of costs and on when needed. A first discussion has been held starting from the Technical board but contributions are not settled down completely. We are in a good status on this item but we will need to focus on this in the next period and then iterate. 2. Schedule the big steps. This is the reason of today discussion: A. present a more refined installation plan (now the sequence, then resources) with the goal of adjusting our installation schedule in P6 and then get aligned with the other sub-systems in Muon-beamline; B. present a more refined plan for cabling services, piping, fibers and flanges Discuss how to participate to the routing-test of services at the IFB mockup; C. Discuss how we want to keep our temperature stable not to interfere with the tracker. These presentations will be showed then at the GM (either at Calo or Installation workshops) 1 S. Miscetti @ Mu2e Installation : Intro 14-Oct-2020

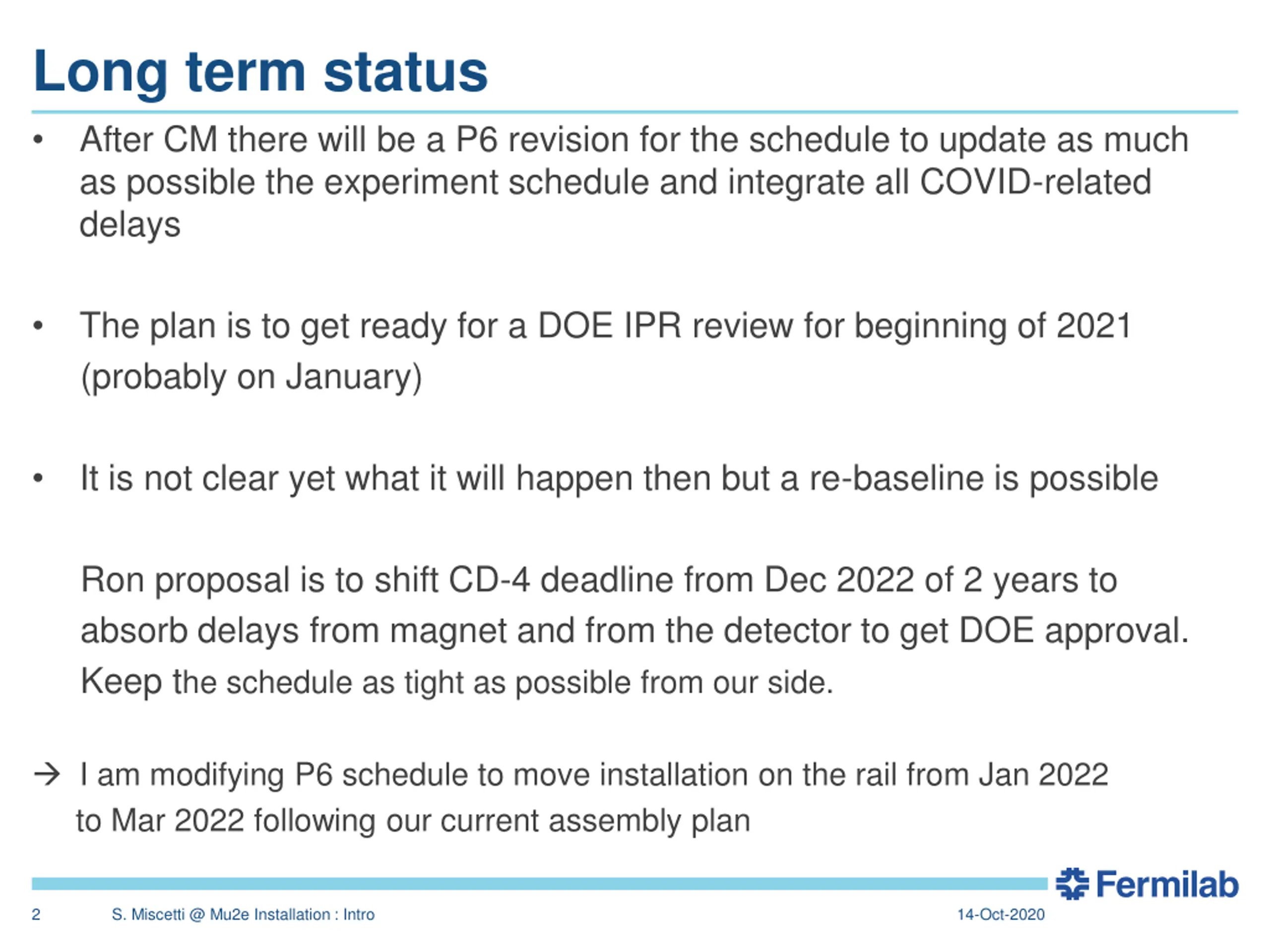

  3. Long term status After CM there will be a P6 revision for the schedule to update as much as possible the experiment schedule and integrate all COVID-related delays The plan is to get ready for a DOE IPR review for beginning of 2021 (probably on January) It is not clear yet what it will happen then but a re-baseline is possible Ron proposal is to shift CD-4 deadline from Dec 2022 of 2 years to absorb delays from magnet and from the detector to get DOE approval. Keep the schedule as tight as possible from our side. I am modifying P6 schedule to move installation on the rail from Jan 2022 to Mar 2022 following our current assembly plan 2 S. Miscetti @ Mu2e Installation : Intro 14-Oct-2020

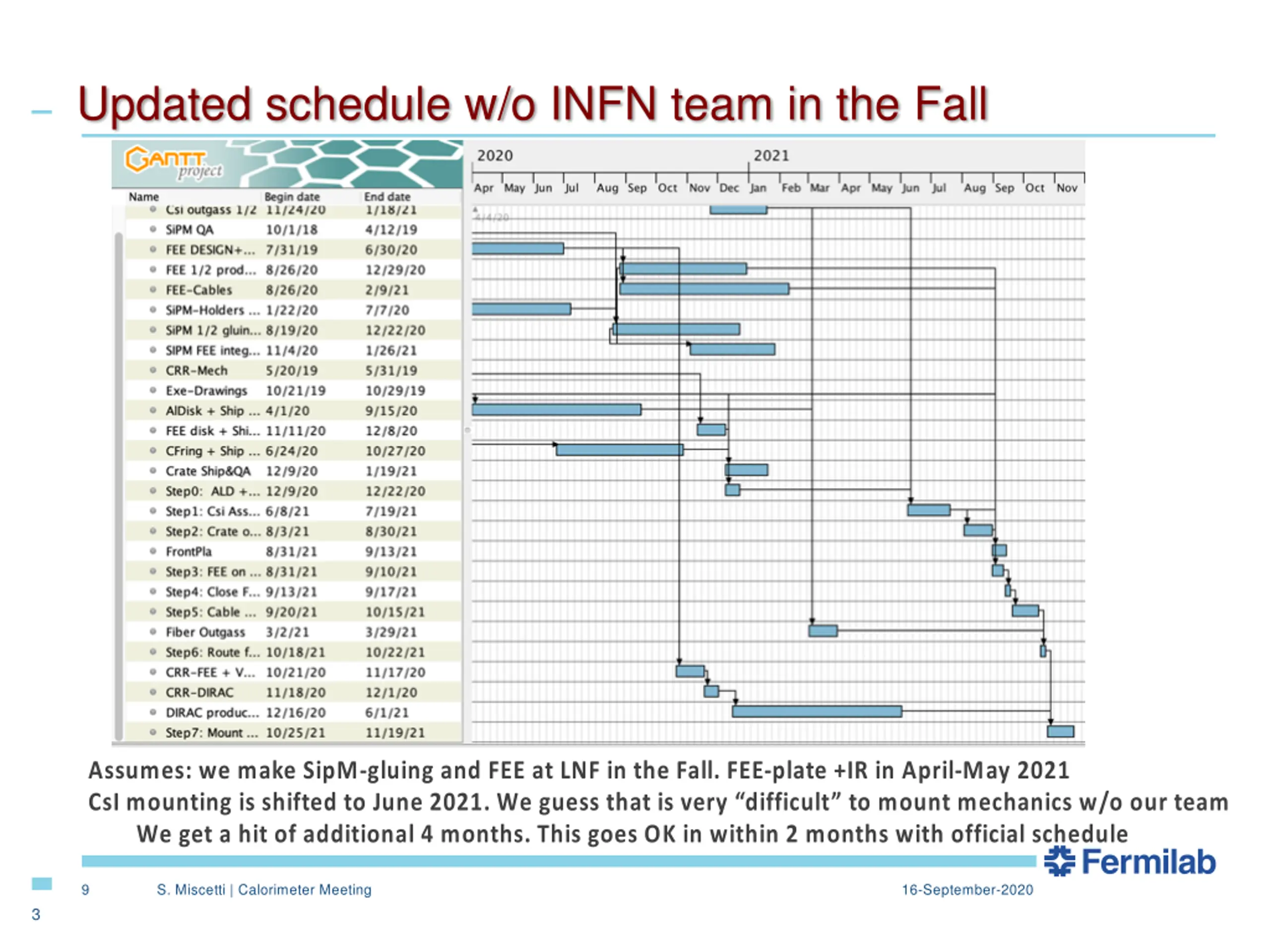

  4. Updated schedule w/o INFN team in the Fall Assumes: we make SipM-gluing and FEE at LNF in the Fall. FEE-plate +IR in April-May 2021 CsI mounting is shifted to June 2021. We guess that is very difficult to mount mechanics w/o our team We get a hit of additional 4 months. This goes OK in within 2 months with official schedule 9 S. Miscetti | Calorimeter Meeting 16-September-2020 3 S. Miscetti @ Mu2e Installation : Intro 14-Oct-2020

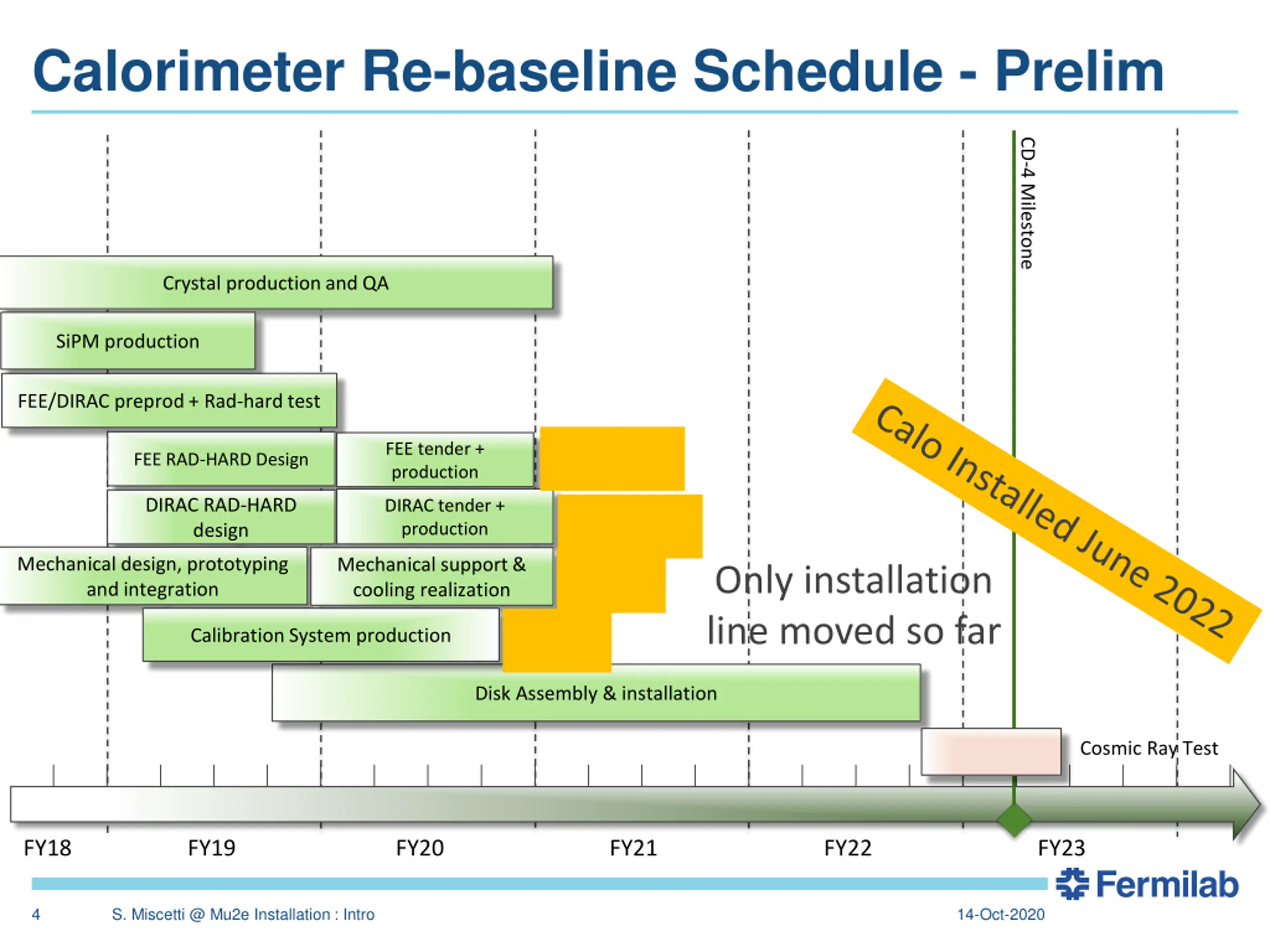

  5. Calorimeter Re-baseline Schedule - Prelim CD-4 Milestone Crystal production and QA SiPM production FEE/DIRAC preprod + Rad-hard test FEE tender + production FEE RAD-HARD Design DIRAC RAD-HARD design DIRAC tender + production Mechanical design, prototyping and integration Mechanical support & cooling realization Only installation line moved so far Calibration System production Disk Assembly & installation Cosmic Ray Test FY18 FY19 FY20 FY21 FY22 FY23 4 S. Miscetti @ Mu2e Installation : Intro 14-Oct-2020

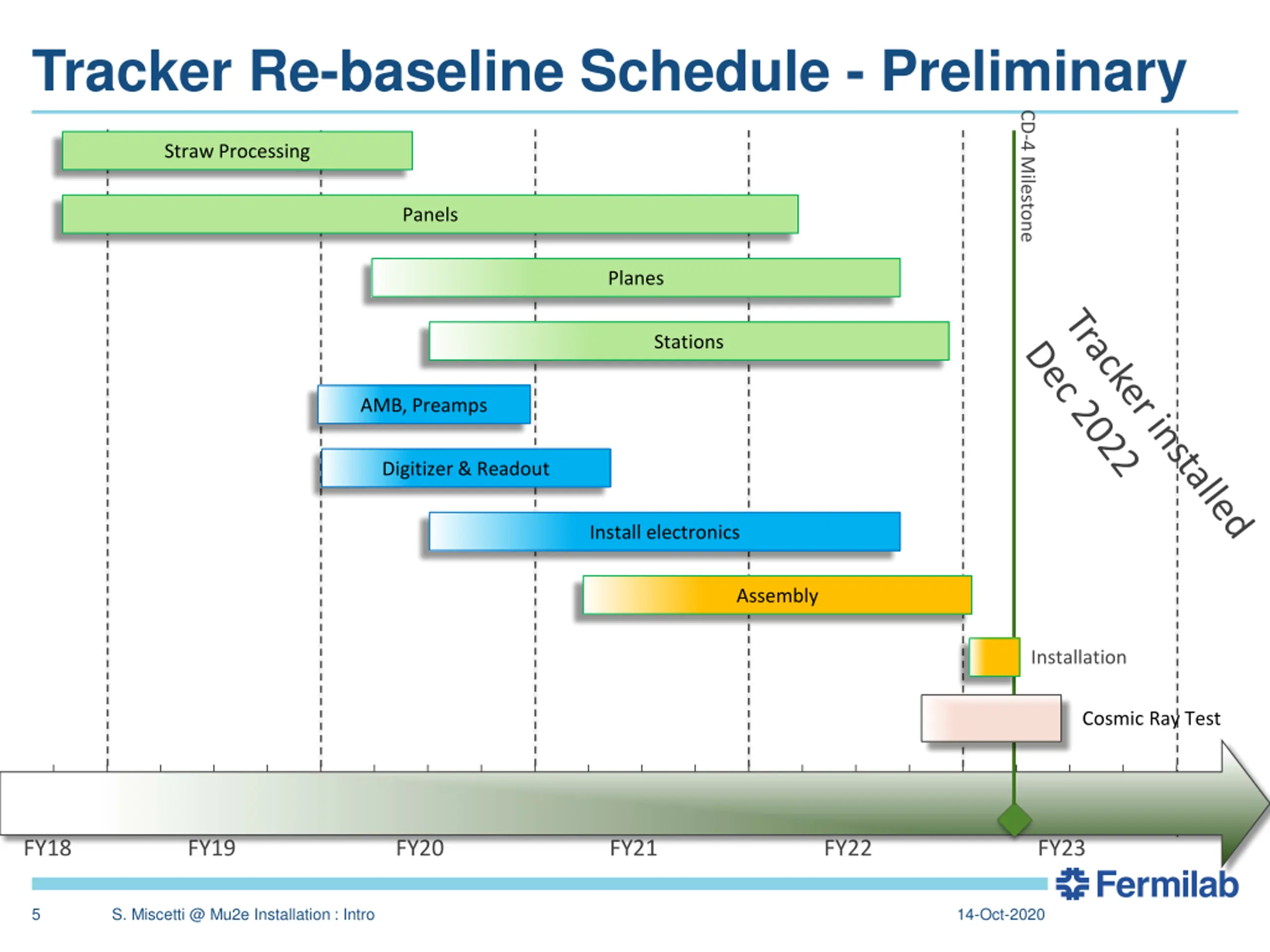

  6. Tracker Re-baseline Schedule - Preliminary CD-4 Milestone Straw Processing Panels Planes Stations AMB, Preamps Digitizer & Readout Install electronics Assembly Installation Cosmic Ray Test FY18 FY19 FY20 FY21 FY22 FY23 5 S. Miscetti @ Mu2e Installation : Intro 14-Oct-2020

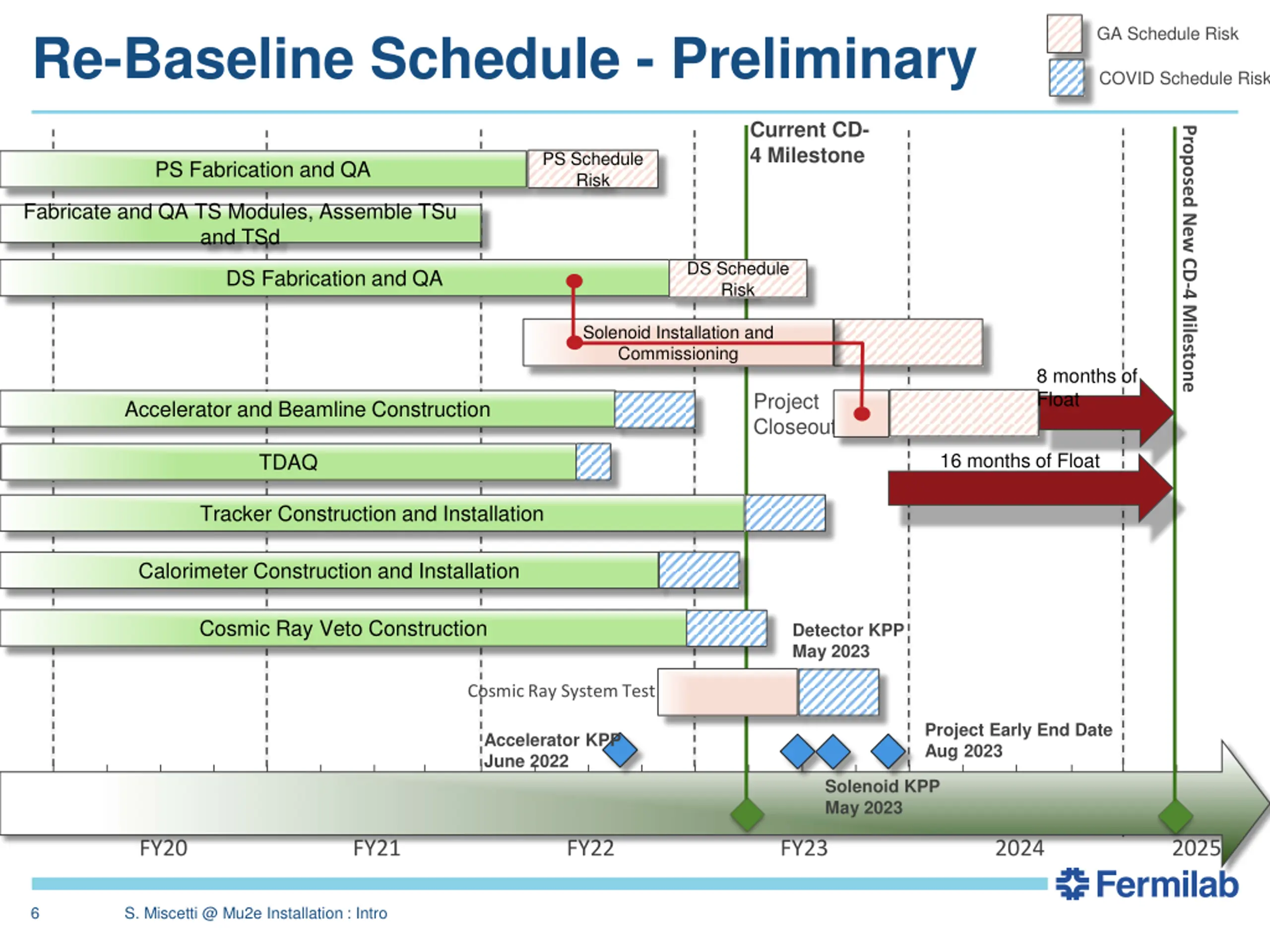

  7. GA Schedule Risk Re-Baseline Schedule - Preliminary COVID Schedule Risk Current CD- 4 Milestone Proposed New CD-4 Milestone PS Schedule Risk PS Fabrication and QA Fabricate and QA TS Modules, Assemble TSu and TSd DS Schedule Risk DS Fabrication and QA Solenoid Installation and Commissioning 8 months of Float Project Closeout Accelerator and Beamline Construction 16 months of Float TDAQ Tracker Construction and Installation Calorimeter Construction and Installation Cosmic Ray Veto Construction Detector KPP May 2023 Cosmic Ray System Test Project Early End Date Aug 2023 Accelerator KPP June 2022 Solenoid KPP May 2023 FY20 FY21 FY22 FY23 2024 2025 6 S. Miscetti @ Mu2e Installation : Intro
