Data Integration Project Overview

modernization committee on products and sources n.w
1 / 7
Embed
Share

"Explore the proposal by the Modernization Committee on Products and Sources for a High-Level Group project on Data Integration. The project aims to move towards better estimates by integrating data from various sources, addressing challenges and leveraging opportunities presented by big data and new technologies."

  • Data Integration
  • Modernization Committee
  • High-Level Group
  • Big Data
  • Statistics

Uploaded on | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. Modernization Committee on Products and Sources: Proposal for HLG project on Data Integration 5thHigh -Level Group Workshop on the modernization of Production and Services, Den Haag -24-26 November 2015

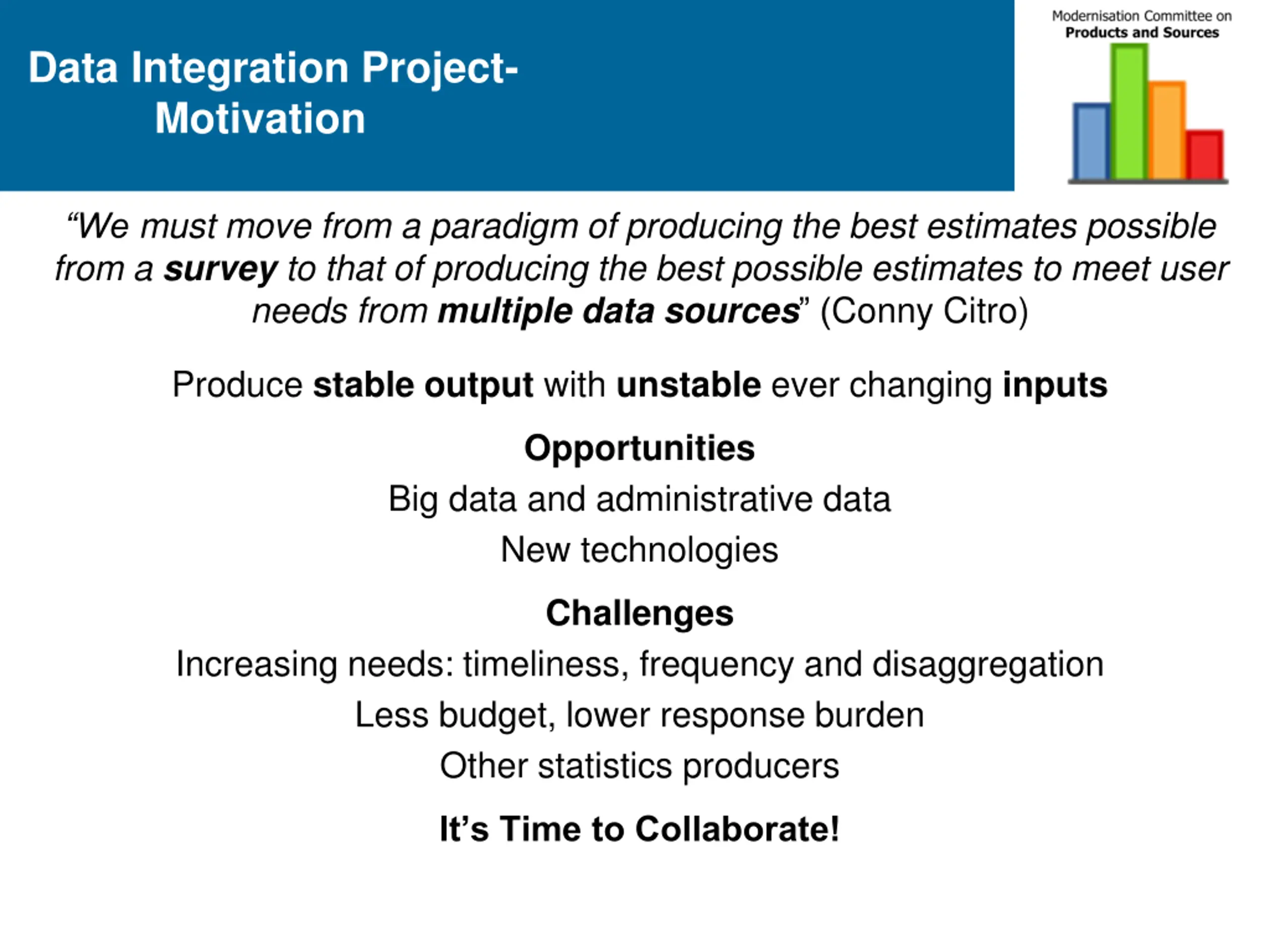

  2. Data Integration Project- Motivation We must move from a paradigm of producing the best estimates possible from a survey to that of producing the best possible estimates to meet user needs from multiple data sources (Conny Citro) Produce stable output with unstable ever changing inputs Opportunities Big data and administrative data New technologies Challenges Increasing needs: timeliness, frequency and disaggregation Less budget, lower response burden Other statistics producers It s Time to Collaborate!

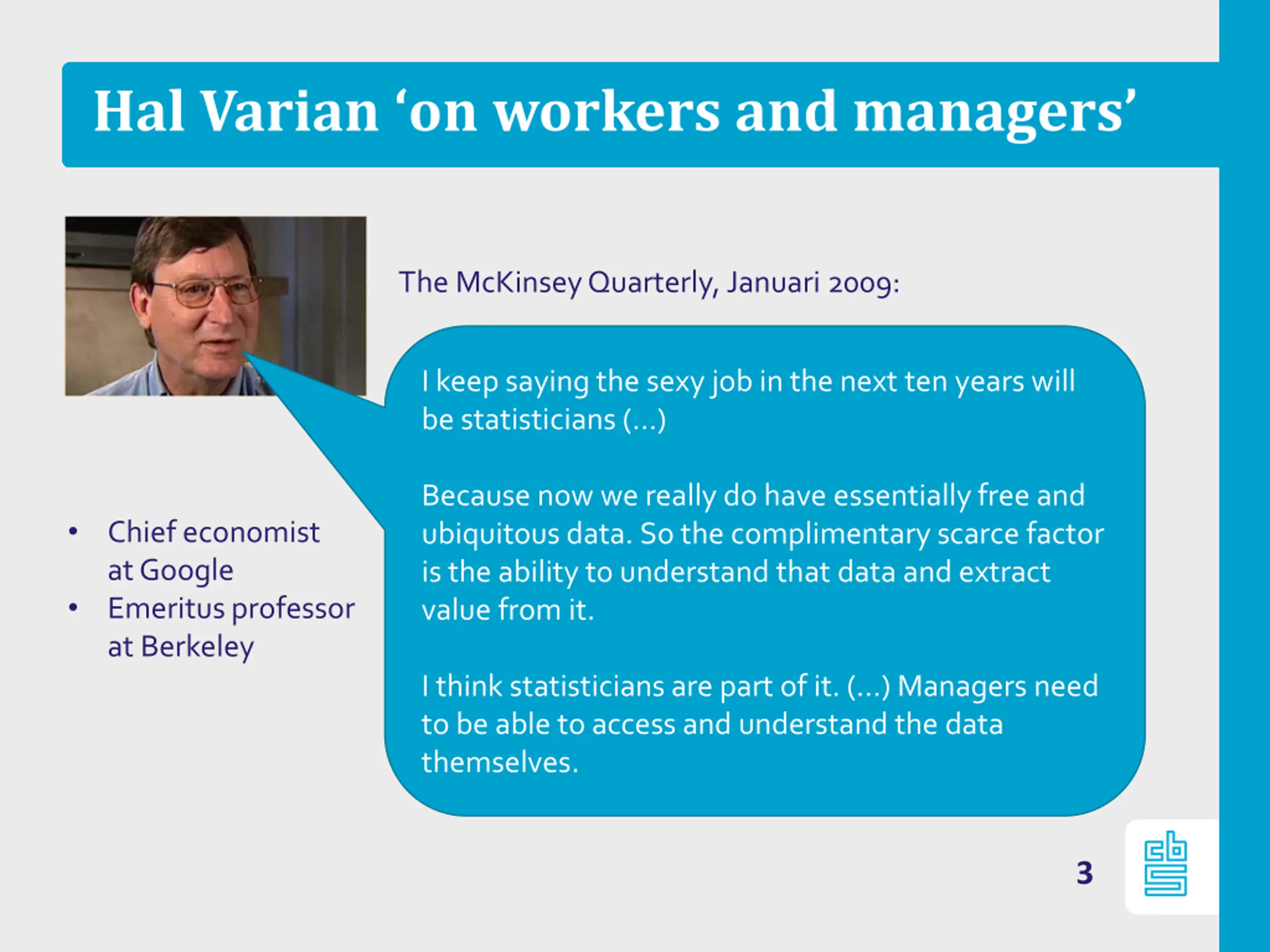

  3. Hal Varian on workers and managers The McKinsey Quarterly, Januari 2009: I keep sayingthe sexy job in the next ten years will be statisticians( ) Because now we really do have essentiallyfree and ubiquitousdata. Sothe complimentaryscarce factor is the ability to understand that data and extract value from it. Chief economist at Google Emeritus professor at Berkeley I think statisticiansare part of it. ( ) Managers need to be able to access and understand the data themselves. 3

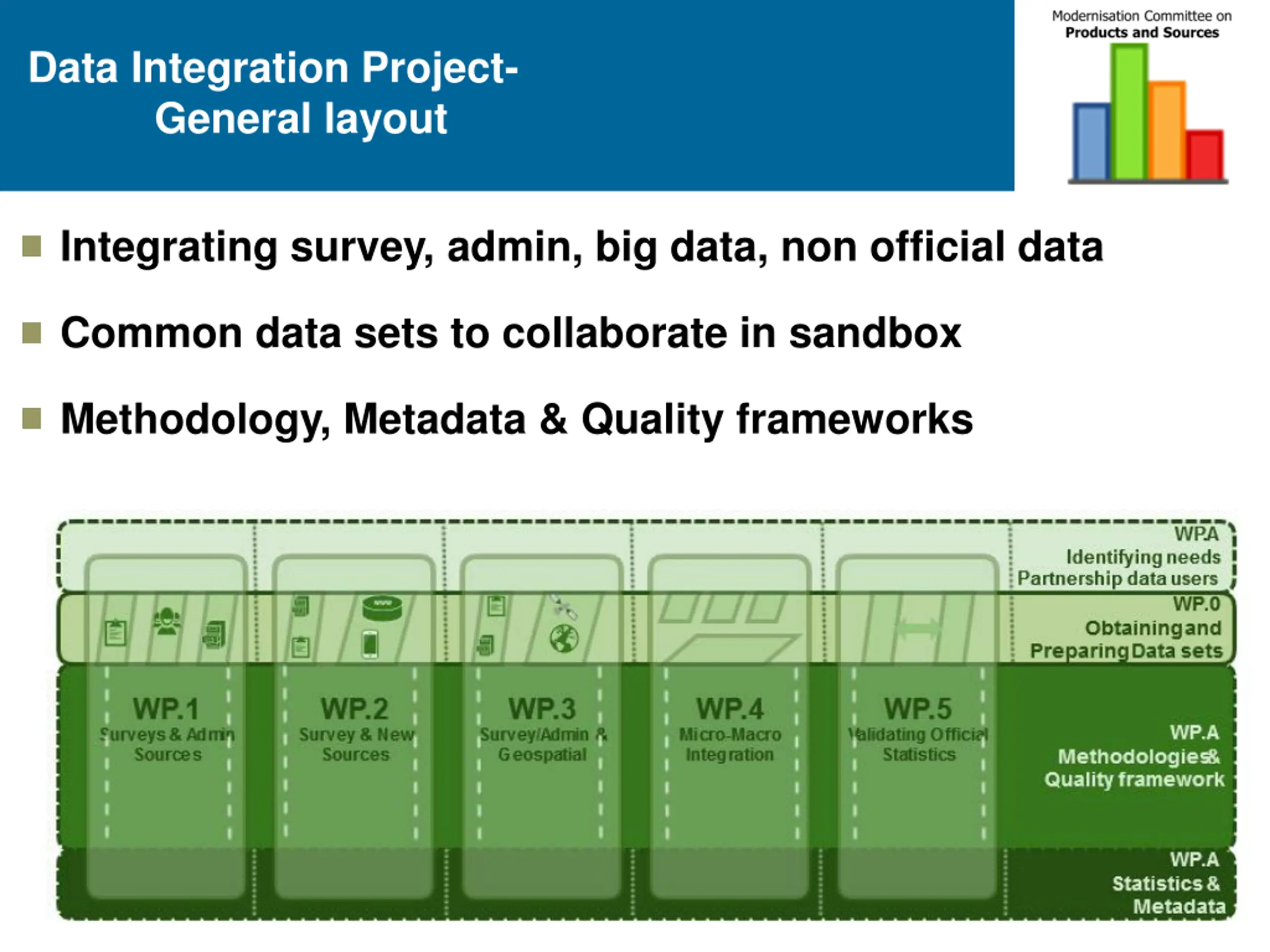

  4. Data Integration Project- General layout Integrating survey, admin, big data, non official data Common data sets to collaborate in sandbox Methodology, Metadata & Quality frameworks UNECE Modernisation Committee for Products and Sources 4

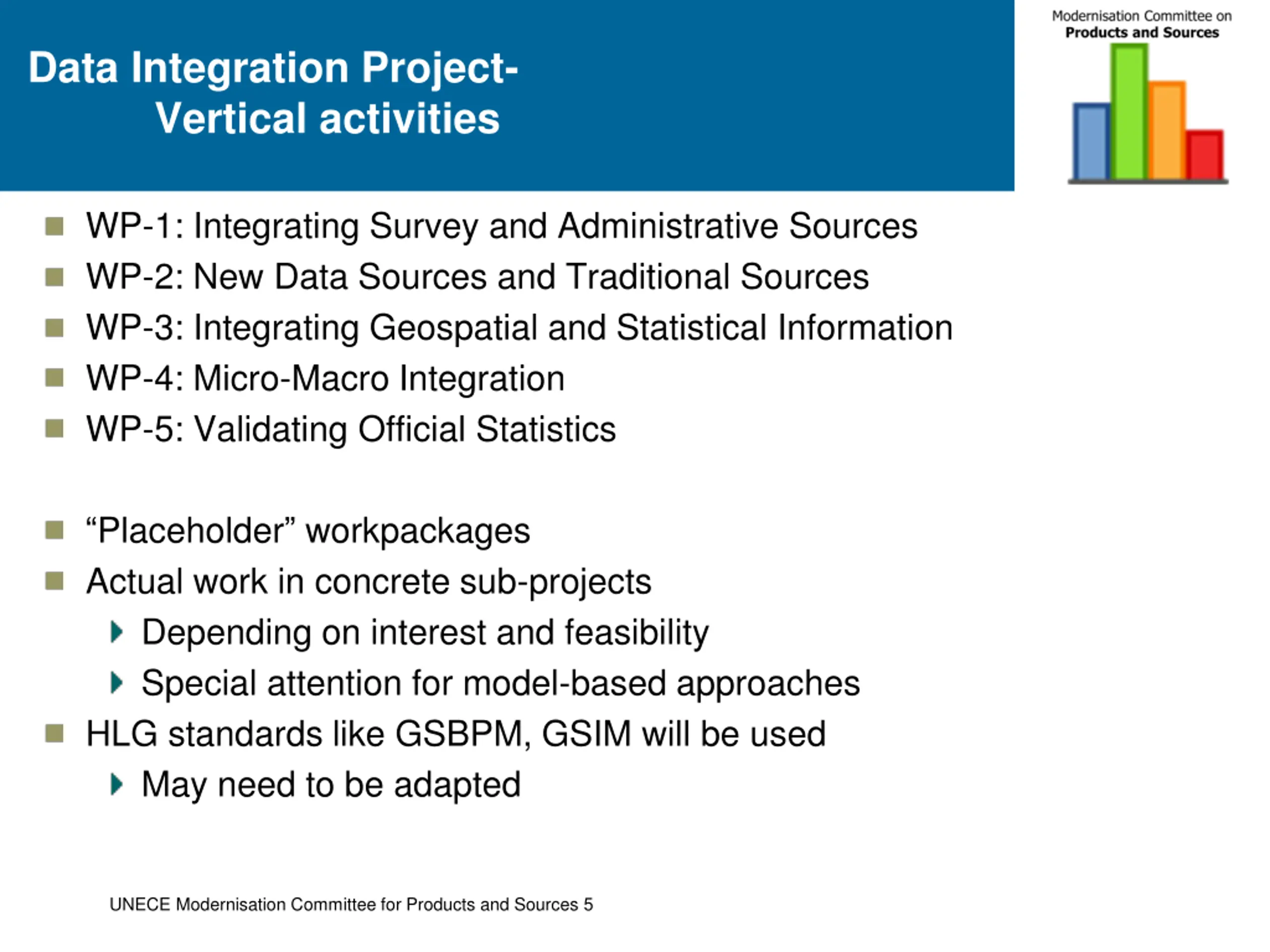

  5. Data Integration Project- Vertical activities WP-1: Integrating Survey and Administrative Sources WP-2: New Data Sources and Traditional Sources WP-3: Integrating Geospatial and Statistical Information WP-4: Micro-Macro Integration WP-5: Validating Official Statistics Placeholder workpackages Actual work in concrete sub-projects Depending on interest and feasibility Special attention for model-based approaches HLG standards like GSBPM, GSIM will be used May need to be adapted UNECE Modernisation Committee for Products and Sources 5

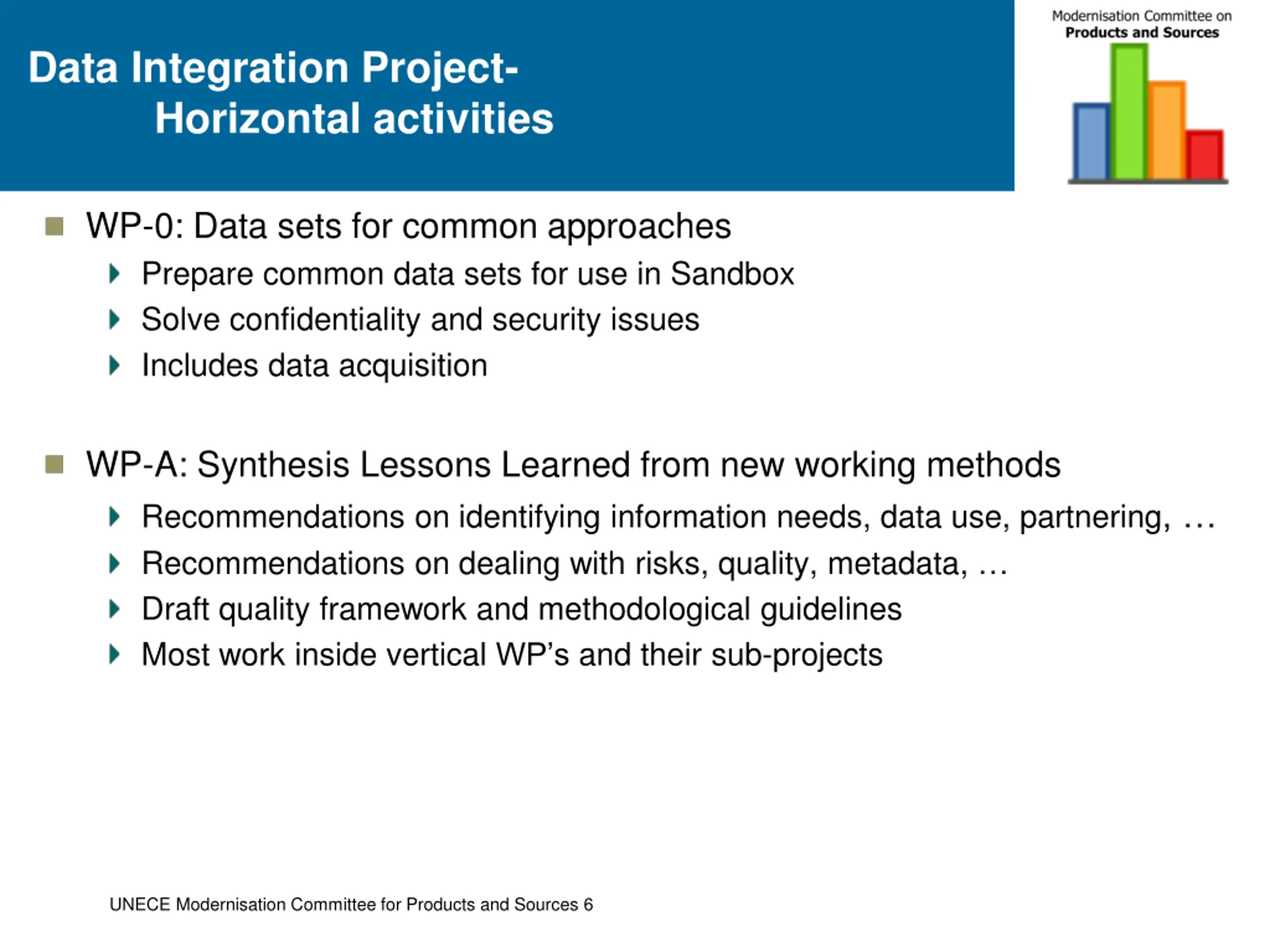

  6. Data Integration Project- Horizontal activities WP-0: Data sets for common approaches Prepare common data sets for use in Sandbox Solve confidentiality and security issues Includes data acquisition WP-A: Synthesis Lessons Learned from new working methods Recommendations on identifying information needs, data use, partnering, Recommendations on dealing with risks, quality, metadata, Draft quality framework and methodological guidelines Most work inside vertical WP s and their sub-projects UNECE Modernisation Committee for Products and Sources 6

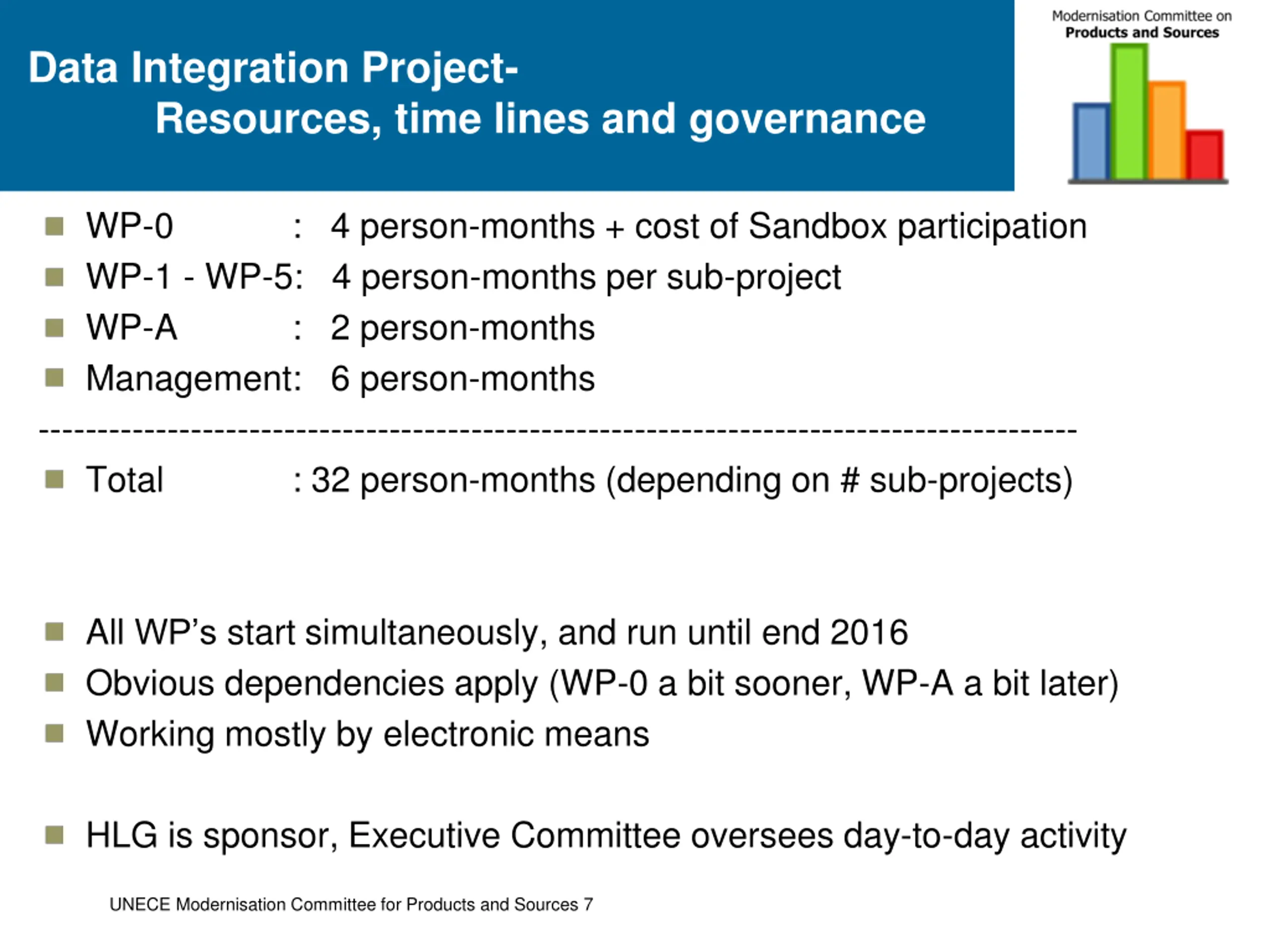

  7. Data Integration Project- Resources, time lines and governance WP-0 WP-1 - WP-5: 4 person-months per sub-project WP-A : 2 person-months Management: 6 person-months ----------------------------------------------------------------------------------------- Total : 32 person-months (depending on # sub-projects) : 4 person-months + cost of Sandbox participation All WP s start simultaneously, and run until end 2016 Obvious dependencies apply (WP-0 a bit sooner, WP-A a bit later) Working mostly by electronic means HLG is sponsor, Executive Committee oversees day-to-day activity UNECE Modernisation Committee for Products and Sources 7
