Data Submission and Project Topology in Energy Community

tyndp 2017 sjws iii @ energy community vienna n.w
1 / 14
Embed
Share

Explore how data submission translates into projects and topology in the Energy Community, covering topics such as project validation rules, monitoring activities, and creating/modifying/canceling project submissions. Get insights into existing network topology details and project modeling scenarios between different countries.

  • Energy
  • Data Submission
  • Project Topology
  • Validation Rules
  • Network

Uploaded on | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. TYNDP 2017 SJWS III @ Energy Community - Vienna 09 February 2016 Projects and topology How does your data submission translate into a Project in the topology d m Balogh Adviser

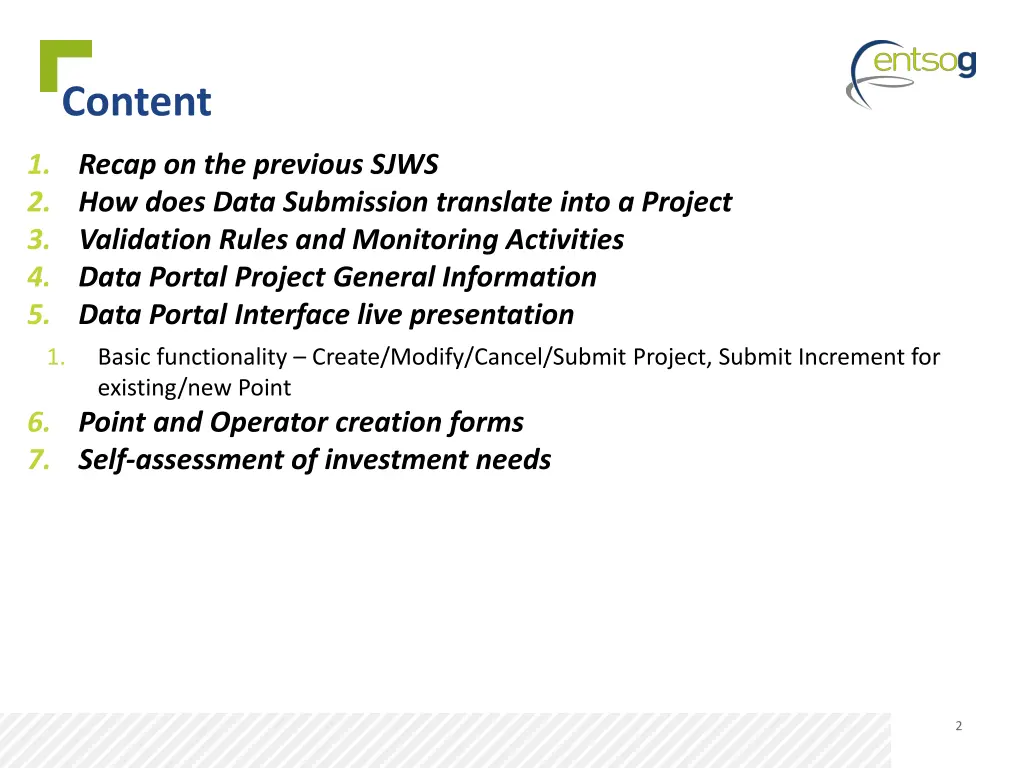

  2. Content 1. Recap on the previous SJWS 2. How does Data Submission translate into a Project 3. Validation Rules and Monitoring Activities 4. Data Portal Project General Information 5. Data Portal Interface live presentation Basic functionality Create/Modify/Cancel/Submit Project, Submit Increment for existing/new Point 6. Point and Operator creation forms 7. Self-assessment of investment needs 1. 2

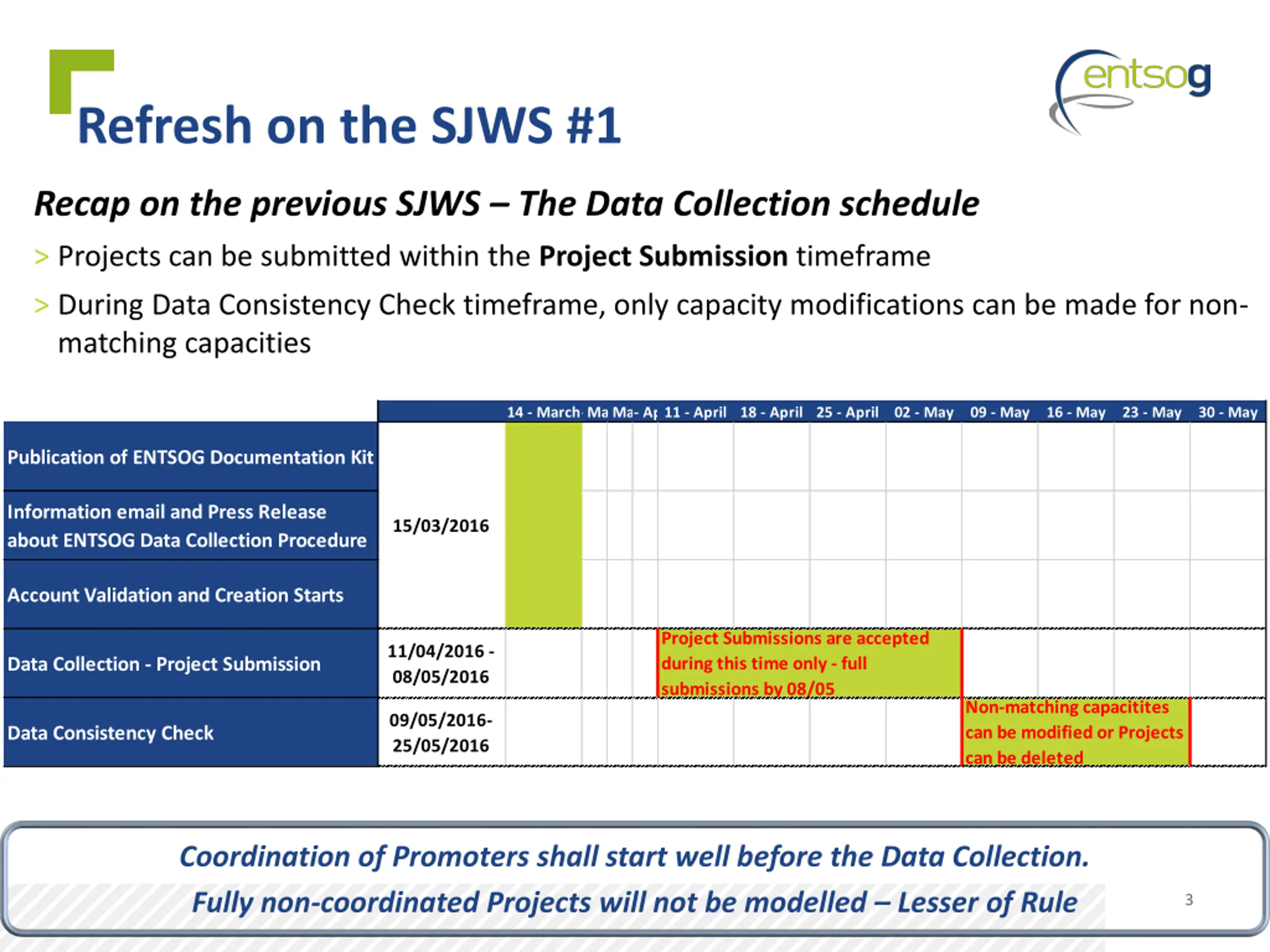

  3. Refresh on the SJWS #1 Recap on the previous SJWS The Data Collection schedule > Projects can be submitted within the Project Submission timeframe > During Data Consistency Check timeframe, only capacity modifications can be made for non- matching capacities 14 - March 21 - March 28 - March 04 - April 11 - April 18 - April 25 - April 02 - May 09 - May 16 - May 23 - May 30 - May Publication of ENTSOG Documentation Kit Information email and Press Release about ENTSOG Data Collection Procedure 15/03/2016 Account Validation and Creation Starts Project Submissions are accepted during this time only - full submissions by 08/05 11/04/2016 - 08/05/2016 Data Collection - Project Submission Non-matching capacitites can be modified or Projects can be deleted 09/05/2016- 25/05/2016 Data Consistency Check Coordination of Promoters shall start well before the Data Collection. Fully non-coordinated Projects will not be modelled Lesser of Rule 3

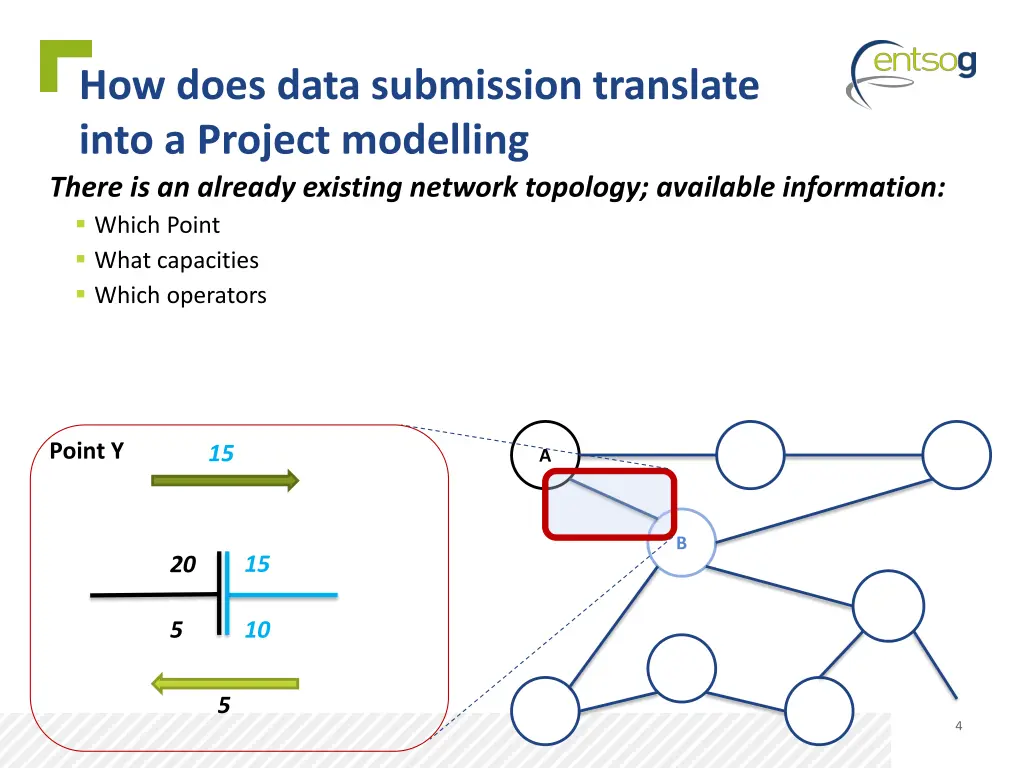

  4. How does data submission translate into a Project modelling There is an already existing network topology; available information: Which Point What capacities Which operators Point Y 15 A B 15 20 5 10 5 4

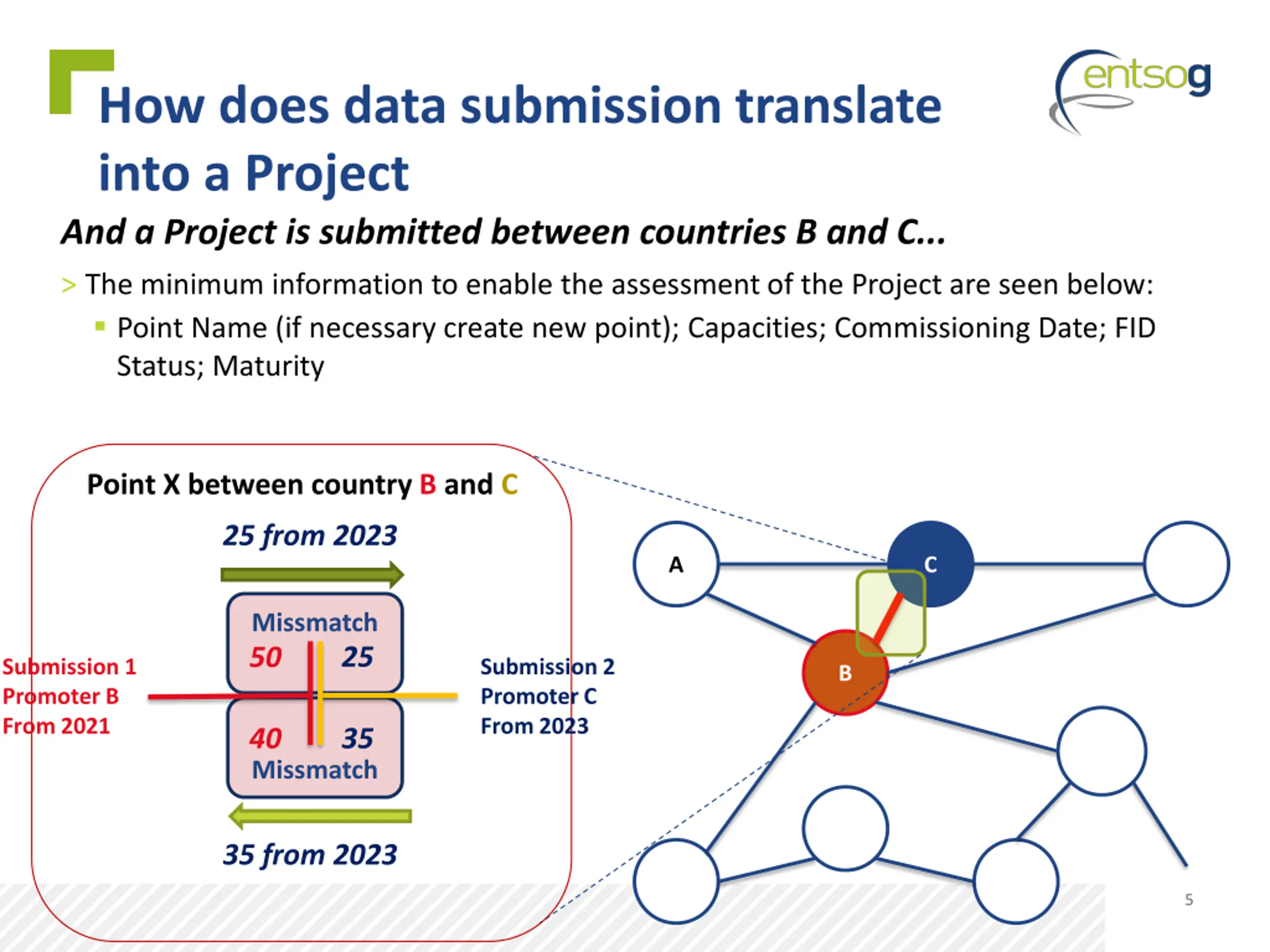

  5. How does data submission translate into a Project And a Project is submitted between countries B and C... > The minimum information to enable the assessment of the Project are seen below: Point Name (if necessary create new point); Capacities; Commissioning Date; FID Status; Maturity Point X between country B and C 25 from 2023 A C Missmatch 50 25 Submission 2 Promoter C From 2023 Submission 1 Promoter B From 2021 B 40 35 Missmatch 35 from 2023 5

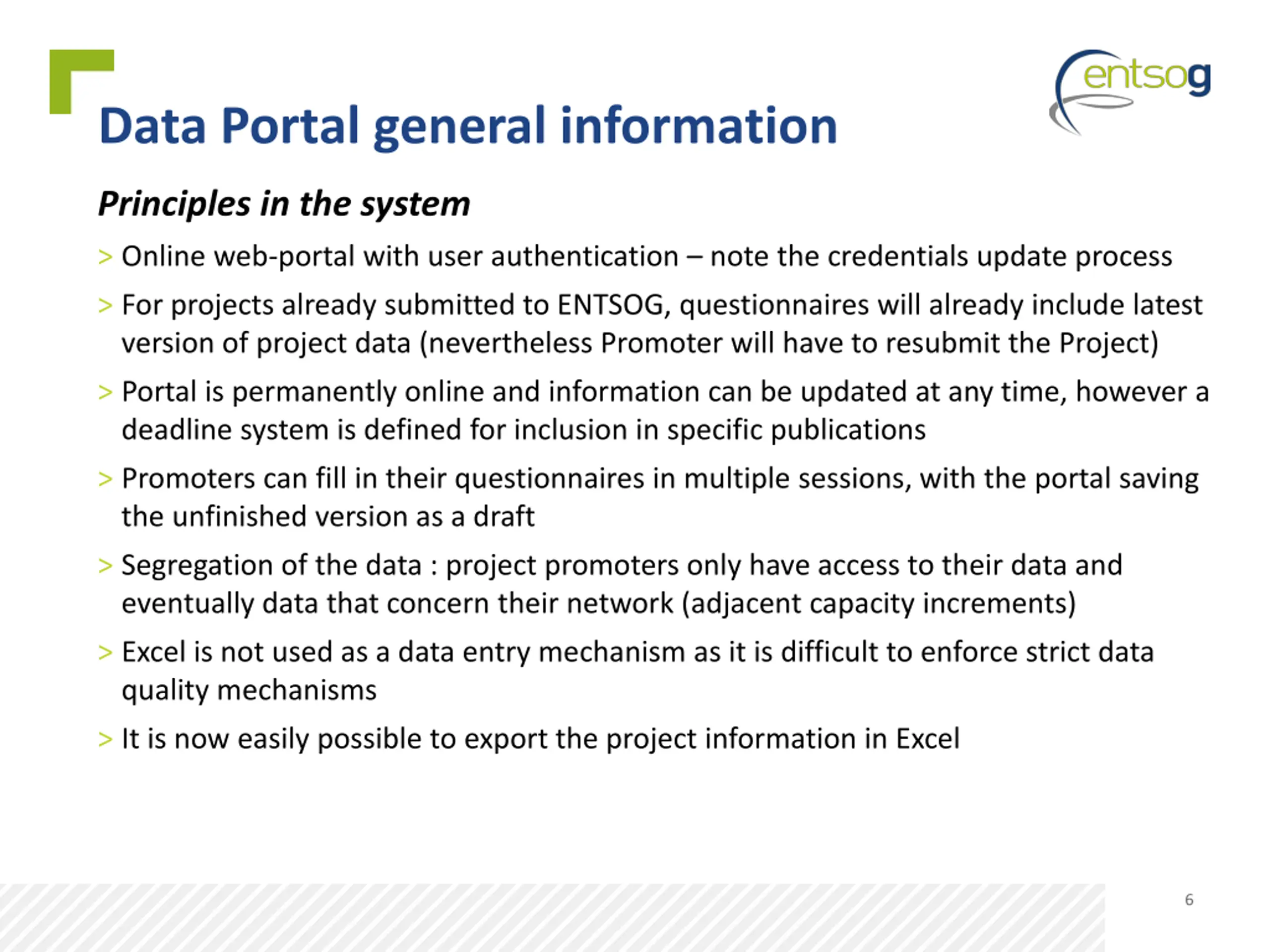

  6. Data Portal general information Principles in the system > Online web-portal with user authentication note the credentials update process > For projects already submitted to ENTSOG, questionnaires will already include latest version of project data (nevertheless Promoter will have to resubmit the Project) > Portal is permanently online and information can be updated at any time, however a deadline system is defined for inclusion in specific publications > Promoters can fill in their questionnaires in multiple sessions, with the portal saving the unfinished version as a draft > Segregation of the data : project promoters only have access to their data and eventually data that concern their network (adjacent capacity increments) > Excel is not used as a data entry mechanism as it is difficult to enforce strict data quality mechanisms > It is now easily possible to export the project information in Excel 6

  7. Validation Rules A rule applied on the submitted data (Project data or Incremental capacity data) Examples: > Commissioning date should be in the future but within the TYNDP time horizon > The value of an increment shall be X>0 GWh/d > A Project with FID in the past cannot be Non-FID > Already submitted Projects have to be updated for a new TYNDP > Point and flow direction have to be submitted (active) for an Increment > Etc... Possible outcomes: > N/A in the given context, on the given data > Warning (Minor) the Rule is violated, but it does not deeply impact modelling > Critical Error (Major) the Rule is violated, and that submitted data is not usable for modelling > Passed The Rule is observed 7 Rules can be read in the Validation Rules Document from 15 March

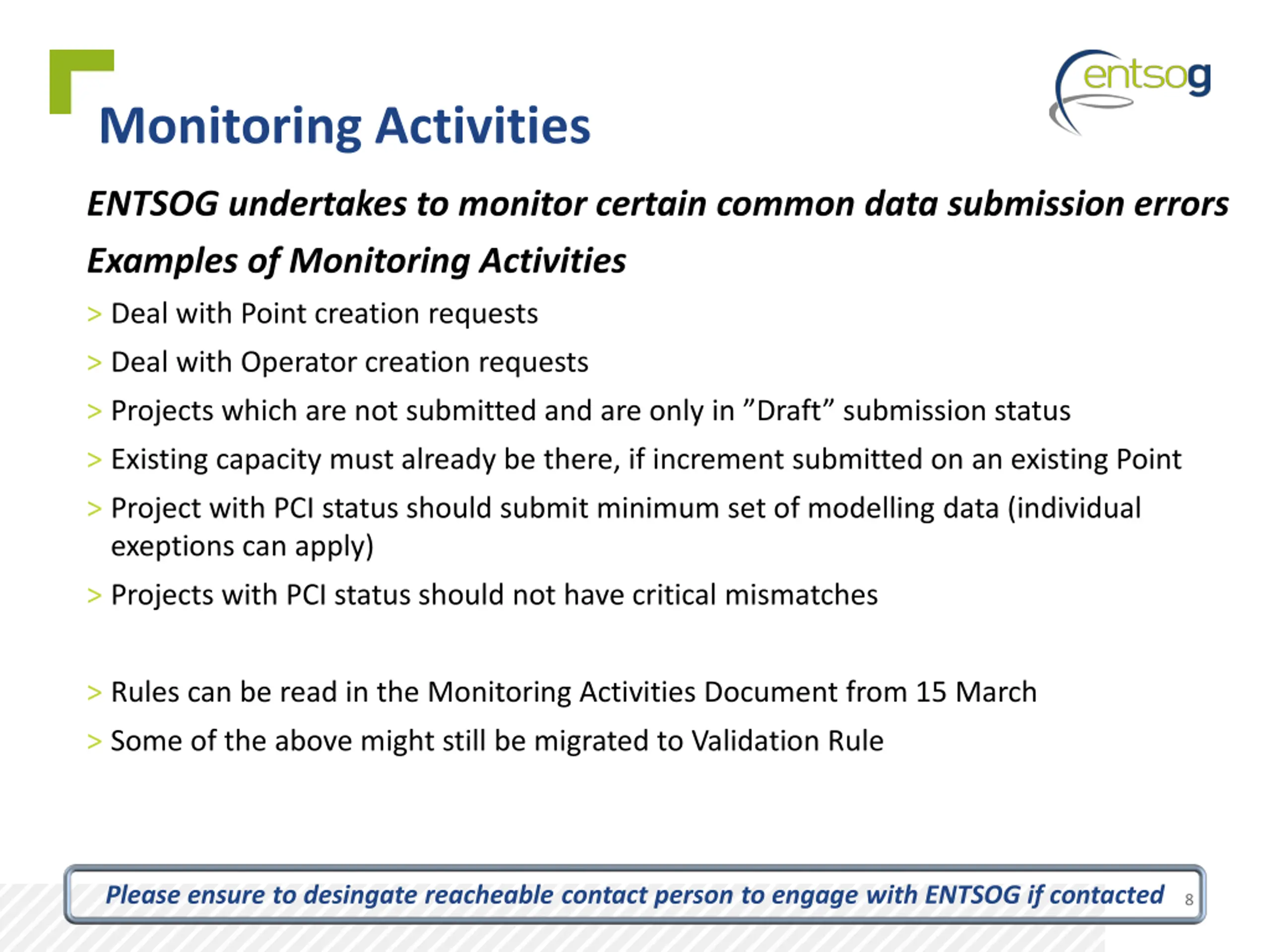

  8. Monitoring Activities ENTSOG undertakes to monitor certain common data submission errors Examples of Monitoring Activities > Deal with Point creation requests > Deal with Operator creation requests > Projects which are not submitted and are only in Draft submission status > Existing capacity must already be there, if increment submitted on an existing Point > Project with PCI status should submit minimum set of modelling data (individual exeptions can apply) > Projects with PCI status should not have critical mismatches > Rules can be read in the Monitoring Activities Document from 15 March > Some of the above might still be migrated to Validation Rule Please ensure to desingate reacheable contact person to engage with ENTSOG if contacted 8

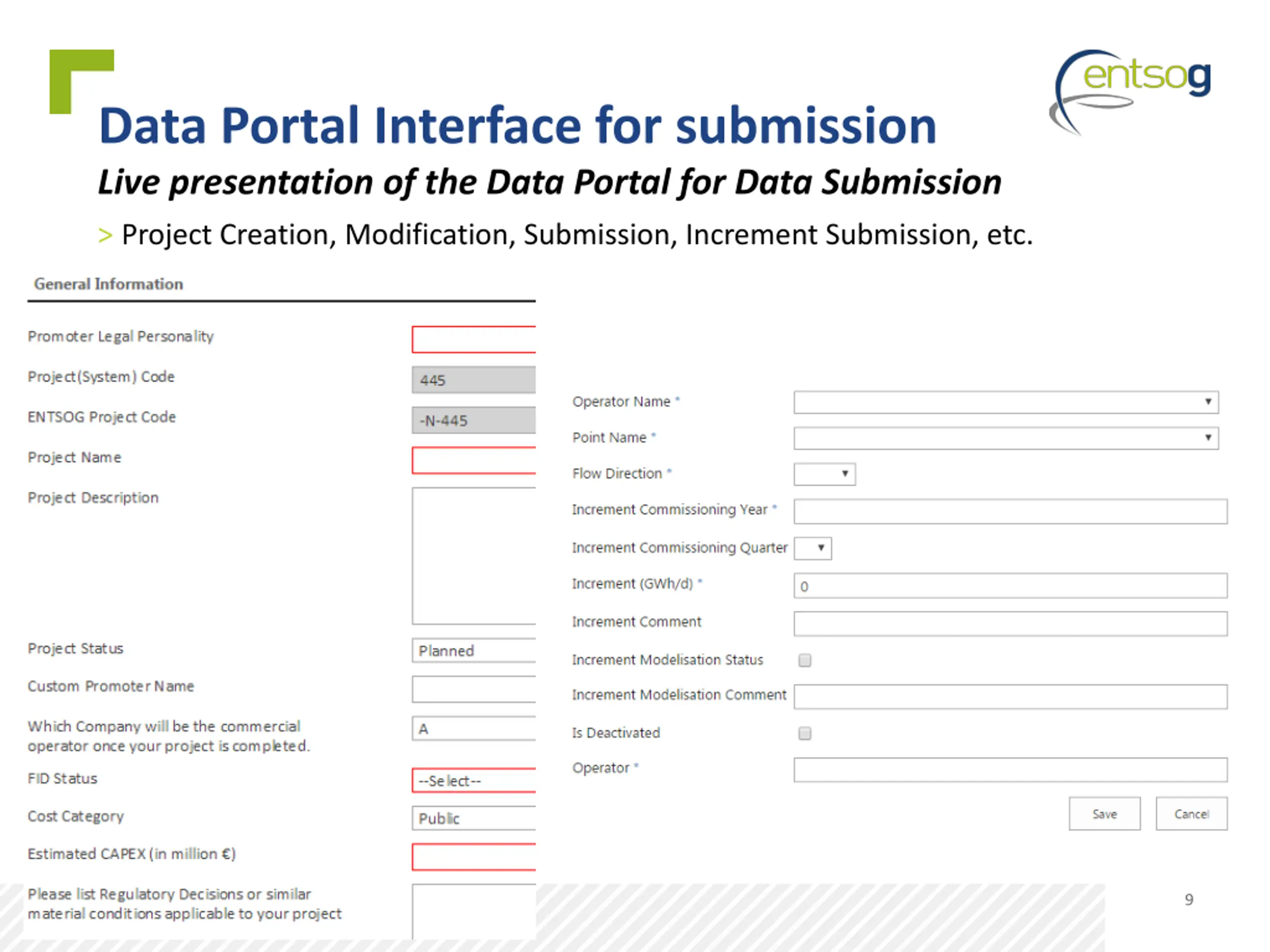

  9. Data Portal Interface for submission Live presentation of the Data Portal for Data Submission > Project Creation, Modification, Submission, Increment Submission, etc. 9

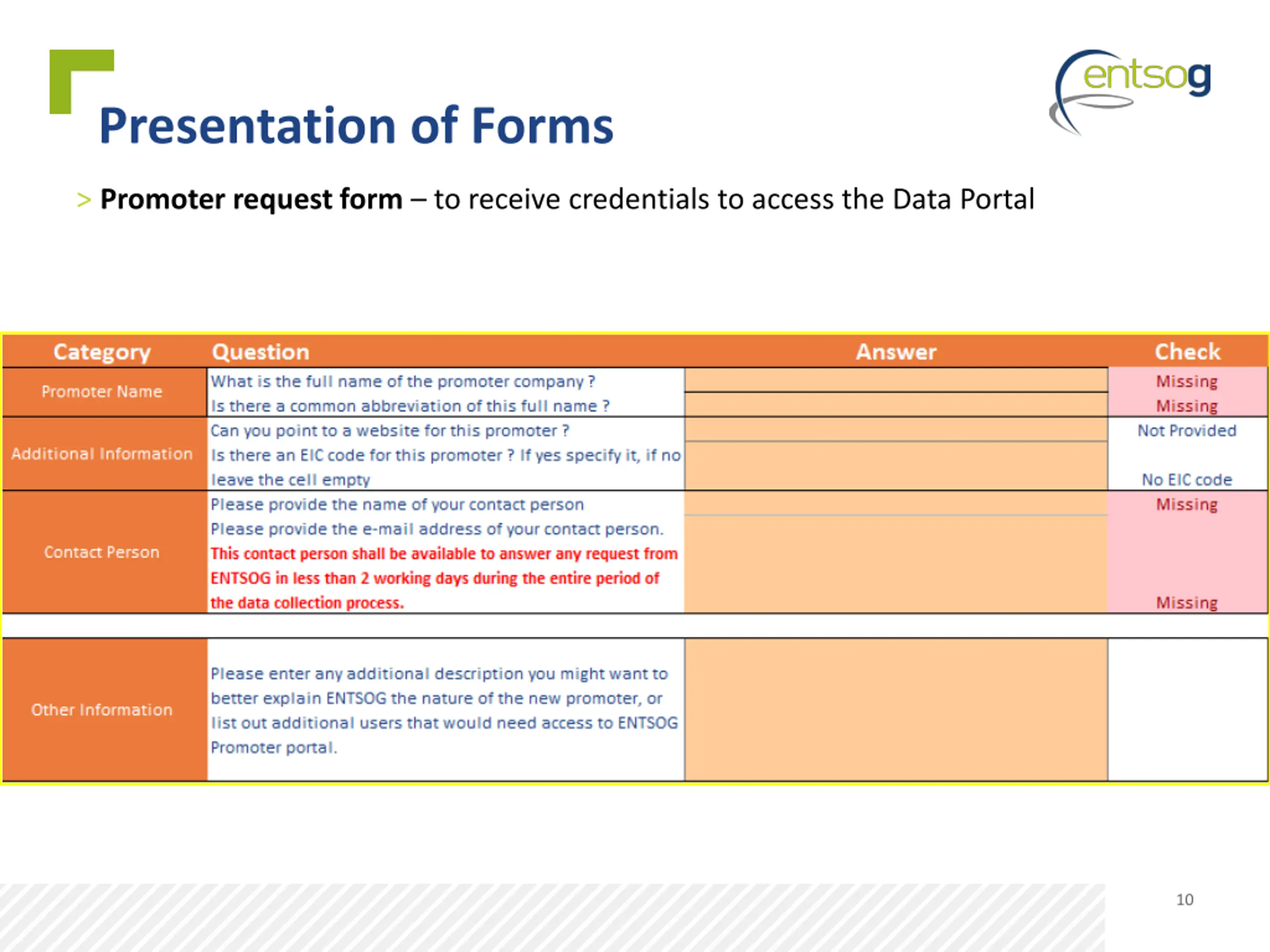

  10. Presentation of Forms > Promoter request form to receive credentials to access the Data Portal 10

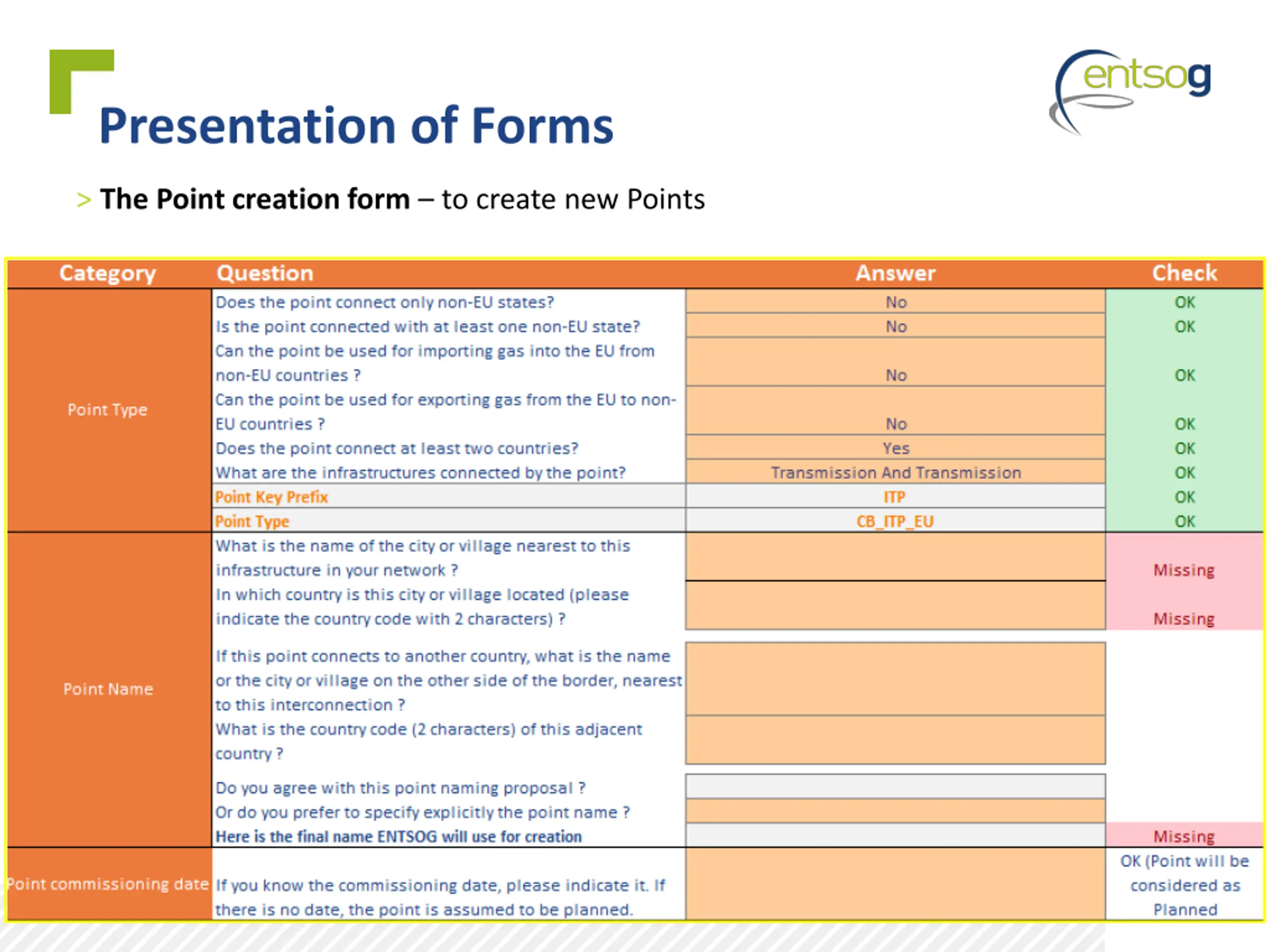

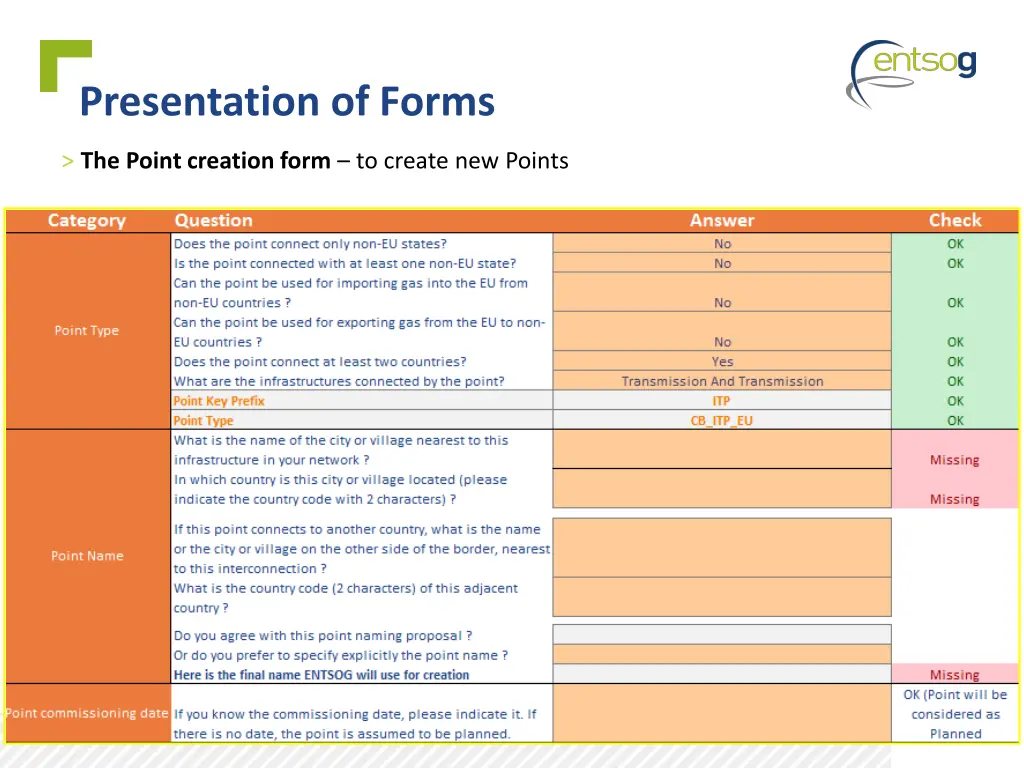

  11. Presentation of Forms > The Point creation form to create new Points 11

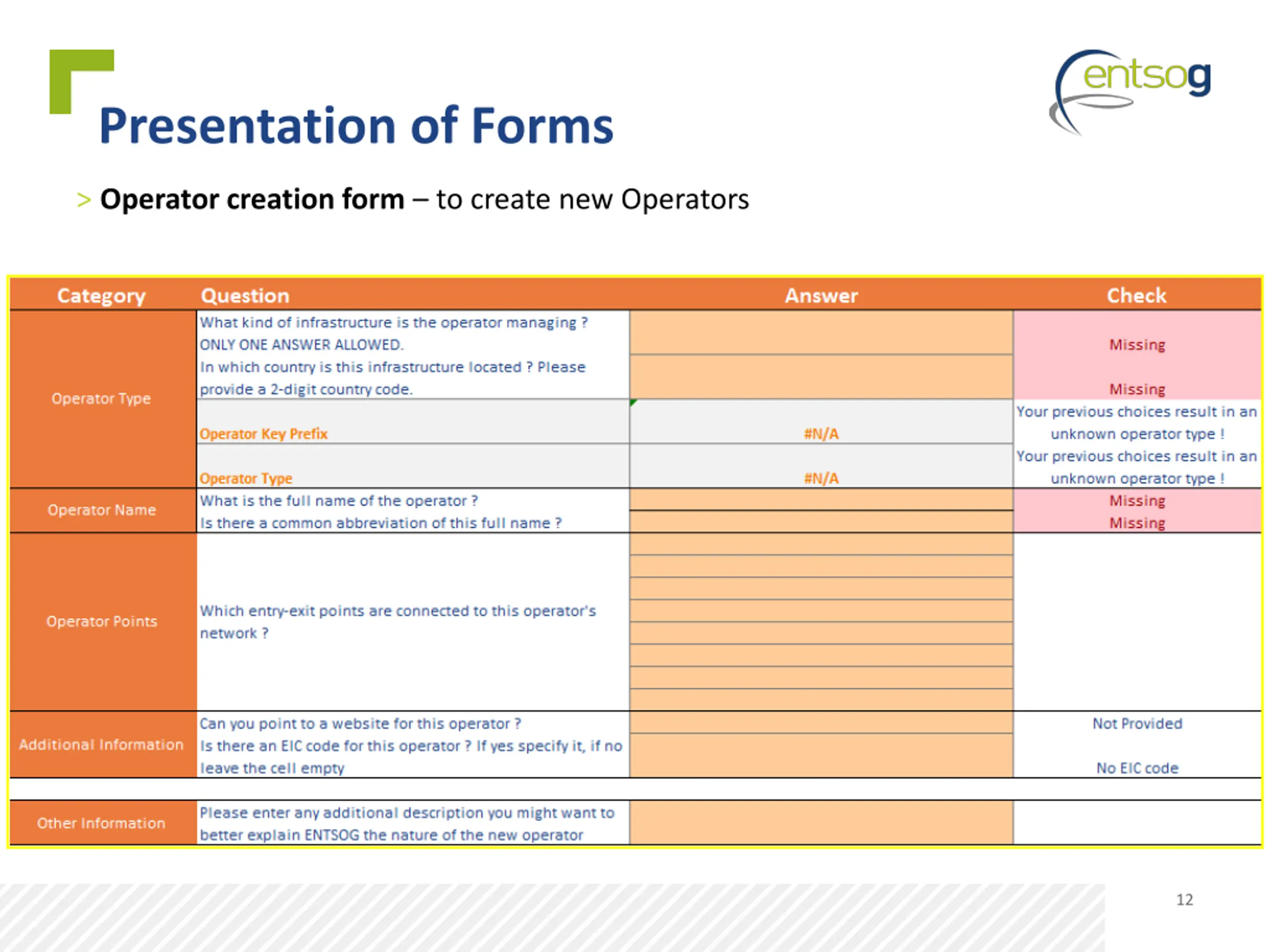

  12. Presentation of Forms > Operator creation form to create new Operators 12

  13. Self-assessment of investment needs In line with the intetions of the COM to identify the investment gaps in the Regional Groups as a first step of the next PCI selection procedure, ENTSOG plans to: > Include in the Project Questionnaire a section where the Promoter can self-assess the Project, by describing which investment need(s) -as indentified within the TYNDP 2015- does the Project fulfil 13

  14. Thank You for Your Attention d m Balogh Adviser, System Development ENTSOG -- European Network of Transmission System Operators for Gas Avenue de Cortenbergh100, B-1000 Brussels Celine.Heidrecheid@entsog.eu EML: WWW: www.entsog.eu
