Dedicated Meetings and Progress Update for Noise Reduction in SCQ Installation

progress and plan n.w
1 / 6
Embed
Share

Explore the latest updates on the SCQ installation progress, discharge issues on different layers, noise reduction efforts, and upcoming plans for the project. Delve into details about recent tasks completed, personnel in charge, and plans for the following week. Learn about dedicated meetings focusing on noise issues, expert suggestions, and noise test results to enhance project outcomes.

  • Meetings
  • Progress Update
  • Noise Reduction
  • SCQ Installation
  • Project Plans

Uploaded on | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. Progress and Plan Mingyi Dong 2025.01.21

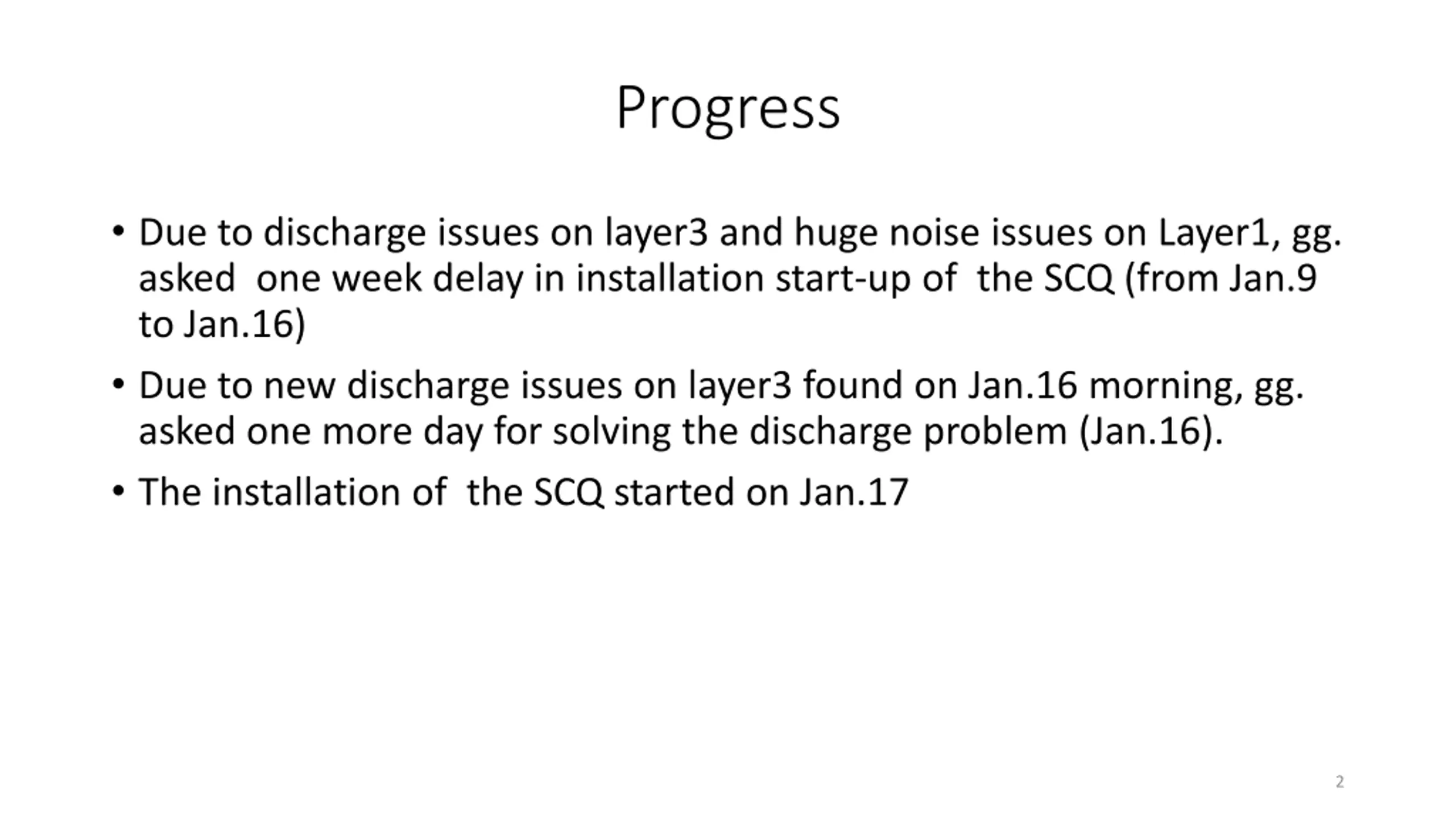

  2. Progress Due to discharge issues on layer3 and huge noise issues on Layer1, gg. asked one week delay in installation start-up of the SCQ (from Jan.9 to Jan.16) Due to new discharge issues on layer3 found on Jan.16 morning, gg. asked one more day for solving the discharge problem (Jan.16). The installation of the SCQ started on Jan.17 2

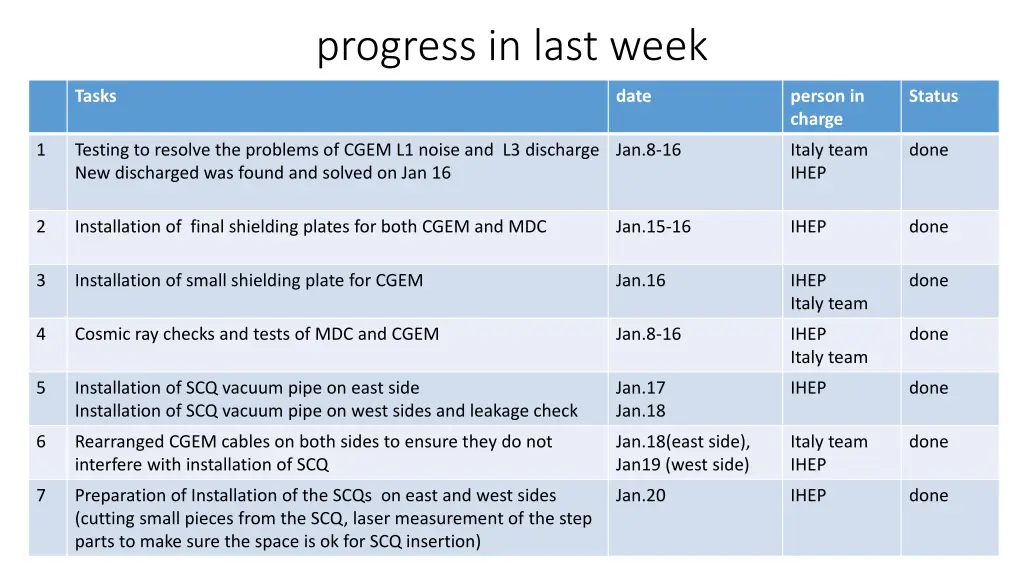

  3. progress in last week Tasks date person in charge Status 1 Testing to resolve the problems of CGEM L1 noise and L3 discharge New discharged was found and solved on Jan 16 Jan.8-16 Italy team IHEP done 2 Installation of final shielding plates for both CGEM and MDC Jan.15-16 IHEP done 3 Installation of small shielding plate for CGEM Jan.16 IHEP Italy team done 4 Cosmic ray checks and tests of MDC and CGEM Jan.8-16 IHEP Italy team done 5 Installation of SCQ vacuum pipe on east side Installation of SCQ vacuum pipe on west sides and leakage check Jan.17 Jan.18 IHEP done 6 Rearranged CGEM cables on both sides to ensure they do not interfere with installation of SCQ Jan.18(east side), Jan19 (west side) Italy team IHEP done 7 Preparation of Installation of the SCQs on east and west sides (cutting small pieces from the SCQ, laser measurement of the step parts to make sure the space is ok for SCQ insertion) Jan.20 IHEP done 3

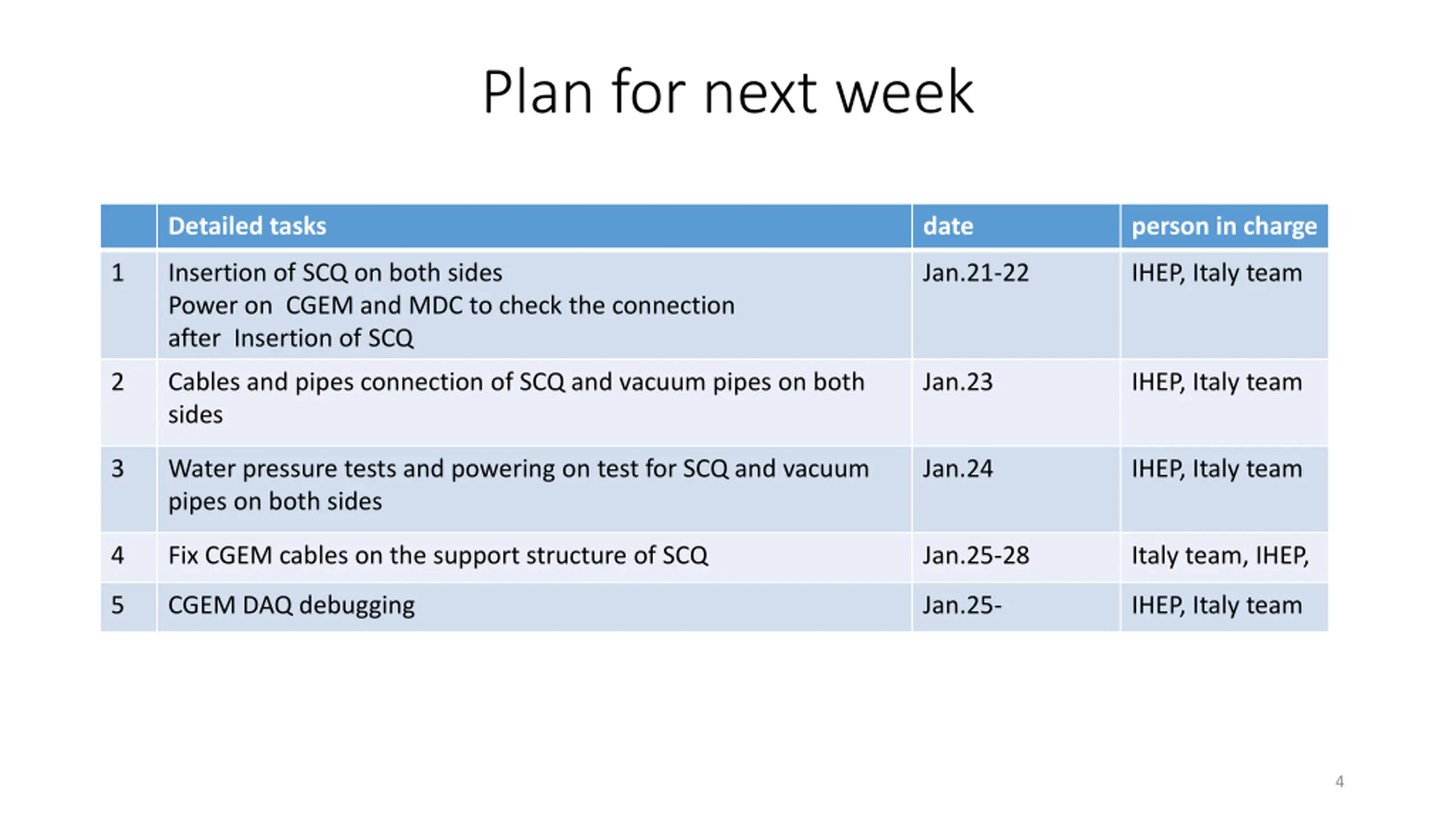

  4. Plan for next week Detailed tasks date person in charge 1 Insertion of SCQ on both sides Power on CGEM and MDC to check the connection after Insertion of SCQ Jan.21-22 IHEP, Italy team 2 Cables and pipes connection of SCQ and vacuum pipes on both sides Jan.23 IHEP, Italy team 3 Water pressure tests and powering on test for SCQ and vacuum pipes on both sides Jan.24 IHEP, Italy team 4 Fix CGEM cables on the support structure of SCQ Jan.25-28 Italy team, IHEP, 5 CGEM DAQ debugging Jan.25- IHEP, Italy team 4

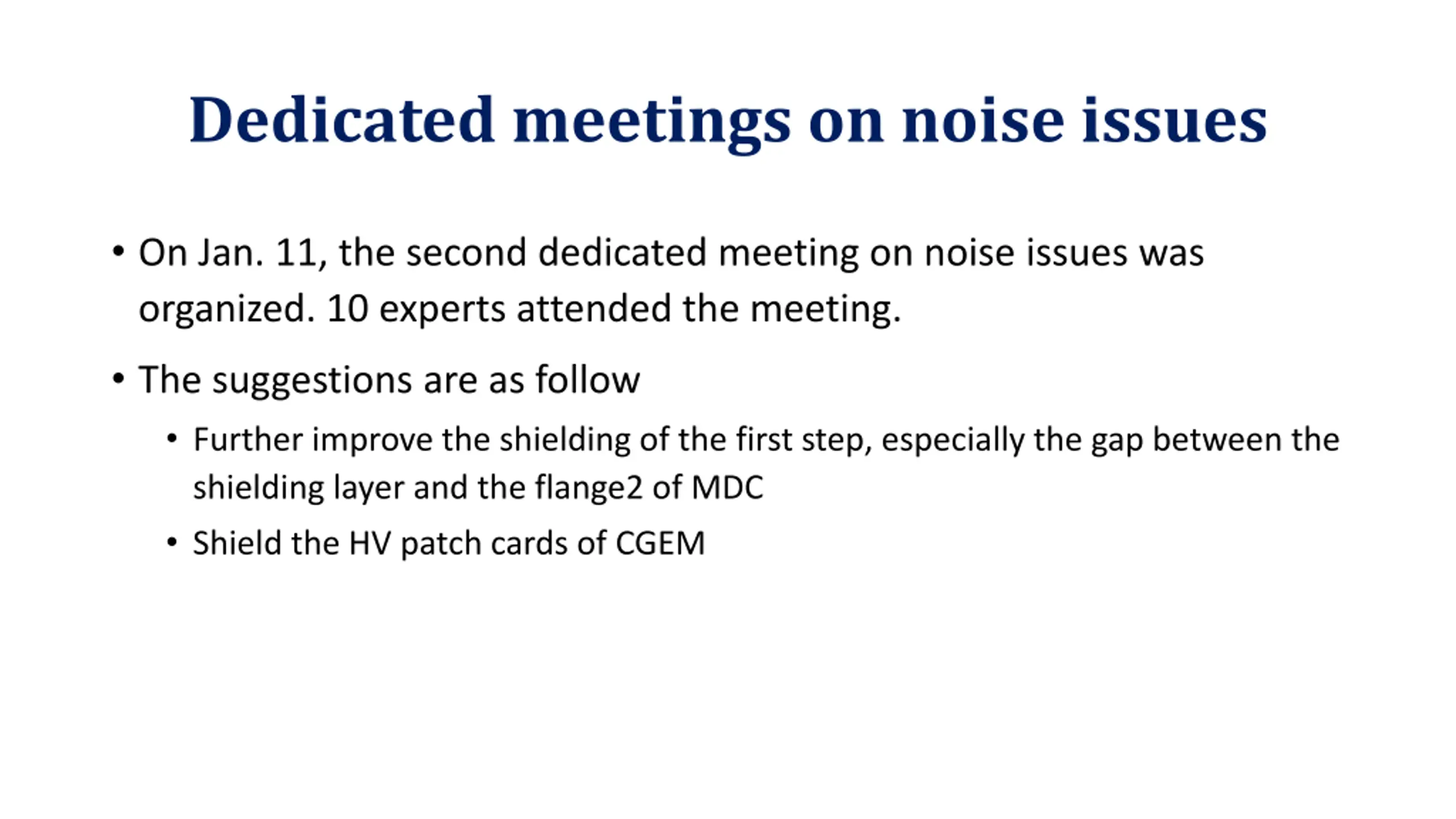

  5. Dedicated meetings on noise issues On Jan. 11, the second dedicated meeting on noise issues was organized. 10 experts attended the meeting. The suggestions are as follow Further improve the shielding of the first step, especially the gap between the shielding layer and the flange2 of MDC Shield the HV patch cards of CGEM

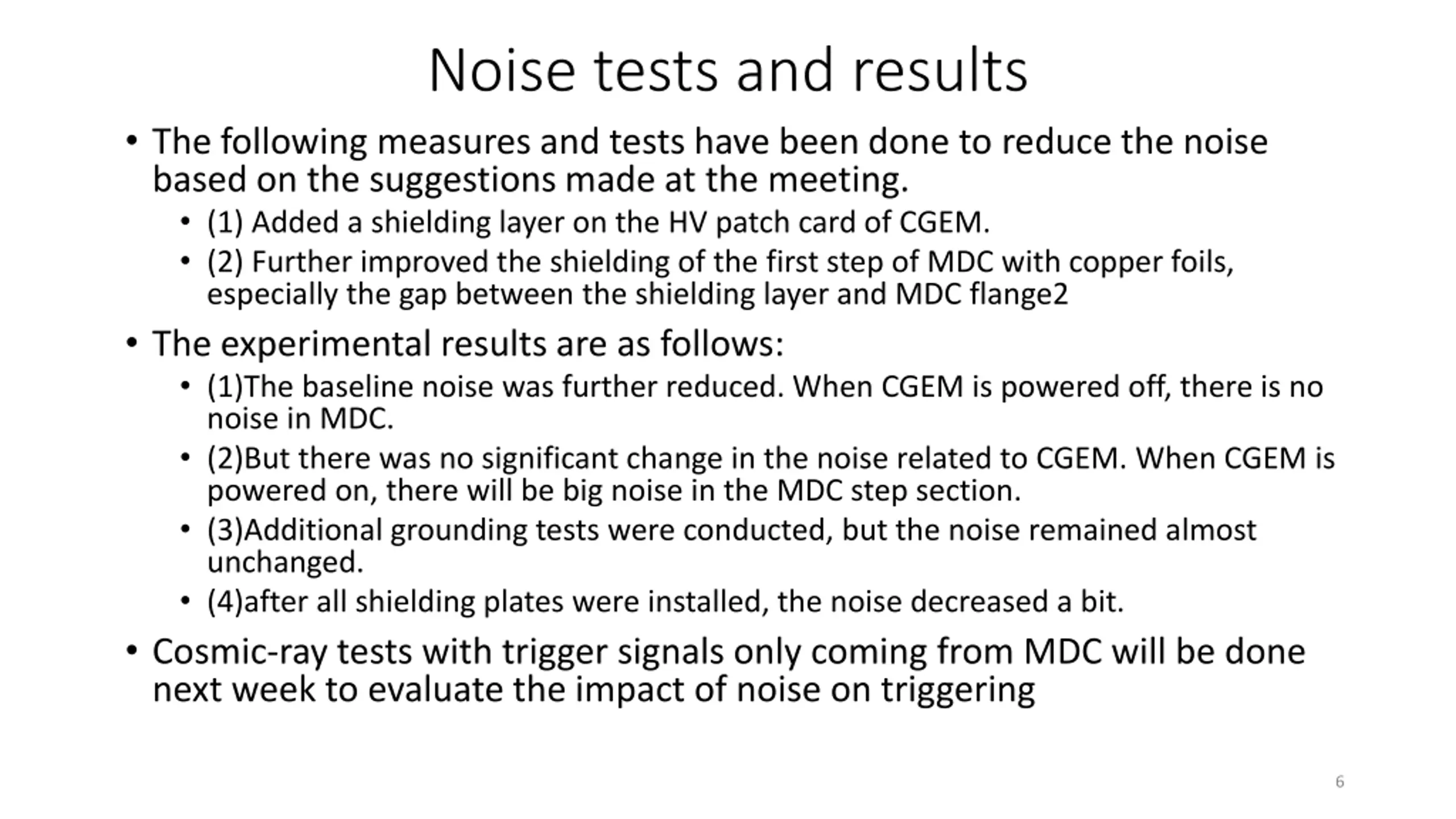

  6. Noise tests and results The following measures and tests have been done to reduce the noise based on the suggestions made at the meeting. (1) Added a shielding layer on the HV patch card of CGEM. (2) Further improved the shielding of the first step of MDC with copper foils, especially the gap between the shielding layer and MDC flange2 The experimental results are as follows: (1)The baseline noise was further reduced. When CGEM is powered off, there is no noise in MDC. (2)But there was no significant change in the noise related to CGEM. When CGEM is powered on, there will be big noise in the MDC step section. (3)Additional grounding tests were conducted, but the noise remained almost unchanged. (4)after all shielding plates were installed, the noise decreased a bit. Cosmic-ray tests with trigger signals only coming from MDC will be done next week to evaluate the impact of noise on triggering 6
