Delivery of Multiple Small Projects Now - Enhanced Project Management Tool

Delivery of Multiple Small Projects Now - Enhanced Project Management Tool
Slide Note
Embed
Share

In this detailed guide, discover how TO-CA model streamlines project delivery by enabling multiple projects under a single contract, emphasizing smaller projects and best-value selection. Learn about the process, benefits, and when to use TO-CA for efficient project management.

  • Project Management
  • Enhanced Tool
  • TO-CA Model
  • Small Projects
  • Best-Value Selection

Uploaded on Feb 20, 2025 | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. Delivery of Multiple Small ProjectsNow! Task Order-Construction Agreements

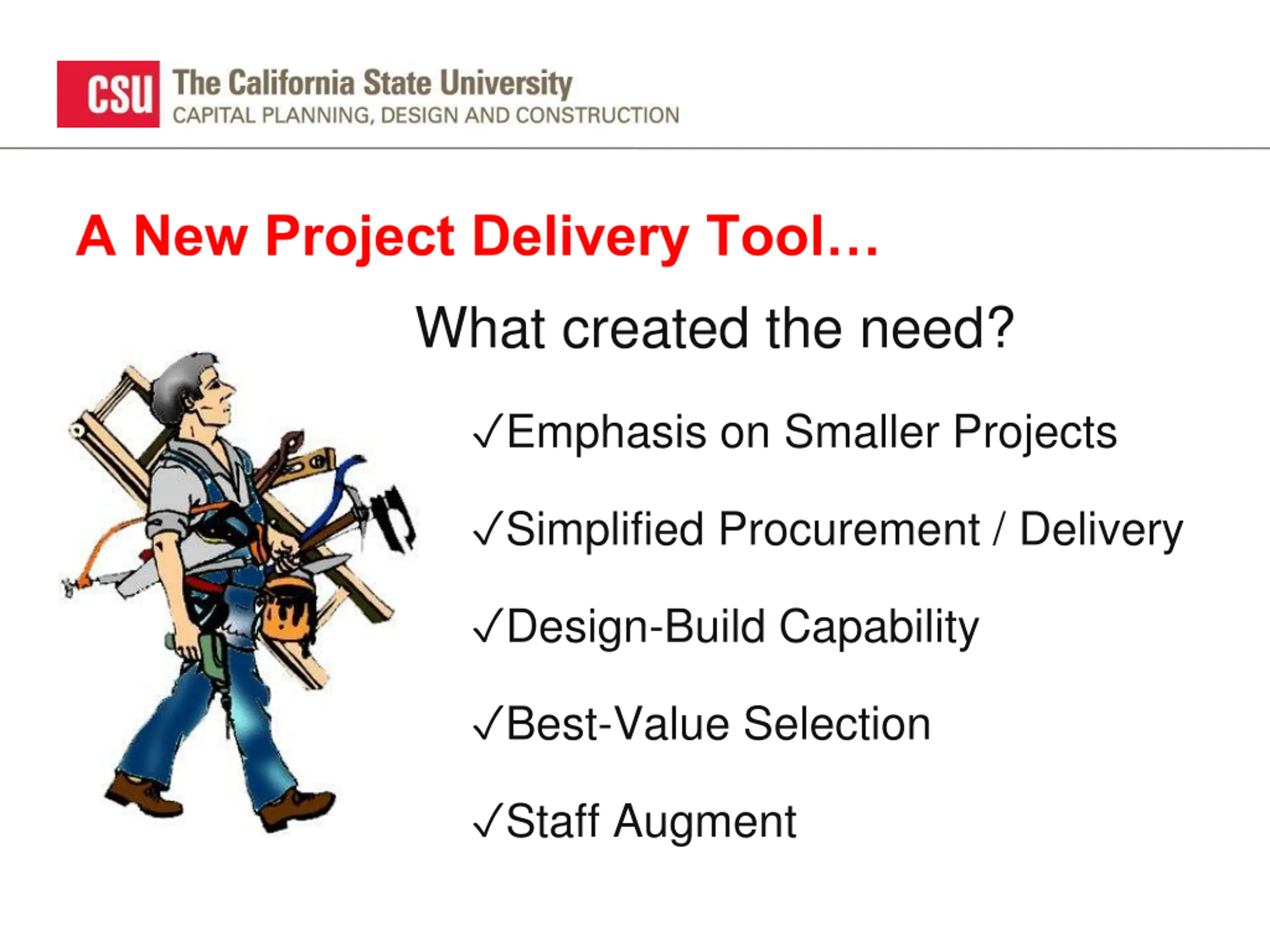

  2. A New Project Delivery Tool What created the need? Emphasis on Smaller Projects Simplified Procurement / Delivery Design-Build Capability Best-Value Selection Staff Augment

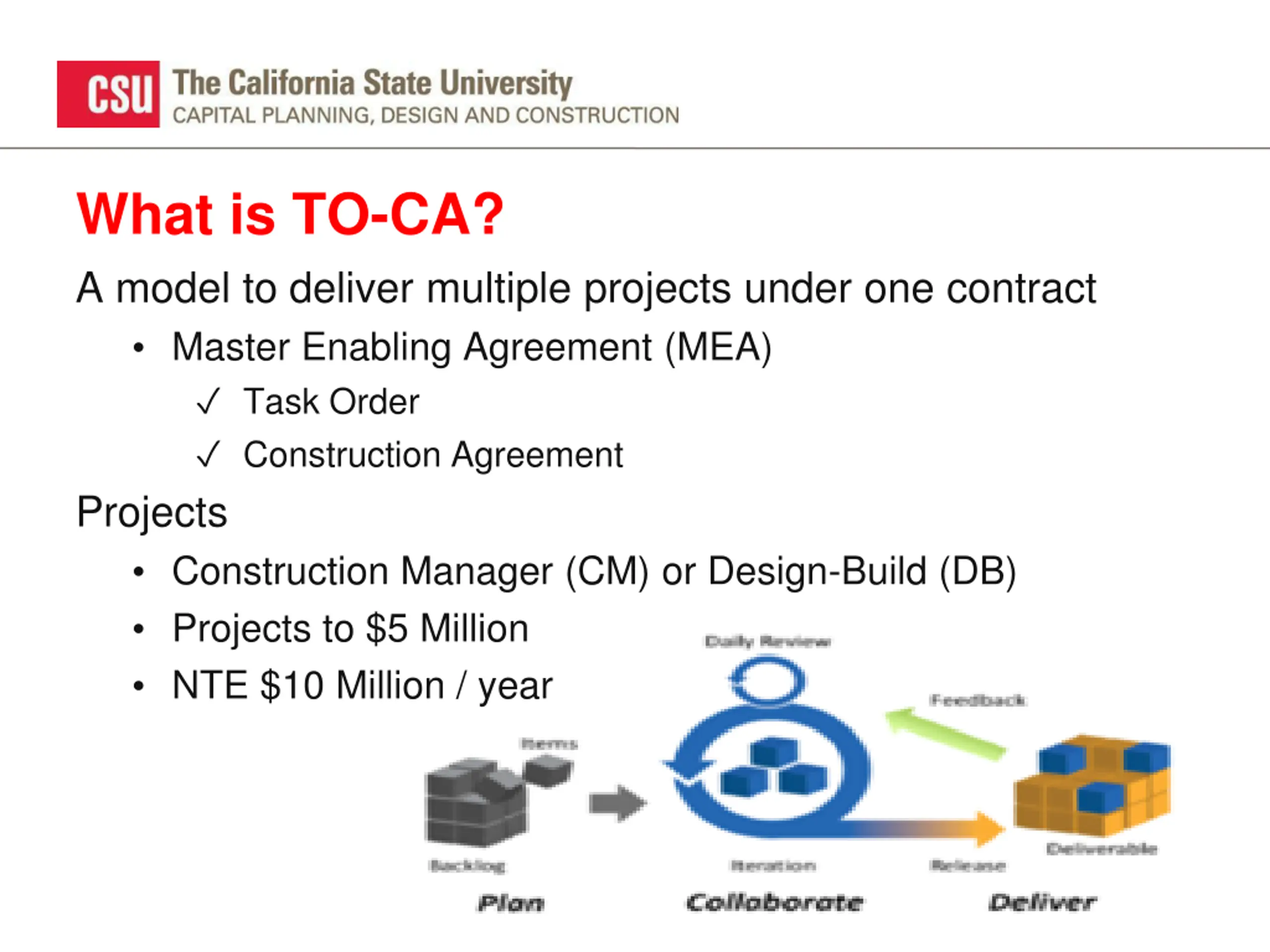

  3. What is TO-CA? A model to deliver multiple projects under one contract Master Enabling Agreement (MEA) Task Order Construction Agreement Projects Construction Manager (CM) or Design-Build (DB) Projects to $5 Million NTE $10 Million / year

  4. What is TO-CA? Selection of Service Provider Two Phase Best Value Request for Qualifications (RFQ) Request for Proposals (RFP) Contract One Year MEA Contract Extension for a second year Projects Preconstruction Negotiated Fees Construction - GC Fee, OH&P and as Bid

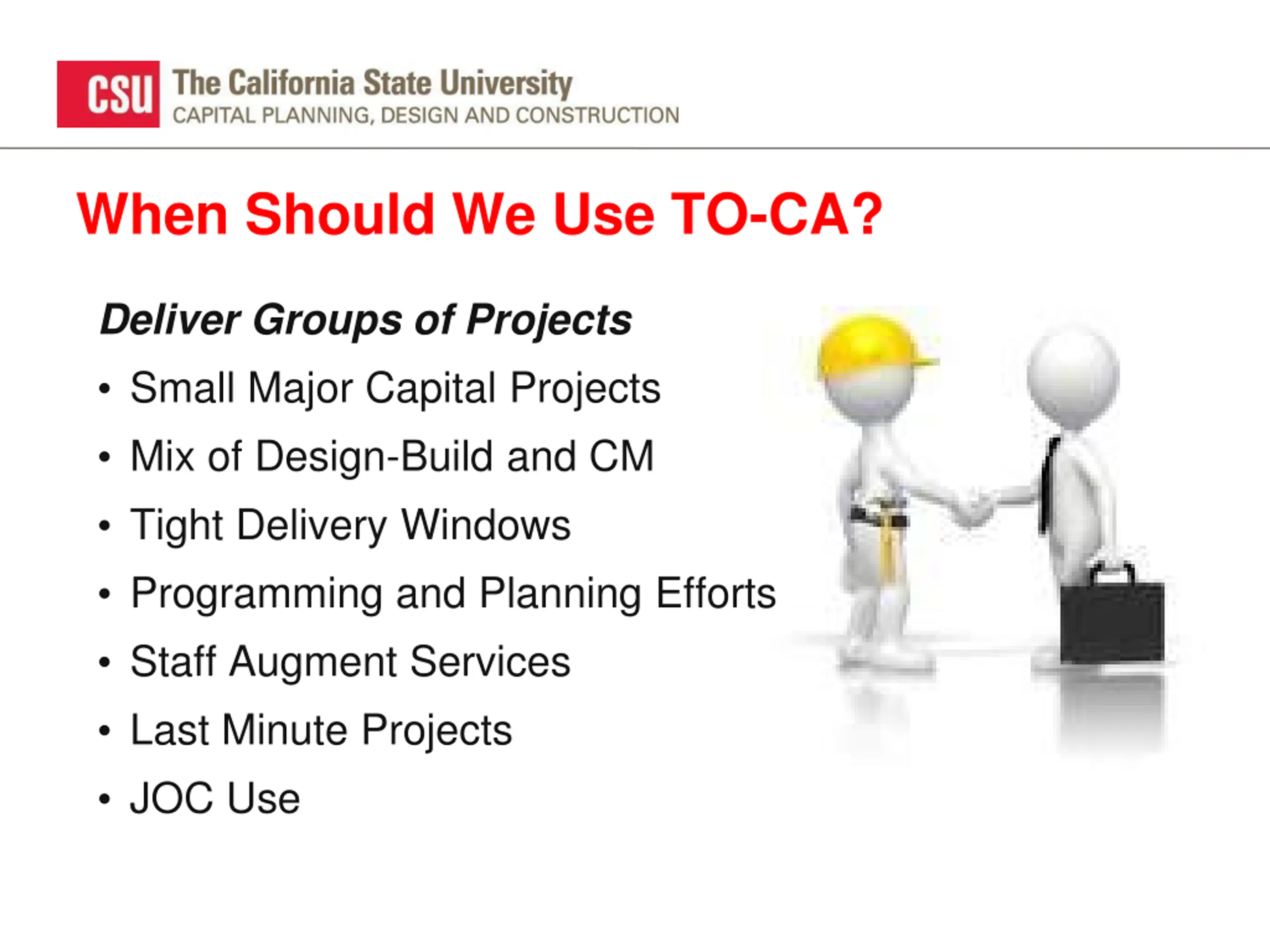

  5. When Should We Use TO-CA? Deliver Groups of Projects Small Major Capital Projects Mix of Design-Build and CM Tight Delivery Windows Programming and Planning Efforts Staff Augment Services Last Minute Projects JOC Use

  6. How Do We Use TO-CA? RFQ List of Projects Schedule Qualifications RFP No Qualifications in RFP Interview / Proposed Team Rider A Cost Component

  7. What is TO-CA? RFP Bid Form Cost Component: Average of three staff rates with highest number of hours: Architectural Services Fees x 2500 hours Consultants Services Fees x 2500 hours Preconstruction Services Fees x 1000 hours Construction Phase Site Management Fee x 4000 hours DB Construction OH&P x 50% of Budgeted D.C.C. CM Construction OH&P x 50% of Budgeted D.C.C. Fee for Assembly of Initial subcontractor bidding pool

  8. How Do We Use TO-CA? Task Orders Negotiated Fees for Services Preconstruction Services Define Scope of Projects Scheduling Estimating Design Services As CM or Design-Builder

  9. How Do We Use TO-CA? Preconstruction Services Subcontractor Bidding Pool Advertise Prequalify Bidding Campus Building Permit Bid to Subcontractor Pool Lump Sum Project Proposal Management Fees as proposed and negotiated OH&P as proposed

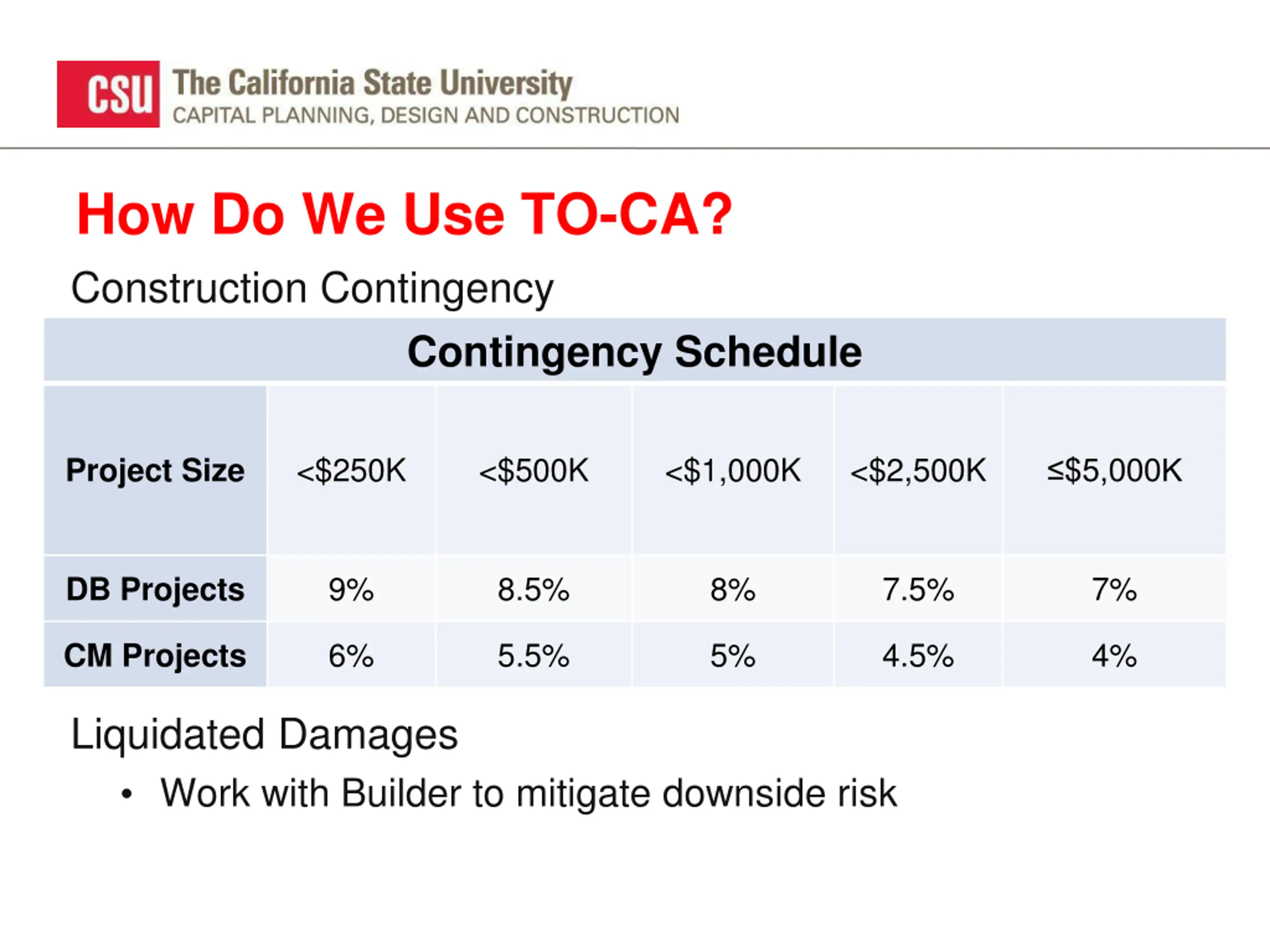

  10. How Do We Use TO-CA? Construction Contingency Contingency Schedule <$250K <$500K <$1,000K <$2,500K Project Size $5,000K 9% 8.5% 8% 7.5% 7% DB Projects 6% 5.5% 5% 4.5% 4% CM Projects Liquidated Damages Work with Builder to mitigate downside risk

  11. How Do We Use TO-CA? Construction Services Construction Agreement Task Order Construction Manager (CM) Design-Build (DB) Owner input on services Construction Agreement Build Project

  12. TO-CA Best Practices DB v. CM Options Listing projects included in RFP Listing of Subcontractors Pre-Process Meeting Single v. Multiple project Task Orders Negotiation of Task Orders

  13. TO-CA Best Practices When is Lump Sum Defined? Review of Lump Sum Contingencies Scheduling

  14. TO-CA Best Practices Project Closeout Lump Sum Contract Punch list Reconciliation of Allowances Project Closeout Checklist Certification of Completion & Occupancy/Release of Retention Notice of Completion Retention

  15. TO-CA Best Practices Risk Teeter Totter Feedback Loop

  16. TO-CA Best Practices It s all about Relationships

  17. TO-CA Road Show Pilot Campuses CPDC TO-CA Training

  18. Questions Discussion ?
