This document provides an overview of the DEMO Work Breakdown Structure (WBS) and WPDES, detailing the project execution plans, conceptual designs, and work packages. It highlights the key components and structure of the project management process.

  • Project Management
  • Work Breakdown Structure
  • Execution Plans
  • Project Design
  • Conceptual Models

Uploaded on Feb 25, 2025 | 21 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. DEMO Work Breakdown Structure and WPDES Alice Beaumont with contributions from G. Federici, C. Baylard, B Meszaros and J. Holden Information Meeting with the Beneficiaries, 20/10/2020 DEMO | 20 October 2020 | Page 1

  2. Overview Work Breakdown Structure (WBS) Project Execution Plans (PEP) Overview of WPDES profiles Example WPDES profiles A Beaumont | 20 October 2020 | Page 2

  3. Work Breakdown Structure 1/6 Plant A DEMO WBS has been created to: strengthen Project Management in the project and, aid development of an integrated DEMO schedule in FP9. The WBS captures all work that will be undertaken on the project. Architecture Fusion Systems Conceptual Design Maintenance Systems Non-Fusion Systems DEMO Engineering Integrated Tools & Processes Phase Independent Project Management Systems Engineering Safety A Beaumont | 20 October 2020 | Page 3

  4. Work Breakdown Structure 2/6 Conceptual Design Plant Architecture A Beaumont | 20 October 2020 | Page 4

  5. Work Breakdown Structure 3/6 Each Work Package WBS has two legs (WP.S and WP.T) plus an additional leg (WP.P) as shown below. Work Package Management (WP.P) System Design (WP.S) Technology R&D (WP.T) A Beaumont | 20 October 2020 | Page 5

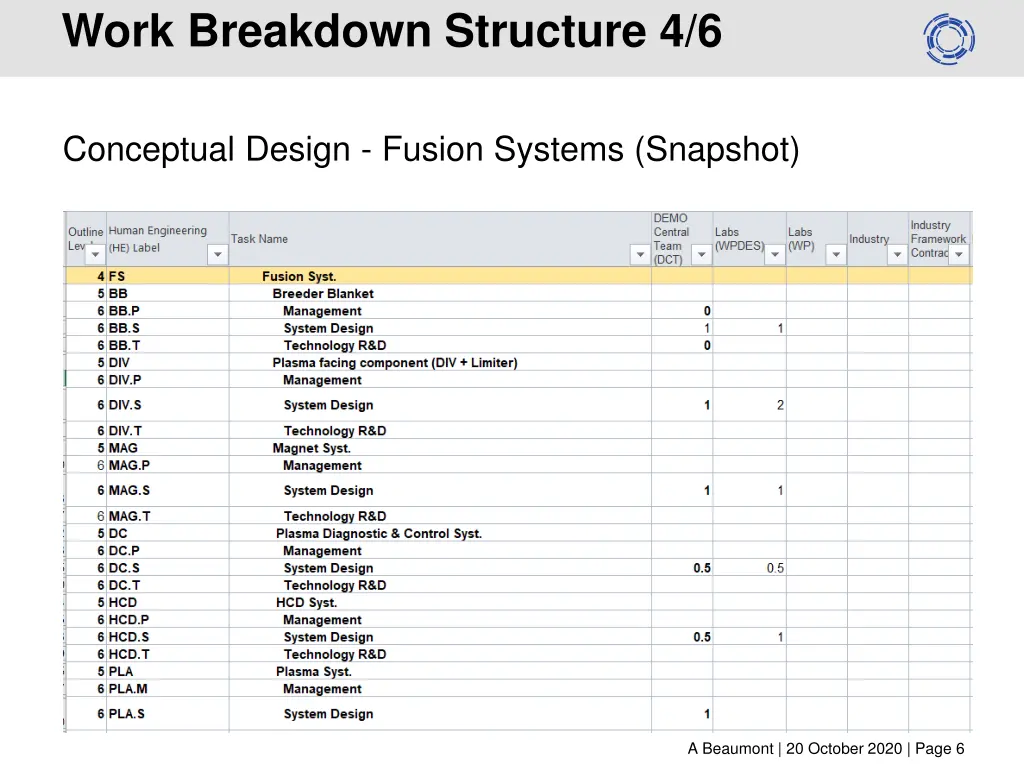

  6. Work Breakdown Structure 4/6 Conceptual Design - Fusion Systems (Snapshot) A Beaumont | 20 October 2020 | Page 6

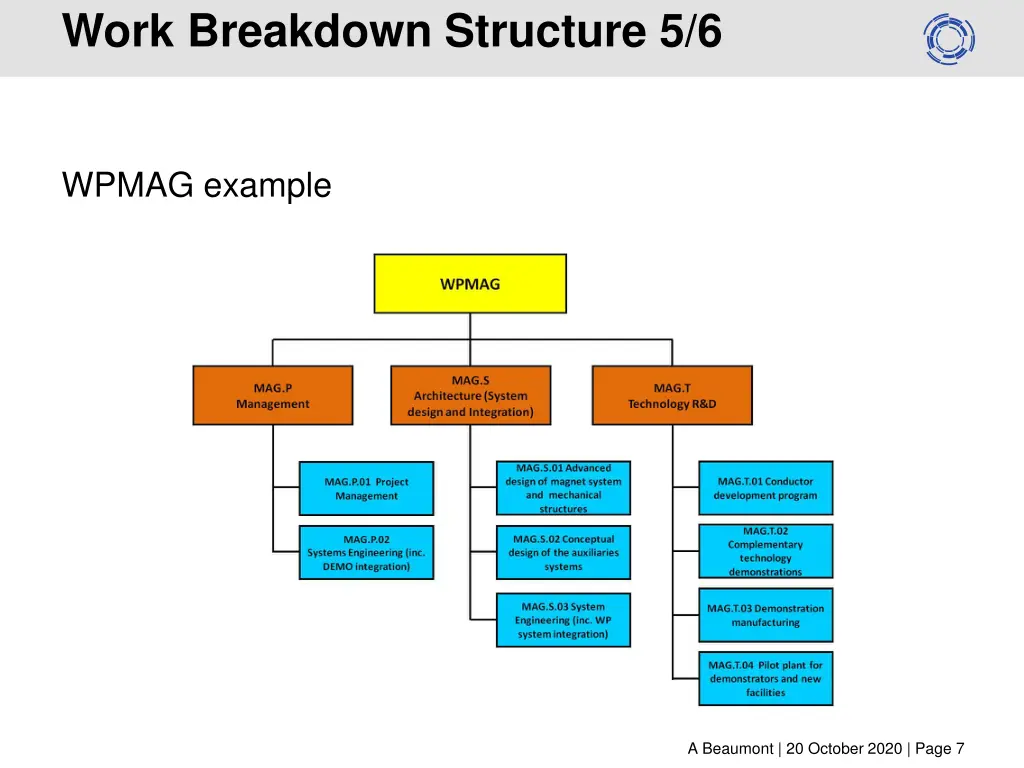

  7. Work Breakdown Structure 5/6 WPMAG example A Beaumont | 20 October 2020 | Page 7

  8. Work Breakdown Structure 6/6 Phase Independent Engineering (Snapshot) A Beaumont | 20 October 2020 | Page 8

  9. Project Execution Plan (PEP) 1/4 Each WP has a PEP broken down into the below sections: Section 1 Project Description Section 2 WBS Section 3 Gantt Chart, Milestones and Deliverables Section 4 Facilities, Industrial Involvement and International Collaboration Section 5 - Budget The PEP has intentionally been kept at a higher level therefore if you have detailed questions then please address these questions to the WP Leads. A Beaumont | 20 October 2020 | Page 9

  10. Project Execution Plan (PEP) 2/4 Example WPBB WBS, Gantt Chart and Milestones WBS-BB.S System Design Requirements, Design, Analyses, Integration and development of design tools for the PB analysed in the WPBB. This element contains the tasks related to the System Engineering (i.e. System Requirements, Interface Management and Risk Analysis for the whole BB Project) Design activities (Blanket System Design and TER) of the different PBS elements considered in the BB Project Design activities for the HCPB BB System intended as in-vessel components, including the connecting pipes of the coolant and purge system up to the VV. Design activities for the HCPB TER System intended as ex-vessel component including the piping system that interface at level of VV the BB System and at level of the Tritium Building the Fuel Cycle System. The system includes the He purge loop with the He removal system and the relative auxiliary systems that recover tritium for the Fuel Cycle. Design activities for the WCLL BB System intended as in-vessel components, including the connecting pipes of the coolant and PbLi Loop up to the VV. In particular MHD analyses of the effects of magnetic field transients due to off-normal events as plasma disruptions and coils fast discharge. Design activities for the WCLL TER System intended as ex-vessel component including the piping system that interface at level of VV the BB System and at level of the Tritium Building the Fuel Cycle System. The system includes the PbLi loop with the T extraction units and the relative auxiliary systems that recover T for the Fuel Cycle. WBS-BB.S.01 Systems Engineering System/ component Design HCPB BB System Design HCPB TER System Design WBS-BB.S.02 WBS-BB.S.02.01 WBS-BB.S.02.02 WBS-BB.S.02.03 WCLL BB System Design WBS-BB.S.02.04 WCLL TER System Design https://idm.euro-fusion.org/?uid=2P6W3D A Beaumont | 20 October 2020 | Page 10

  11. Project Execution Plan (PEP) 3/4 Milestone ID Title (short description) WBS ID Grant Milestone Date BB.S-M2021 Readiness Review WBS-BB.S.01 Dec-21 BB.S-M2.1.1 Preliminary conceptual design for the HCPB BB System concluded WBS-BB.S.02.01 Dec-22 BB.S-M2.2.1 Preliminary conceptual design for the HCPB TER System concluded WBS-BB.S.02.02 Dec-22 BB.S-M2.3.1 Preliminary conceptual design for the WCLL BB System concluded WBS-BB.S.02.03 Dec-22 BB.S-M2.4.1 Preliminary conceptual design for the WCLL TER System concluded WBS-BB.S.02.04 Dec-22 BB.S-M2.1.2 Reference conceptual design for the HCPB BB System defined WBS-BB.S.02.01 X Oct-24 BB.S-M2.2.2 Reference conceptual design for the HCPB TER System defined WBS-BB.S.02.02 X Oct-24 BB.S-M2.3.2 Reference conceptual design for the WCLL BB System defined WBS-BB.S.02.03 X Oct-24 BB.S-M2.4.2 Reference conceptual design for the WCLL TER System defined WBS-BB.S.02.04 X Oct-24 BB.S-MG2 Gate G2 WBS-BB.P.01 X Dec-24 https://idm.euro-fusion.org/?uid=2P6W3D A Beaumont | 20 October 2020 | Page 11

  12. Project Execution Plan (PEP) 4/4 All PEPs can be found on IDM Work Package IDM Reference DEMO DCT & WPDES BB BOP DC DIV HCD MAG MAT PES RM SAE TFV https://idm.euro-fusion.org/?uid=2NV475 https://idm.euro-fusion.org/?uid=2NLDR3 https://idm.euro-fusion.org/?uid=2P6W3D https://idm.euro-fusion.org/?uid=2N8TGR https://idm.euro-fusion.org/?uid=2P97Z2 https://idm.euro-fusion.org/?uid=2NEB92 https://idm.euro-fusion.org/?uid=2PCTZL https://idm.euro-fusion.org/?uid=2NTVQU https://idm.euro-fusion.org/?uid=2NPQTP https://idm.euro-fusion.org/?uid=2NV5NM https://idm.euro-fusion.org/?uid=2MN7X3 https://idm.euro-fusion.org/?uid=2NYXSJ https://idm.euro-fusion.org/?uid=2NYW97 A Beaumont | 20 October 2020 | Page 12

  13. WPDES The WPDES assists the DEMO Central Team (DCT). The WPDES Call for Participation will be done in terms of profiles rather than task specifications. The example profiles shown in the next slides will be included as an annex in the Call for Participation. The WPDES manpower is envisaged to increase year on year. A Beaumont | 20 October 2020 | Page 13

  14. WPDES Profile Example 1 A Beaumont | 20 October 2020 | Page 14

  15. WPDES Profile Example 2 A Beaumont | 20 October 2020 | Page 15

  16. WPDES Profile Example 3 A Beaumont | 20 October 2020 | Page 16

  17. Summary The DEMO WBS will enable the DEMO Integrated Schedule to be developed in FP9. The WPDES Call for Participation will be profiles rather than task specifications. If you have detailed questions regarding the PEPs and WBS then please address these questions to the WP Leads. A Beaumont | 20 October 2020 | Page 17
