DOT Constrained Resources & Leave Request Guidelines

DOT Constrained Resources & Leave Request Guidelines
Slide Note
Embed
Share

This content showcases guidelines for managing DOT constrained resources and establishing consistent leave notification approaches for staff and consultants. It covers topics such as vacation request procedures, leave notification responsibilities, and acceptance criteria for load tickets. The visual aids provide clarity on resource management processes within the organization.

  • Resource Management
  • Leave Requests
  • Vacation Procedures
  • Load Tickets
  • DOT Guidelines

Uploaded on Mar 16, 2025 | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. Micheal Hoelker & Todd Matheson

  2. New Training Format 2

  3. 3

  4. DOT Constrained Resources Limited ability to cover unforeseen Resource Demands compared to previous years. 4

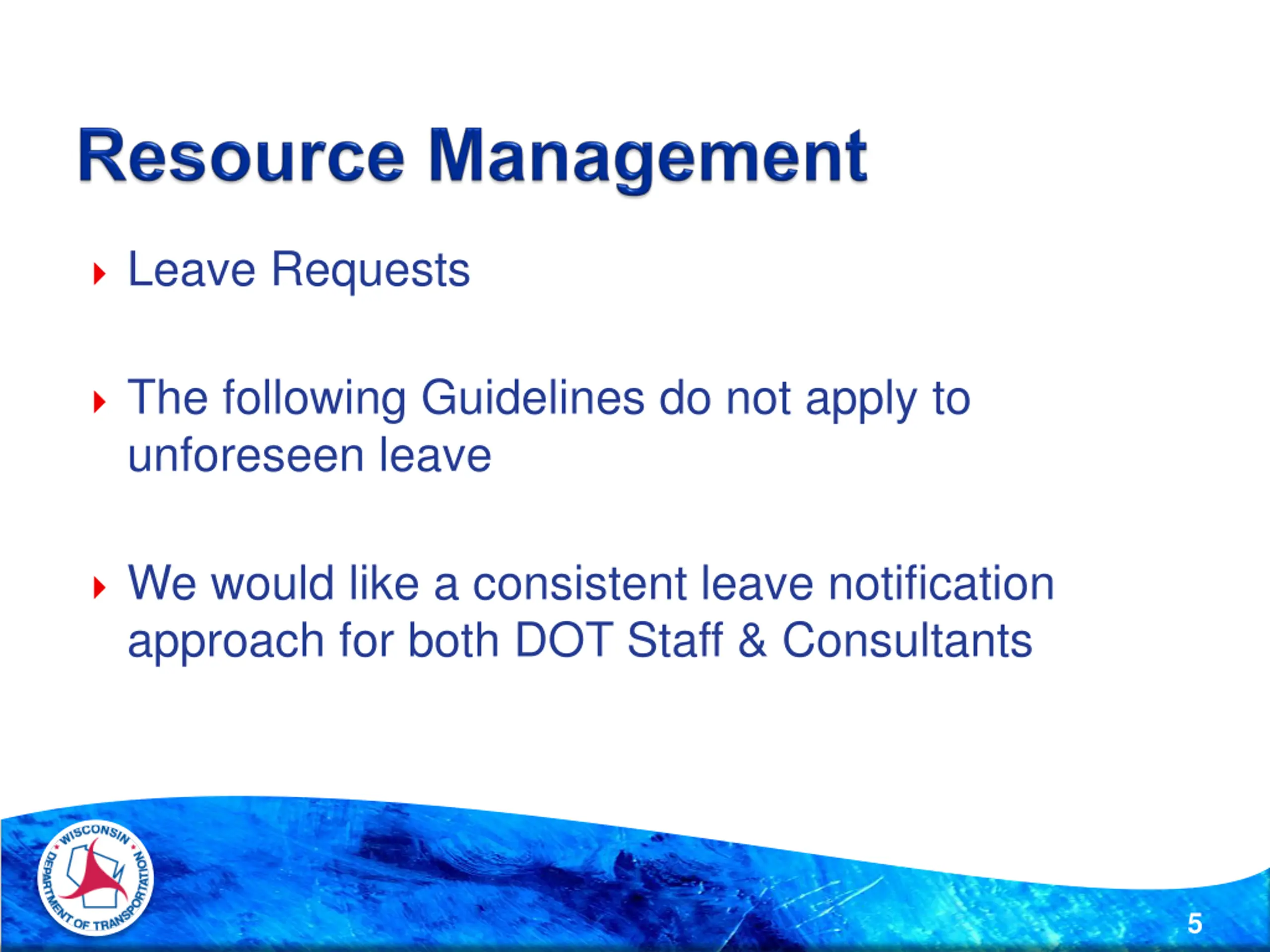

  5. Leave Requests The following Guidelines do not apply to unforeseen leave We would like a consistent leave notification approach for both DOT Staff & Consultants 5

  6. Vacation requests should be submitted a reasonable time prior to the date/time of the vacation. A reasonable time is at least equivalent to time being requested, though, it is recommended that a request be made as soon as the need or event is known. 6

  7. Leave Requests to WisDOT Supervisor (PM should be made aware by either supervisor or employee) Supervisor is responsible for review, approval and resource coverage. 7

  8. Leave Requests to WisDOT Supervisor (PM should be made aware by either supervisor or consultant) Consulting Firm will propose coverage plan to WisDOT Supervisor. Supervisor is responsible for review and approval of Consulting Firm s resource coverage proposal. 8

  9. How late do we accept load tickets? - Day Late? - Week Late? - Up to the day before the next Estimate? - Substantial Complete? - Tentative Final? - Just prior to Final Estimate? 9

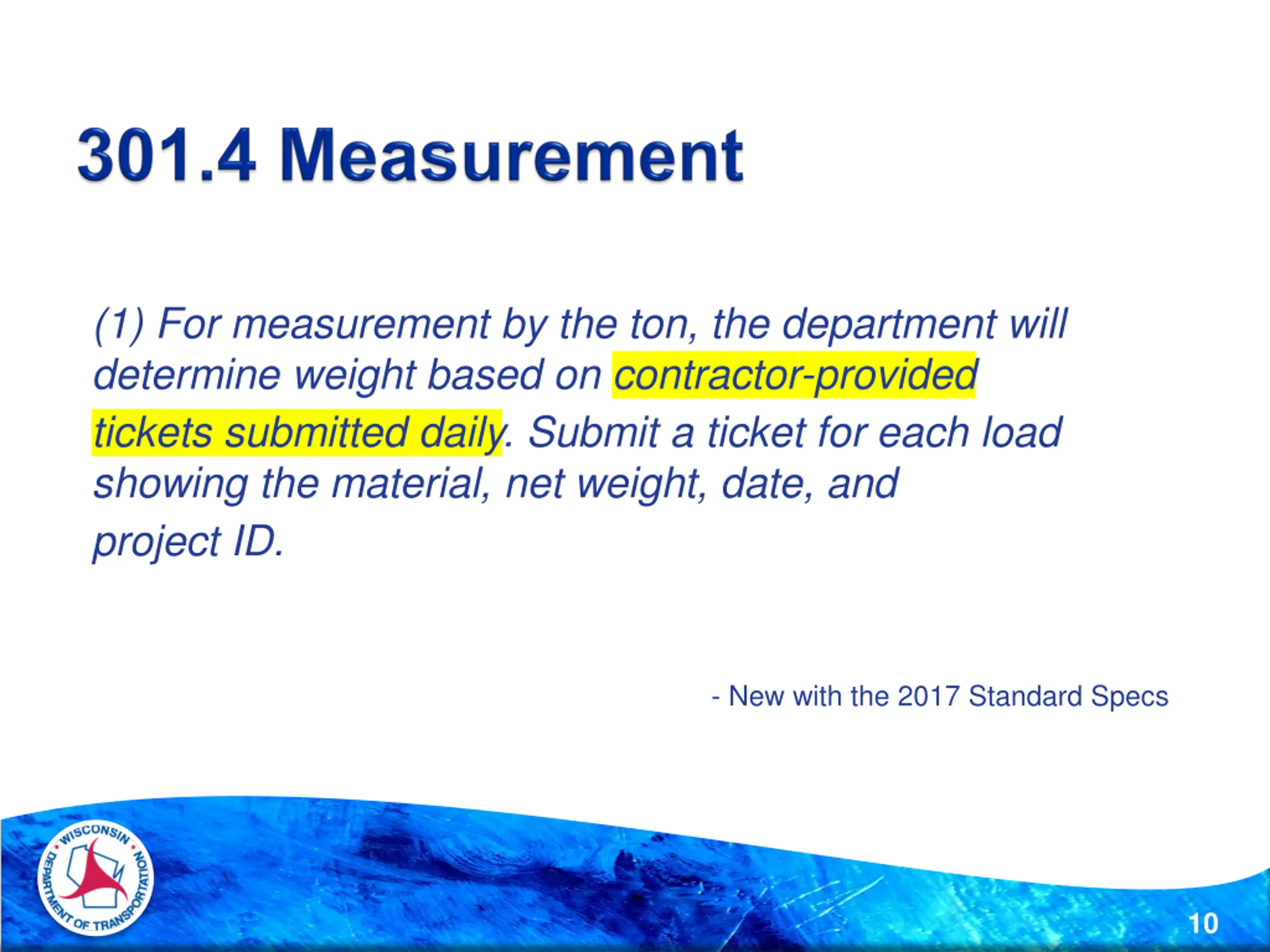

  10. (1) For measurement by the ton, the department will determine weight based on contractor-provided tickets submitted daily. Submit a ticket for each load showing the material, net weight, date, and project ID. - New with the 2017 Standard Specs 10

  11. Concern over projects not being completed on time. Recent examples of projects being very late with high dollar LDs. Be mindful of Section 108 as it relates to project schedules. Contractor s schedules need to conform with the requirements outlined in Section 108. If not request additions and or corrections. 11

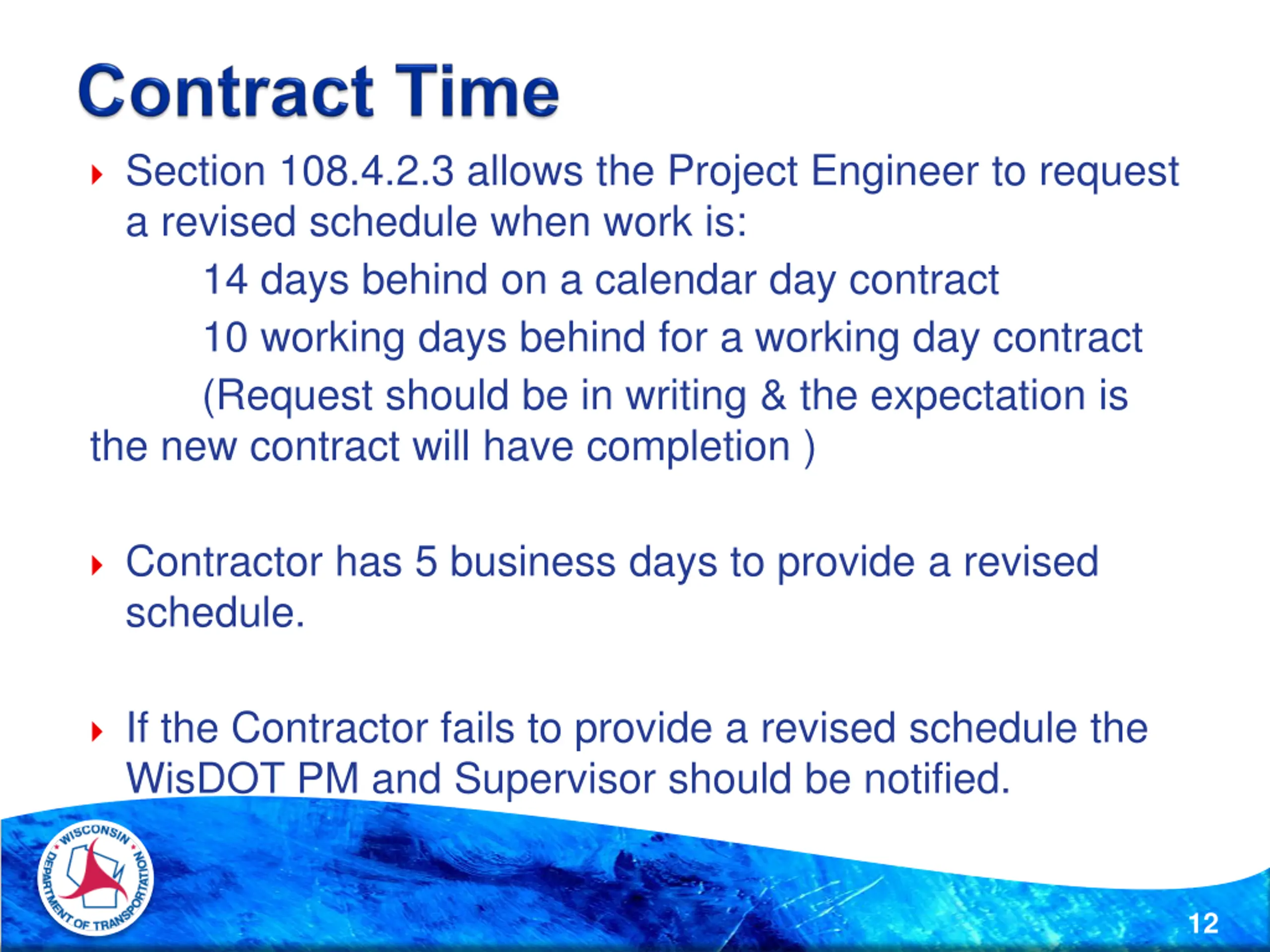

  12. Section 108.4.2.3 allows the Project Engineer to request a revised schedule when work is: 14 days behind on a calendar day contract 10 working days behind for a working day contract (Request should be in writing & the expectation is the new contract will have completion ) Contractor has 5 business days to provide a revised schedule. If the Contractor fails to provide a revised schedule the WisDOT PM and Supervisor should be notified. 12

  13. Extra work where additional time is justified as outlined in 108.10 it should be handled with a change order at the time of change. No black-book time. End of the project. Time should not be stopped until all work under pay items are completed. Time does not necessarily stop with the road open to traffic. PMs should be involved and concur with substantially complete and stopping contract time at the end of the project. 13
