ERCOT Outage Study Cases in SOTE
Explore the SCR799 project by ERCOT for outage study cases within the System Operations Test Environment (SOTE). This tool ensures quick access to Network Operations Model and Real-Time State Estimator results, improving outage evaluation efficiency for Transmission Service Providers (TSPs). Implementation set to begin in June 2024 with completion by Q4 of the same year.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
SCR799 ERCOT Outage Study Cases in the System Operations Test Environment (SOTE) Shireesha Methuku May 29, 2024

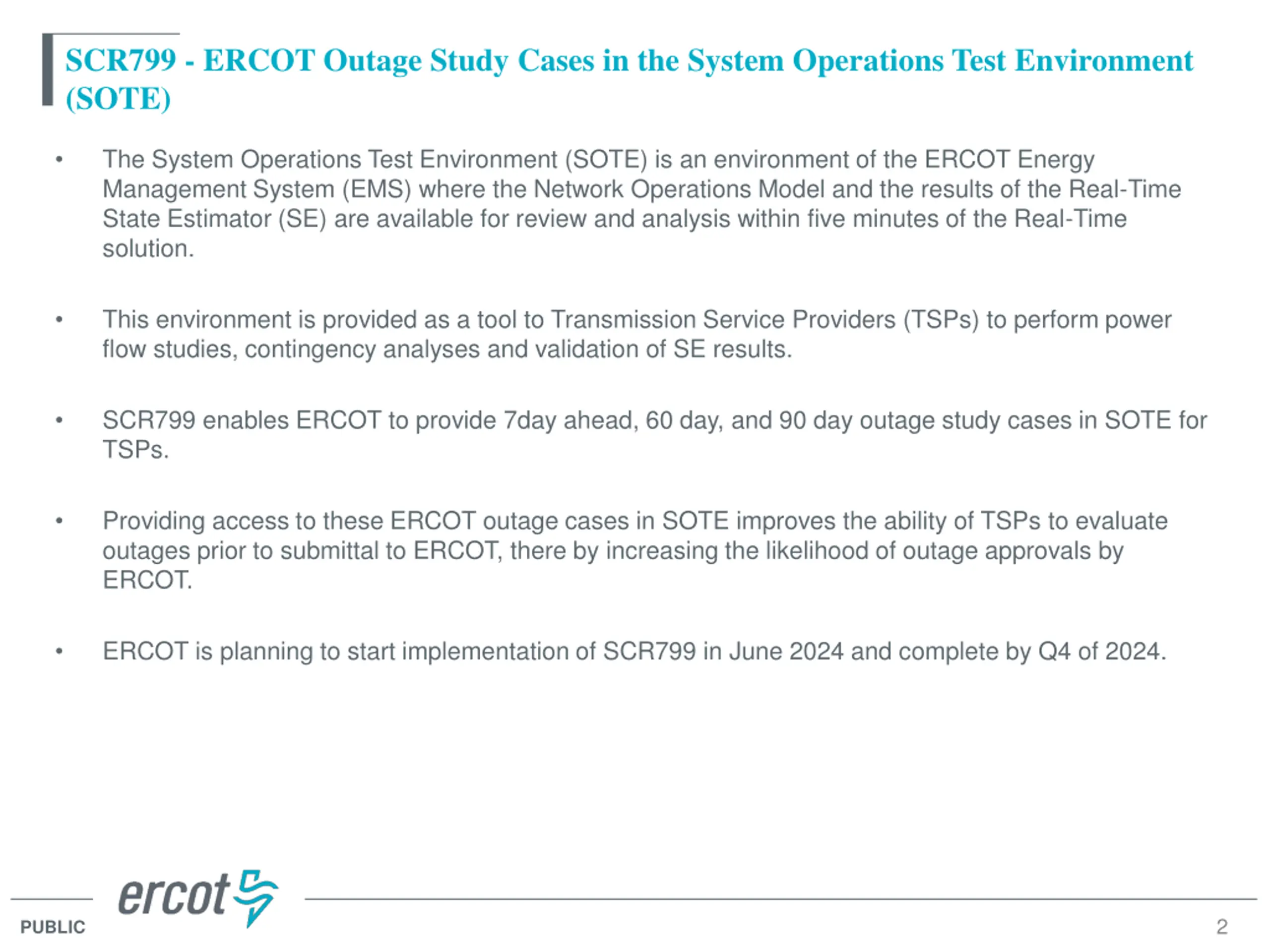

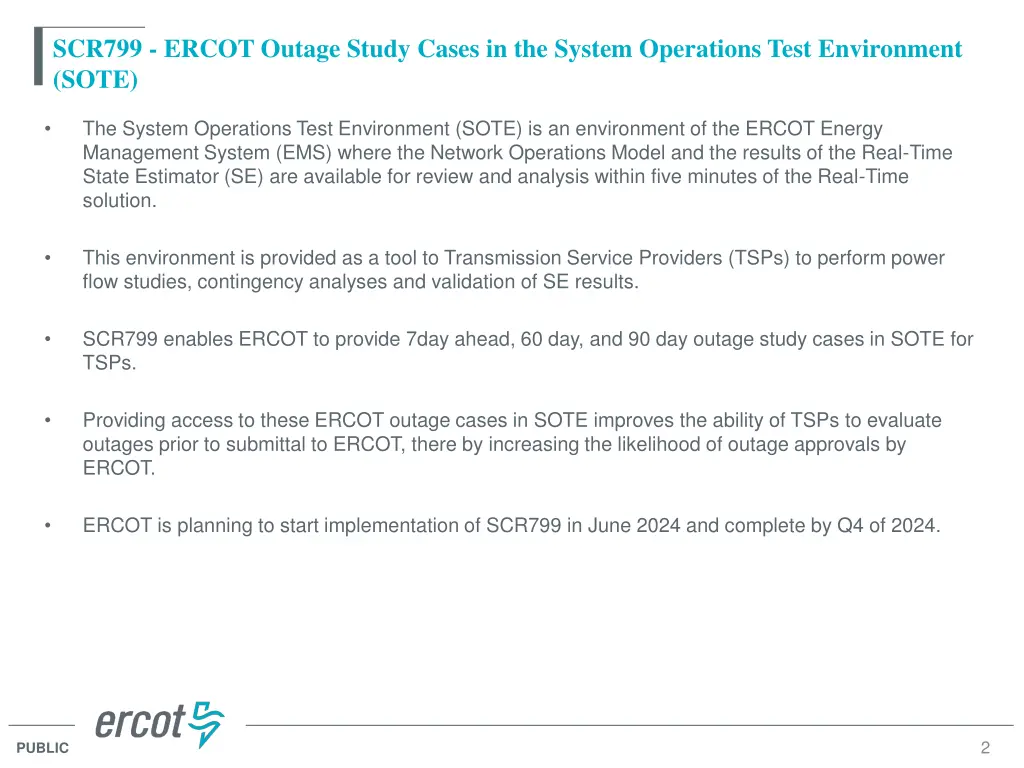

SCR799 - ERCOT Outage Study Cases in the System Operations Test Environment (SOTE) The System Operations Test Environment (SOTE) is an environment of the ERCOT Energy Management System (EMS) where the Network Operations Model and the results of the Real-Time State Estimator (SE) are available for review and analysis within five minutes of the Real-Time solution. This environment is provided as a tool to Transmission Service Providers (TSPs) to perform power flow studies, contingency analyses and validation of SE results. SCR799 enables ERCOT to provide 7day ahead, 60 day, and 90 day outage study cases in SOTE for TSPs. Providing access to these ERCOT outage cases in SOTE improves the ability of TSPs to evaluate outages prior to submittal to ERCOT, there by increasing the likelihood of outage approvals by ERCOT. ERCOT is planning to start implementation of SCR799 in June 2024 and complete by Q4 of 2024. 2 PUBLIC

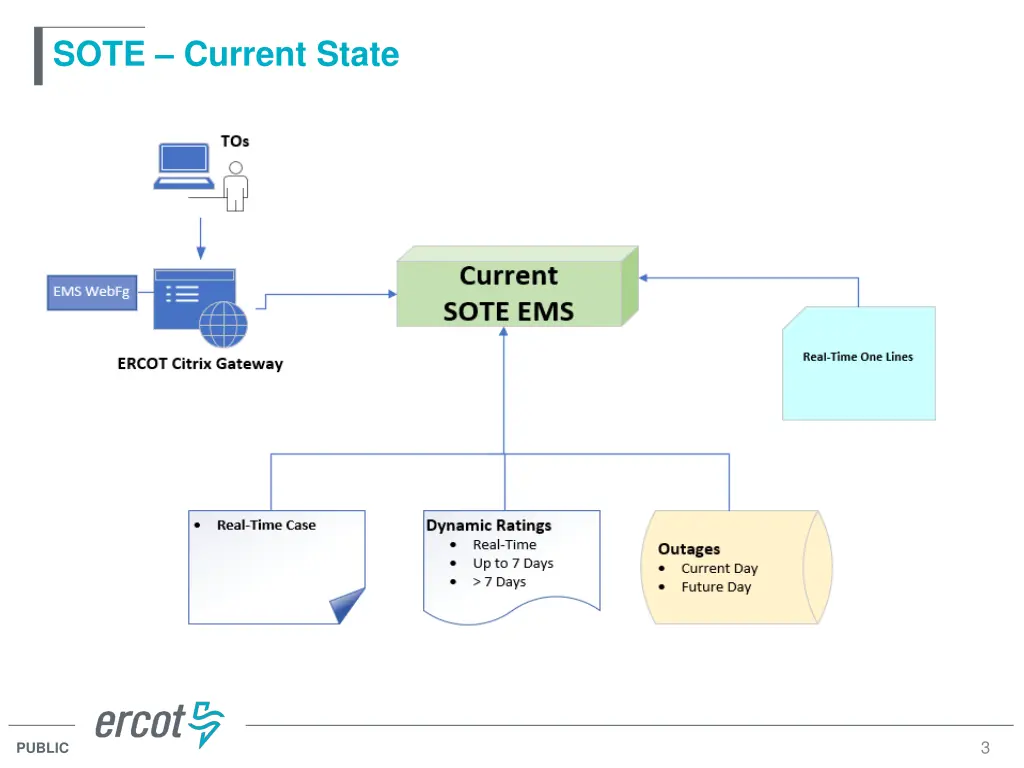

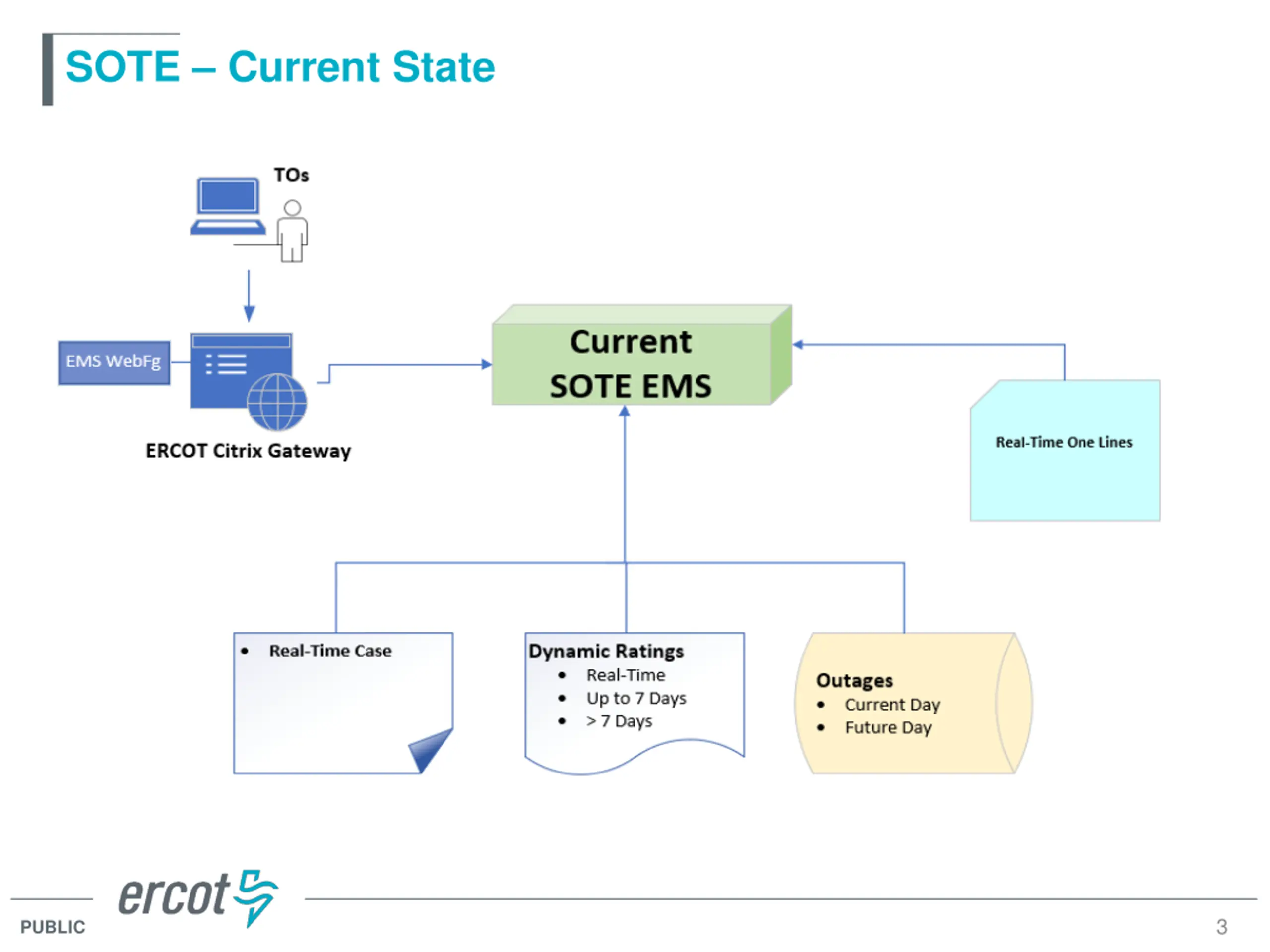

SOTE Current State 3 PUBLIC

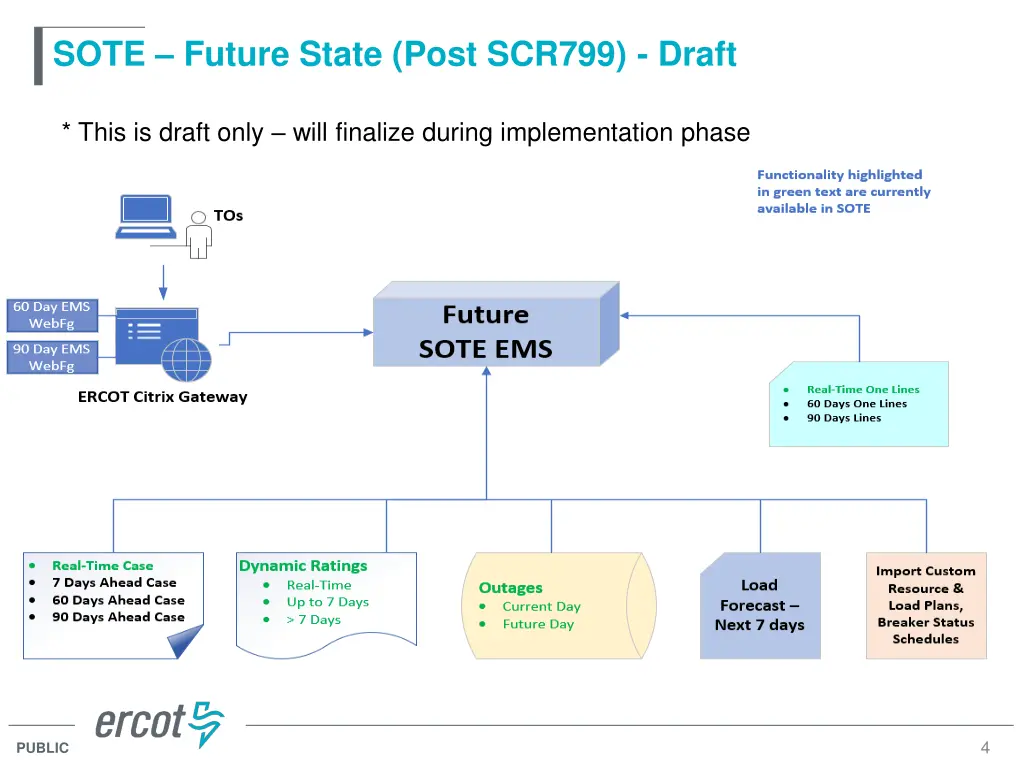

SOTE Future State (Post SCR799) - Draft * This is draft only will finalize during implementation phase 4 PUBLIC
