ERCOT Point-to-Point Submission Activity Analysis

day ahead market ptp and ptplo submission activity n.w
1 / 7
Embed
Share

Explore how ERCOT analyzes the impact of Point-to-Point (PTP) submissions on performance, proposes fees for unawarded PTPs, and considers measures to manage submission volumes for optimization in the Day-Ahead Market (DAM).

  • ERCOT
  • PTP submissions
  • Market analysis
  • Optimization
  • Performance

Uploaded on | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. Day-Ahead Market PTP and PTPLO Submission Activity April 14, 2025 Curry Holden Day-Ahead Market Supervisor

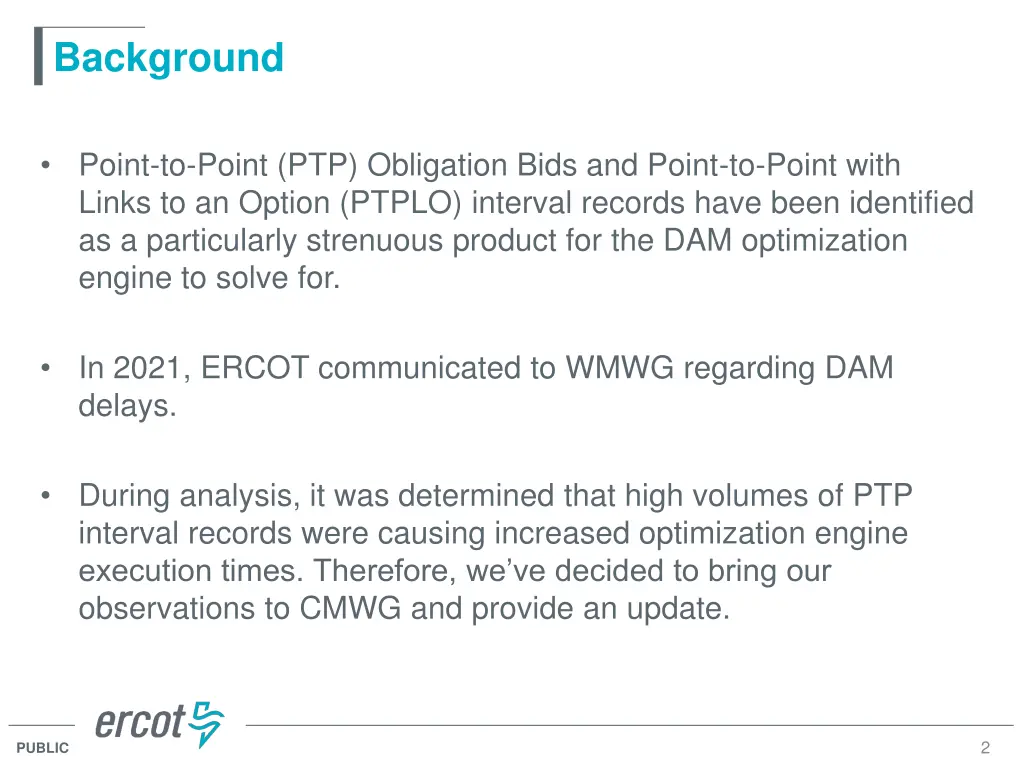

  2. Background Point-to-Point (PTP) Obligation Bids and Point-to-Point with Links to an Option (PTPLO) interval records have been identified as a particularly strenuous product for the DAM optimization engine to solve for. In 2021, ERCOT communicated to WMWG regarding DAM delays. During analysis, it was determined that high volumes of PTP interval records were causing increased optimization engine execution times. Therefore, we ve decided to bring our observations to CMWG and provide an update. 2 PUBLIC

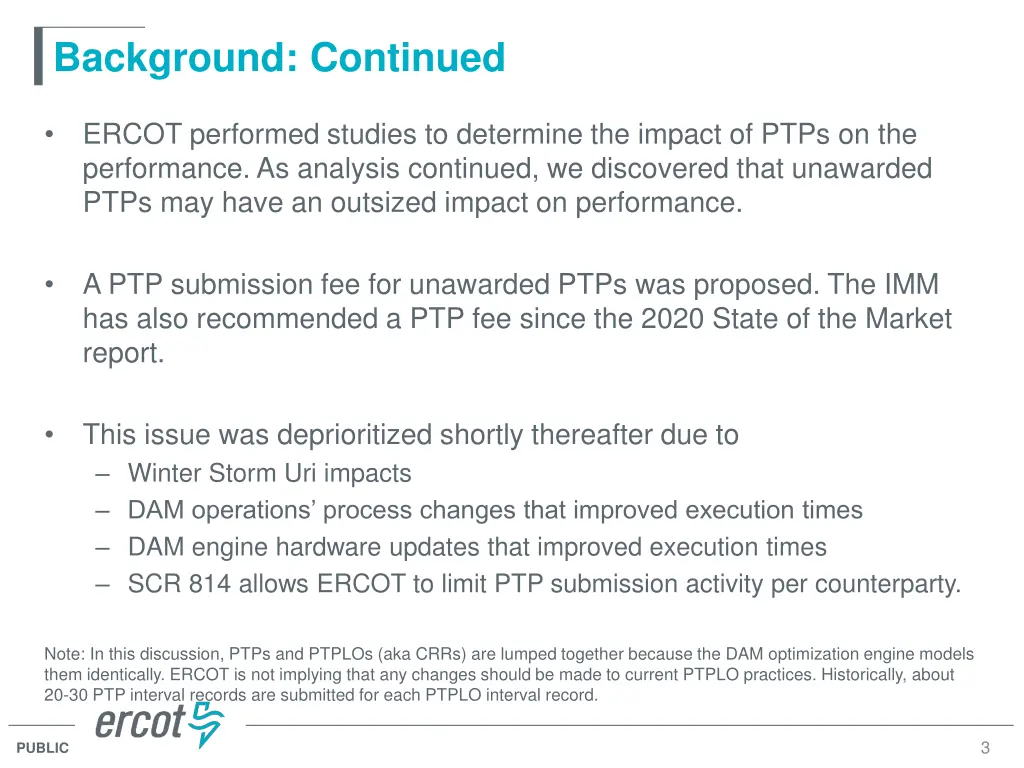

  3. Background: Continued ERCOT performed studies to determine the impact of PTPs on the performance. As analysis continued, we discovered that unawarded PTPs may have an outsized impact on performance. A PTP submission fee for unawarded PTPs was proposed. The IMM has also recommended a PTP fee since the 2020 State of the Market report. This issue was deprioritized shortly thereafter due to Winter Storm Uri impacts DAM operations process changes that improved execution times DAM engine hardware updates that improved execution times SCR 814 allows ERCOT to limit PTP submission activity per counterparty. Note: In this discussion, PTPs and PTPLOs (aka CRRs) are lumped together because the DAM optimization engine models them identically. ERCOT is not implying that any changes should be made to current PTPLO practices. Historically, about 20-30 PTP interval records are submitted for each PTPLO interval record. 3 PUBLIC

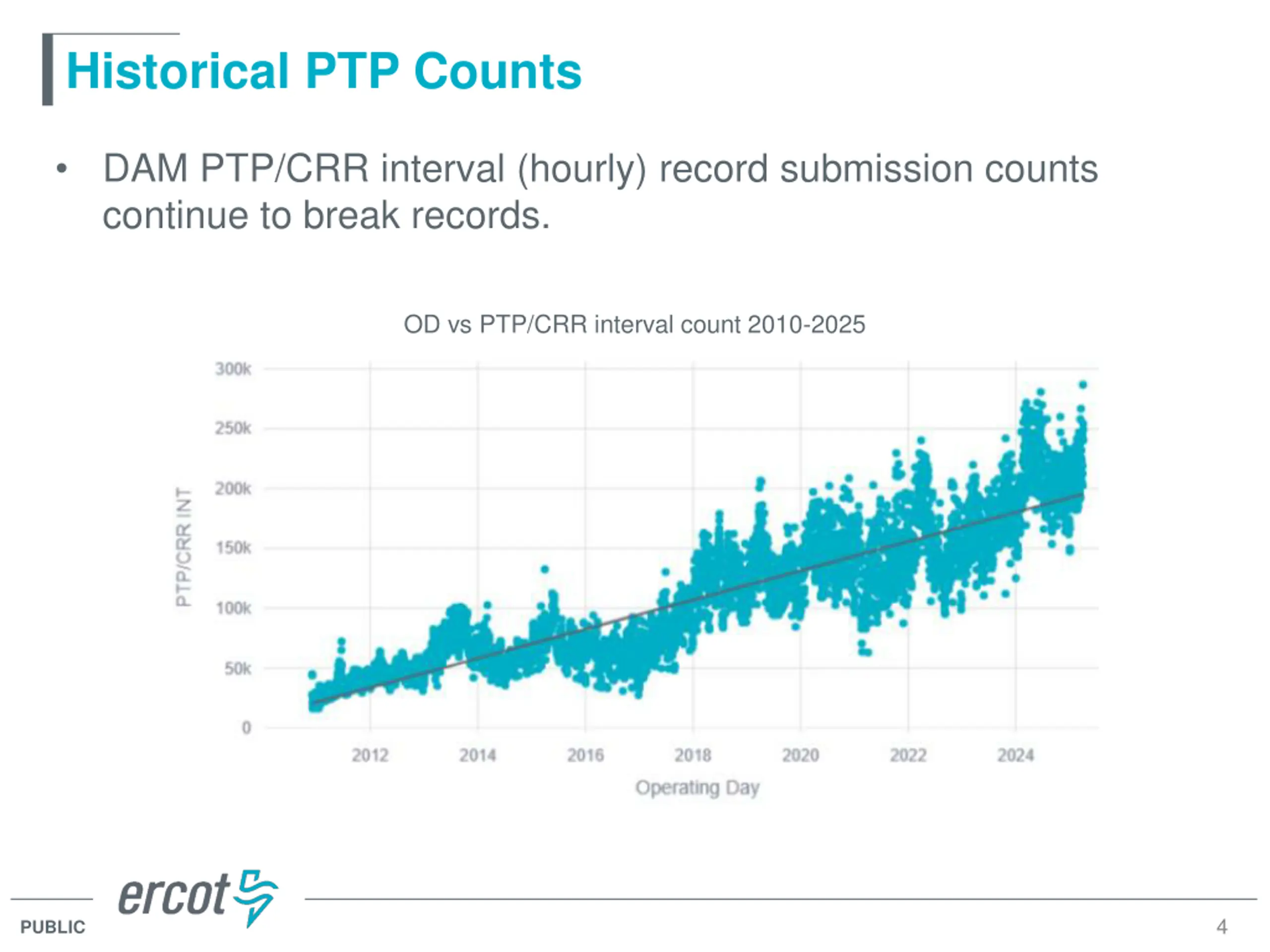

  4. Historical PTP Counts DAM PTP/CRR interval (hourly) record submission counts continue to break records. OD vs PTP/CRR interval count 2010-2025 4 PUBLIC

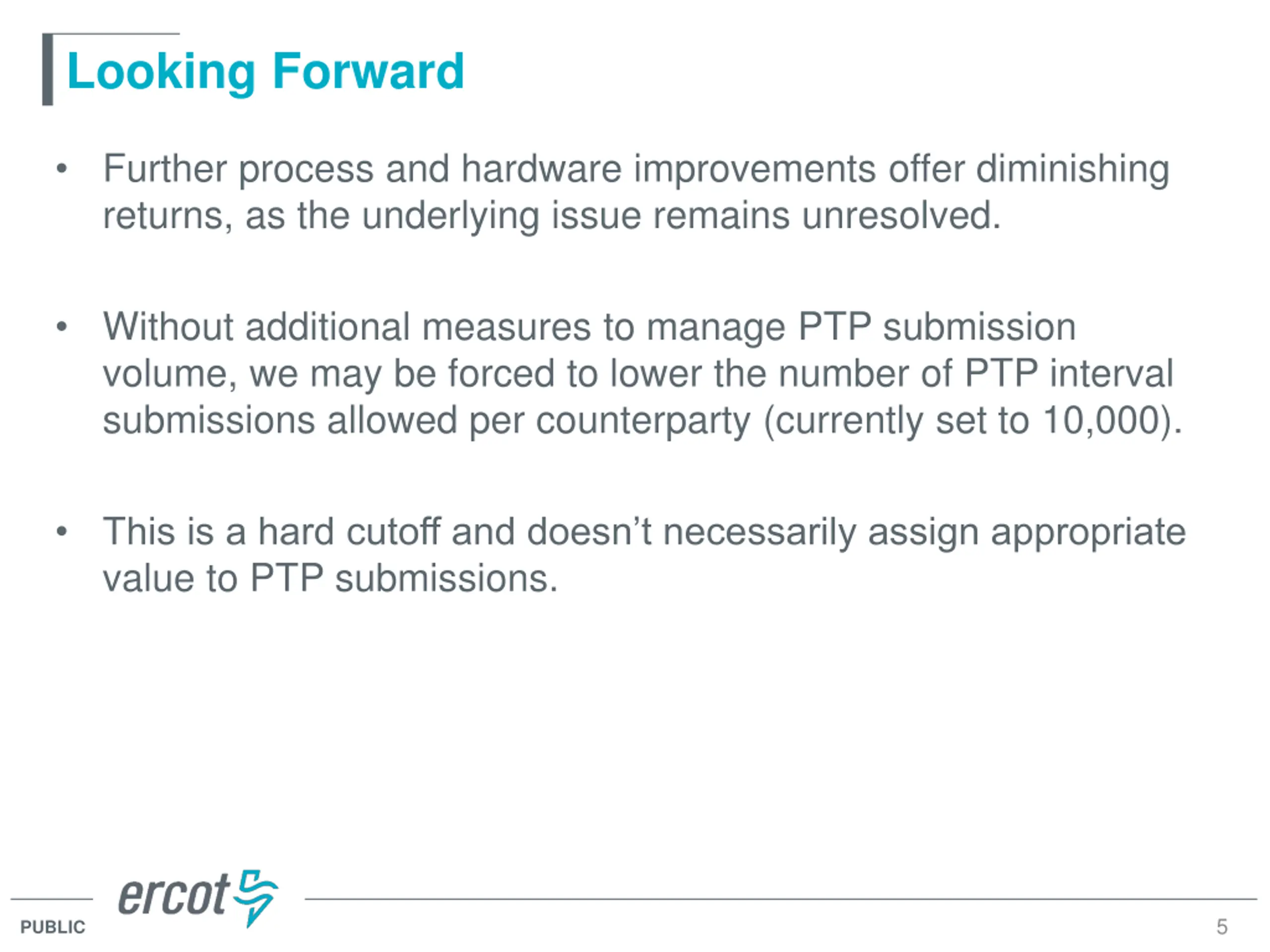

  5. Looking Forward Further process and hardware improvements offer diminishing returns, as the underlying issue remains unresolved. Without additional measures to manage PTP submission volume, we may be forced to lower the number of PTP interval submissions allowed per counterparty (currently set to 10,000). This is a hard cutoff and doesn t necessarily assign appropriate value to PTP submissions. 5 PUBLIC

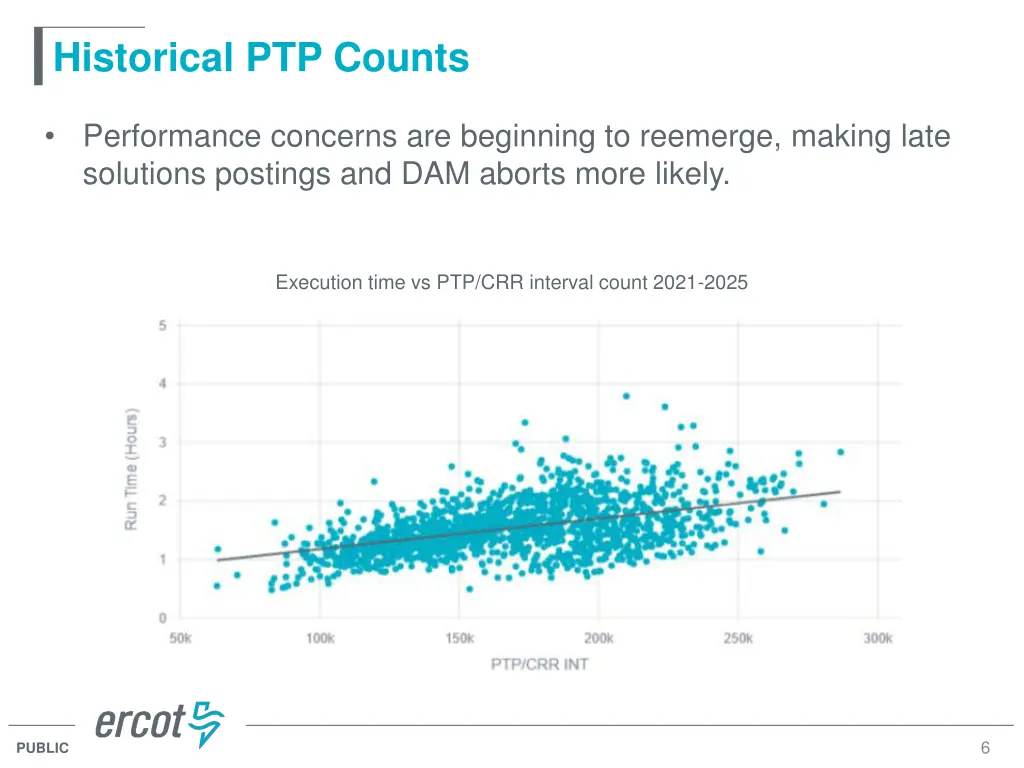

  6. Historical PTP Counts Performance concerns are beginning to reemerge, making late solutions postings and DAM aborts more likely. Execution time vs PTP/CRR interval count 2021-2025 6 PUBLIC

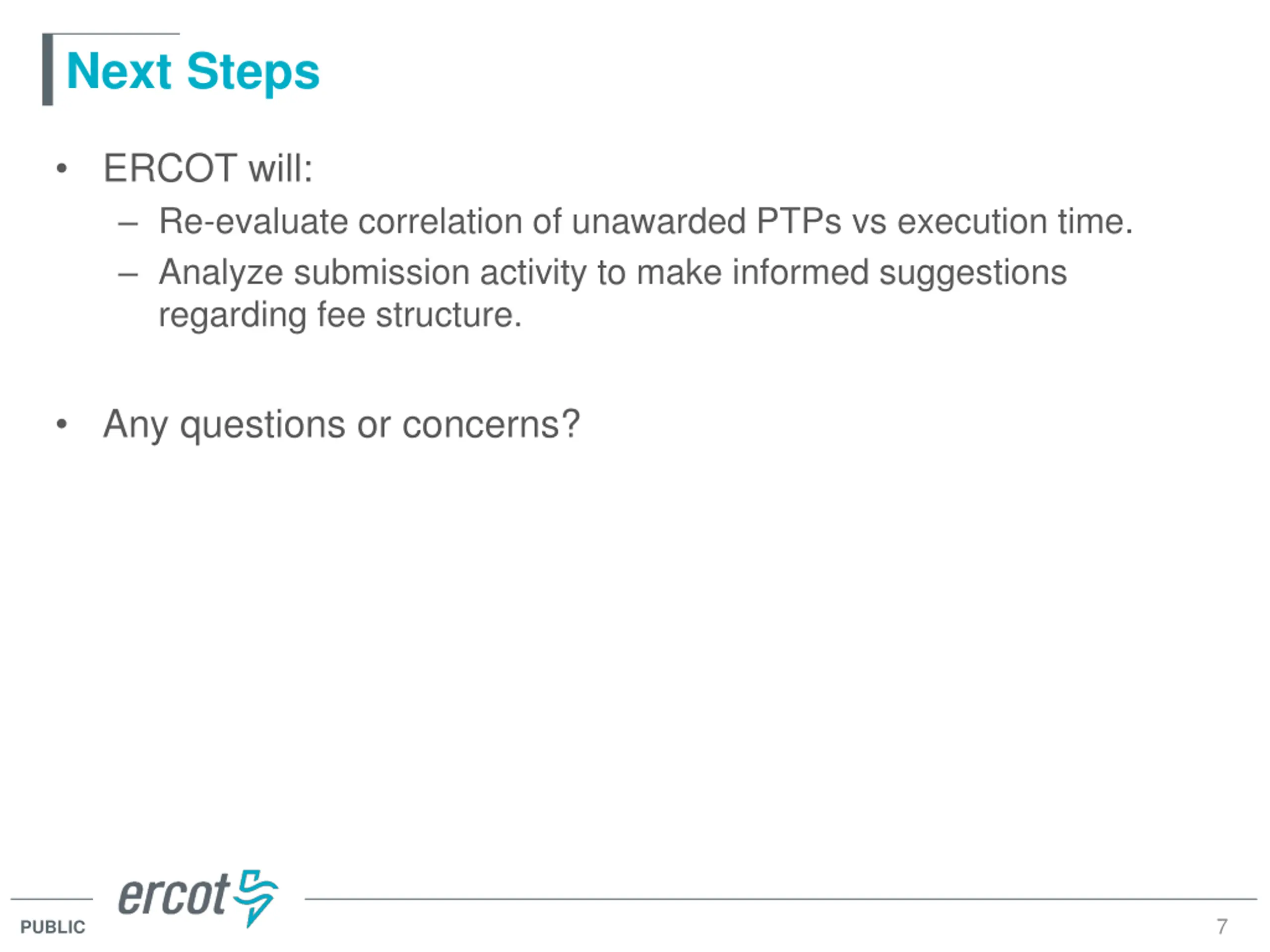

  7. Next Steps ERCOT will: Re-evaluate correlation of unawarded PTPs vs execution time. Analyze submission activity to make informed suggestions regarding fee structure. Any questions or concerns? 7 PUBLIC
