ERCOT Resource Integration Topics Update
Explore the latest insights on resource integration topics discussed in the ERCOT Resource Integration Working Group meeting on April 19, 2022. Learn about Quarterly Stability Assessment planning, dynamic model reviews, and more to stay informed about upcoming deadlines and requirements.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
Resource Integration Topics Jay Teixeira ERCOT Resource Integration Working Group April 19, 2022

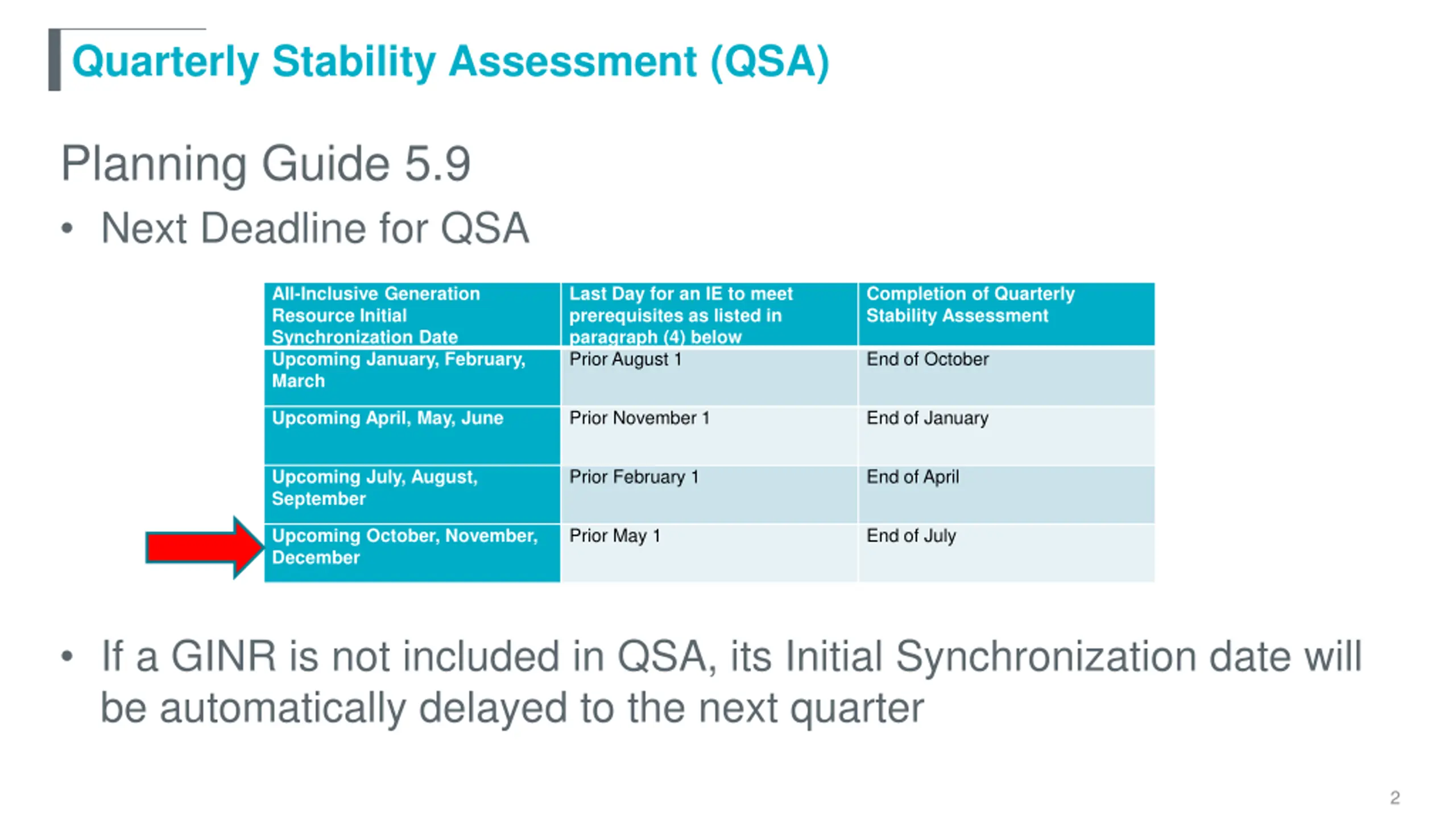

Quarterly Stability Assessment (QSA) Planning Guide 5.9 Next Deadline for QSA All-Inclusive Generation Resource Initial Synchronization Date Upcoming January, February, March Last Day for an IE to meet prerequisites as listed in paragraph (4) below Prior August 1 Completion of Quarterly Stability Assessment End of October Prior November 1 End of January Upcoming April, May, June Prior February 1 End of April Upcoming July, August, September Prior May 1 End of July Upcoming October, November, December If a GINR is not included in QSA, its Initial Synchronization date will be automatically delayed to the next quarter 2
Quarterly Stability Assessment (QSA) Planning Guide 5.9, Quarterly Stability Assessment Issue s seen in previous QSA s 10 day comment period for FIS Needs to be complete before QSA deadline TSPs need to plan for it Dynamic/PSCAD Model Review Updated dynamic model dependent on FIS Stability study Need to meet PG 6.9 15 to 30 days prior to QSA deadline PSSE Model Quality Test Required TSPs have requested dynamic model MQT report submitted with dynamic model prior to FIS Stability Study PSCAD Model Quality Test and Unit Model Validation required TSAT Model Required If PSSE model is UDM, then TSAT model should be UDM 3

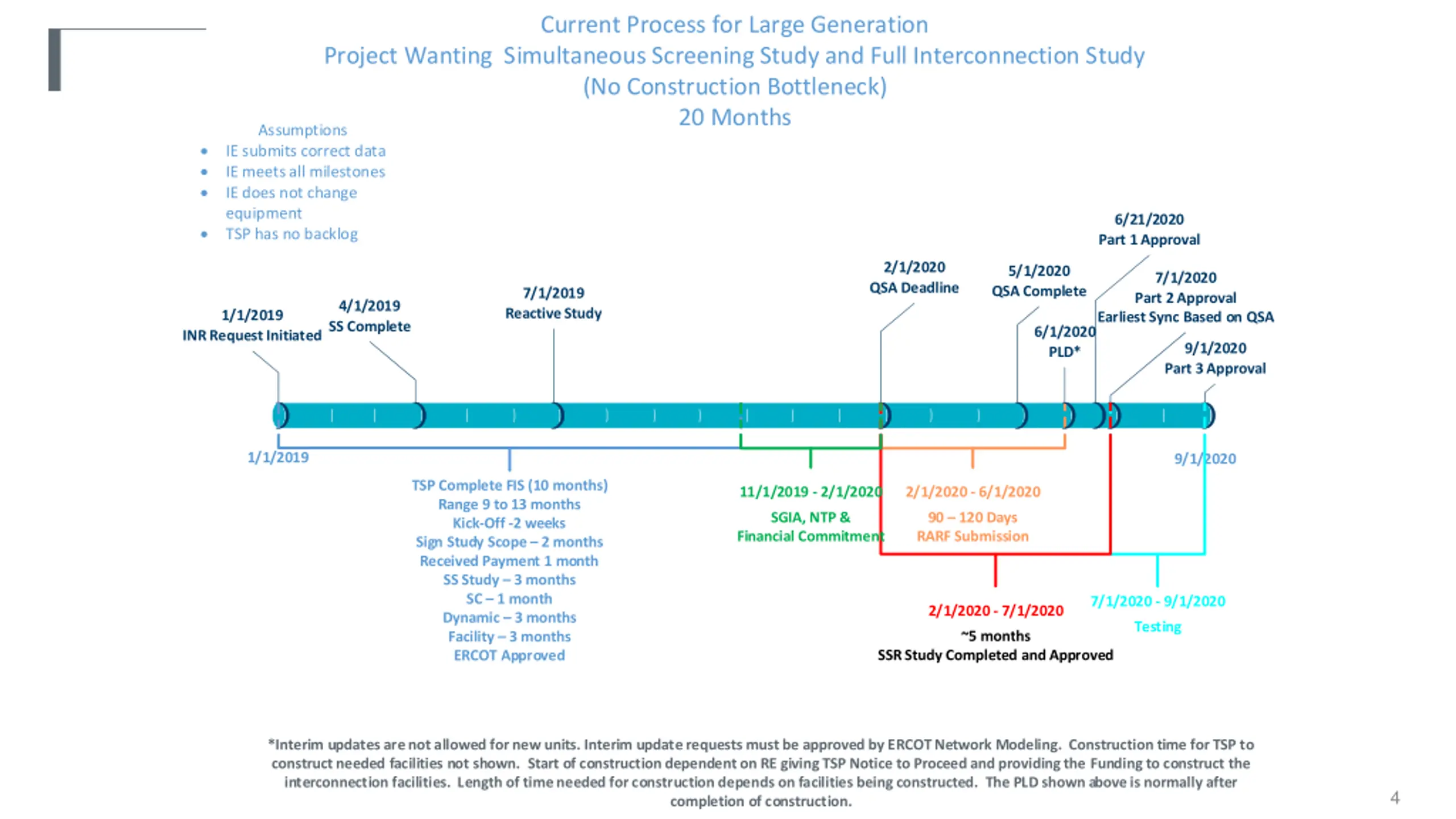

Current Process for Large Generation Project Wanting Simultaneous Screening Study and Full Interconnection Study (No Construction Bottleneck) 20 Months Assumptions IE submits correct data IE meets all milestones IE does not change equipment TSP has no backlog 6/21/2020 Part 1 Approval 2/1/2020 QSA Deadline 5/1/2020 QSA Complete 7/1/2020 Part 2 Approval Earliest Sync Based on QSA 7/1/2019 Reactive Study 4/1/2019 SS Complete 1/1/2019 6/1/2020 PLD* INR Request Initiated 9/1/2020 Part 3 Approval 1/1/2019 9/1/2020 TSP Complete FIS (10 months) Range 9 to 13 months Kick-Off -2 weeks Sign Study Scope months Received Payment 1 month SS Study months SC month Dynamic months Facility months ERCOT Approved 11/1/2019 - 2/1/2020 2/1/2020 - 6/1/2020 SGIA, NTP & Financial Commitment Days RARF Submission 7/1/2020 - 9/1/2020 2/1/2020 - 7/1/2020 Testing ~5 months SSR Study Completed and Approved *Interim updates are not allowed for new units. Interim update requests must be approved by ERCOT Network Modeling. Construction time for TSP to construct needed facilities not shown. Start of construction dependent on RE giving TSP Notice to Proceed and providing the Funding to construct the interconnection facilities. Length of time needed for construction depends on facilities being constructed. The PLD shown above is normally after completion of construction. 4

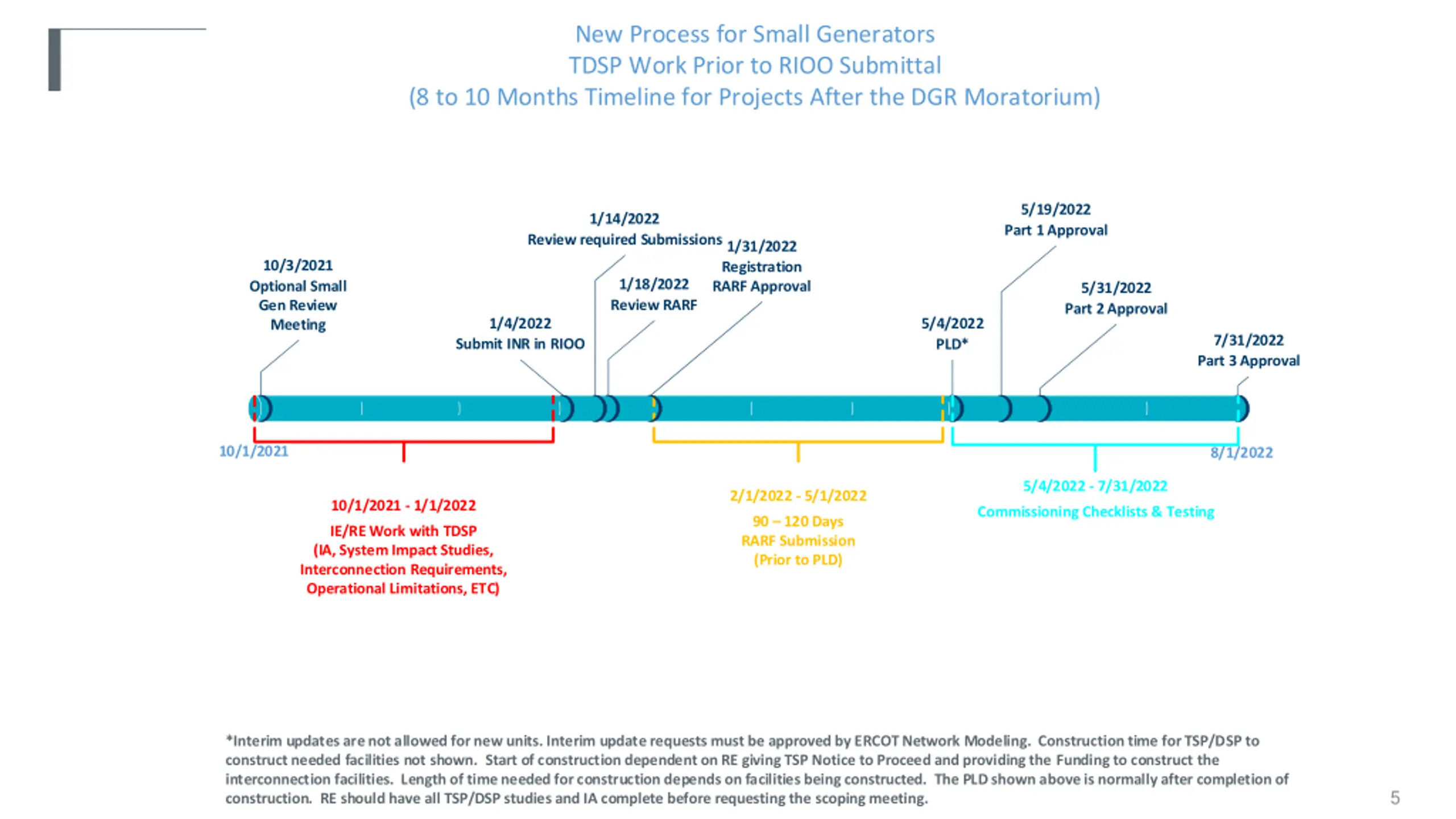

New Process for Small Generators TDSP Work Prior to RIOO Submittal (8 to 10 Months Timeline for Projects After the DGR Moratorium) 5/19/2022 Part 1 Approval 1/14/2022 Review required Submissions 1/31/2022 Registration RARF Approval 10/3/2021 Optional Small Gen Review Meeting 1/18/2022 Review RARF 5/31/2022 Part 2 Approval 1/4/2022 5/4/2022 PLD* 7/31/2022 Part 3 Approval Submit INR in RIOO 10/1/2021 8/1/2022 5/4/2022 - 7/31/2022 2/1/2022 - 5/1/2022 10/1/2021 - 1/1/2022 Commissioning Checklists & Testing Days RARF Submission (Prior to PLD) IE/RE Work with TDSP (IA, System Impact Studies, Interconnection Requirements, Operational Limitations, ETC) *Interim updates are not allowed for new units. Interim update requests must be approved by ERCOT Network Modeling. Construction time for TSP/DSP to construct needed facilities not shown. Start of construction dependent on RE giving TSP Notice to Proceed and providing the Funding to construct the interconnection facilities. Length of time needed for construction depends on facilities being constructed. The PLD shown above is normally after completion of construction. RE should have all TSP/DSP studies and IA complete before requesting the scoping meeting. 5

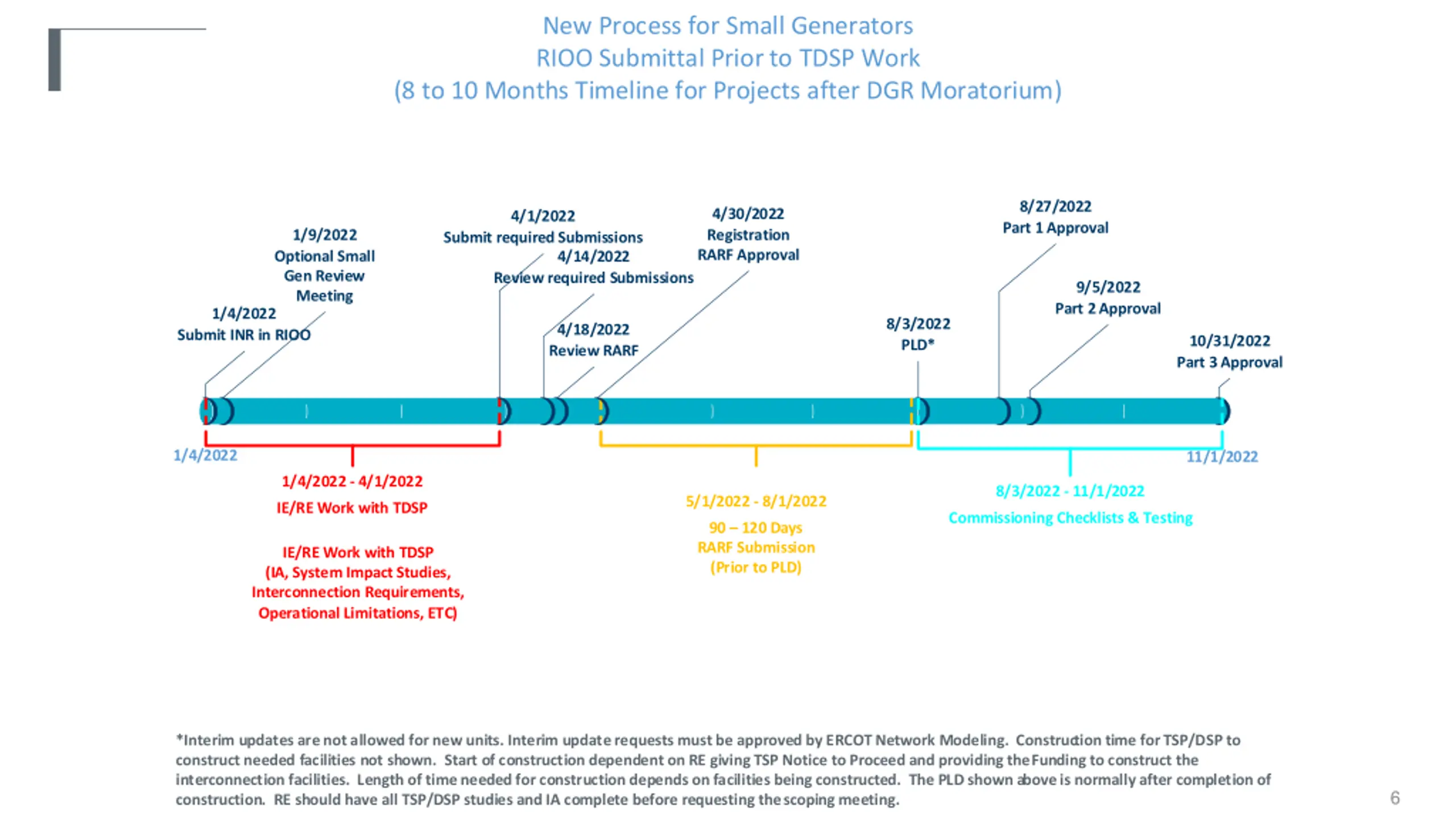

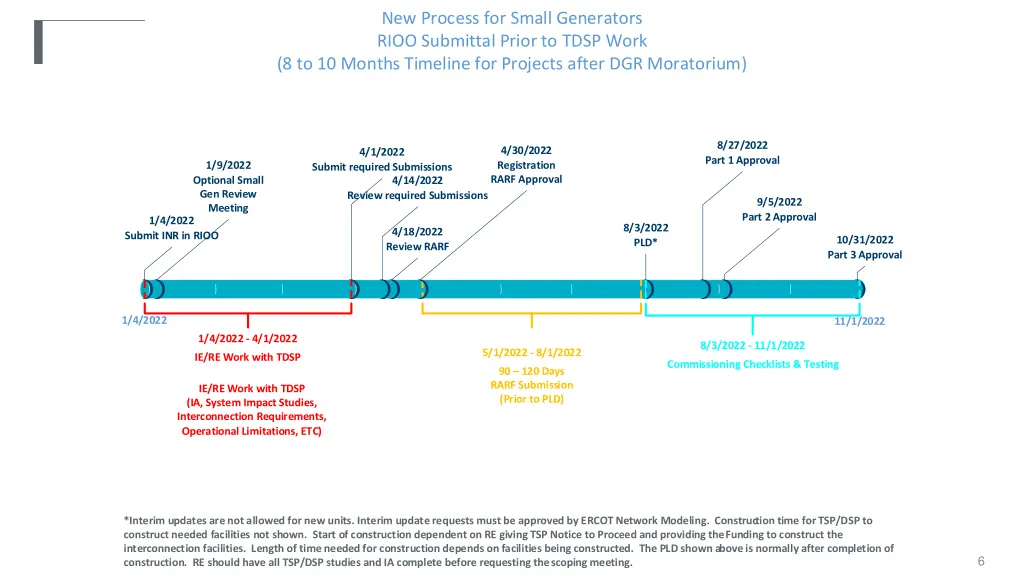

New Process for Small Generators RIOO Submittal Prior to TDSP Work (8 to 10 Months Timeline for Projects after DGR Moratorium) 8/27/2022 Part 1 Approval 4/30/2022 Registration RARF Approval 4/1/2022 1/9/2022 Optional Small Gen Review Meeting Submit required Submissions 4/14/2022 Review required Submissions 9/5/2022 Part 2 Approval 1/4/2022 8/3/2022 PLD* 4/18/2022 Review RARF Submit INR in RIOO 10/31/2022 Part 3 Approval 1/4/2022 11/1/2022 1/4/2022 - 4/1/2022 8/3/2022 - 11/1/2022 5/1/2022 - 8/1/2022 IE/RE Work with TDSP Commissioning Checklists & Testing Days RARF Submission (Prior to PLD) IE/RE Work with TDSP (IA, System Impact Studies, Interconnection Requirements, Operational Limitations, ETC) *Interim updates are not allowed for new units. Interim update requests must be approved by ERCOT Network Modeling. Construction time for TSP/DSP to construct needed facilities not shown. Start of construction dependent on RE giving TSP Notice to Proceed and providing the Funding to construct the interconnection facilities. Length of time needed for construction depends on facilities being constructed. The PLD shown above is normally after completion of construction. RE should have all TSP/DSP studies and IA complete before requesting the scoping meeting. 6
Discussion Items What are Generator Terminals As modeled in ERCOT Operations Model For non-conventional, usually 34.5 kV Dissimilar Real Power/Turbine Rating Need to study summer and winter with higher turbine ratings in winter Use highest sustainable rating regardless of temperature on RARF Unit Info HRL at highest seasonal rating value SGIA refer to differing seasonal ratings if applicable Higher rated seasonal ratings studied in addition to summer peak if necessary 7
Active RRs None 8

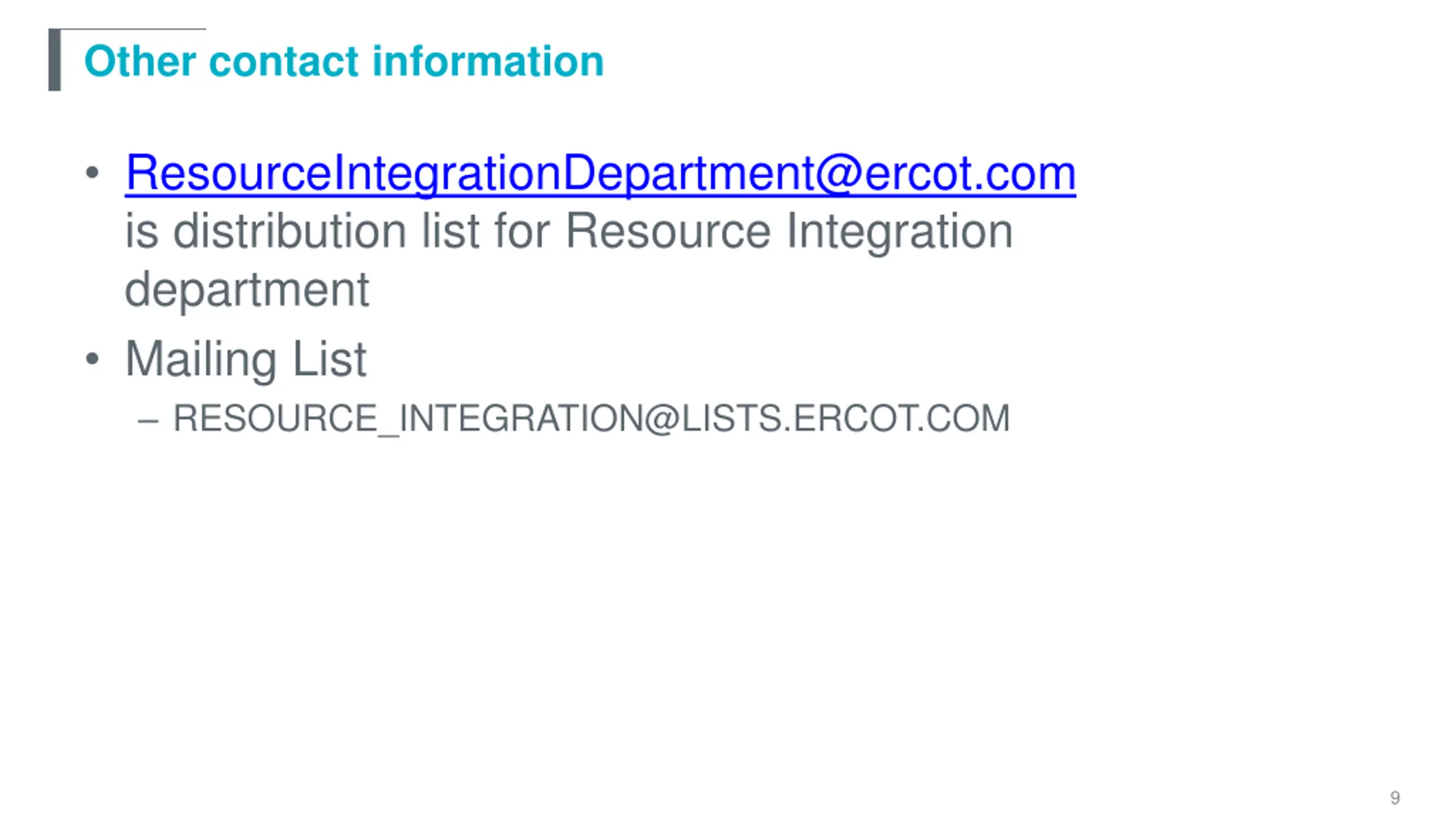

Other contact information ResourceIntegrationDepartment@ercot.com is distribution list for Resource Integration department Mailing List RESOURCE_INTEGRATION@LISTS.ERCOT.COM 9
Questions? Thank you!
