ERCOT Resource Integration Working Group Updates for Q2 2025
Stay updated with ERCOT's Quarterly Stability Assessment (QSA) planning, including important deadlines, model requirements, and meter design proposals. Ensure compliance and seamless integration of resources for effective energy management.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
Resource Integration Topics Jenifer Fernandes ERCOT Resource Integration Working Group April 16th, 2025

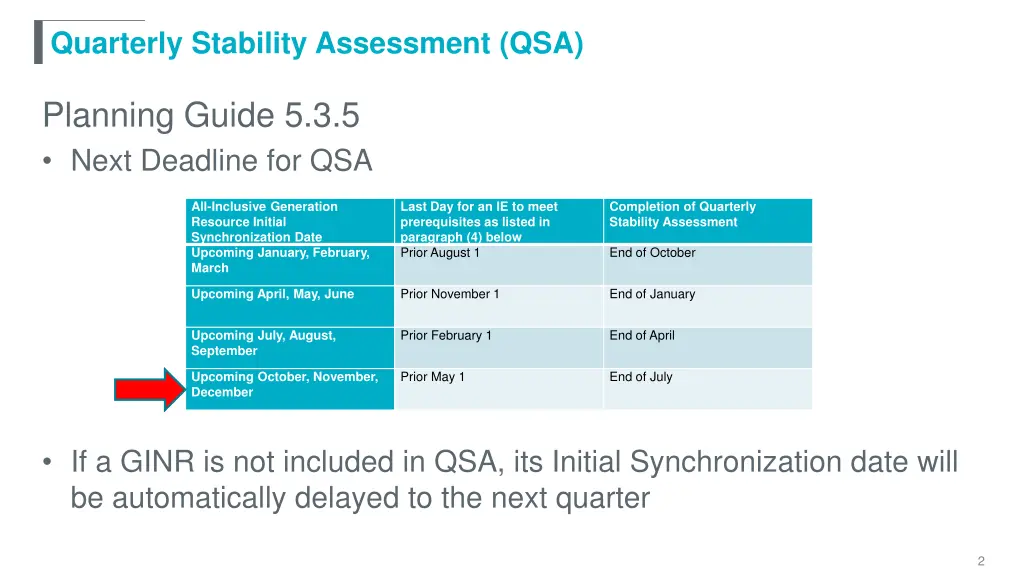

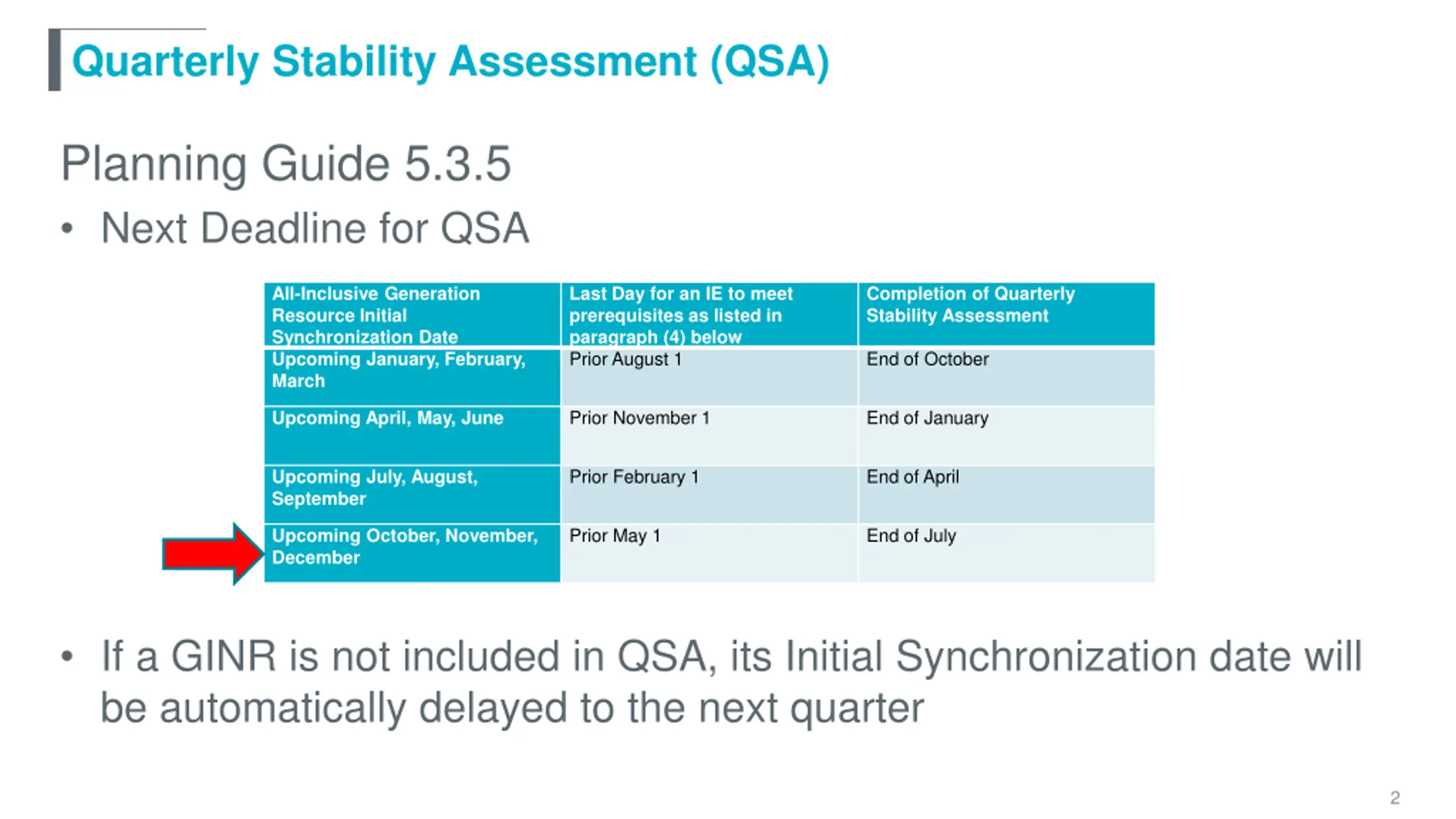

Quarterly Stability Assessment (QSA) Planning Guide 5.3.5 Next Deadline for QSA All-Inclusive Generation Resource Initial Synchronization Date Upcoming January, February, March Last Day for an IE to meet prerequisites as listed in paragraph (4) below Prior August 1 Completion of Quarterly Stability Assessment End of October Prior November 1 End of January Upcoming April, May, June Prior February 1 End of April Upcoming July, August, September Prior May 1 End of July Upcoming October, November, December If a GINR is not included in QSA, its Initial Synchronization date will be automatically delayed to the next quarter 2

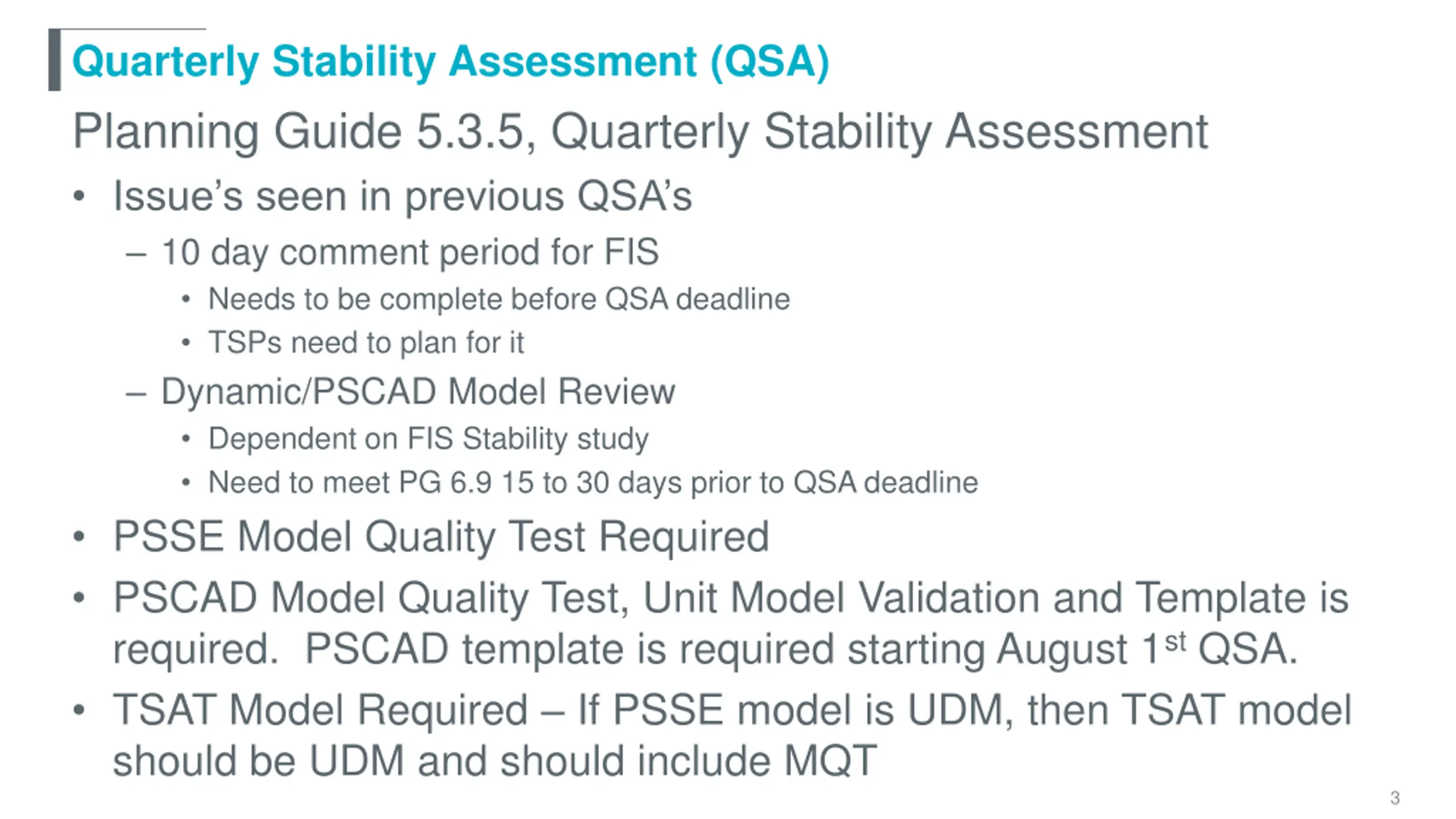

Quarterly Stability Assessment (QSA) Planning Guide 5.3.5, Quarterly Stability Assessment Issue s seen in previous QSA s 10 day comment period for FIS Needs to be complete before QSA deadline TSPs need to plan for it Dynamic/PSCAD Model Review Dependent on FIS Stability study Need to meet PG 6.9 15 to 30 days prior to QSA deadline PSSE Model Quality Test Required PSCAD Model Quality Test, Unit Model Validation and Template is required. PSCAD template is required starting August 1st QSA. TSAT Model Required If PSSE model is UDM, then TSAT model should be UDM and should include MQT 3

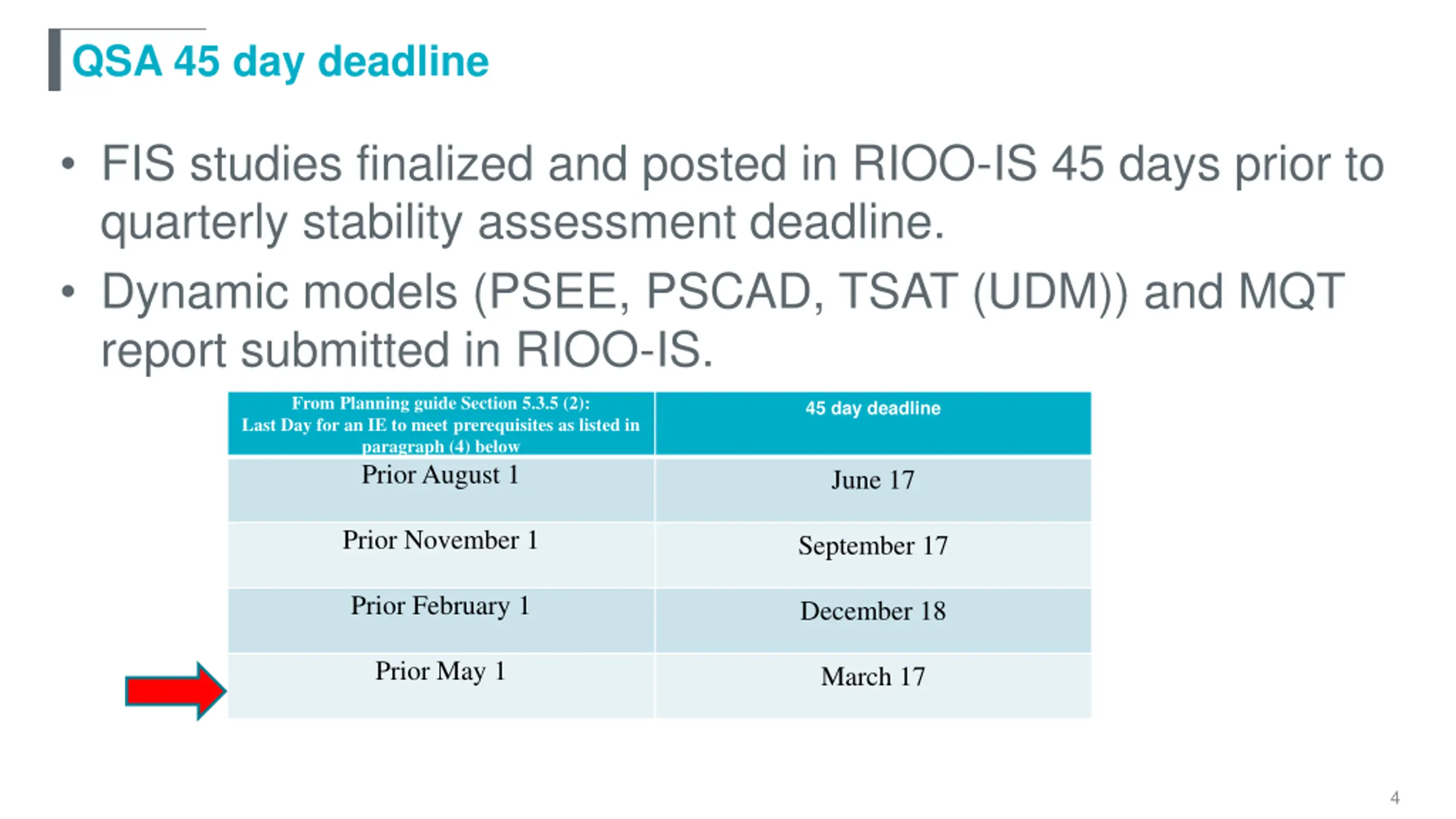

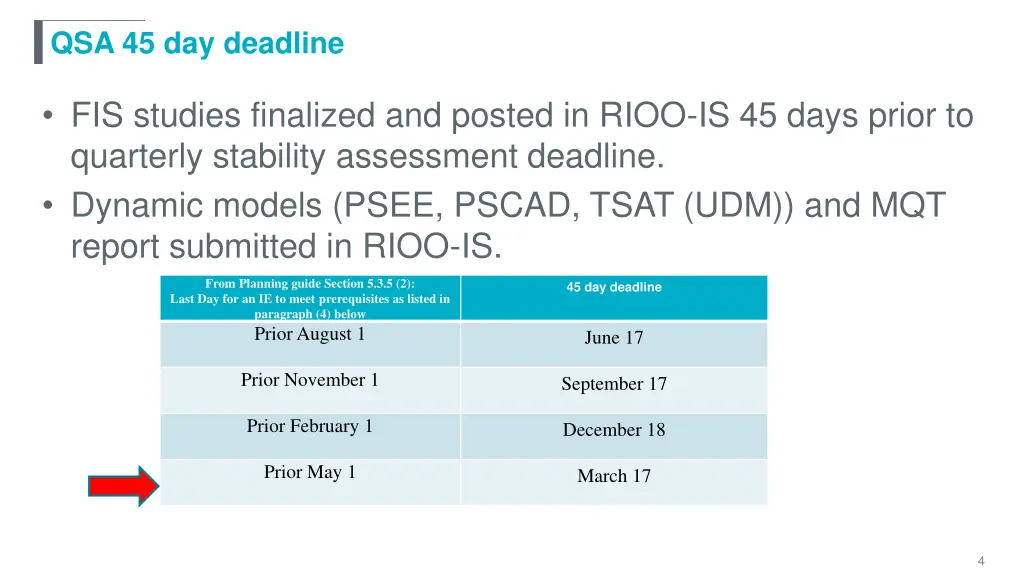

QSA 45 day deadline FIS studies finalized and posted in RIOO-IS 45 days prior to quarterly stability assessment deadline. Dynamic models (PSEE, PSCAD, TSAT (UDM)) and MQT report submitted in RIOO-IS. From Planning guide Section 5.3.5 (2): Last Day for an IE to meet prerequisites as listed in paragraph (4) below Prior August 1 45 day deadline June 17 Prior November 1 September 17 Prior February 1 December 18 Prior May 1 March 17 4

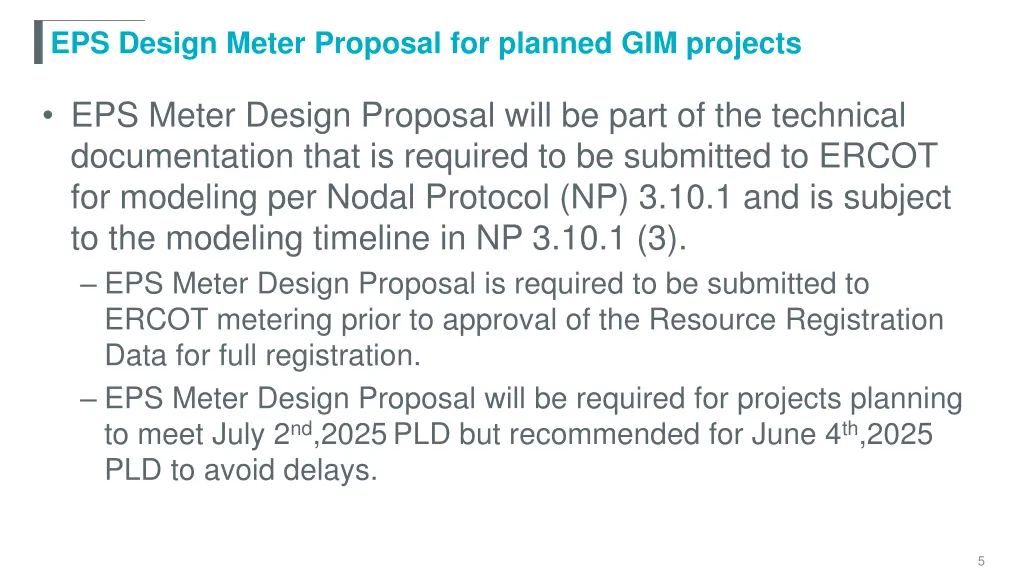

EPS Design Meter Proposal for planned GIM projects EPS Meter Design Proposal will be part of the technical documentation that is required to be submitted to ERCOT for modeling per Nodal Protocol (NP) 3.10.1 and is subject to the modeling timeline in NP 3.10.1 (3). EPS Meter Design Proposal is required to be submitted to ERCOT metering prior to approval of the Resource Registration Data for full registration. EPS Meter Design Proposal will be required for projects planning to meet July 2nd,2025PLD but recommended for June 4th,2025 PLD to avoid delays. 5

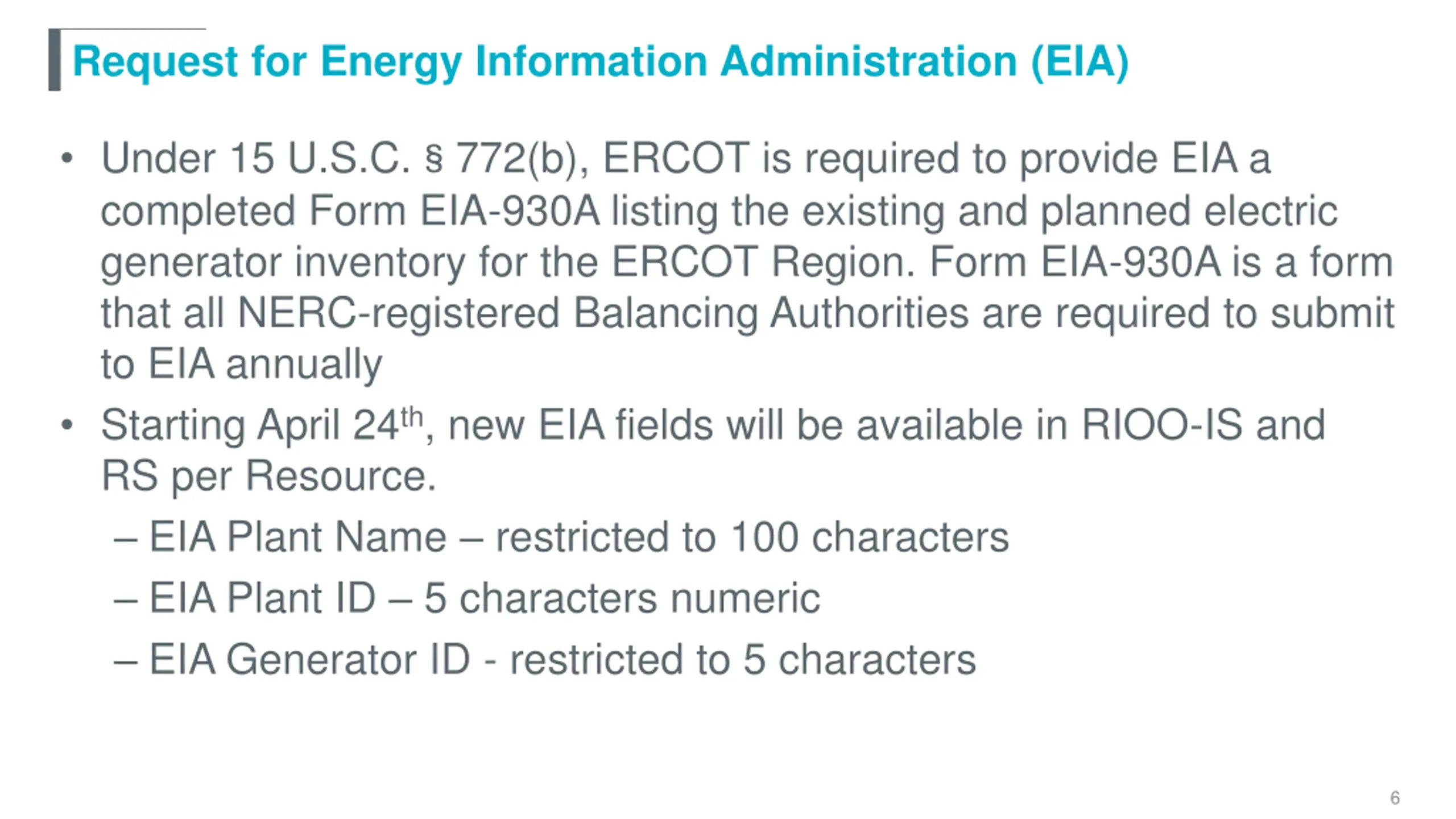

Request for Energy Information Administration (EIA) Under 15 U.S.C. 772(b), ERCOT is required to provide EIA a completed Form EIA-930A listing the existing and planned electric generator inventory for the ERCOT Region. Form EIA-930A is a form that all NERC-registered Balancing Authorities are required to submit to EIA annually Starting April 24th, new EIA fields will be available in RIOO-IS and RS per Resource. EIA Plant Name restricted to 100 characters EIA Plant ID 5 characters numeric EIA Generator ID - restricted to 5 characters 6

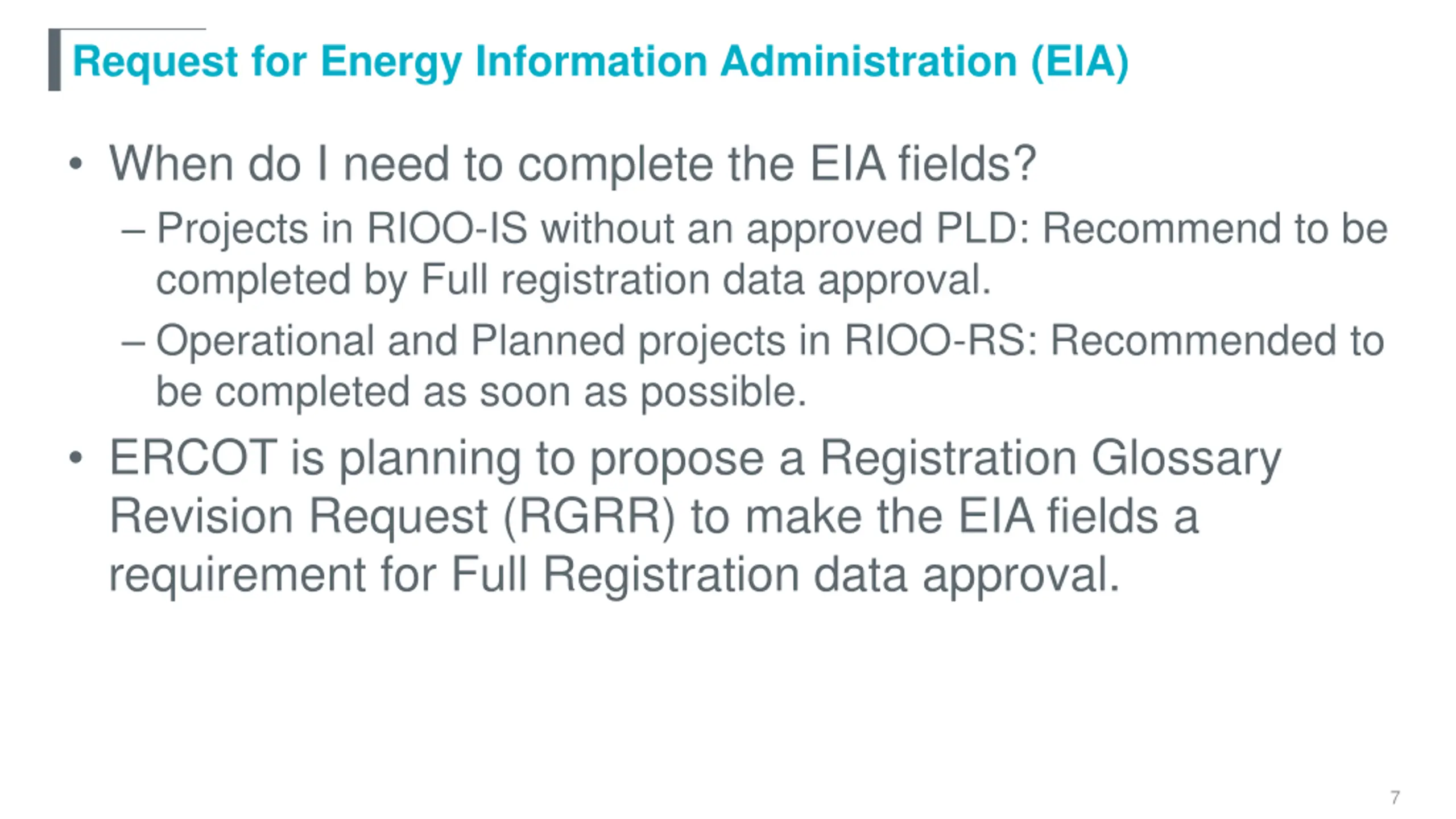

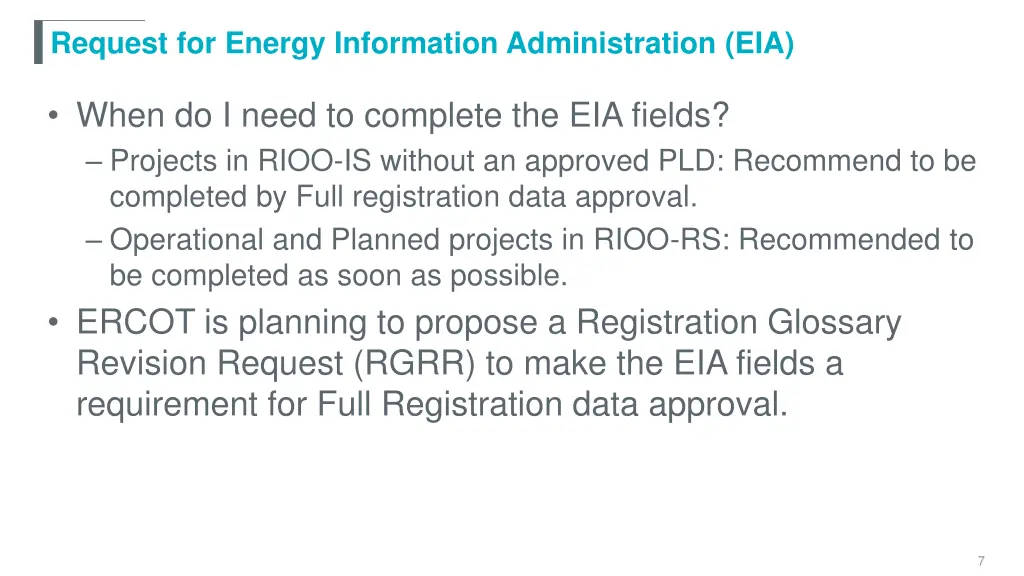

Request for Energy Information Administration (EIA) When do I need to complete the EIA fields? Projects in RIOO-IS without an approved PLD: Recommend to be completed by Full registration data approval. Operational and Planned projects in RIOO-RS: Recommended to be completed as soon as possible. ERCOT is planning to propose a Registration Glossary Revision Request (RGRR) to make the EIA fields a requirement for Full Registration data approval. 7

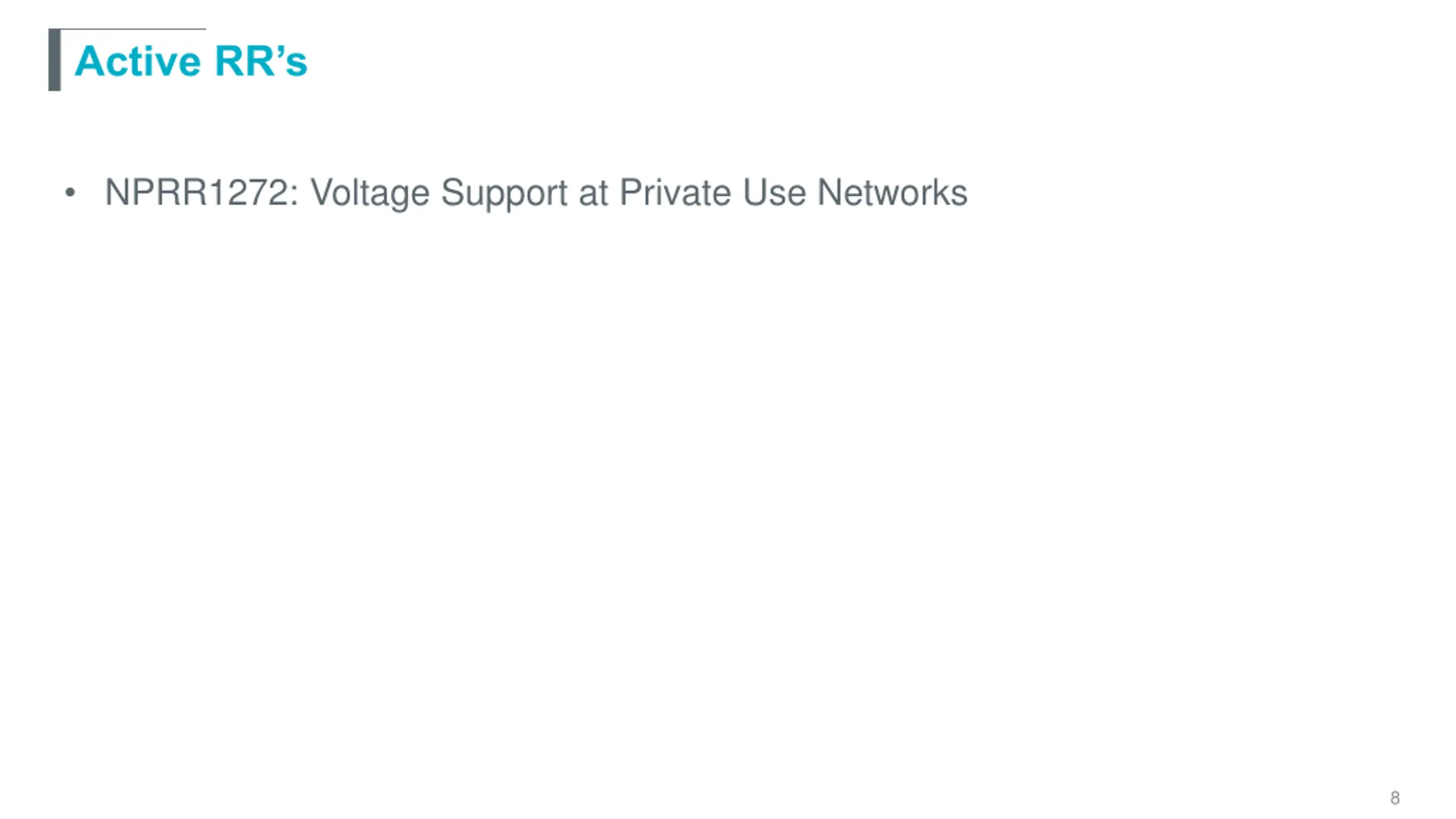

Active RRs NPRR1272: Voltage Support at Private Use Networks 8

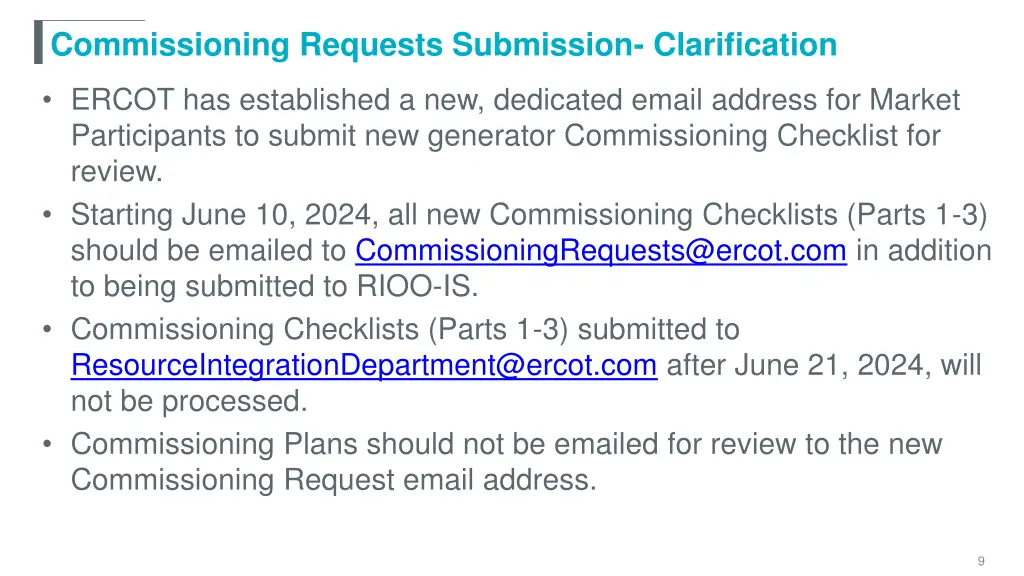

Commissioning Requests Submission- Clarification ERCOT has established a new, dedicated email address for Market Participants to submit new generator Commissioning Checklist for review. Starting June 10, 2024, all new Commissioning Checklists (Parts 1-3) should be emailed to CommissioningRequests@ercot.com in addition to being submitted to RIOO-IS. Commissioning Checklists (Parts 1-3) submitted to ResourceIntegrationDepartment@ercot.com after June 21, 2024, will not be processed. Commissioning Plans should not be emailed for review to the new Commissioning Request email address. 9

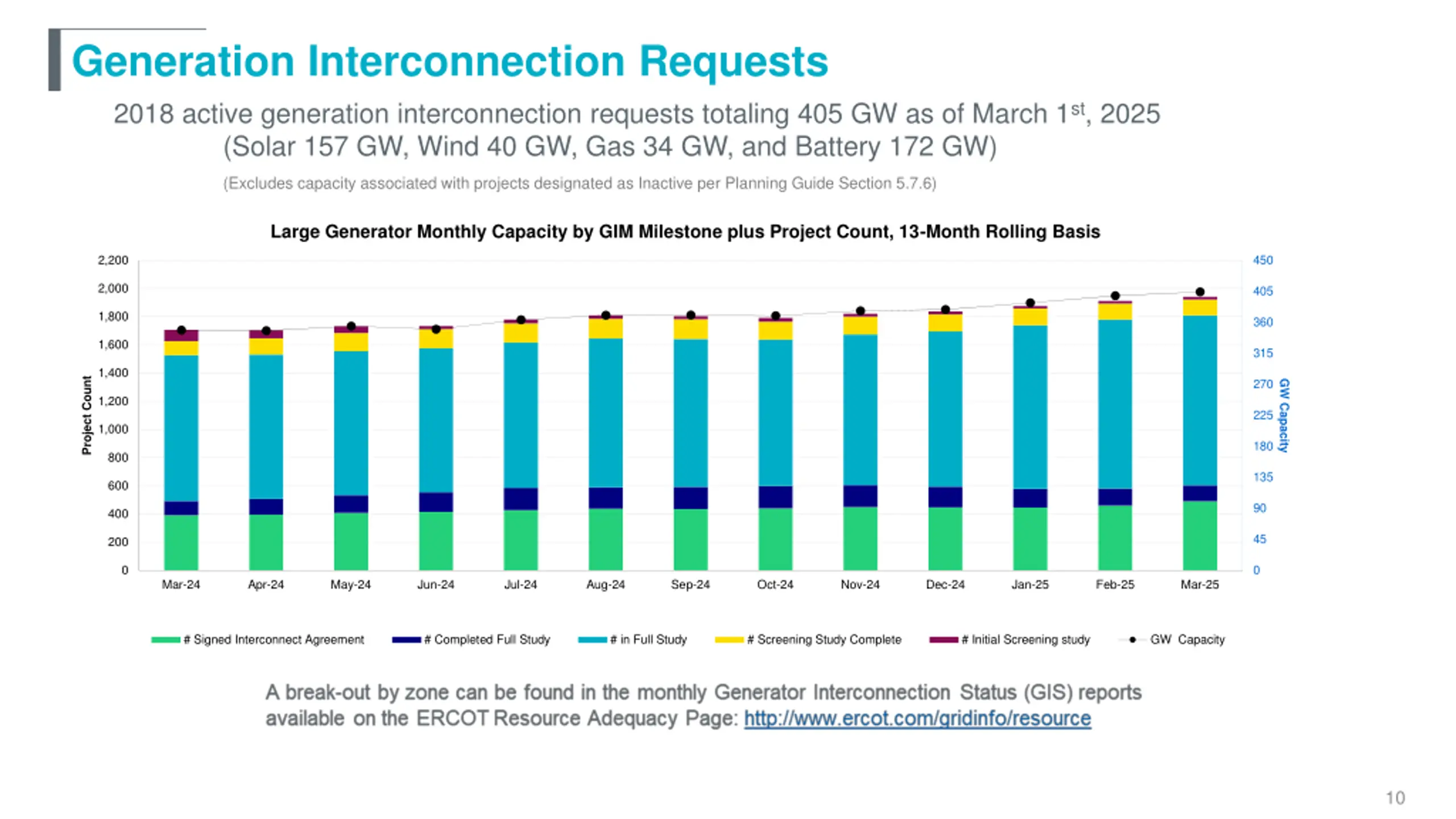

Generation Interconnection Requests 2018 active generation interconnection requests totaling 405 GW as of March 1st, 2025 (Solar 157 GW, Wind 40 GW, Gas 34 GW, and Battery 172 GW) (Excludes capacity associated with projects designated as Inactive per Planning Guide Section 5.7.6) Large Generator Monthly Capacity by GIM Milestone plus Project Count, 13-Month Rolling Basis 2,200 450 2,000 405 1,800 360 1,600 315 1,400 Project Count 270 GW Capacity 1,200 225 1,000 180 800 135 600 90 400 45 200 0 0 Mar-24 Apr-24 May-24 Jun-24 Jul-24 Aug-24 Sep-24 Oct-24 Nov-24 Dec-24 Jan-25 Feb-25 Mar-25 # Signed Interconnect Agreement # Completed Full Study # in Full Study # Screening Study Complete # Initial Screening study GW Capacity 10

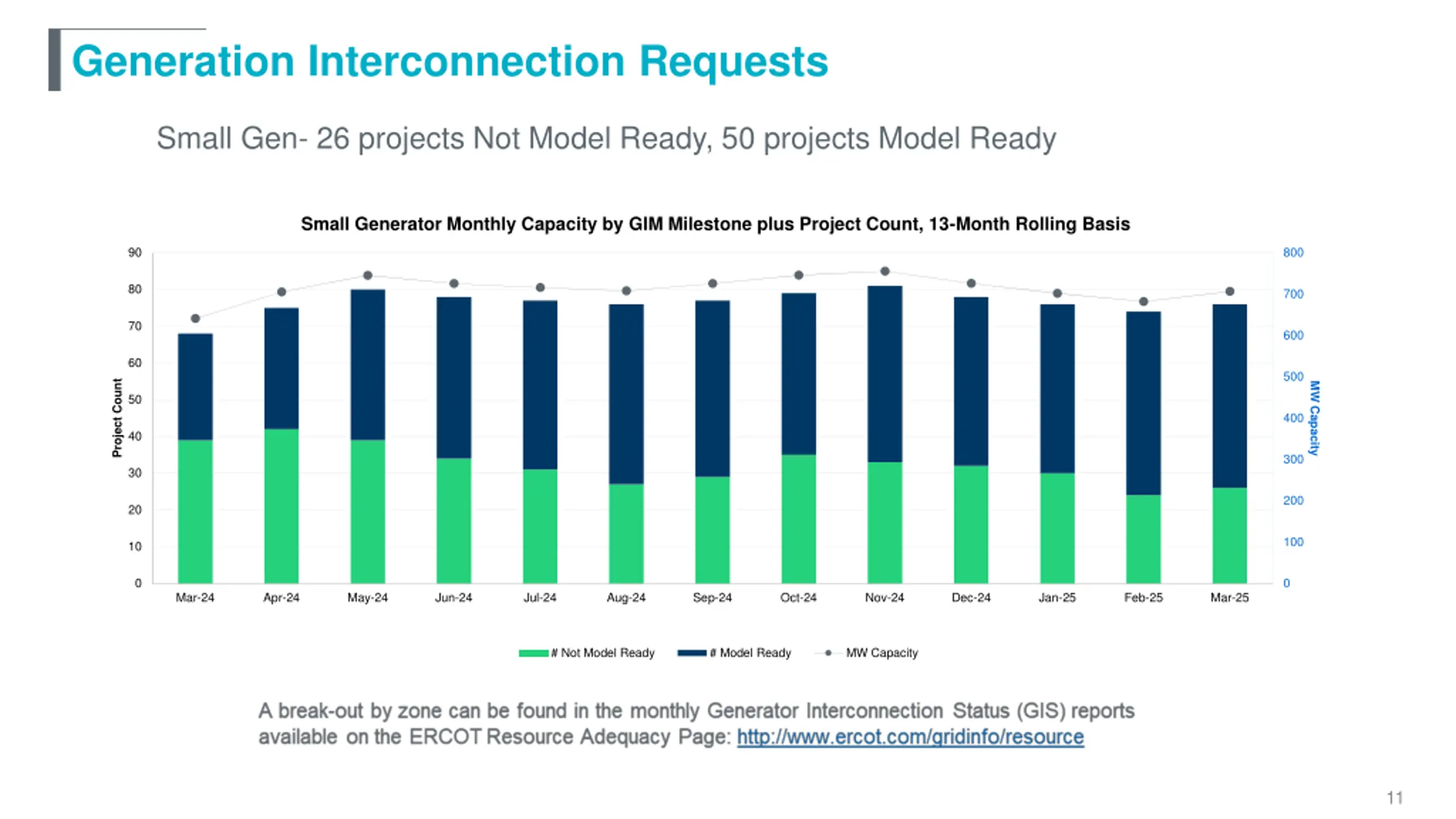

Generation Interconnection Requests Small Gen- 26 projects Not Model Ready, 50 projects Model Ready Small Generator Monthly Capacity by GIM Milestone plus Project Count, 13-Month Rolling Basis 90 800 80 700 70 600 60 500 Project Count MW Capacity 50 400 40 300 30 200 20 100 10 0 0 Mar-24 Apr-24 May-24 Jun-24 Jul-24 Aug-24 Sep-24 Oct-24 Nov-24 Dec-24 Jan-25 Feb-25 Mar-25 # Not Model Ready # Model Ready MW Capacity 11

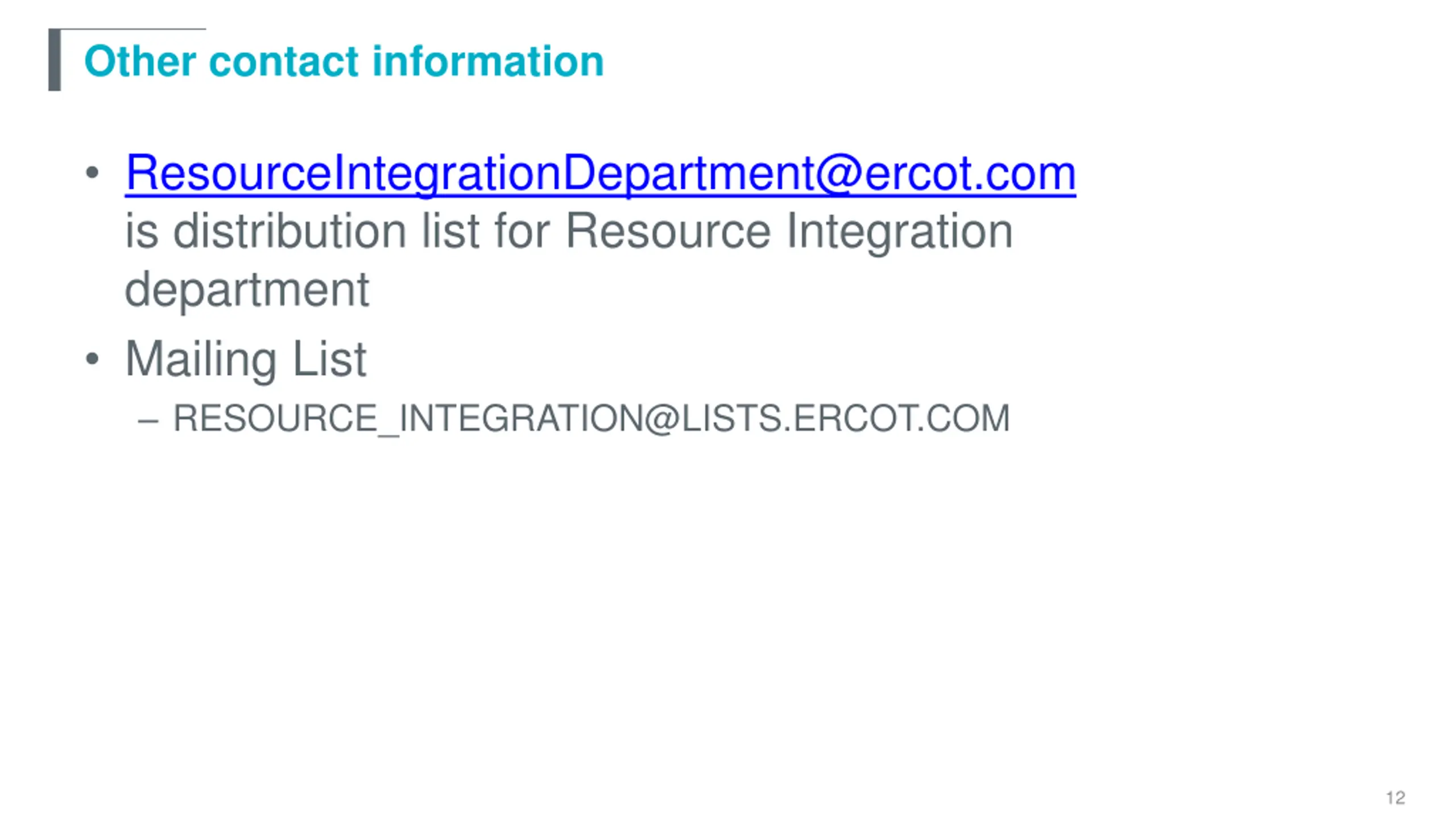

Other contact information ResourceIntegrationDepartment@ercot.com is distribution list for Resource Integration department Mailing List RESOURCE_INTEGRATION@LISTS.ERCOT.COM 12
Questions? Thank you!

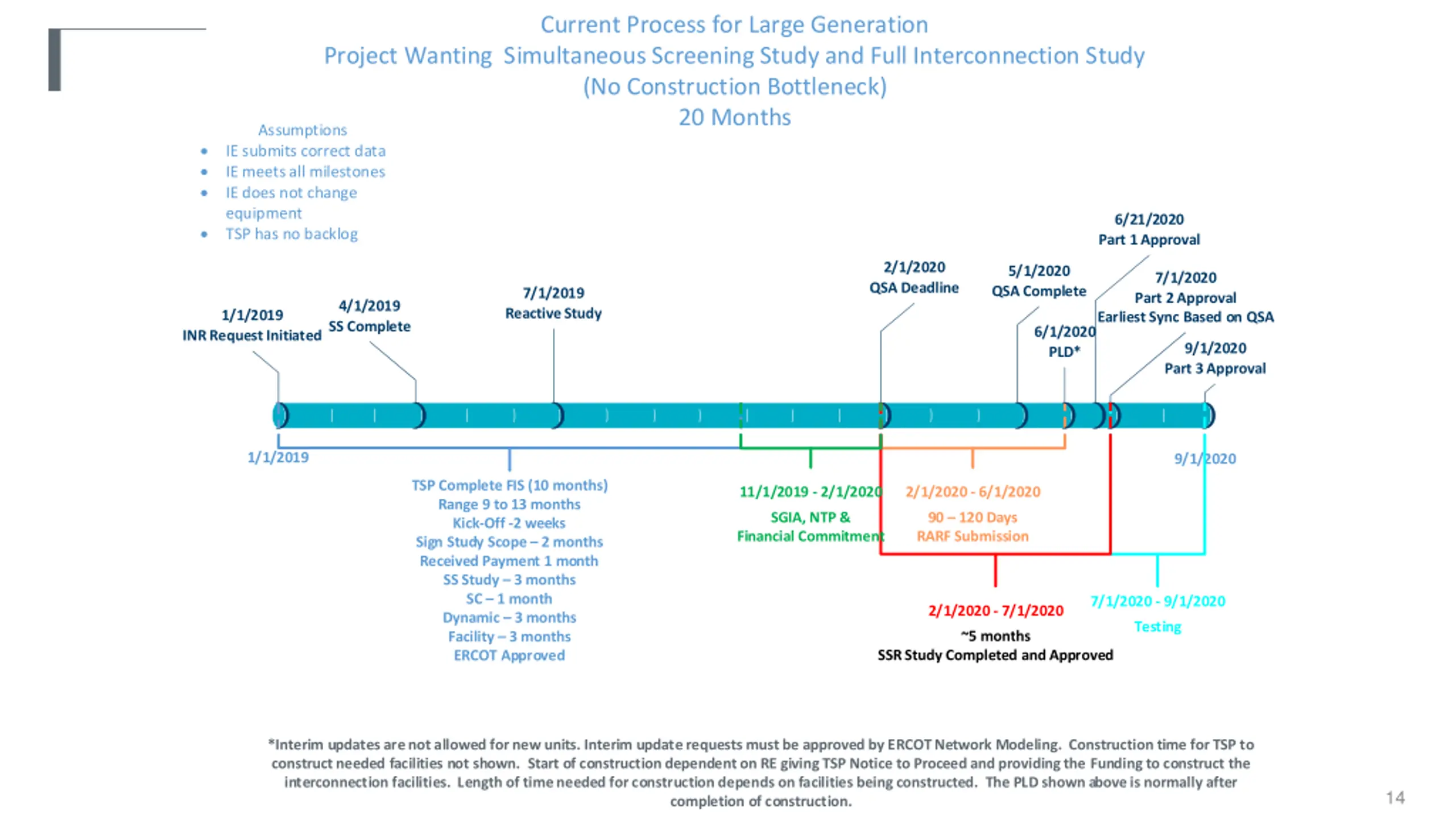

Current Process for Large Generation Project Wanting Simultaneous Screening Study and Full Interconnection Study (No Construction Bottleneck) 20 Months Assumptions IE submits correct data IE meets all milestones IE does not change equipment TSP has no backlog 6/21/2020 Part 1 Approval 2/1/2020 QSA Deadline 5/1/2020 QSA Complete 7/1/2020 Part 2 Approval Earliest Sync Based on QSA 7/1/2019 Reactive Study 4/1/2019 SS Complete 1/1/2019 6/1/2020 PLD* INR Request Initiated 9/1/2020 Part 3 Approval 1/1/2019 9/1/2020 TSP Complete FIS (10 months) Range 9 to 13 months Kick-Off -2 weeks Sign Study Scope months Received Payment 1 month SS Study months SC month Dynamic months Facility months ERCOT Approved 11/1/2019 - 2/1/2020 2/1/2020 - 6/1/2020 SGIA, NTP & Financial Commitment Days RARF Submission 7/1/2020 - 9/1/2020 2/1/2020 - 7/1/2020 Testing ~5 months SSR Study Completed and Approved *Interim updates are not allowed for new units. Interim update requests must be approved by ERCOT Network Modeling. Construction time for TSP to construct needed facilities not shown. Start of construction dependent on RE giving TSP Notice to Proceed and providing the Funding to construct the interconnection facilities. Length of time needed for construction depends on facilities being constructed. The PLD shown above is normally after completion of construction. 14

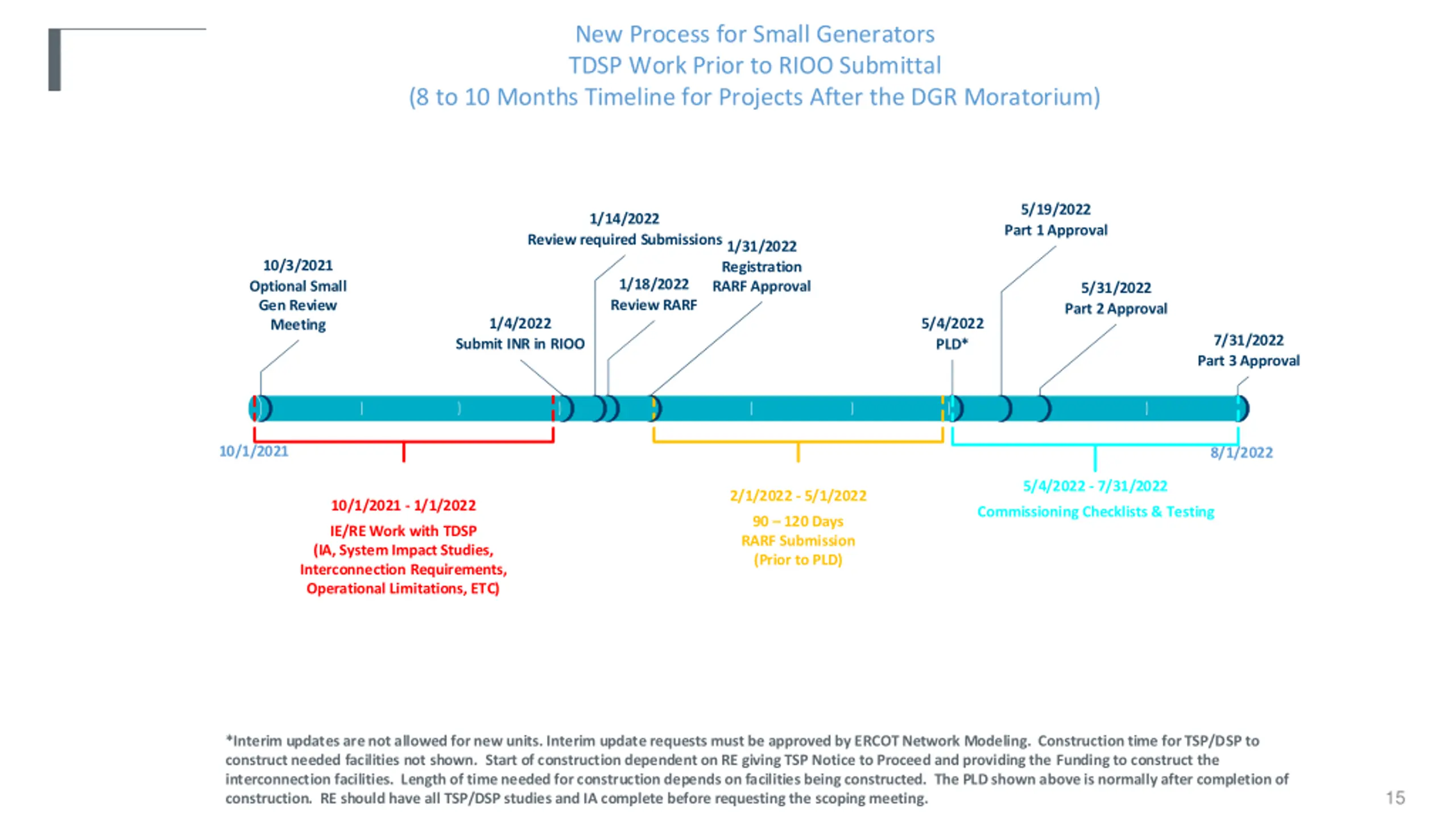

New Process for Small Generators TDSP Work Prior to RIOO Submittal (8 to 10 Months Timeline for Projects After the DGR Moratorium) 5/19/2022 Part 1 Approval 1/14/2022 Review required Submissions 1/31/2022 Registration RARF Approval 10/3/2021 Optional Small Gen Review Meeting 1/18/2022 Review RARF 5/31/2022 Part 2 Approval 1/4/2022 5/4/2022 PLD* 7/31/2022 Part 3 Approval Submit INR in RIOO 10/1/2021 8/1/2022 5/4/2022 - 7/31/2022 2/1/2022 - 5/1/2022 10/1/2021 - 1/1/2022 Commissioning Checklists & Testing Days RARF Submission (Prior to PLD) IE/RE Work with TDSP (IA, System Impact Studies, Interconnection Requirements, Operational Limitations, ETC) *Interim updates are not allowed for new units. Interim update requests must be approved by ERCOT Network Modeling. Construction time for TSP/DSP to construct needed facilities not shown. Start of construction dependent on RE giving TSP Notice to Proceed and providing the Funding to construct the interconnection facilities. Length of time needed for construction depends on facilities being constructed. The PLD shown above is normally after completion of construction. RE should have all TSP/DSP studies and IA complete before requesting the scoping meeting. 15

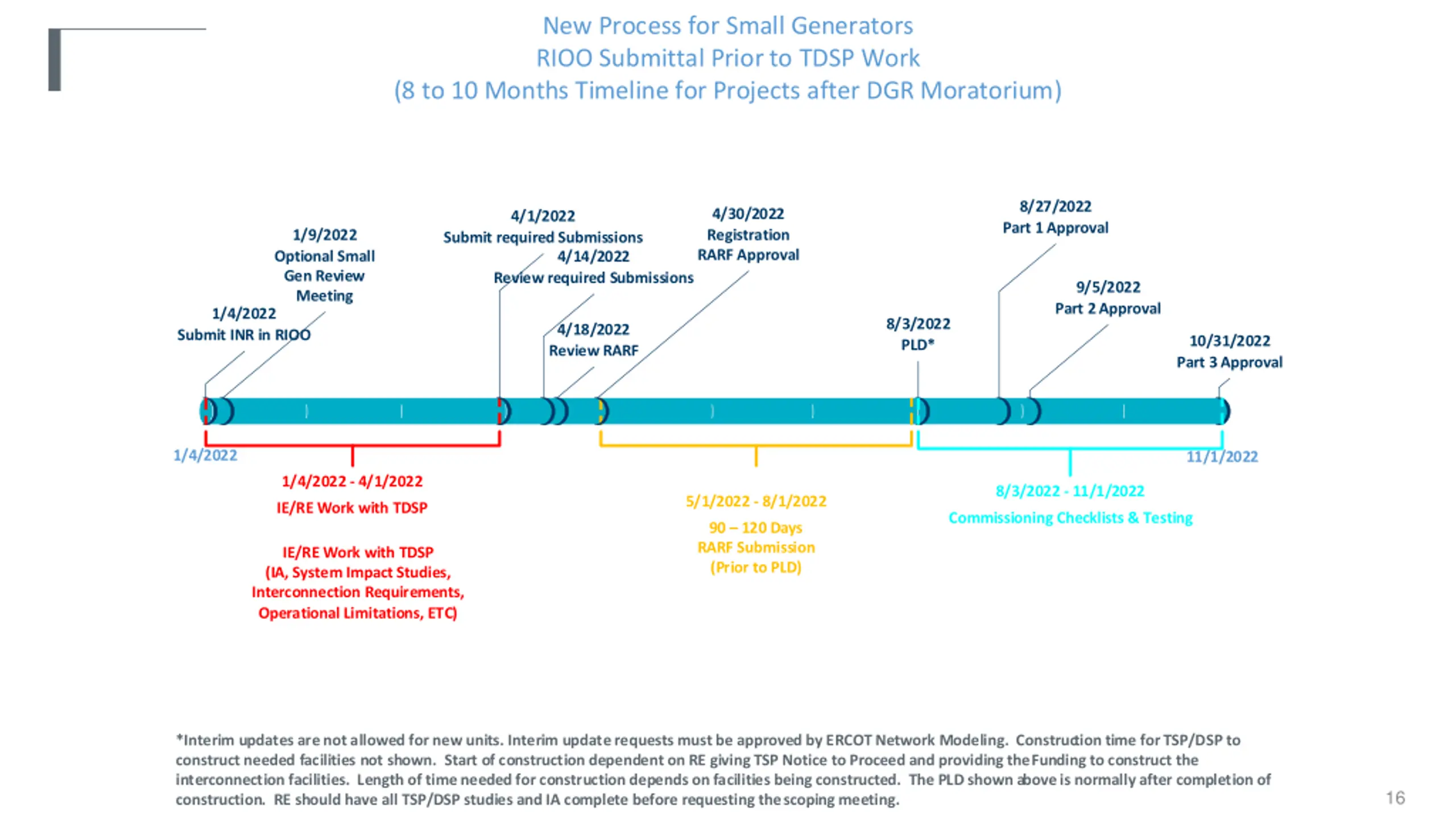

New Process for Small Generators RIOO Submittal Prior to TDSP Work (8 to 10 Months Timeline for Projects after DGR Moratorium) 8/27/2022 Part 1 Approval 4/30/2022 Registration RARF Approval 4/1/2022 1/9/2022 Optional Small Gen Review Meeting Submit required Submissions 4/14/2022 Review required Submissions 9/5/2022 Part 2 Approval 1/4/2022 8/3/2022 PLD* 4/18/2022 Review RARF Submit INR in RIOO 10/31/2022 Part 3 Approval 1/4/2022 11/1/2022 1/4/2022 - 4/1/2022 8/3/2022 - 11/1/2022 5/1/2022 - 8/1/2022 IE/RE Work with TDSP Commissioning Checklists & Testing Days RARF Submission (Prior to PLD) IE/RE Work with TDSP (IA, System Impact Studies, Interconnection Requirements, Operational Limitations, ETC) *Interim updates are not allowed for new units. Interim update requests must be approved by ERCOT Network Modeling. Construction time for TSP/DSP to construct needed facilities not shown. Start of construction dependent on RE giving TSP Notice to Proceed and providing the Funding to construct the interconnection facilities. Length of time needed for construction depends on facilities being constructed. The PLD shown above is normally after completion of construction. RE should have all TSP/DSP studies and IA complete before requesting the scoping meeting. 16
