ERCOT Updates May 2022: Important Information on DGR/DESR Resource Node Management

may 2022 ndswg ercot updates n.w
1 / 12
Embed
Share

Stay informed with the latest updates from ERCOT regarding DGR/DESR resource node management post-conversion, including details on station impedance, relocation flexibility, and protocol compliance. Learn about the criteria for moving resource nodes and how it impacts electrically similar nodes in the network.

  • ERCOT Updates
  • Resource Node Management
  • DGR
  • DESR
  • Protocol Compliance

Uploaded on | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. May 2022 NDSWG - ERCOT Updates April 22, 2025

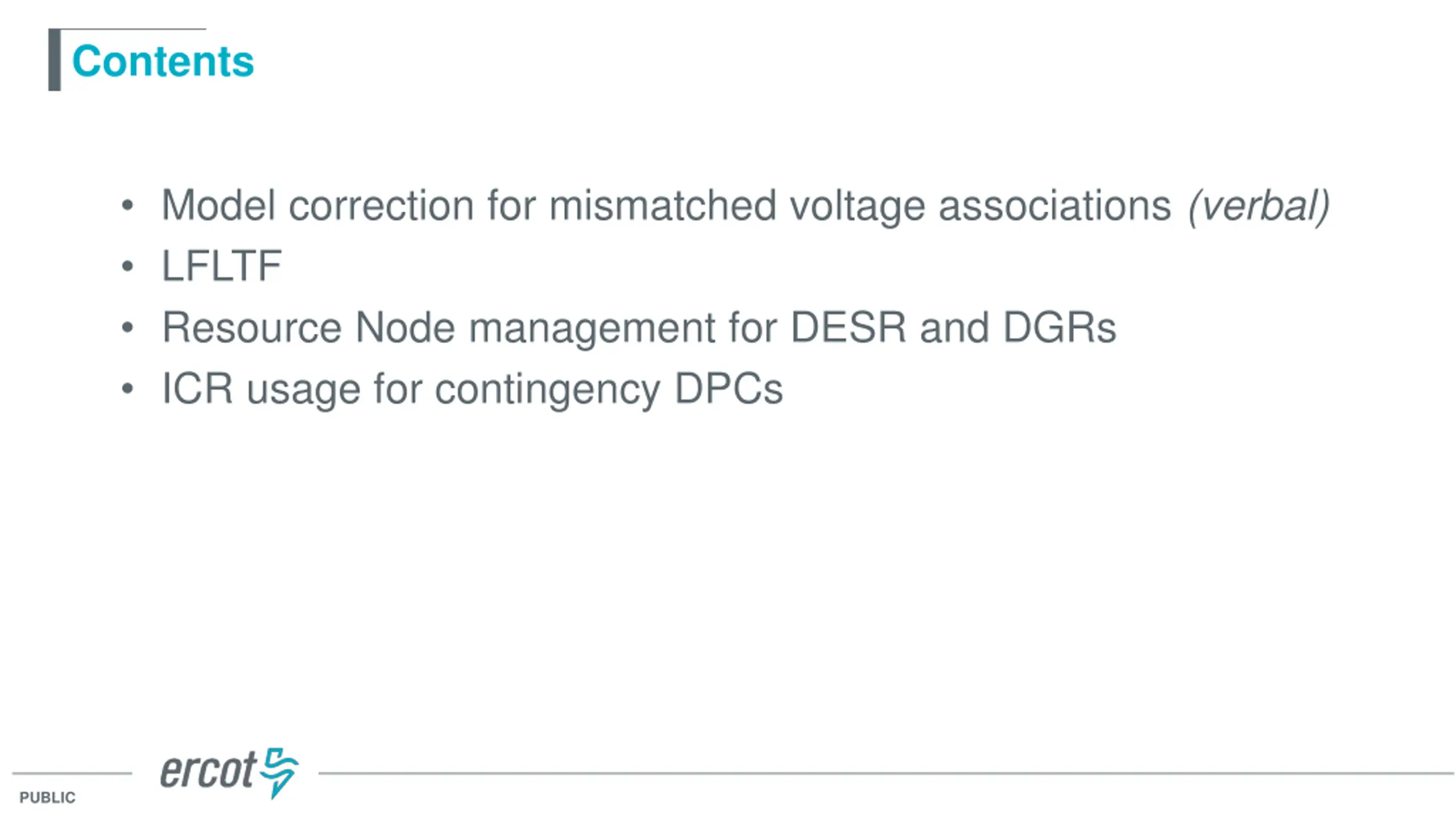

  2. Contents Model correction for mismatched voltage associations (verbal) LFLTF Resource Node management for DESR and DGRs ICR usage for contingency DPCs PUBLIC

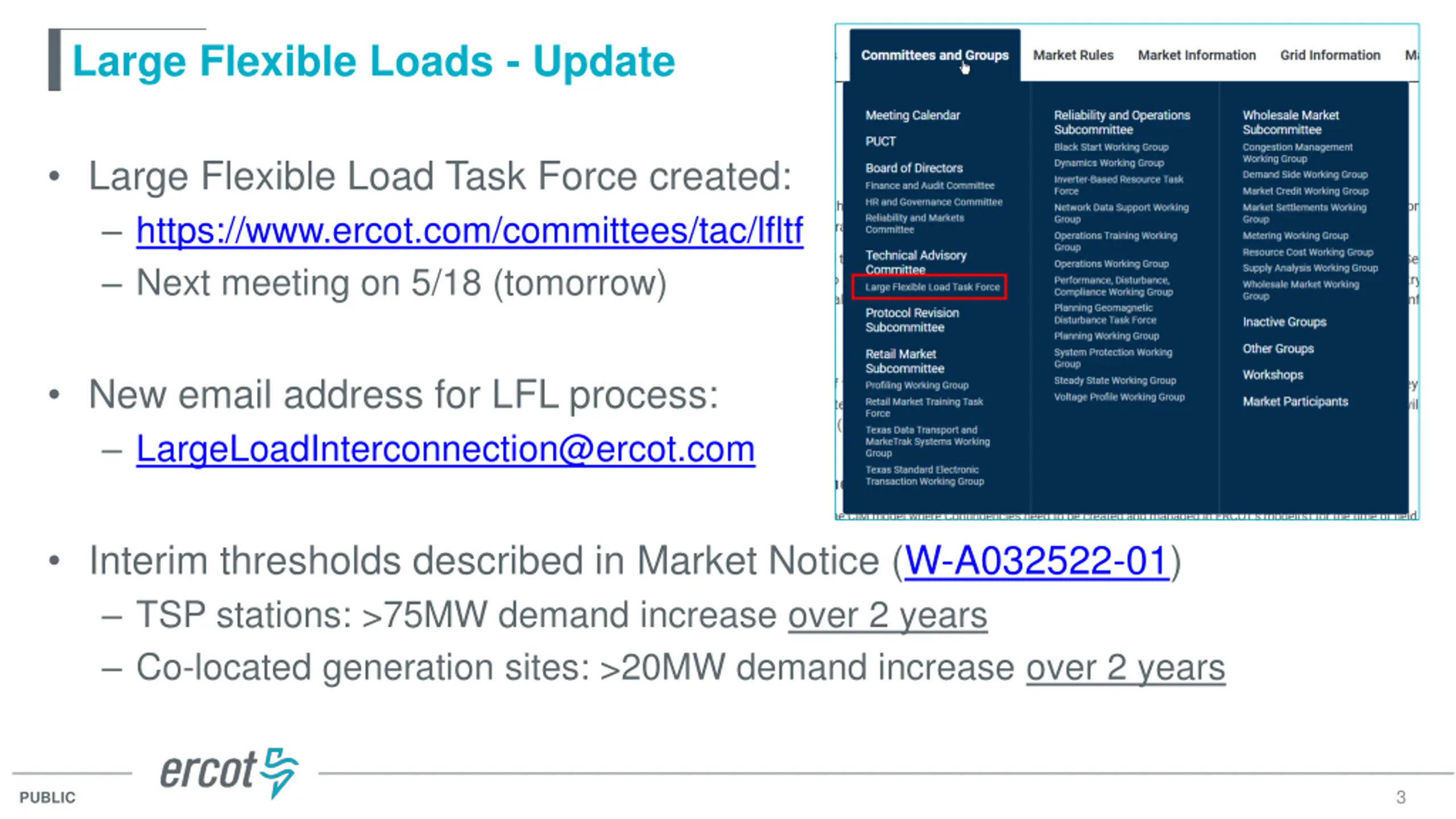

  3. Large Flexible Loads - Update Large Flexible Load Task Force created: https://www.ercot.com/committees/tac/lfltf Next meeting on 5/18 (tomorrow) New email address for LFL process: LargeLoadInterconnection@ercot.com Interim thresholds described in Market Notice (W-A032522-01) TSP stations: >75MW demand increase over 2 years Co-located generation sites: >20MW demand increase over 2 years 3 PUBLIC

  4. Resource Node Movement for DGR/DESR PUBLIC

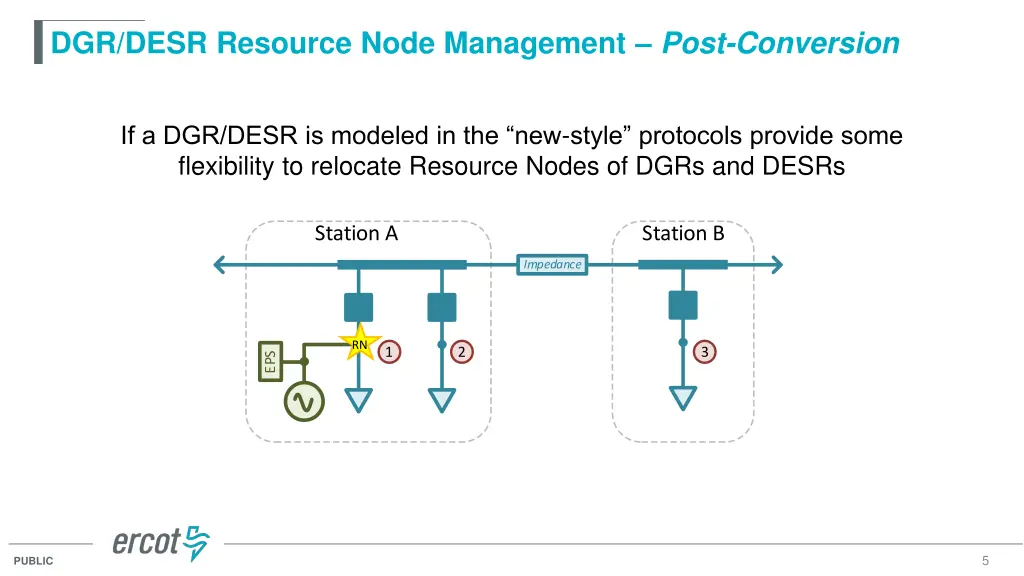

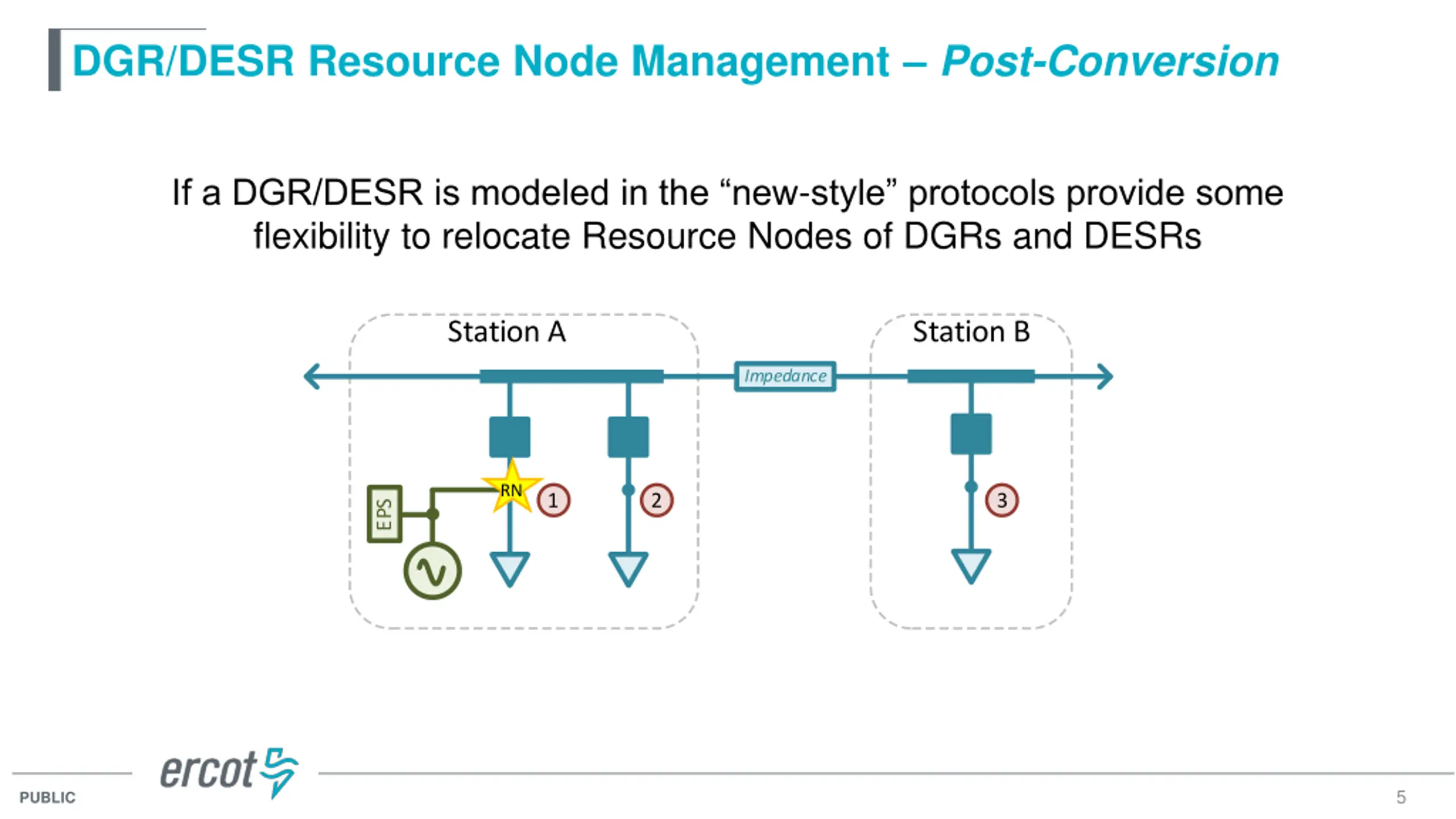

  5. DGR/DESR Resource Node Management Post-Conversion If a DGR/DESR is modeled in the new-style protocols provide some flexibility to relocate Resource Nodes of DGRs and DESRs Station A Station B Impedance RN 1 2 3 EPS 5 PUBLIC

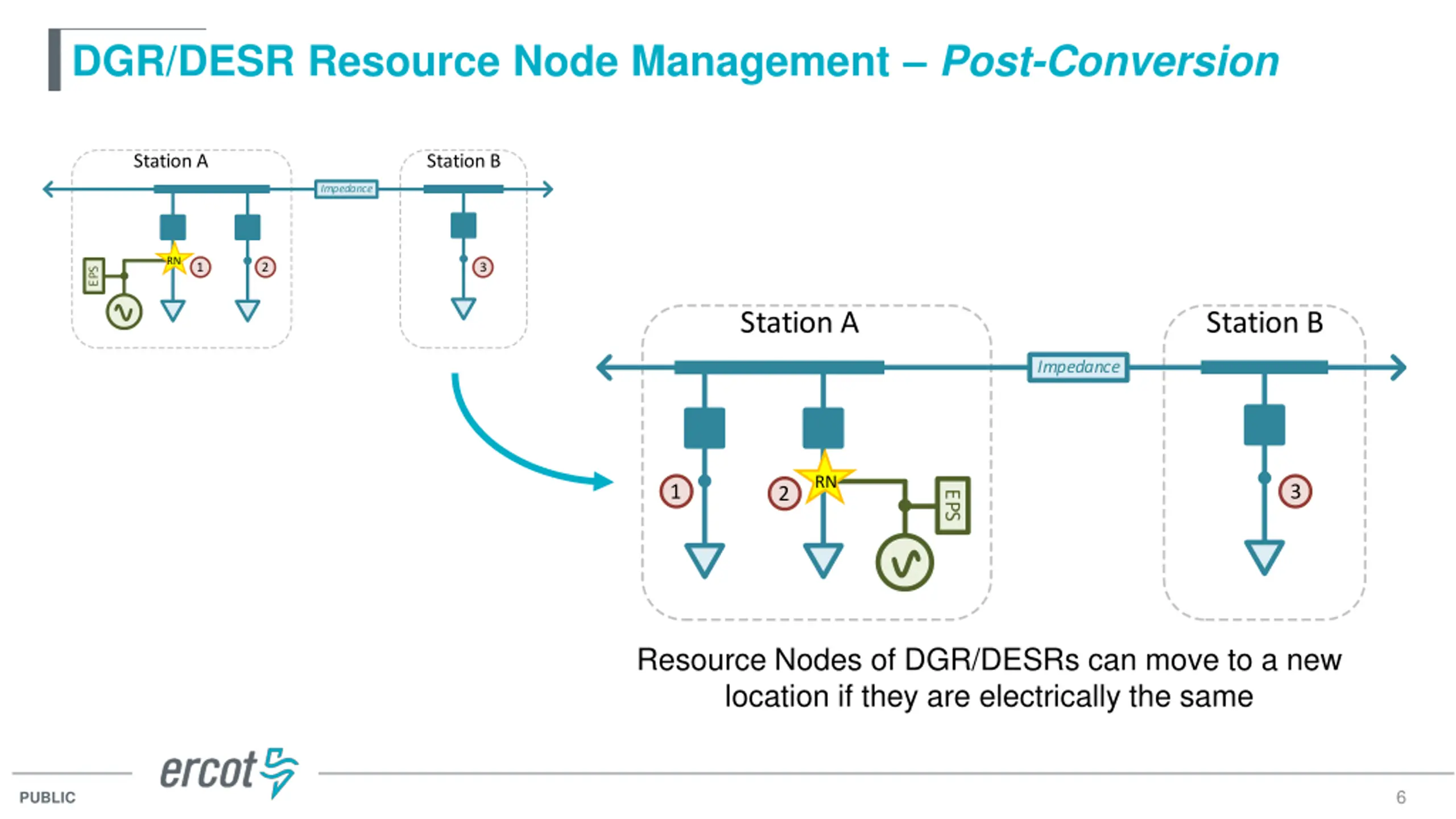

  6. DGR/DESR Resource Node Management Post-Conversion Station A Station B Impedance RN 1 2 3 EPS Station A Station B Impedance RN 1 3 2 EPS Resource Nodes of DGR/DESRs can move to a new location if they are electrically the same 6 PUBLIC

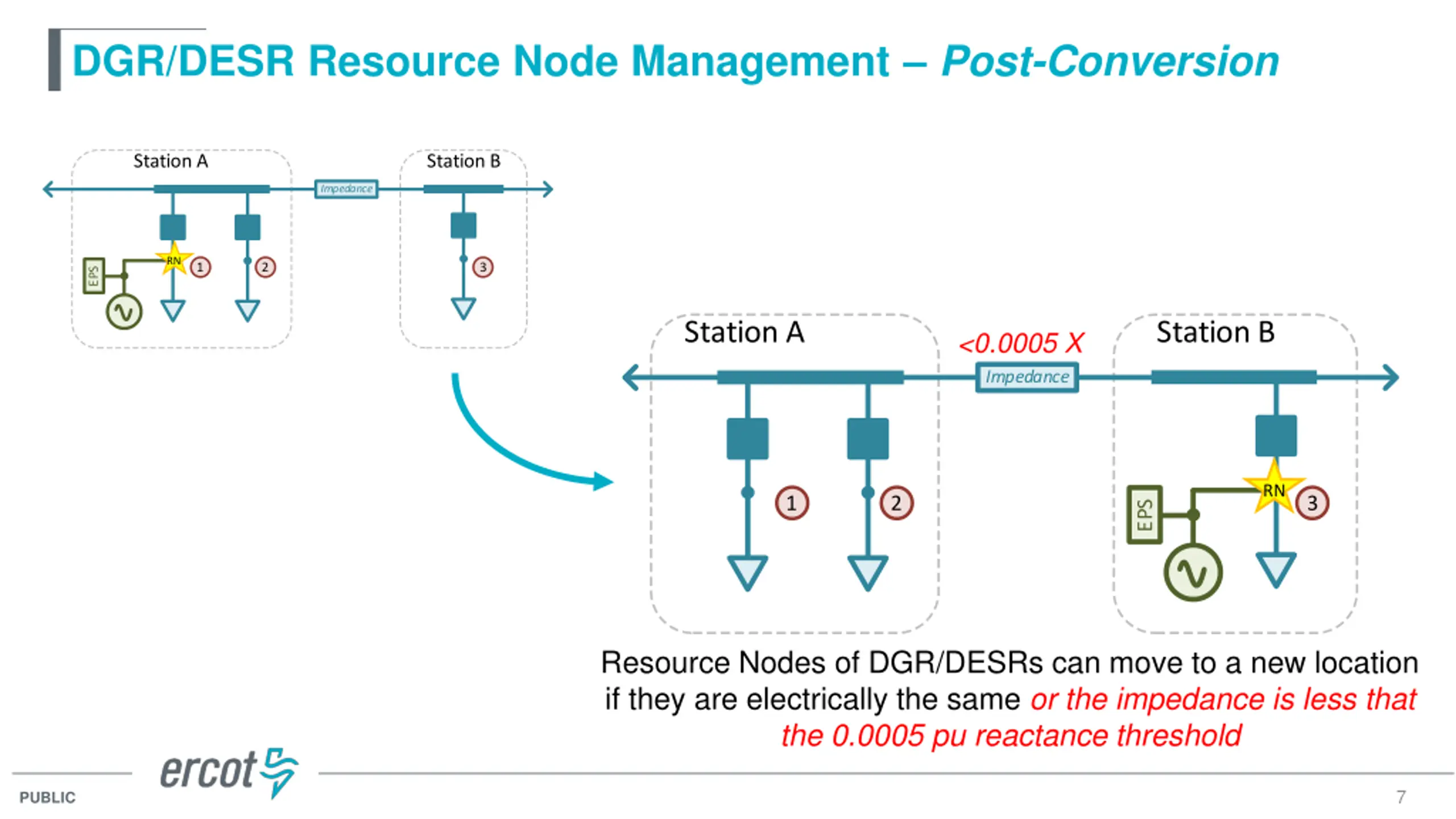

  7. DGR/DESR Resource Node Management Post-Conversion Station A Station B Impedance RN 1 2 3 EPS Station A Station B <0.0005 X Impedance RN 1 2 3 EPS Resource Nodes of DGR/DESRs can move to a new location if they are electrically the same or the impedance is less that the 0.0005 pu reactance threshold 7 PUBLIC

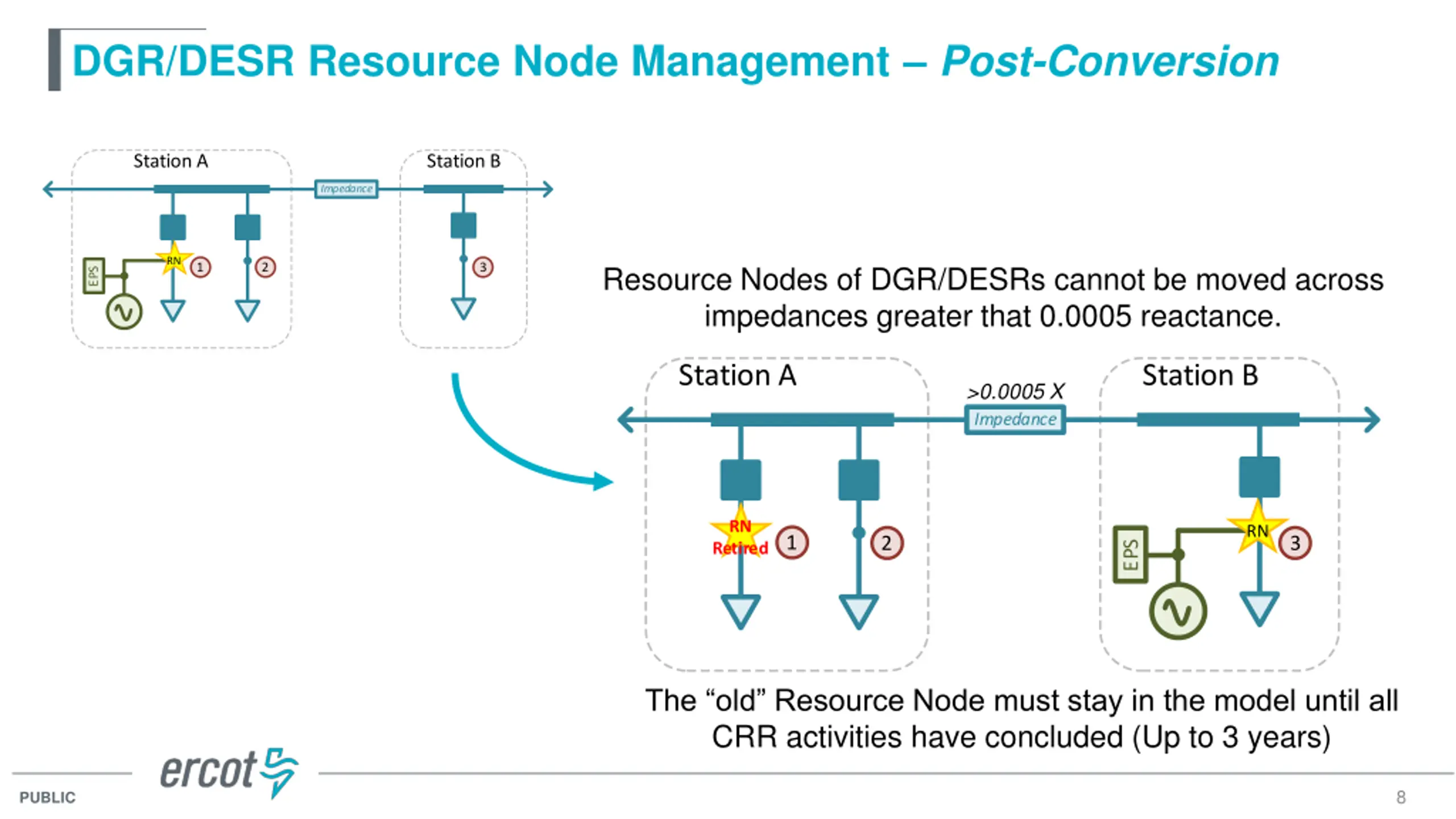

  8. DGR/DESR Resource Node Management Post-Conversion Station A Station B Impedance RN Resource Nodes of DGR/DESRs cannot be moved across impedances greater that 0.0005 reactance. 1 2 3 EPS Station A Station B >0.0005 X Impedance RN RN 1 2 3 EPS Retired The old Resource Node must stay in the model until all CRR activities have concluded (Up to 3 years) 8 PUBLIC

  9. Contingency Management Informational Change Requests 9 PUBLIC

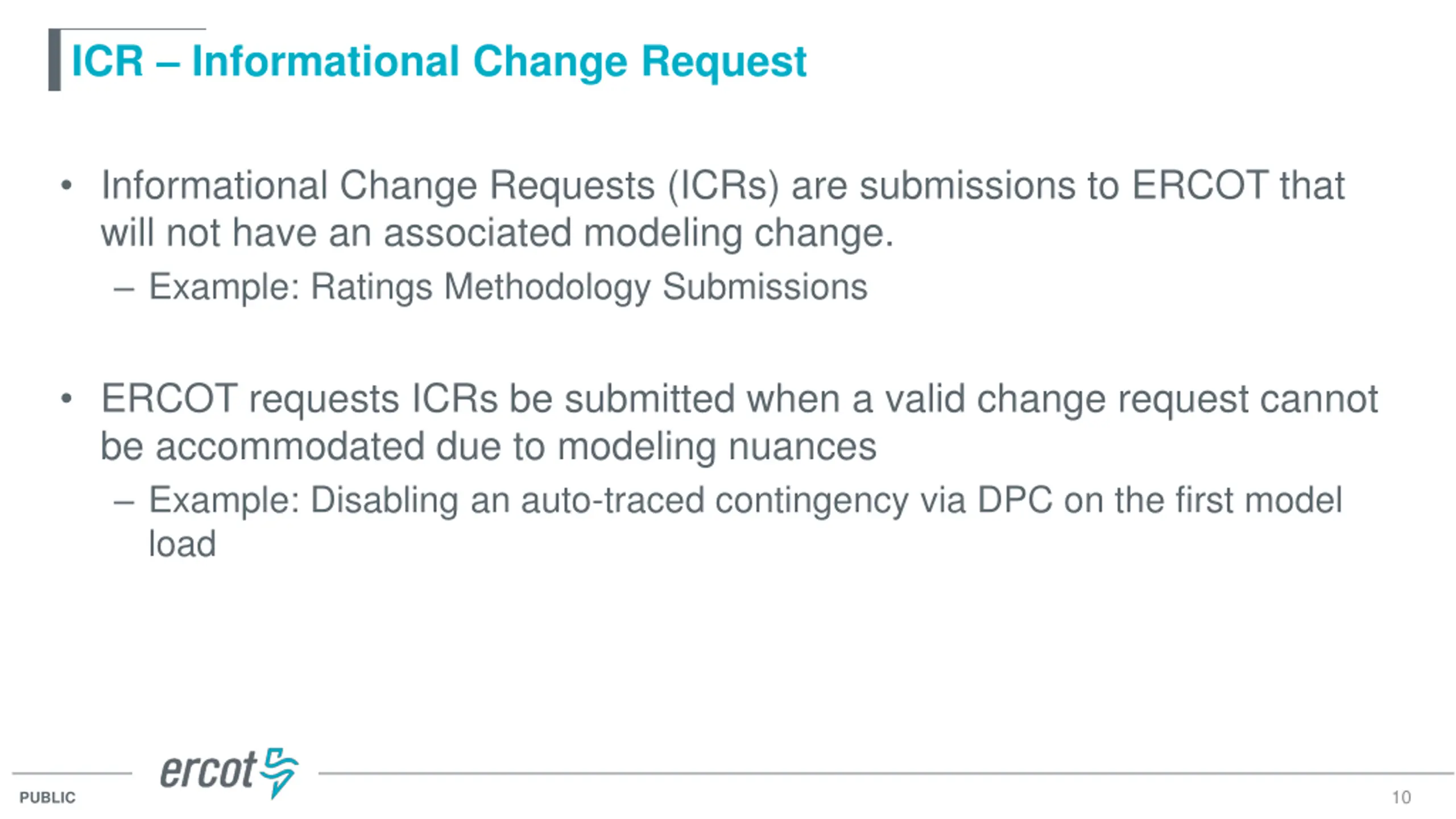

  10. ICR Informational Change Request Informational Change Requests (ICRs) are submissions to ERCOT that will not have an associated modeling change. Example: Ratings Methodology Submissions ERCOT requests ICRs be submitted when a valid change request cannot be accommodated due to modeling nuances Example: Disabling an auto-traced contingency via DPC on the first model load 10 PUBLIC

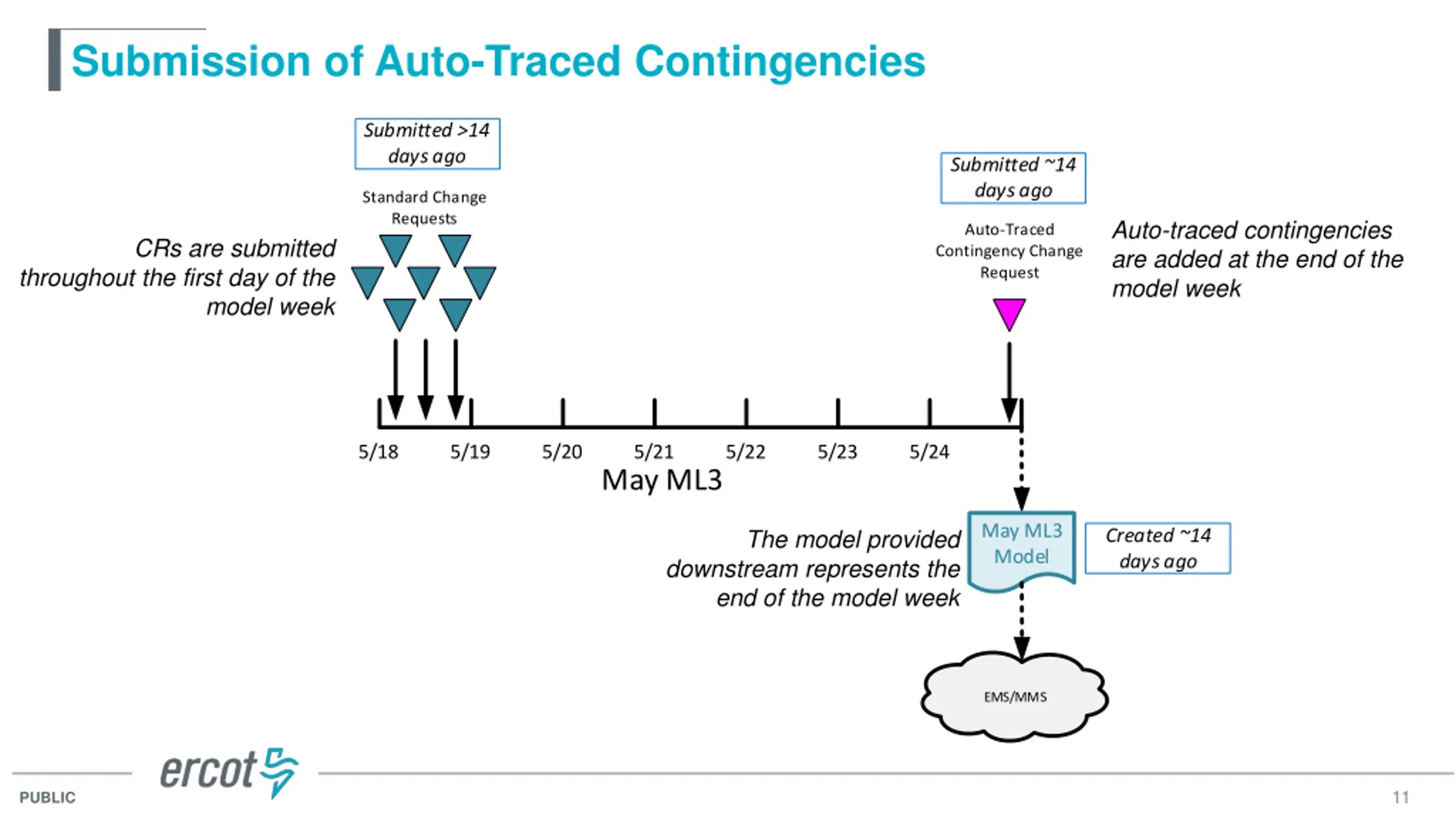

  11. Submission of Auto-Traced Contingencies Submitted >14 days ago Submitted ~14 days ago Standard Change Requests Auto-traced contingencies are added at the end of the model week Auto-Traced Contingency Change Request CRs are submitted throughout the first day of the model week 5/18 5/19 5/20 5/21 5/22 5/23 5/24 May ML3 May ML3 Model The model provided downstream represents the end of the model week Created ~14 days ago EMS/MMS 11 PUBLIC

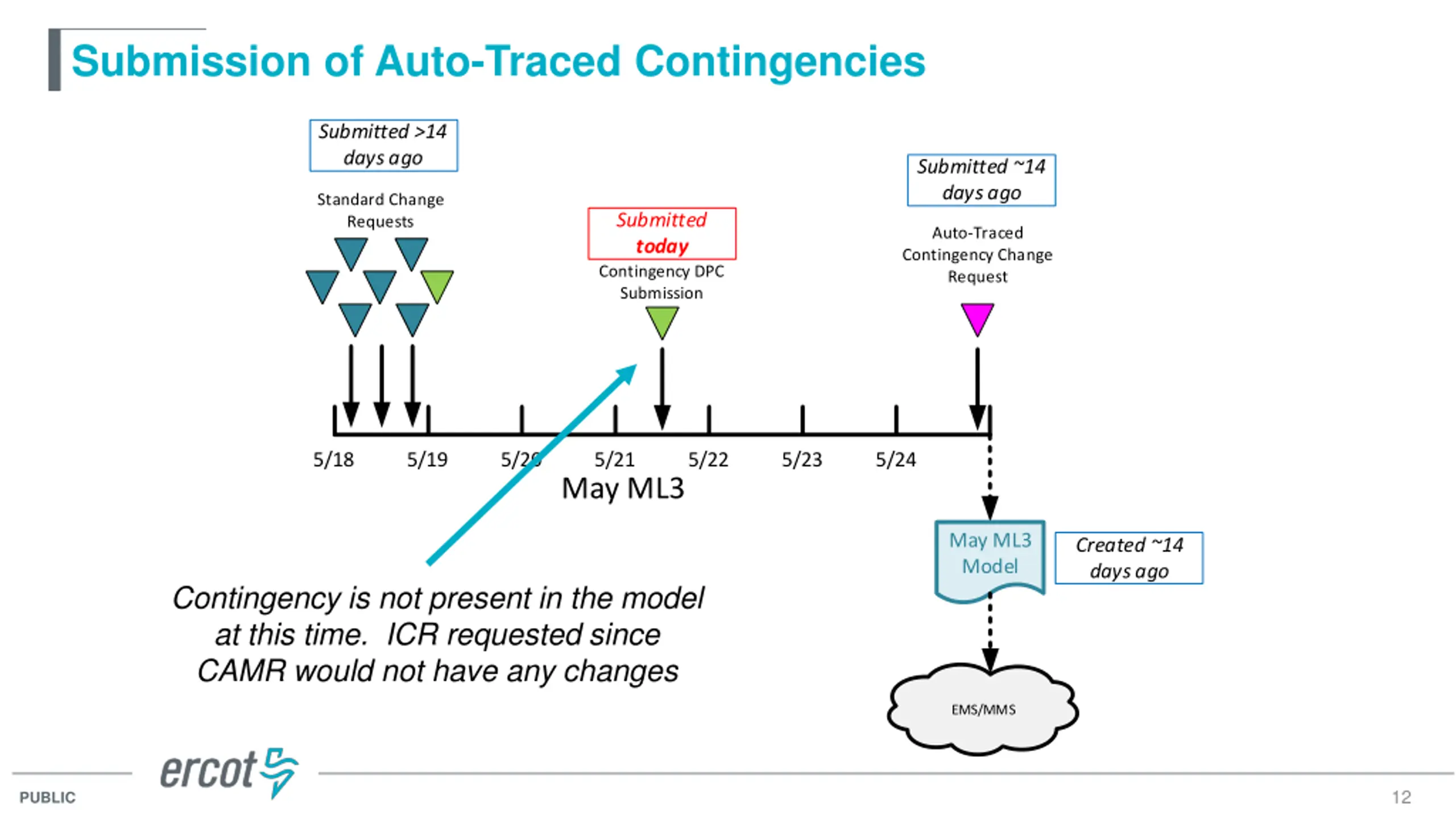

  12. Submission of Auto-Traced Contingencies Submitted >14 days ago Submitted ~14 days ago Standard Change Requests Submitted today Auto-Traced Contingency Change Request Contingency DPC Submission 5/18 5/19 5/20 5/21 5/22 5/23 5/24 May ML3 May ML3 Model Created ~14 days ago Contingency is not present in the model at this time. ICR requested since CAMR would not have any changes EMS/MMS 12 PUBLIC
