Presentation Transcript
Federal Aviation Administration Performance-Based Communication and Surveillance (PBCS) Closing remarks Presented to: ICAO Asia-Pacific RCP/RSP Workshop (Bangkok, Thailand) By: Tom Kraft tom.kraft@faa.gov Date: 13-14 May 2013

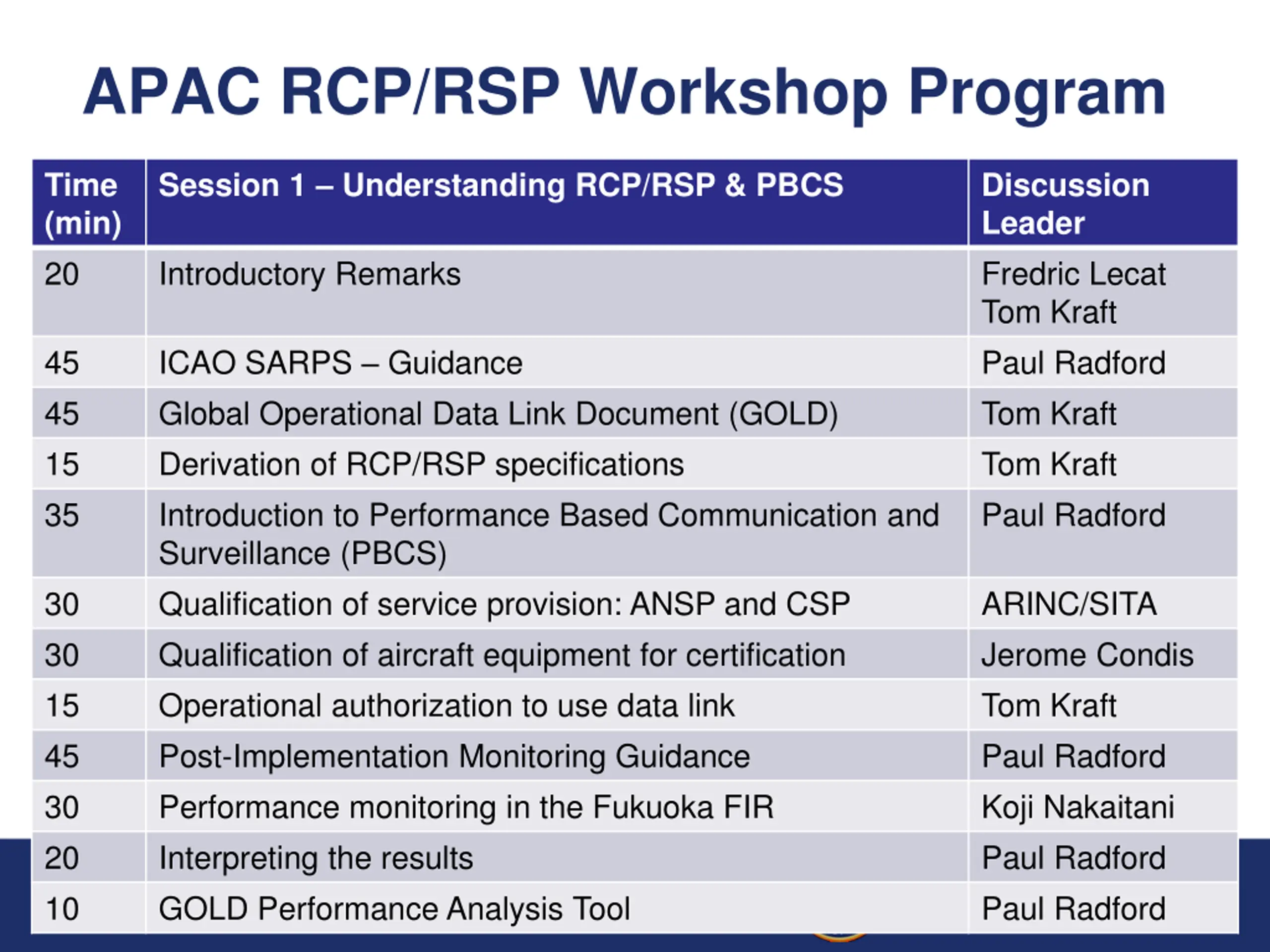

APAC RCP/RSP Workshop Program Time (min) 20 Session 1 Understanding RCP/RSP & PBCS Discussion Leader Fredric Lecat Tom Kraft Paul Radford Tom Kraft Tom Kraft Paul Radford Introductory Remarks 45 45 15 35 ICAO SARPS Guidance Global Operational Data Link Document (GOLD) Derivation of RCP/RSP specifications Introduction to Performance Based Communication and Surveillance (PBCS) Qualification of service provision: ANSP and CSP Qualification of aircraft equipment for certification Operational authorization to use data link Post-Implementation Monitoring Guidance Performance monitoring in the Fukuoka FIR Interpreting the results 30 30 15 45 30 20 ARINC/SITA Jerome Condis Tom Kraft Paul Radford Koji Nakaitani Paul Radford Paul Radford Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 10 GOLD Performance Analysis Tool 2

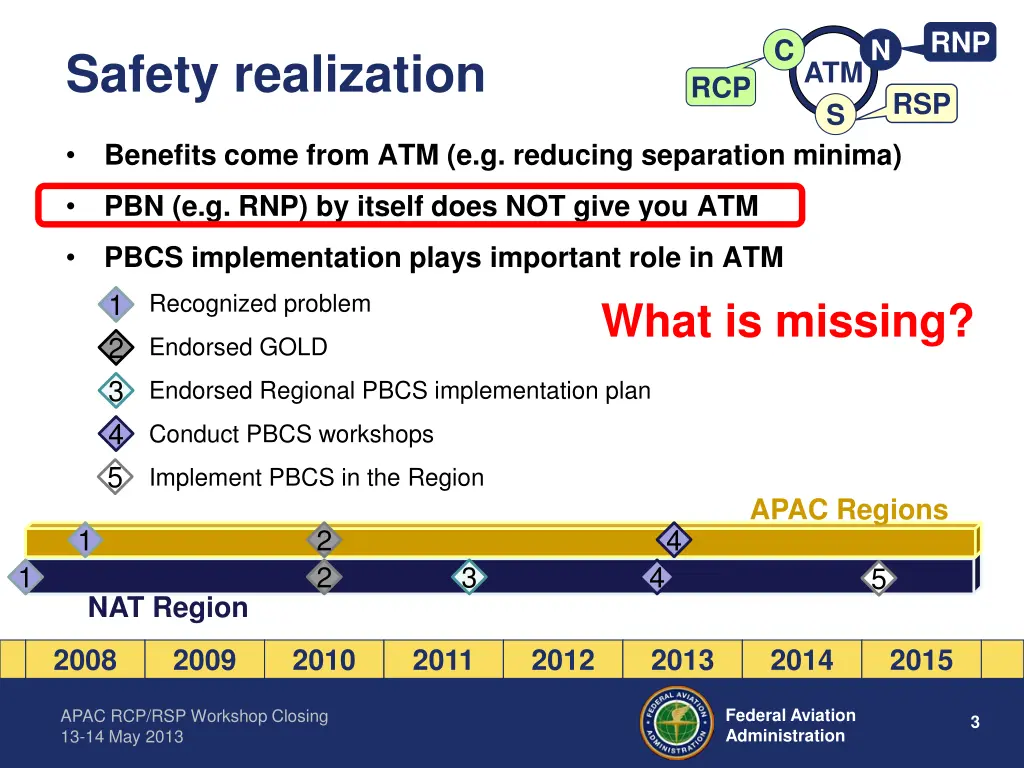

RNP C N Safety realization ATM S RCP RSP Benefits come from ATM (e.g. reducing separation minima) PBN (e.g. RNP) by itself does NOT give you ATM PBCS implementation plays important role in ATM 1 2 3 4 5 Recognized problem What is missing? Endorsed GOLD Endorsed Regional PBCS implementation plan Conduct PBCS workshops Implement PBCS in the Region APAC Regions 1 2 4 1 2 3 4 5 NAT Region 2008 2009 2010 2011 2012 2013 2014 2015 Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 3

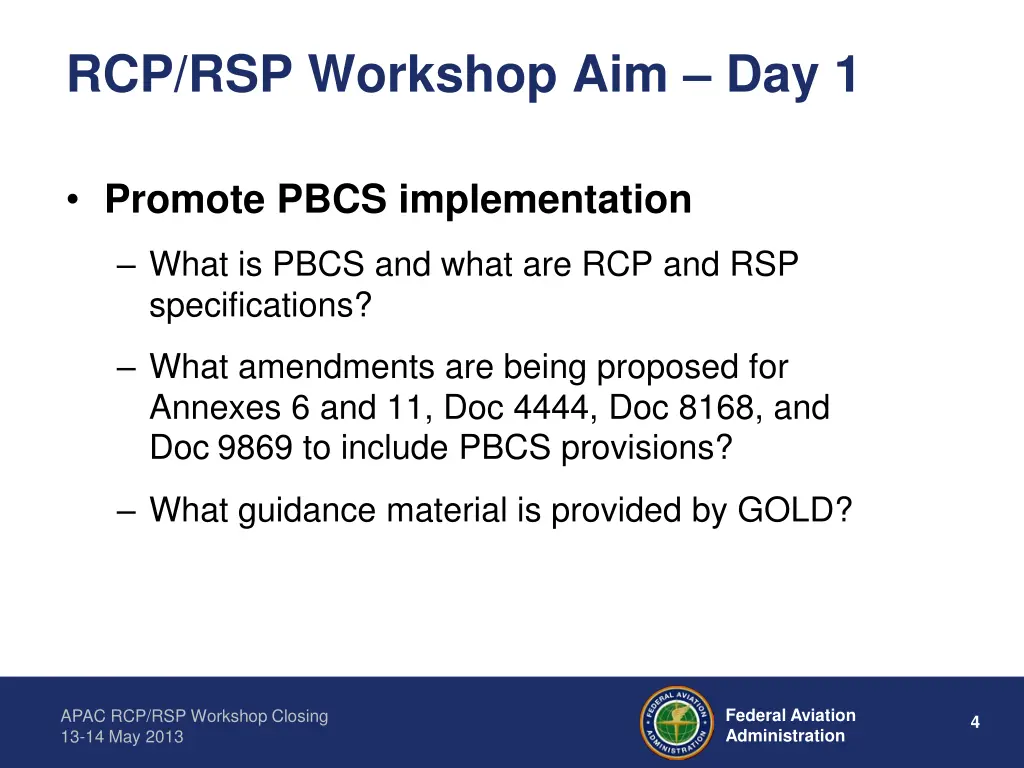

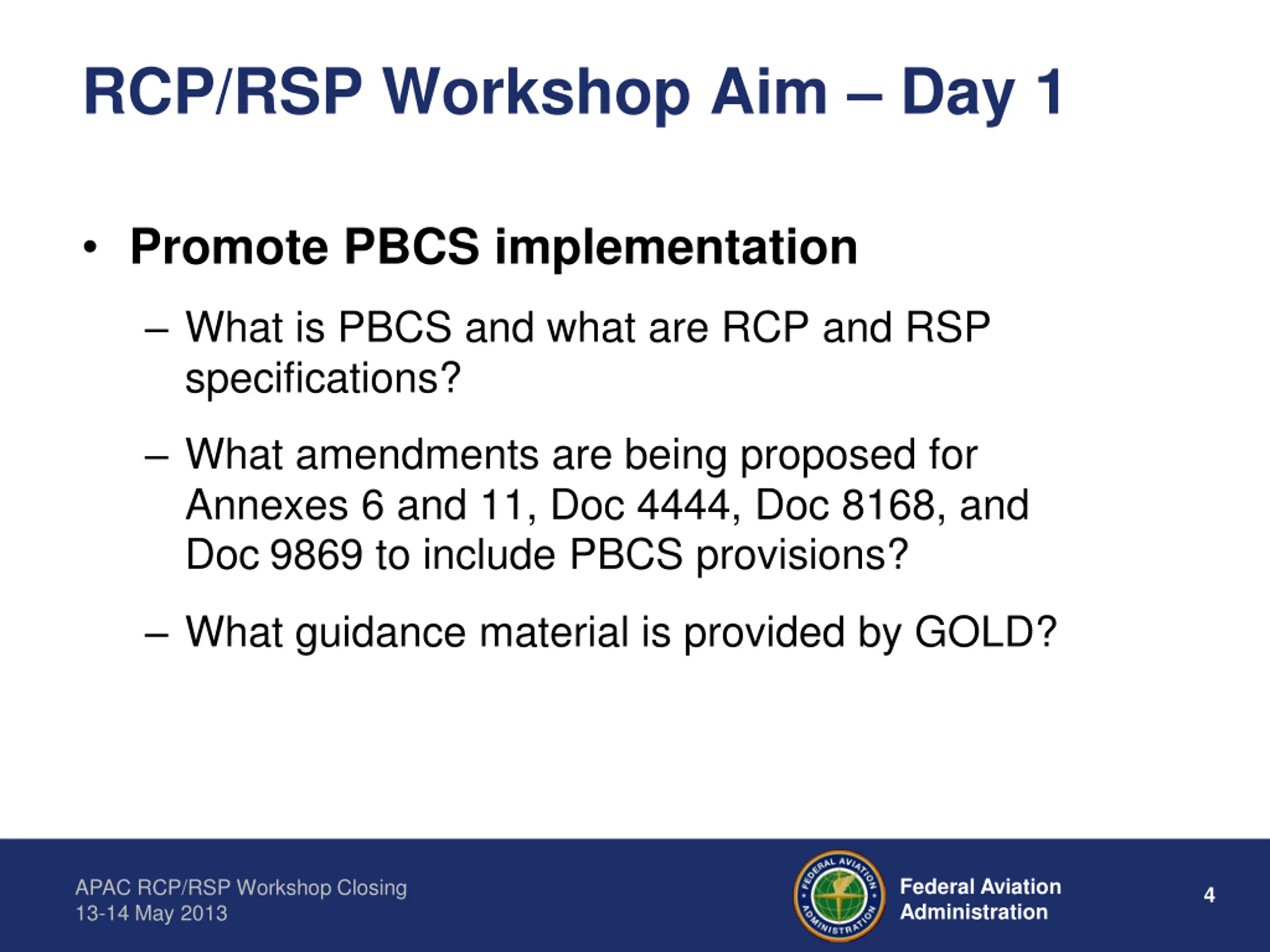

RCP/RSP Workshop Aim Day 1 Promote PBCS implementation What is PBCS and what are RCP and RSP specifications? What amendments are being proposed for Annexes 6 and 11, Doc 4444, Doc 8168, and Doc 9869 to include PBCS provisions? What guidance material is provided by GOLD? Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 4

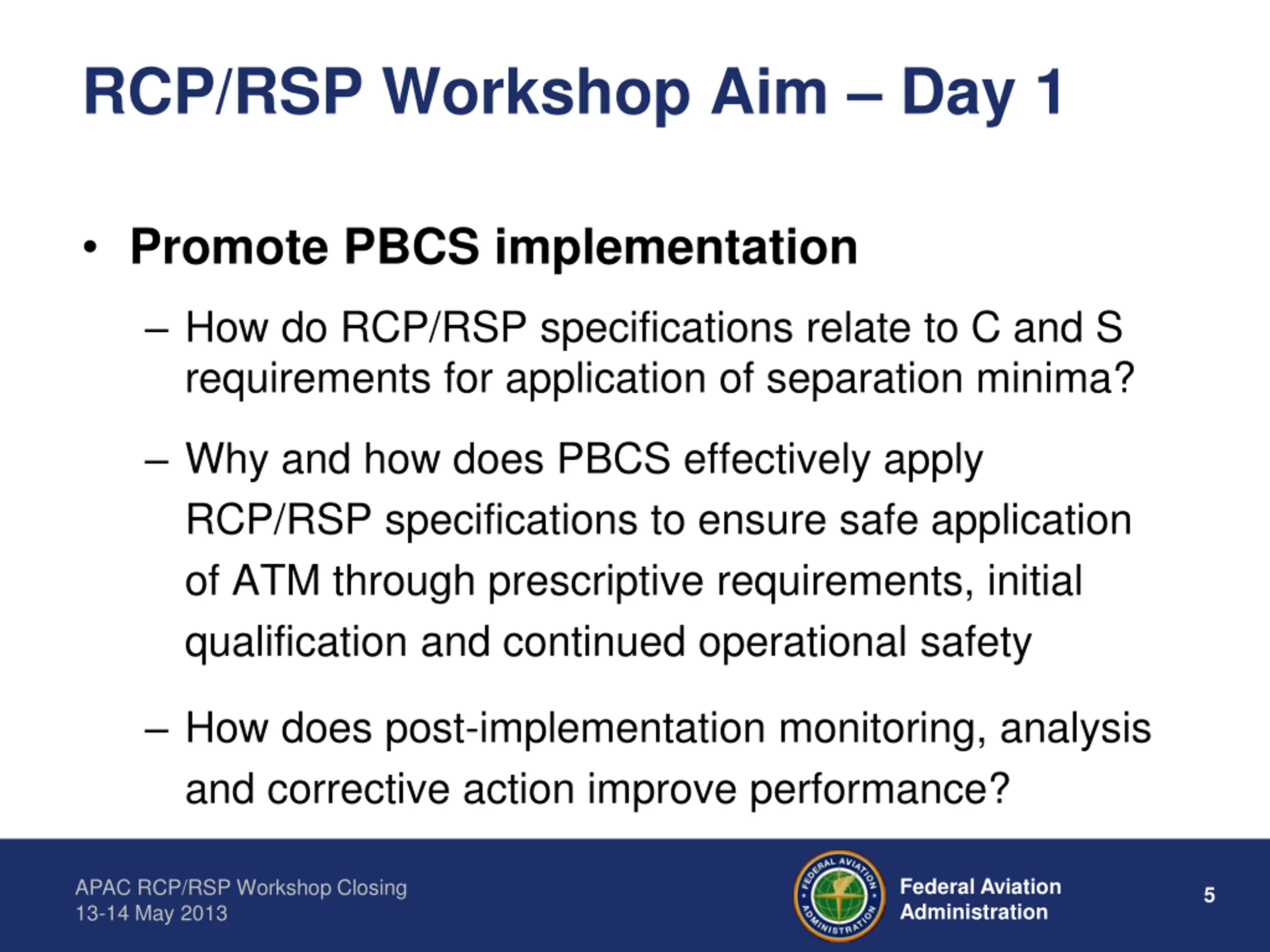

RCP/RSP Workshop Aim Day 1 Promote PBCS implementation How do RCP/RSP specifications relate to C and S requirements for application of separation minima? Why and how does PBCS effectively apply RCP/RSP specifications to ensure safe application of ATM through prescriptive requirements, initial qualification and continued operational safety How does post-implementation monitoring, analysis and corrective action improve performance? Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 5

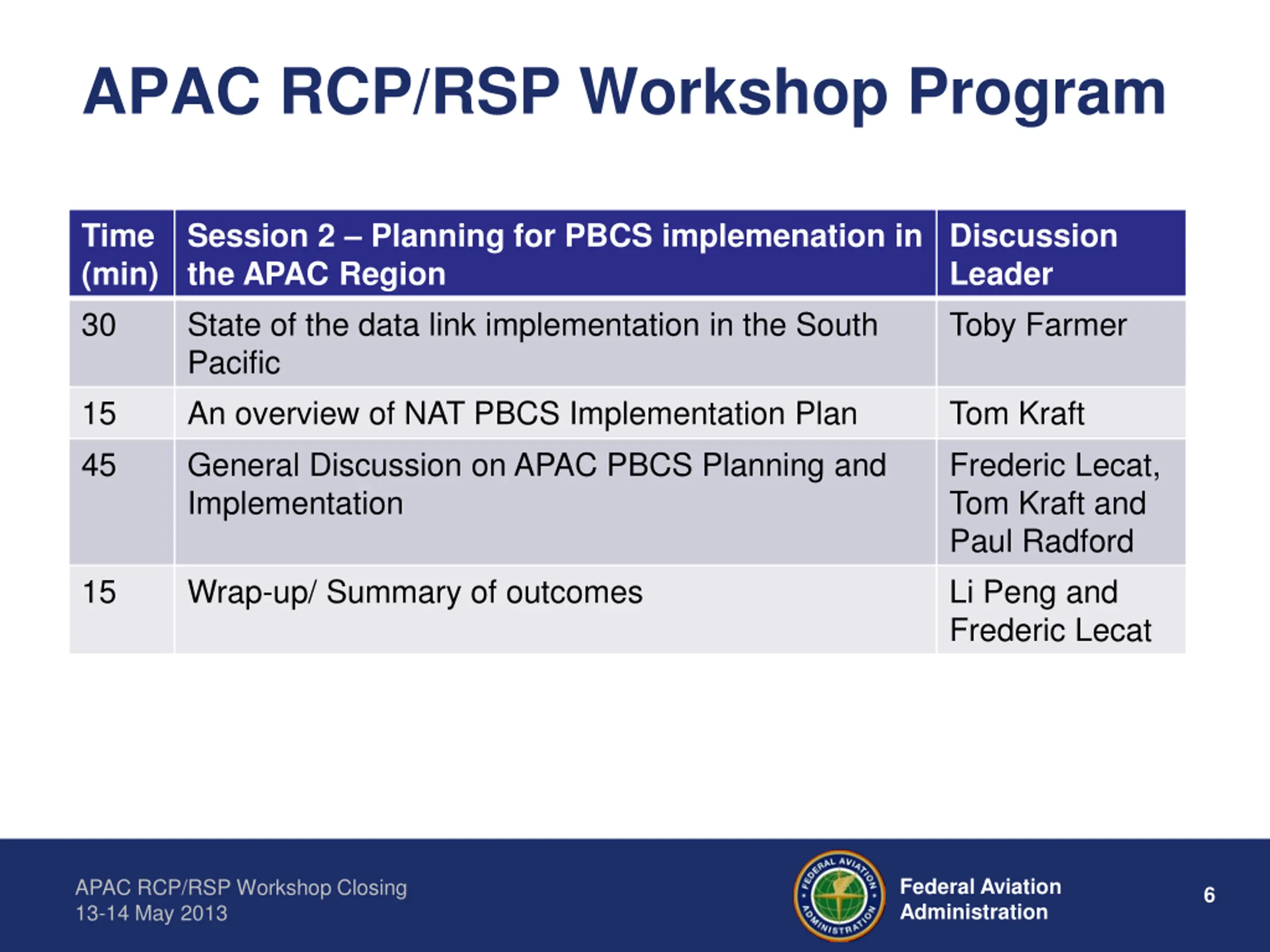

APAC RCP/RSP Workshop Program Time (min) 30 Session 2 Planning for PBCS implemenation in the APAC Region State of the data link implementation in the South Pacific An overview of NAT PBCS Implementation Plan General Discussion on APAC PBCS Planning and Implementation Discussion Leader Toby Farmer 15 45 Tom Kraft Frederic Lecat, Tom Kraft and Paul Radford Li Peng and Frederic Lecat 15 Wrap-up/ Summary of outcomes Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 6

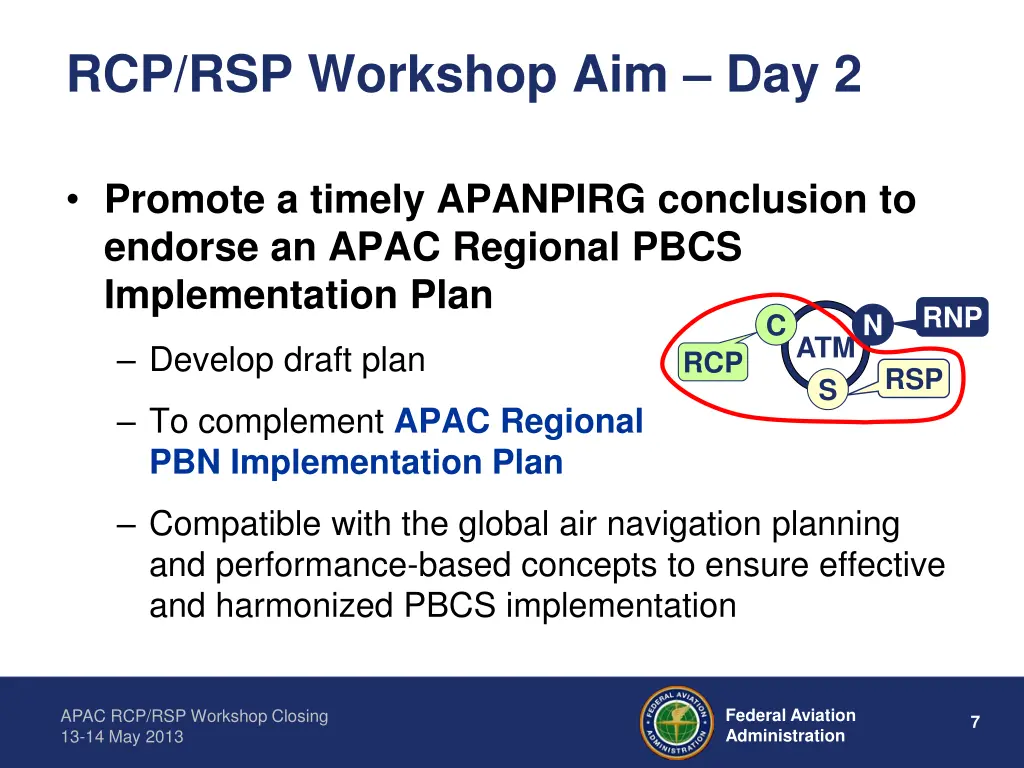

RCP/RSP Workshop Aim Day 2 Promote a timely APANPIRG conclusion to endorse an APAC Regional PBCS Implementation Plan RNP C N ATM S Develop draft plan RCP RSP To complement APAC Regional PBN Implementation Plan Compatible with the global air navigation planning and performance-based concepts to ensure effective and harmonized PBCS implementation Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 7
NAT PBCS implementation planning tasks Completed On track TASK ID TASK DESCRIPTOR GENERAL PROJECT DEVELOPMENT & MANAGEMENT COMPLETE BY LEAD 1 2 3 4 Plan Target dates RCP/RSP specifications NAT PBCS Workshop(s) NAT IMG/38 and NAT SPG/47 NAT IMG/38 and NAT SPG/47 NAT SPG/47 2012-2013 NAT CNSG NAT IMG NAT SARSIG ICAO/ States DOCUMENTATION NAT ATMG in coordination with CNSG GOLD ad-hoc group NAT ATMG/ CNSG NAT ATMG/ CNSG 5 Operational concepts NAT IMG/42and NAT SPG/49 6 GOLD amendments NAT IMG/42 and NAT SPG/49 7 Contingency procedures NAT IMG/42 and NAT SPG/49 8 Restoration of service NAT IMG/42 and NAT SPG/49 a) NAT IMG/42 and NAT SPG/49 (as part of the NAT SUPPs PfA) and GOLD b) amend Doc 4444 target date - NAT SPG/50 NAT CNSG ICAO (Global) 9 Flight plan requirements NAT CNSG NAT ATMG States CNSG OPS/AIR 10 PfA for NAT Regional Supplementary Procedures (NAT SUPPS) NAT IMG/42 and NAT SPG/49 11 14 15 AIPs and other State documents supporting NAT SUPPS GOLD proposal for RCP/RSP compliance determination GOLD proposal for guidelines on operator eligibility Consistent with Task 10 NAT IMG/42 and NAT SPG/49 NAT IMG/42 and NAT SPG/49 IMPLEMENTATION ACTIVITIES Before the start of operational trials of RLongSM or RLatSM. 12 ATC automation changes NAT ANSPs ANSPs, DLMA, CNSG, SARSIG 13 Confirm actual CPDLC and ADS C performance Prior to operational implementation AIRWORTHINESS AND OPERATIONAL ELIGIBILITY End of 2014, Prior to operational implementation of RLatSM or RLongSM SOG, States, ANSPs, Users 16 State regulations and guidance material Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 17 Post-implementation monitoring POST IMPLEMENTATION TASKS 8 ANSPs, DLMA, CNSG

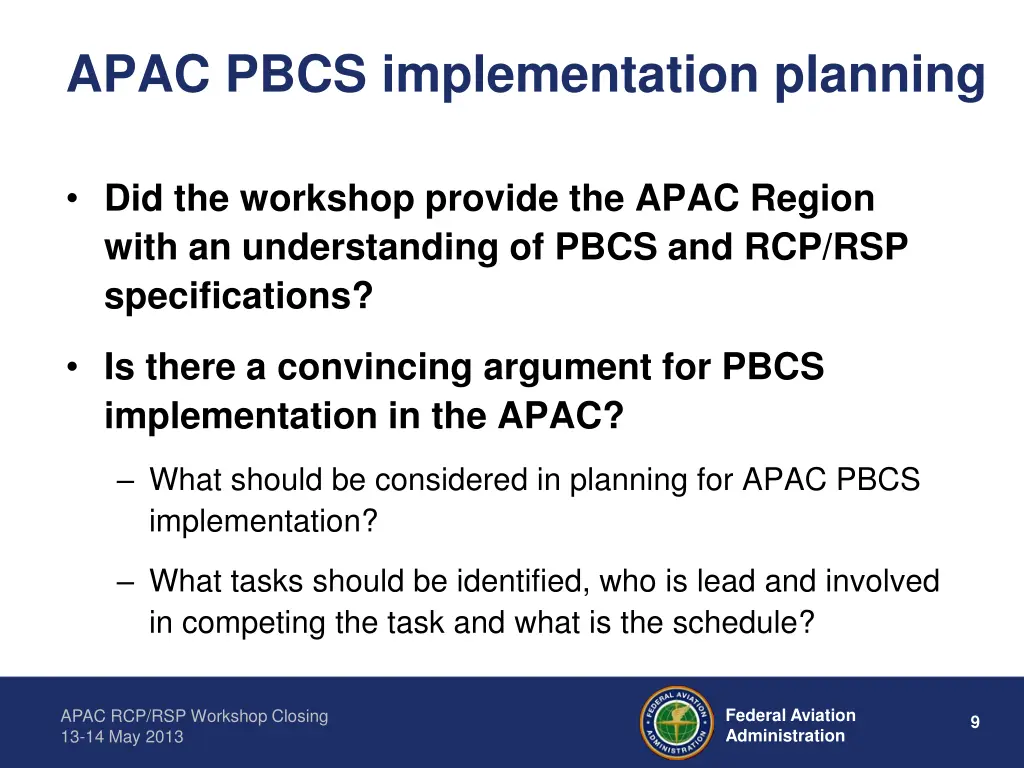

APAC PBCS implementation planning Did the workshop provide the APAC Region with an understanding of PBCS and RCP/RSP specifications? Is there a convincing argument for PBCS implementation in the APAC? What should be considered in planning for APAC PBCS implementation? What tasks should be identified, who is lead and involved in competing the task and what is the schedule? Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 9
APAC PBCS Implementation Plan TASK ID GENERAL PROJECT DEVELOPMENT & MANAGEMENT 1 Plan 2 Target dates 3 Applicability of RCP/RSP specifications 4 PBCS Workshop(s) DOCUMENTATION 5 Operational concepts 6 GOLD amendments 7 Contingency procedures 8 Restoration of service 9 Flight plan requirements 10 PfA for NAT Regional Supplementary Procedures (NAT SUPPS) 11 AIPs and other State documents supporting NAT SUPPS 14 GOLD proposal for RCP/RSP compliance determination 15 GOLD proposal for guidelines on operator eligibility IMPLEMENTATION ACTIVITIES 12 ATC automation changes 13 Confirm actual CPDLC and ADS C performance AIRWORTHINESS AND OPERATIONAL ELIGIBILITY 16 State regulations and guidance material POST IMPLEMENTATION TASKS 17 Post-implementation monitoring TASK DESCRIPTOR COMPLETE BY LEAD Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 10

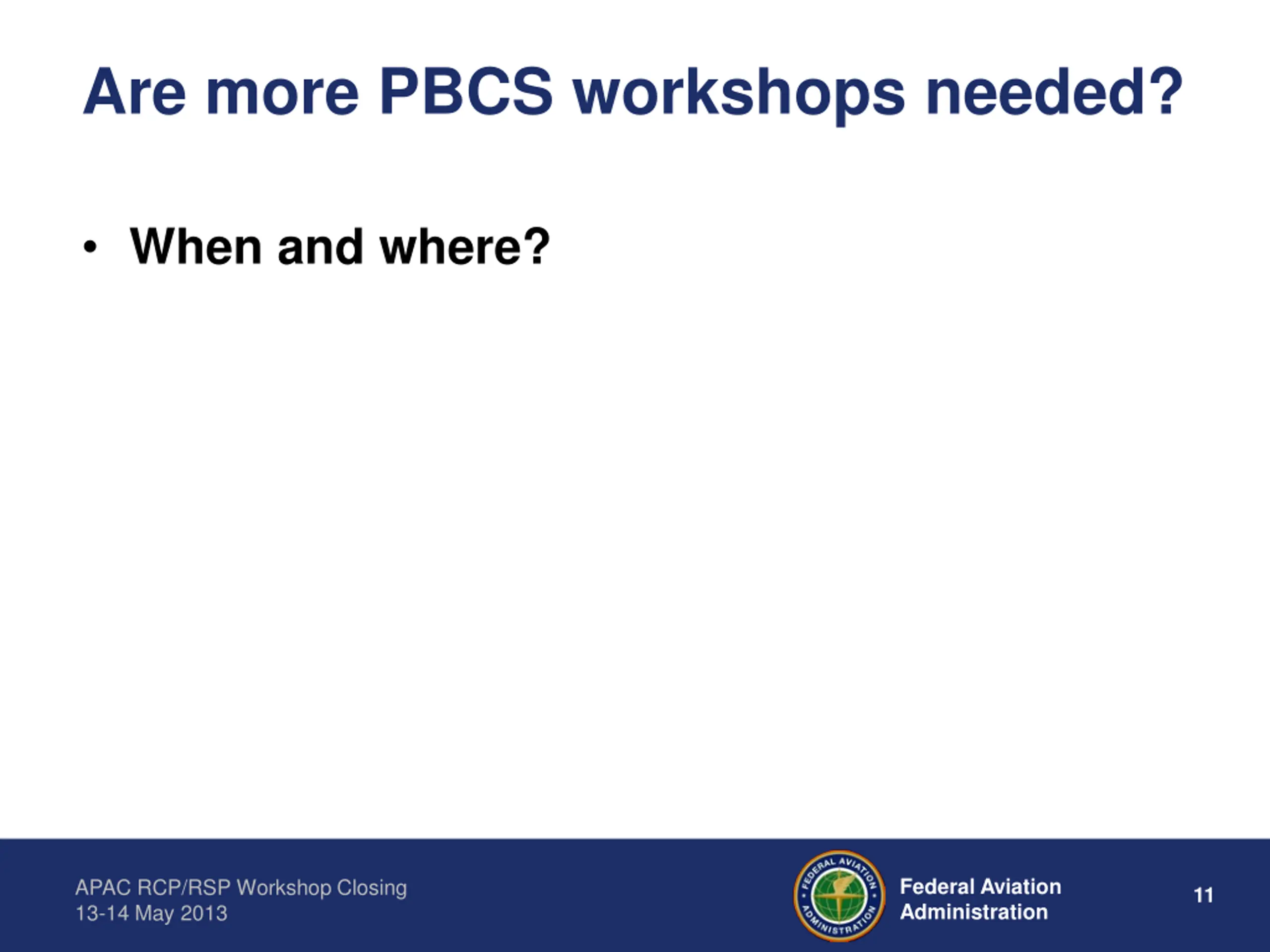

Are more PBCS workshops needed? When and where? Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 11
Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 12
Federal Aviation Administration APAC RCP/RSP Workshop Closing 13-14 May 2013 13

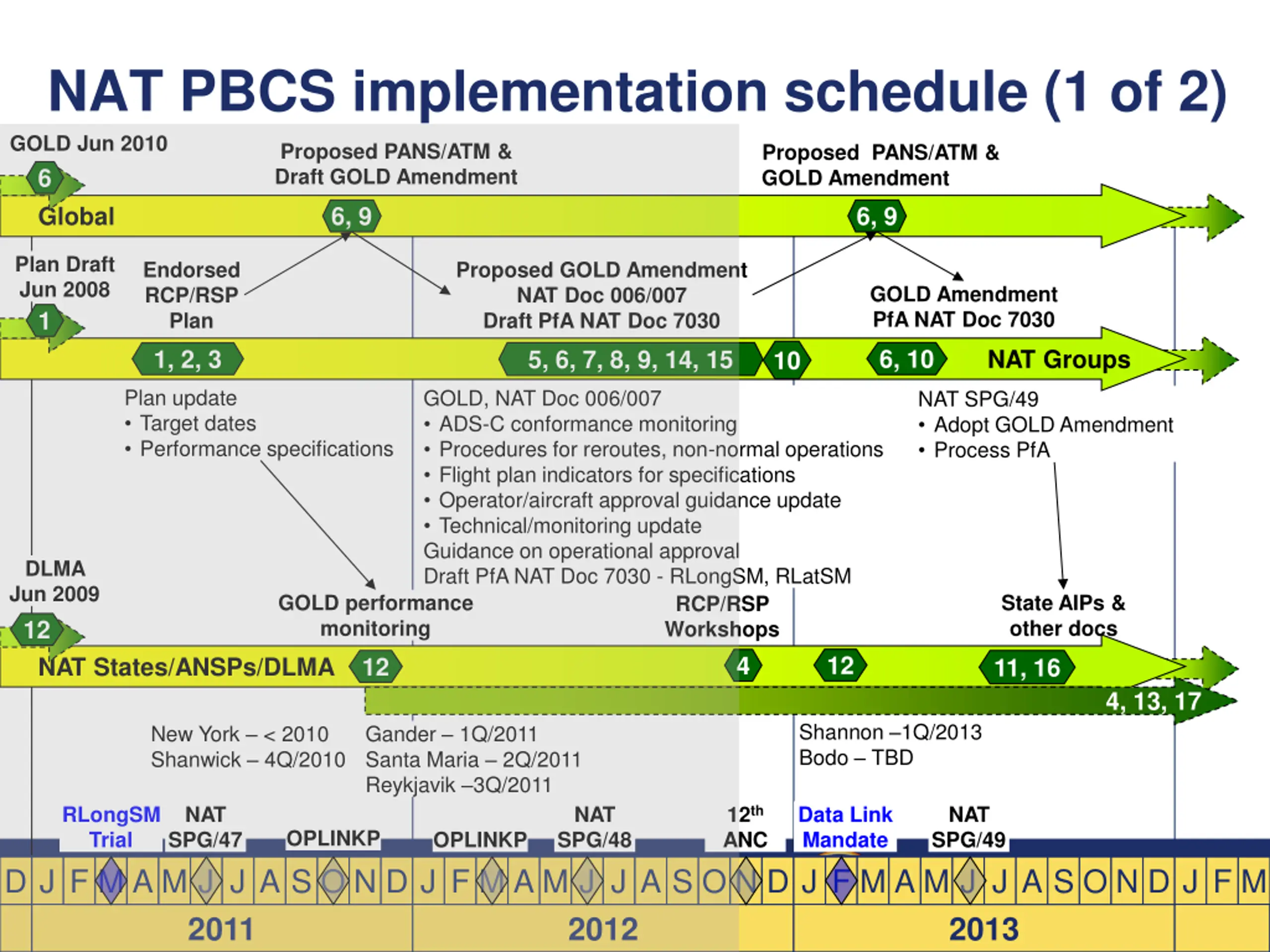

NAT PBCS implementation schedule (1 of 2) GOLD Jun 2010 Proposed PANS/ATM & Draft GOLD Amendment Proposed PANS/ATM & GOLD Amendment 6, 9 6 Global 6, 9 Plan Draft Jun 2008 1 Endorsed RCP/RSP Plan 1, 2, 3 Proposed GOLD Amendment NAT Doc 006/007 Draft PfA NAT Doc 7030 5, 6, 7, 8, 9, 14, 15 GOLD Amendment PfA NAT Doc 7030 6, 10 NAT Groups 10 Plan update Target dates Performance specifications GOLD, NAT Doc 006/007 ADS-C conformance monitoring Procedures for reroutes, non-normal operations Flight plan indicators for specifications Operator/aircraft approval guidance update Technical/monitoring update Guidance on operational approval Draft PfA NAT Doc 7030 - RLongSM, RLatSM GOLD performance monitoring 12 NAT SPG/49 Adopt GOLD Amendment Process PfA DLMA Jun 2009 State AIPs & other docs RCP/RSP Workshops 12 12 4 NAT States/ANSPs/DLMA 11, 16 4, 13, 17 Shannon 1Q/2013 Bodo TBD New York < 2010 Shanwick 4Q/2010 Santa Maria 2Q/2011 Reykjavik 3Q/2011 NAT SPG/47 OPLINKP Gander 1Q/2011 RLongSM Trial NAT SPG/48 12th ANC Data Link Mandate NAT SPG/49 OPLINKP D J F M A M J J A S O N D J F M A M J J A S O N D J F M A M J J A S O N D J F M Federal Aviation Administration 2013 APAC RCP/RSP Workshop Closing 13-14 May 2013 2011 14 2012

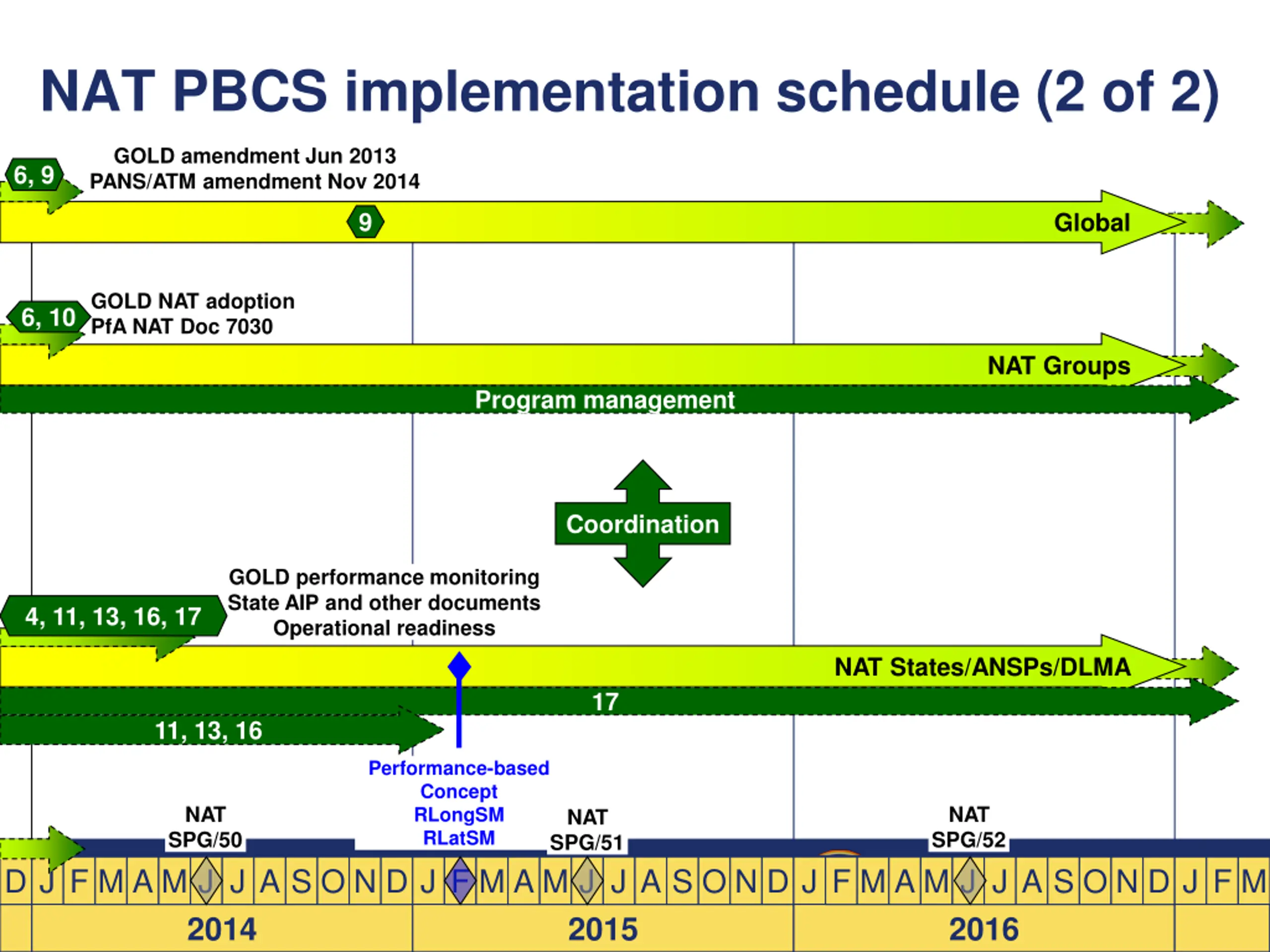

NAT PBCS implementation schedule (2 of 2) GOLD amendment Jun 2013 PANS/ATM amendment Nov 2014 6, 9 9 Global GOLD NAT adoption PfA NAT Doc 7030 6, 10 NAT Groups Program management Coordination GOLD performance monitoring State AIP and other documents Operational readiness 4, 11, 13, 16, 17 NAT States/ANSPs/DLMA 17 11, 13, 16 Performance-based Concept RLongSM RLatSM NAT SPG/50 NAT SPG/52 NAT SPG/51 D J F M A M J J A S O N D J F M A M J J A S O N D J F M A M J J A S O N D J F M Federal Aviation Administration 2016 APAC RCP/RSP Workshop Closing 13-14 May 2013 2014 15 2015
