Honeoye Falls-Lima Central School District Phase 3.B High School Contract Recommendations
This document outlines the contract recommendations for Phase 3.B High School construction in Honeoye Falls-Lima Central School District. It includes bid participation, contract awards, budget summary, project milestone dates, and related details.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
Honeoye Falls-Lima Central School District Phase 3.B High School Contract Recommendations

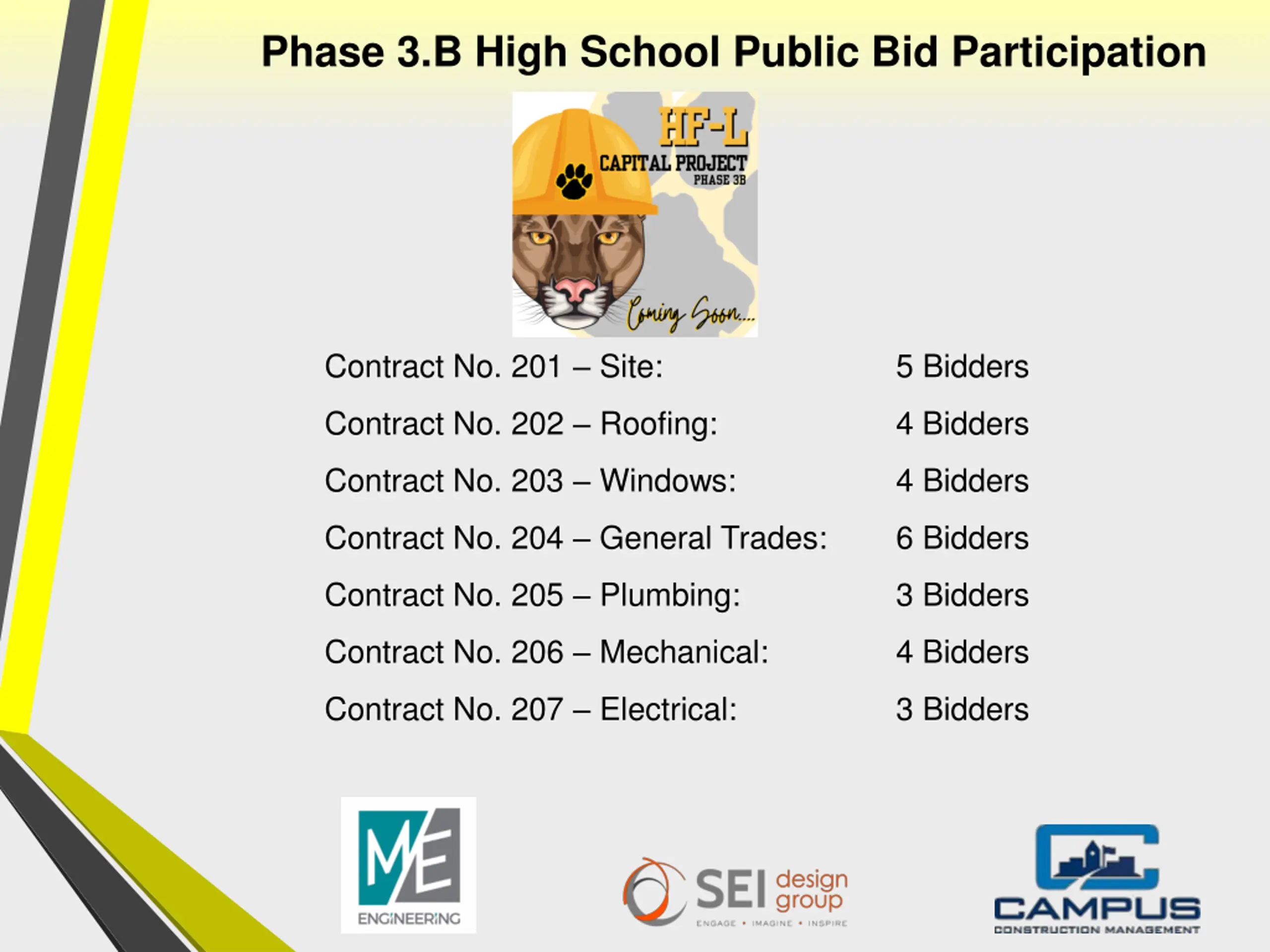

Phase 3.B High School Public Bid Participation Contract No. 201 Site: 5 Bidders Contract No. 202 Roofing: 4 Bidders Contract No. 203 Windows: 4 Bidders Contract No. 204 General Trades: 6 Bidders Contract No. 205 Plumbing: 3 Bidders Contract No. 206 Mechanical: 4 Bidders Contract No. 207 Electrical: 3 Bidders

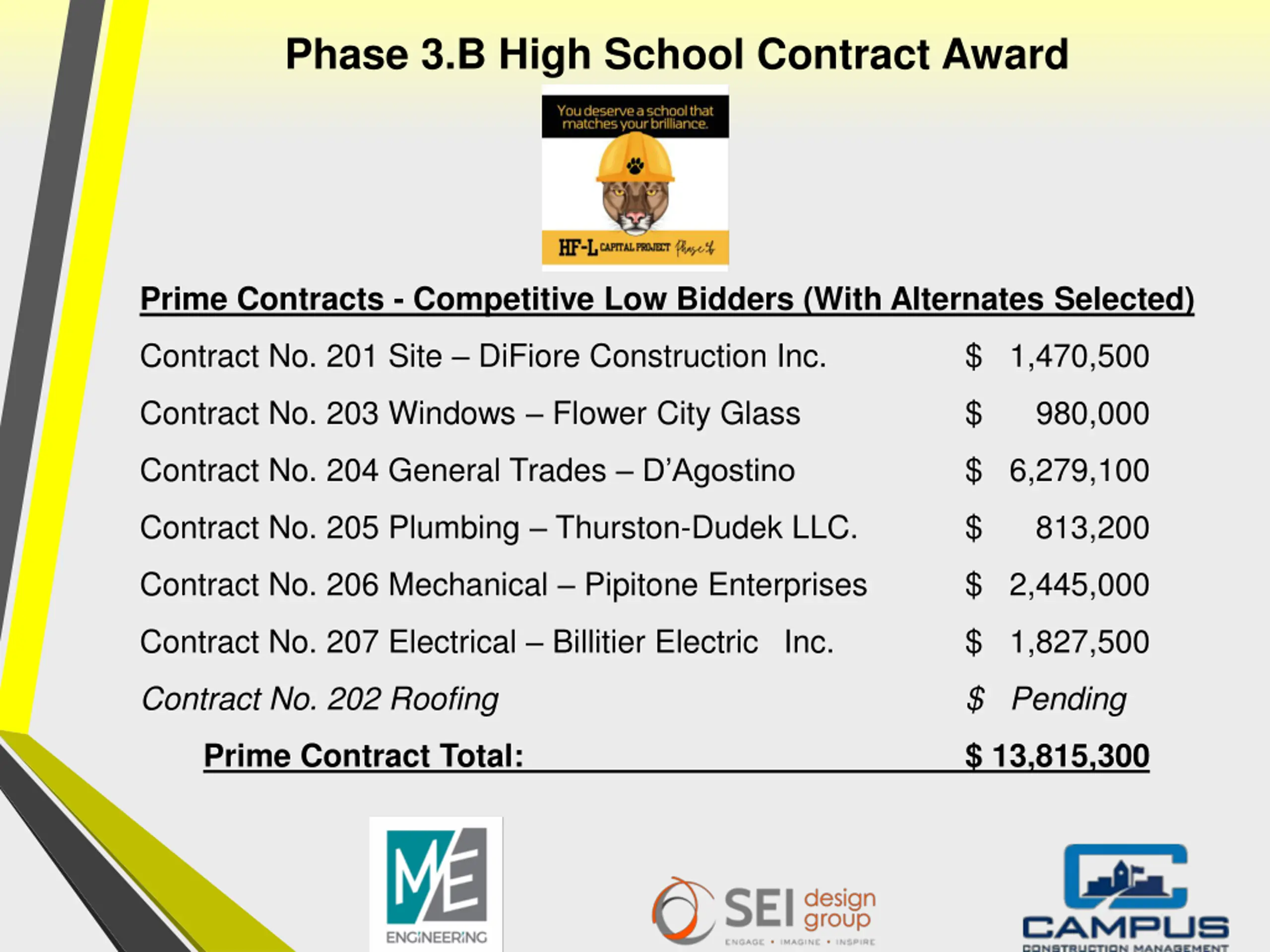

Phase 3.B High School Contract Award Prime Contracts - Competitive Low Bidders (With Alternates Selected) Contract No. 201 Site DiFiore Construction Inc. $ 1,470,500 Contract No. 203 Windows Flower City Glass $ 980,000 Contract No. 204 General Trades D Agostino $ 6,279,100 Contract No. 205 Plumbing Thurston-Dudek LLC. $ 813,200 Contract No. 206 Mechanical Pipitone Enterprises $ 2,445,000 Contract No. 207 Electrical Billitier Electric Inc. $ 1,827,500 Contract No. 202 Roofing $ Pending Prime Contract Total: $ 13,815,300

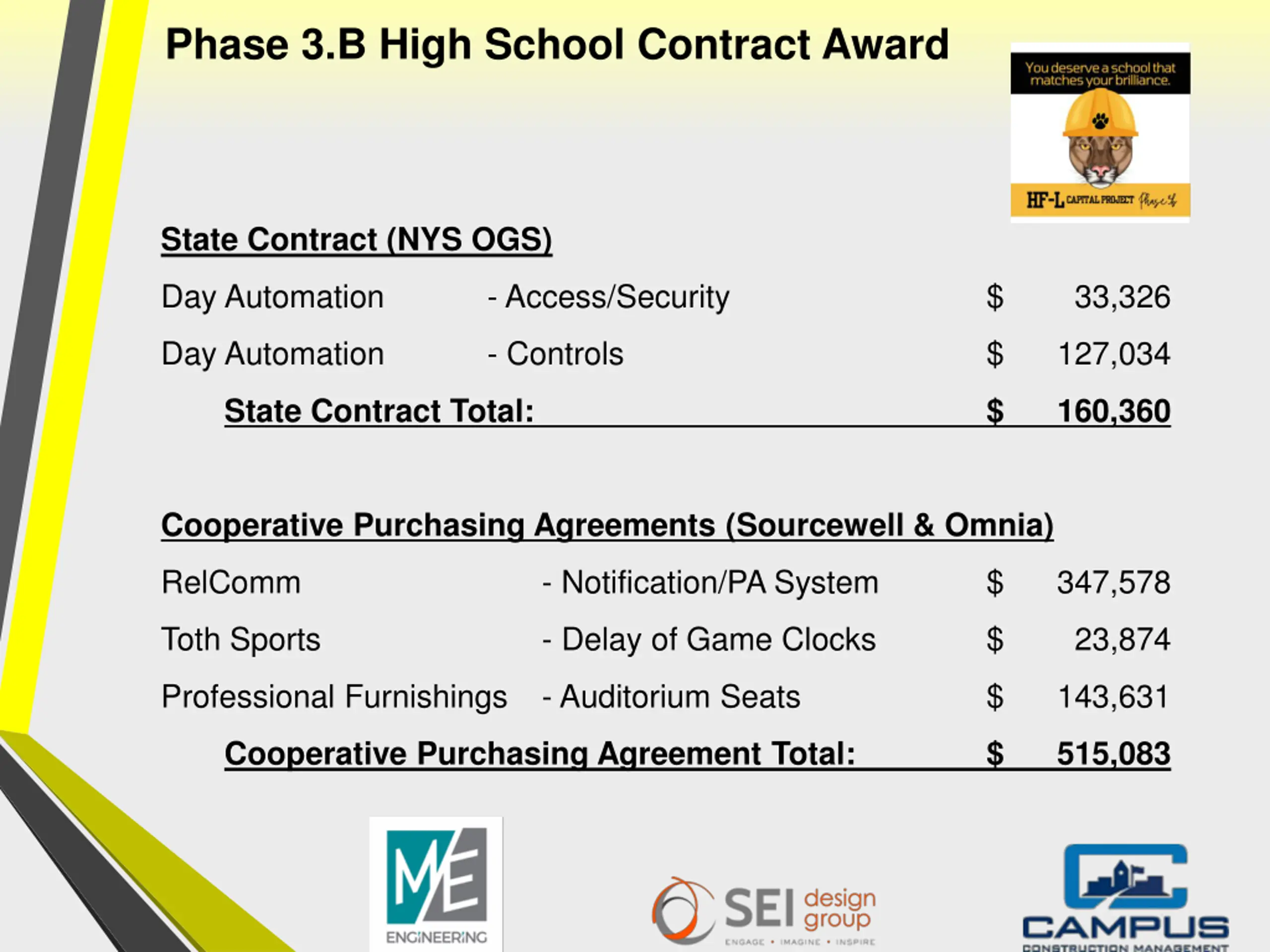

Phase 3.B High School Contract Award State Contract (NYS OGS) Day Automation - Access/Security $ 33,326 Day Automation - Controls $ 127,034 State Contract Total: $ 160,360 Cooperative Purchasing Agreements (Sourcewell & Omnia) RelComm - Notification/PA System $ 347,578 Toth Sports - Delay of Game Clocks $ 23,874 Professional Furnishings - Auditorium Seats $ 143,631 Cooperative Purchasing Agreement Total: $ 515,083

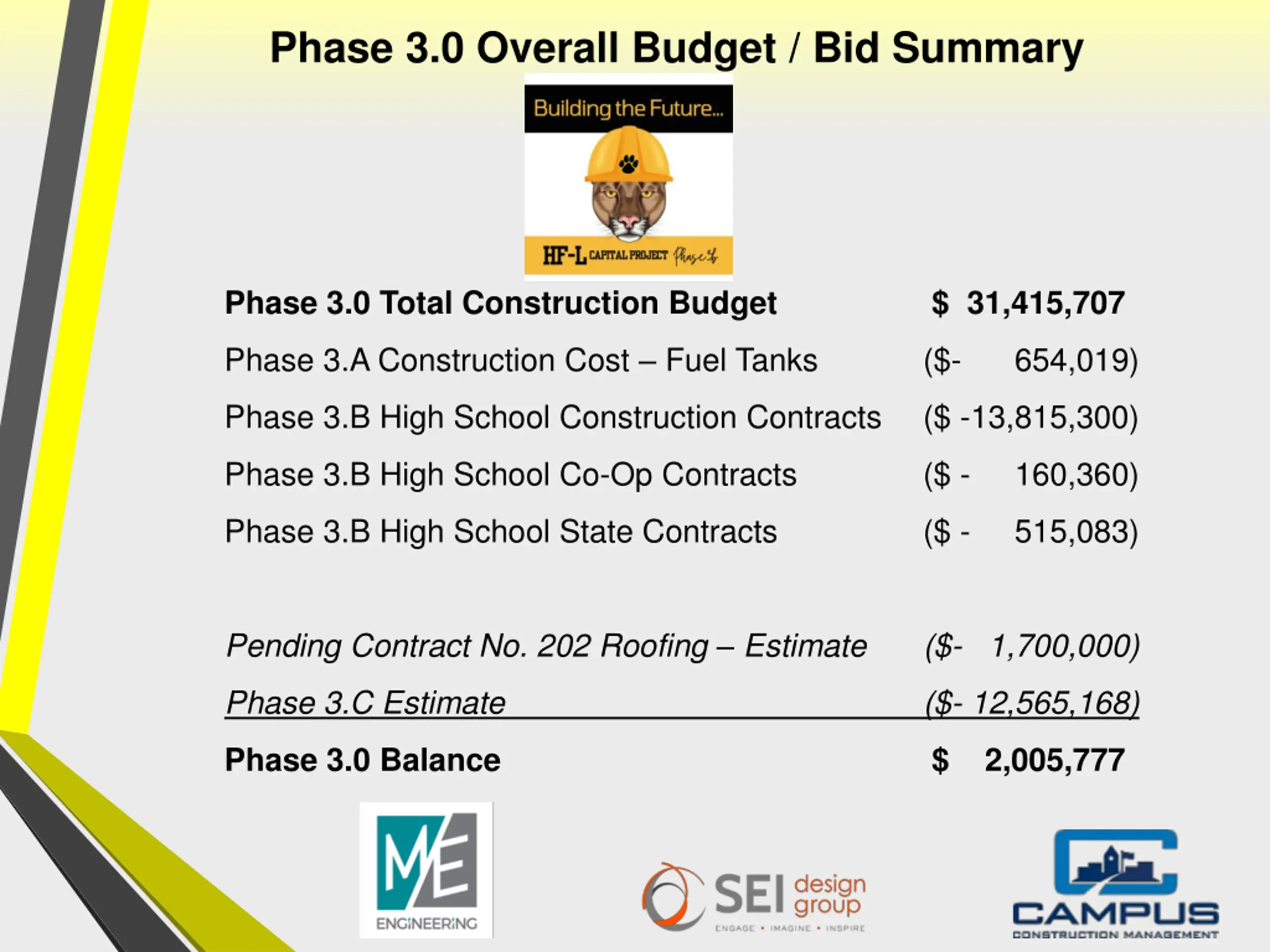

Phase 3.0 Overall Budget / Bid Summary Phase 3.0 Total Construction Budget $ 31,415,707 Phase 3.A Construction Cost Fuel Tanks ($- 654,019) Phase 3.B High School Construction Contracts ($ -13,815,300) Phase 3.B High School Co-Op Contracts ($ - 160,360) Phase 3.B High School State Contracts ($ - 515,083) Pending Contract No. 202 Roofing Estimate ($- 1,700,000) Phase 3.C Estimate ($- 12,565,168) $ 2,005,777 Phase 3.0 Balance

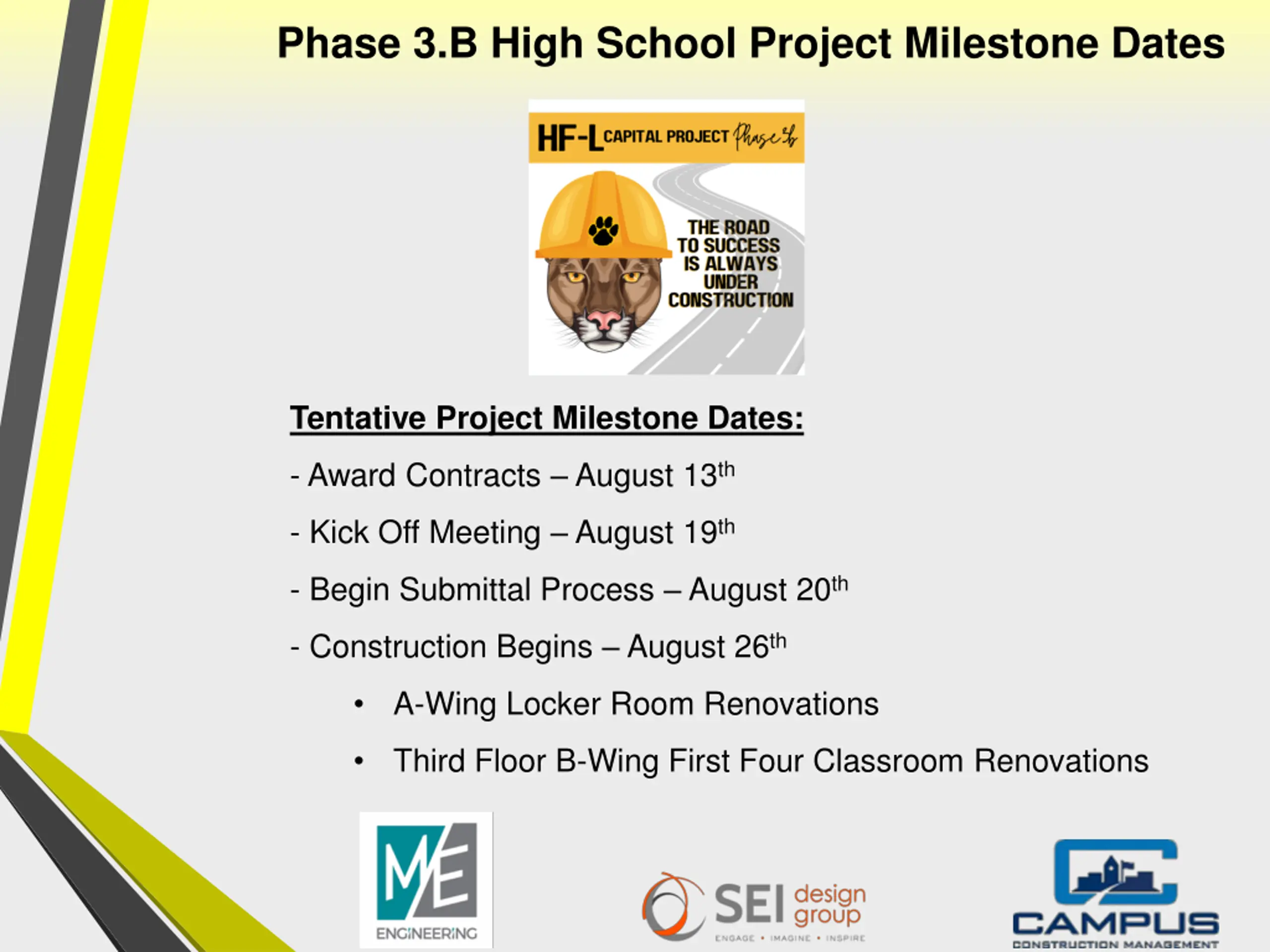

Phase 3.B High School Project Milestone Dates Tentative Project Milestone Dates: - Award Contracts August 13th - Kick Off Meeting August 19th - Begin Submittal Process August 20th - Construction Begins August 26th A-Wing Locker Room Renovations Third Floor B-Wing First Four Classroom Renovations

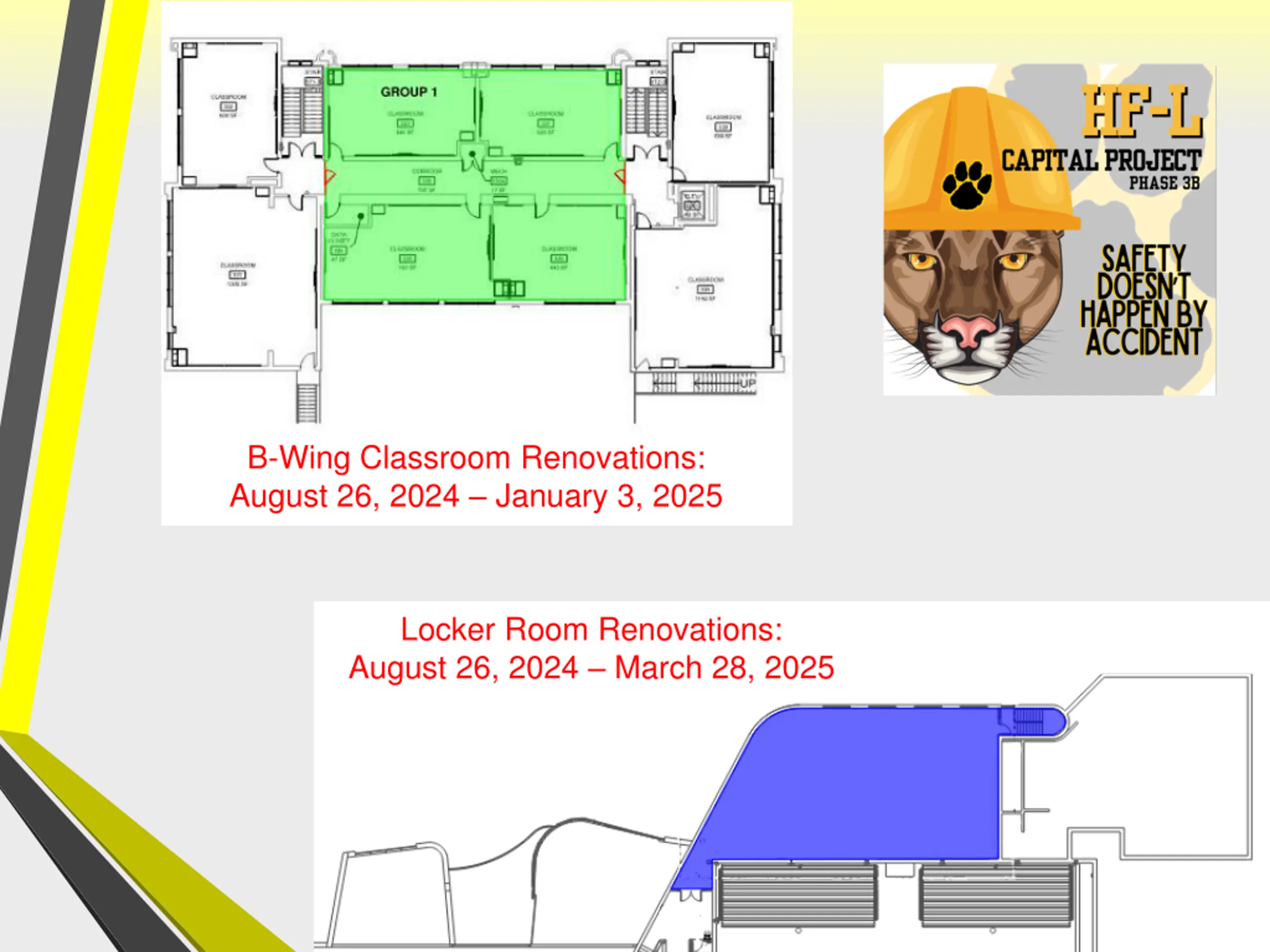

B-Wing Classroom Renovations: August 26, 2024 January 3, 2025 Locker Room Renovations: August 26, 2024 March 28, 2025
