Implementing the NPV Rule for Capital Budgeting Applications

capital budgeting applications n.w
1 / 25
Embed
Share

Explore the use of NPV rule in capital budgeting applications, with a focus on sensitivity, scenario, and breakeven analysis. Understand the concept of Internal Rate of Return (IRR) and its significance in evaluating project investments.

  • NPV Rule
  • Capital Budgeting
  • IRR
  • Sensitivity Analysis
  • Scenario Analysis

Uploaded on | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. Capital Budgeting Applications Implementing the NPV Rule

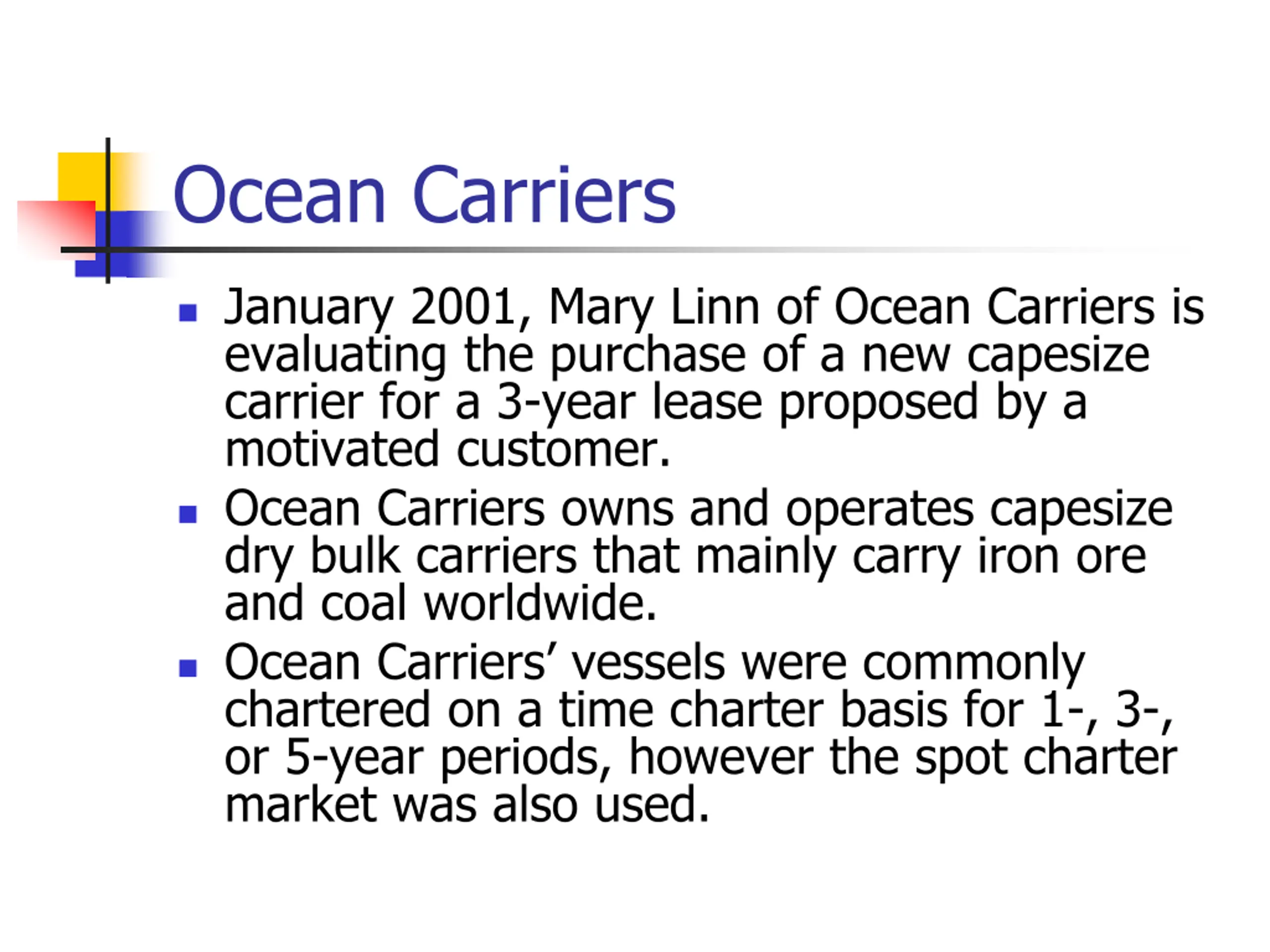

  2. Ocean Carriers January 2001, Mary Linn of Ocean Carriers is evaluating the purchase of a new capesize carrier for a 3-year lease proposed by a motivated customer. Ocean Carriers owns and operates capesize dry bulk carriers that mainly carry iron ore and coal worldwide. Ocean Carriers vessels were commonly chartered on a time charter basis for 1-, 3-, or 5-year periods, however the spot charter market was also used.

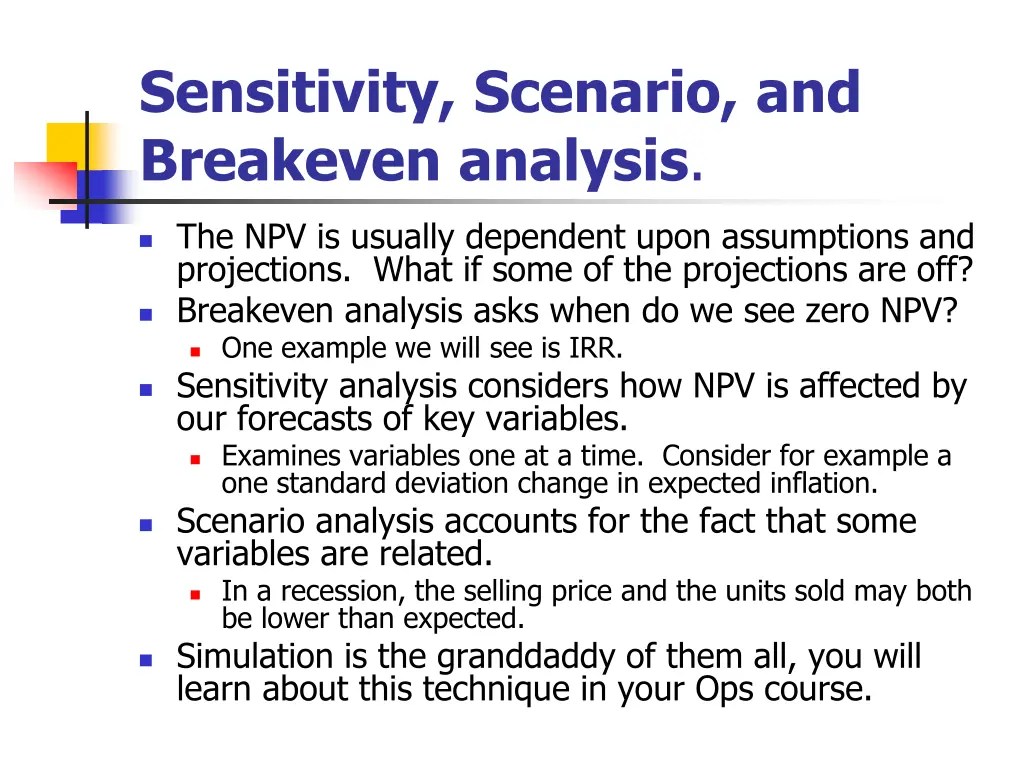

  3. Sensitivity, Scenario, and Breakeven analysis. The NPV is usually dependent upon assumptions and projections. What if some of the projections are off? Breakeven analysis asks when do we see zero NPV? One example we will see is IRR. Sensitivity analysis considers how NPV is affected by our forecasts of key variables. Examines variables one at a time. Consider for example a one standard deviation change in expected inflation. Scenario analysis accounts for the fact that some variables are related. In a recession, the selling price and the units sold may both be lower than expected. Simulation is the granddaddy of them all, you will learn about this technique in your Ops course.

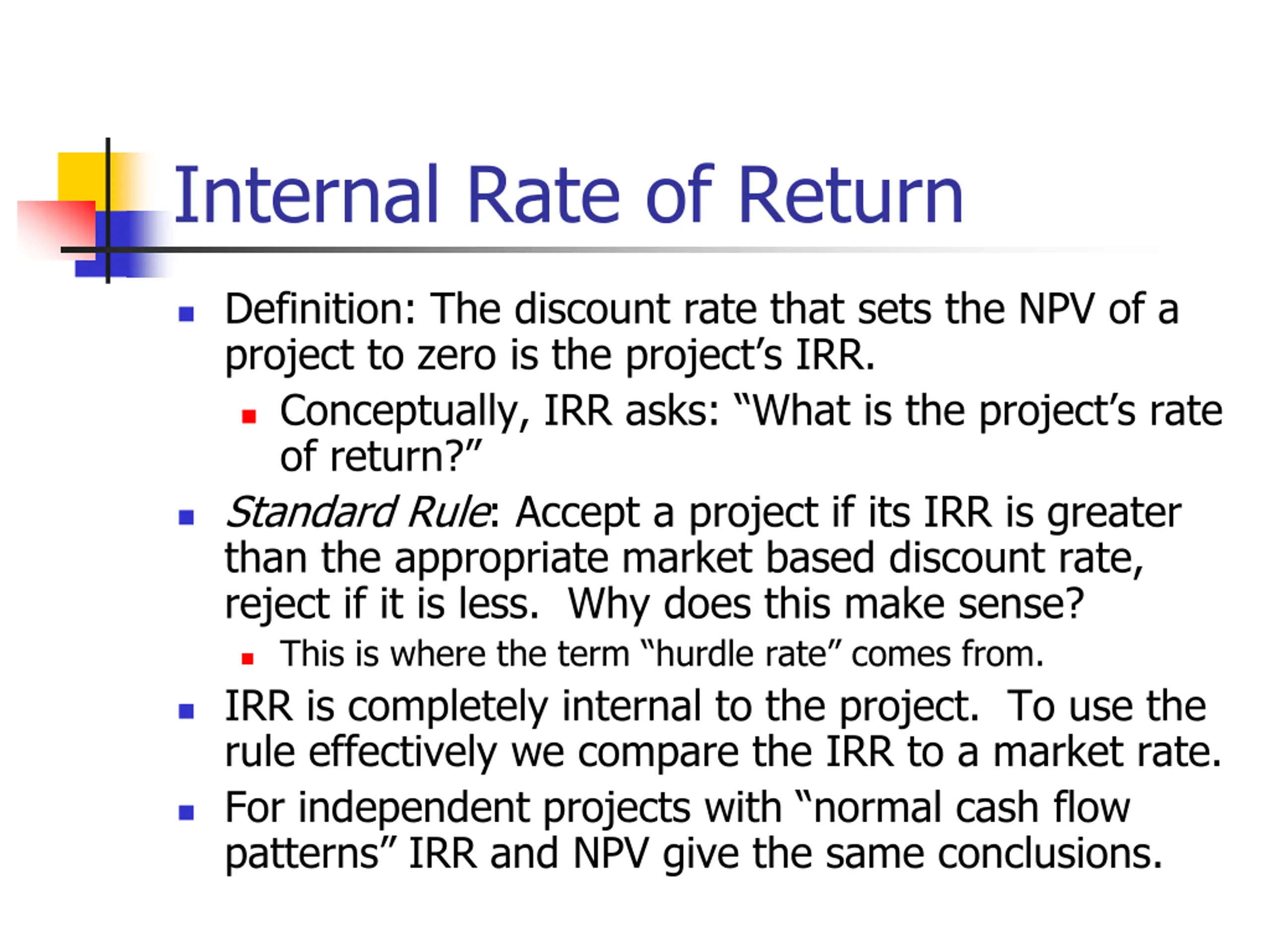

  4. Internal Rate of Return Definition: The discount rate that sets the NPV of a project to zero is the project s IRR. Conceptually, IRR asks: What is the project s rate of return? Standard Rule: Accept a project if its IRR is greater than the appropriate market based discount rate, reject if it is less. Why does this make sense? This is where the term hurdle rate comes from. IRR is completely internal to the project. To use the rule effectively we compare the IRR to a market rate. For independent projects with normal cash flow patterns IRR and NPV give the same conclusions.

  5. IRR Normal Cash Flow Pattern Consider the following stream of cash flows: 0 1 2 3 $400 $400 $400 -$1,000 Calculate the NPV at different discount rates until you find the discount rate where the NPV of this set of cash flows equals zero. That s all you do to find IRR.

  6. IRR NPV Profile Diagram Evaluate the NPV at various discount rates: 250 Rate NPV 0 10 20 200 150 $200 -$5.3 -$157.4 100 50 NPV 0 -50 0 10 20 -100 -150 -200 Discount Rate At r = 9.7%, NPV = 0

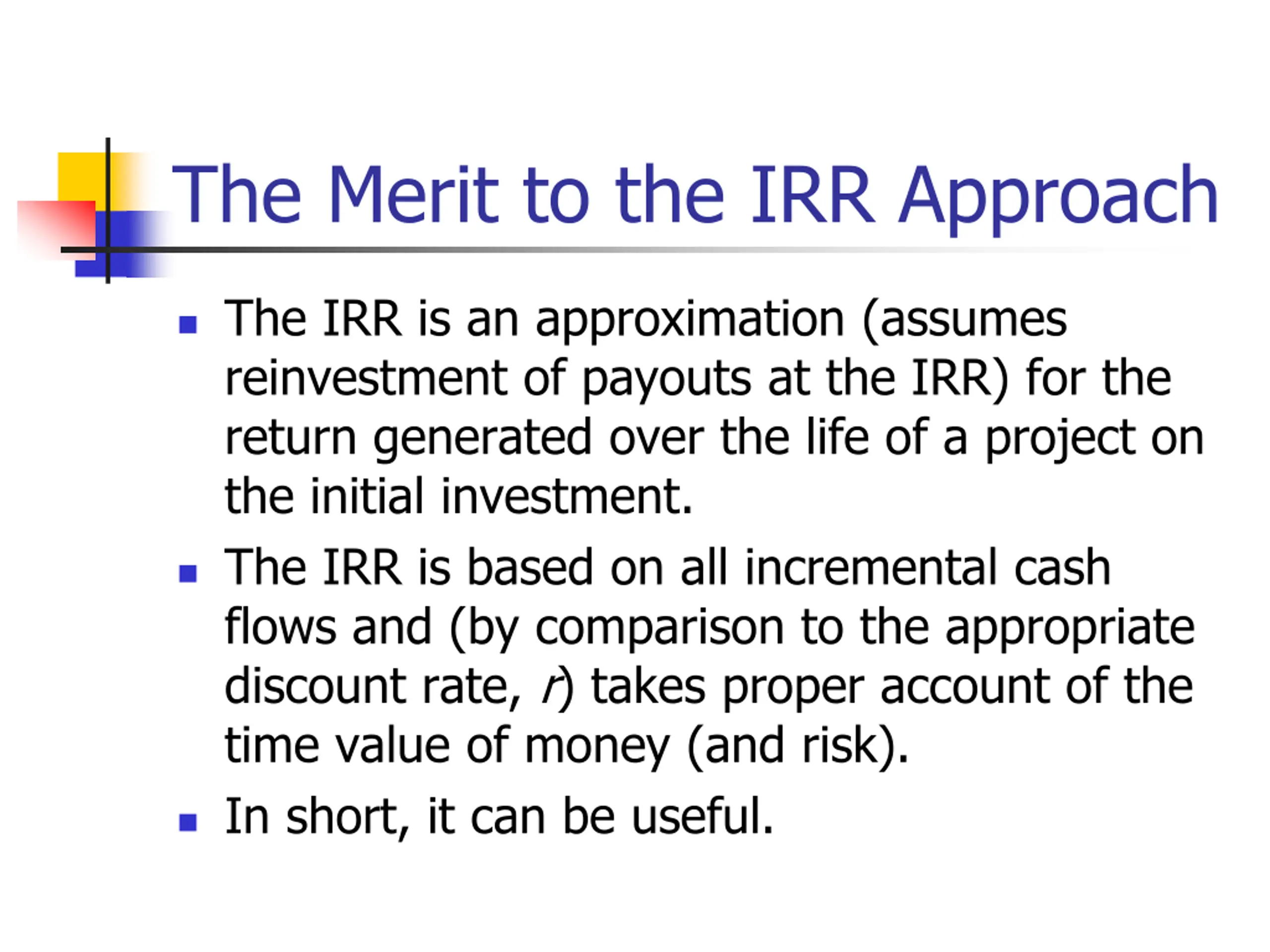

  7. The Merit to the IRR Approach The IRR is an approximation (assumes reinvestment of payouts at the IRR) for the return generated over the life of a project on the initial investment. The IRR is based on all incremental cash flows and (by comparison to the appropriate discount rate, r) takes proper account of the time value of money (and risk). In short, it can be useful.

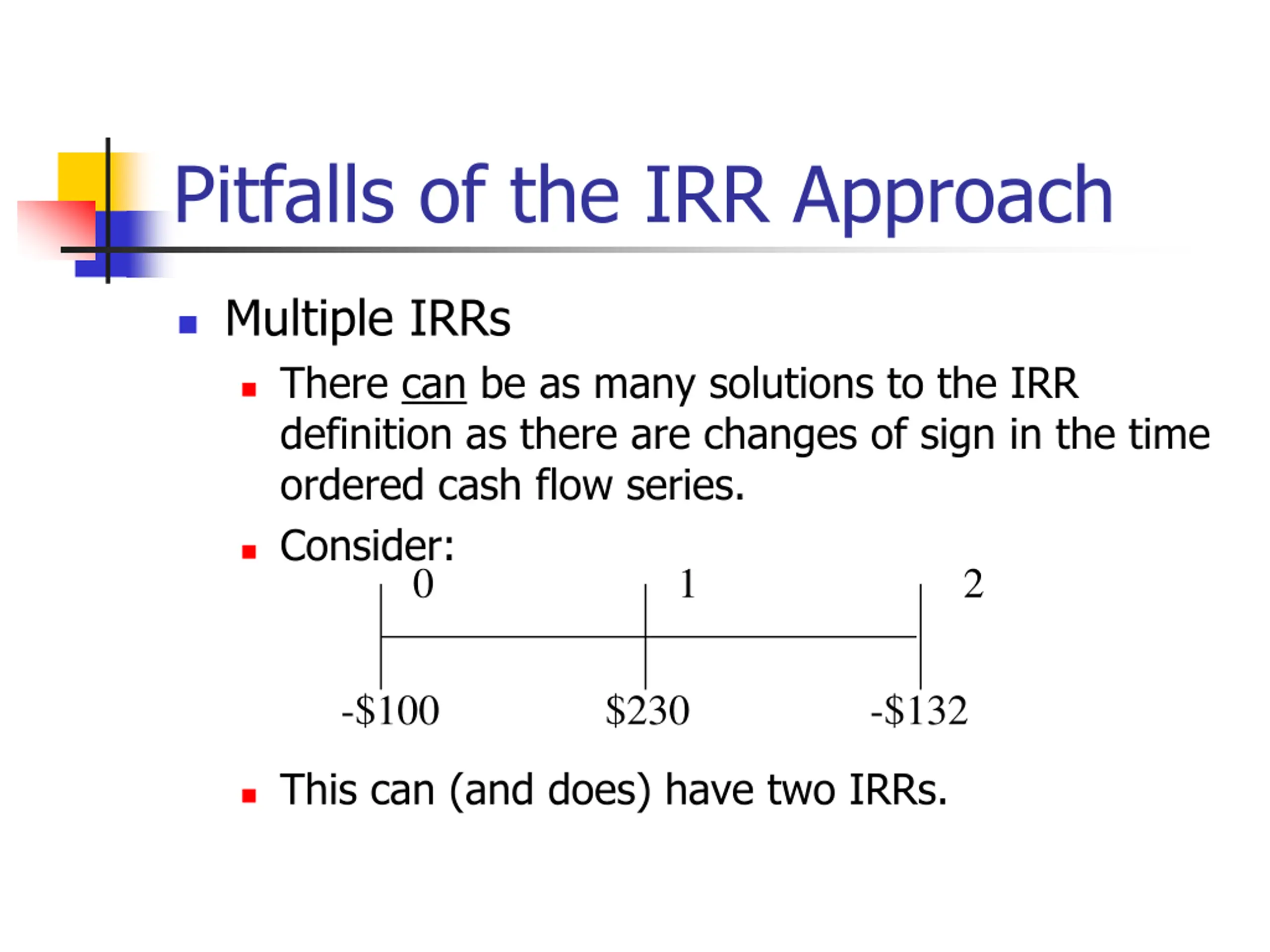

  8. Pitfalls of the IRR Approach Multiple IRRs There can be as many solutions to the IRR definition as there are changes of sign in the time ordered cash flow series. Consider: 0 1 2 -$100 $230 -$132 This can (and does) have two IRRs.

  9. Pitfalls of IRR cont Disc.Rate 0.00% 10.00% 15.00% 20.00% 40.00% NPV -$2.00 $0.00 IRR1 $0.19 $0.00 IRR2 -$3.06 0.5 0 0 10 15 20 40 -0.5 -1 NPV -1.5 -2 -2.5 -3 Discount Rate

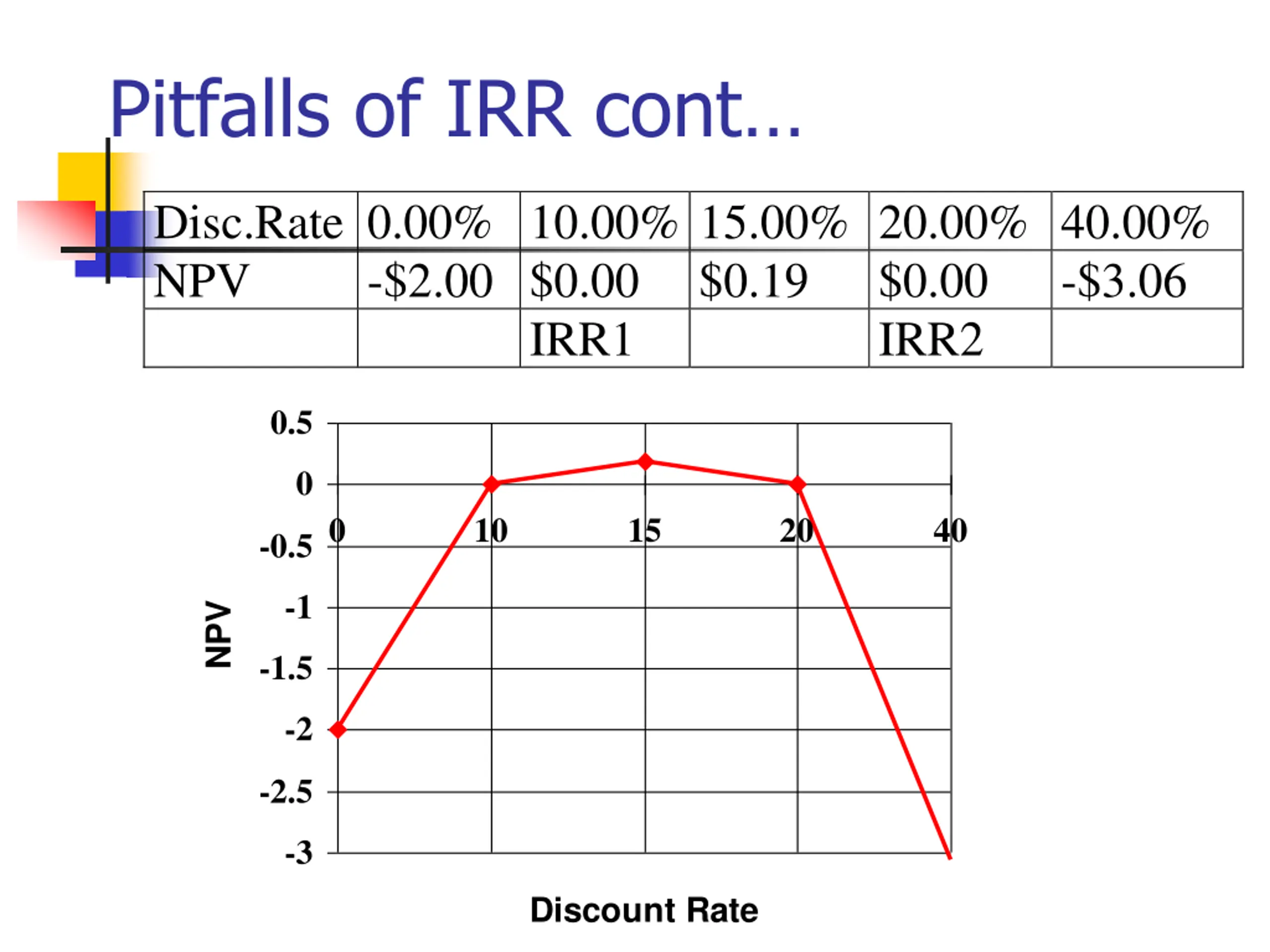

  10. Pitfalls of IRR cont 3 2.5 2 1.5 NPV 1 0.5 0 0 10 15 20 40 -0.5 Discount Rate

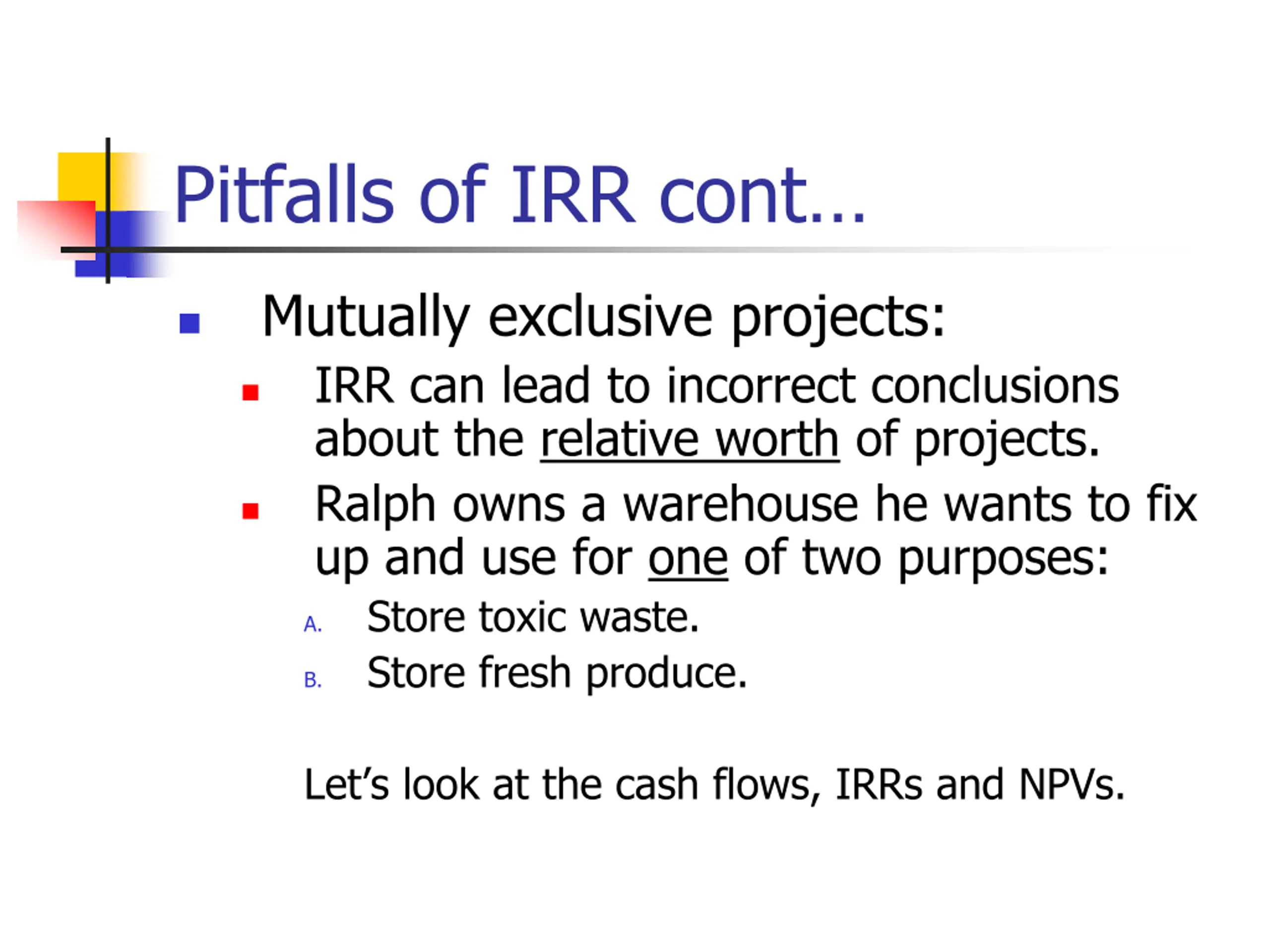

  11. Pitfalls of IRR cont Mutually exclusive projects: IRR can lead to incorrect conclusions about the relative worth of projects. Ralph owns a warehouse he wants to fix up and use for one of two purposes: Store toxic waste. Store fresh produce. A. B. Let s look at the cash flows, IRRs and NPVs.

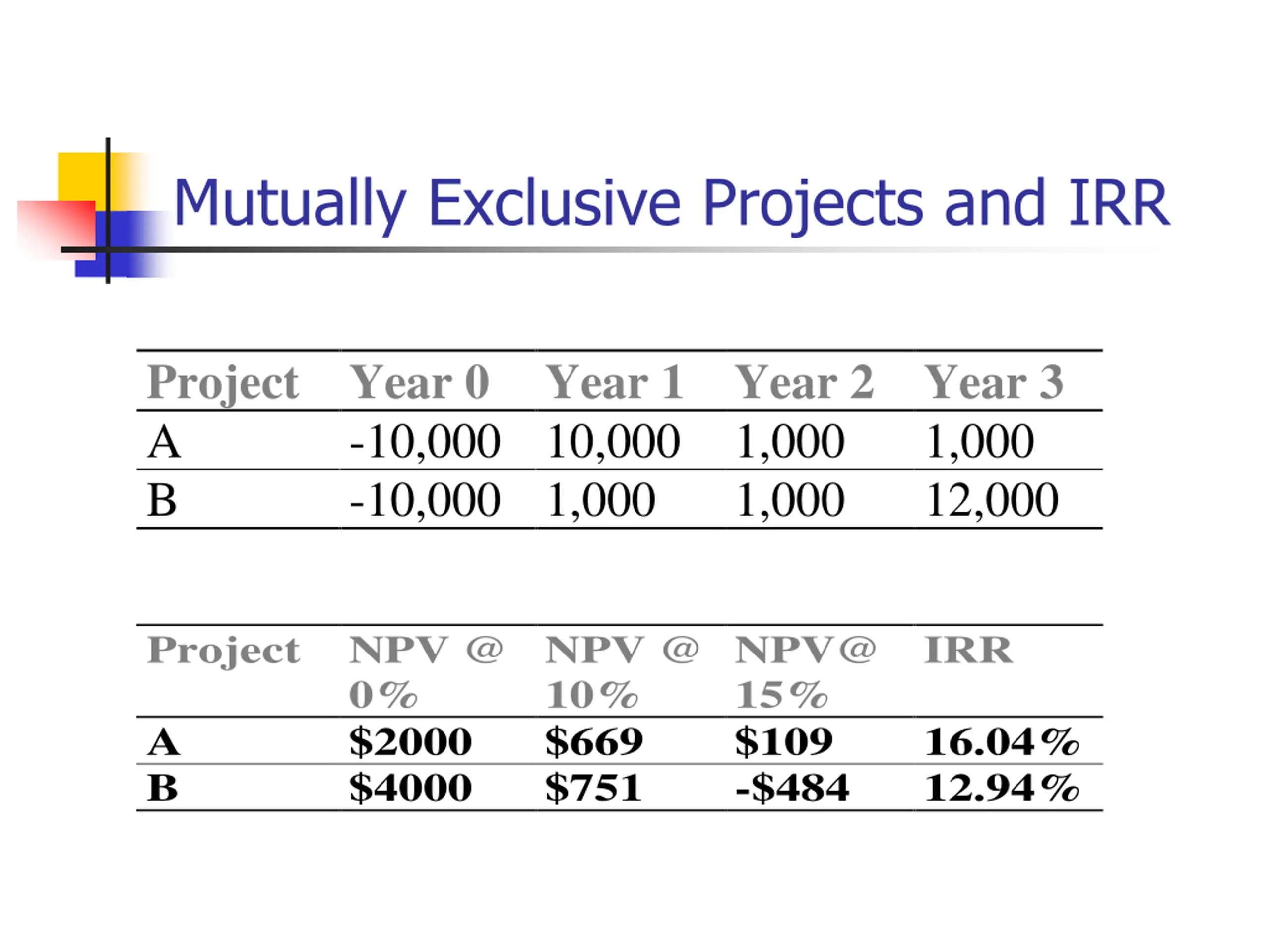

  12. Mutually Exclusive Projects and IRR Project A B Year 0 -10,000 10,000 -10,000 1,000 Year 1 Year 2 1,000 1,000 Year 3 1,000 12,000 Project NPV @ 0% $2000 $4000 NPV @ 10% $669 $751 NPV@ 15% $109 -$484 IRR A B 16.04% 12.94%

  13. 5000 A B 4000 3000 NPV 2000 1000 0 0% 10% 15% -1000 Discount Rate At low discount rates, B is better. At high discount rates, A is better. But A always has the higher IRR. A common mistake to make is choose A regardless of the discount rate. Simply choosing the project with the larger IRR would be justified only if the projects intermediate cash flows could be reinvested at the IRR instead of the actual market rate, r, for the life of the project.

  14. Project Scale and the IRR Because the IRR puts things in terms of a rate it may not tell you what really interests you; which investment will create the most wealth . Example: Project A B Investment -$1,000 -$10,000 Time 1 +$1,500 +$13,000 IRR 50% 30% NPV at 10% $363.64 $1,1818.18

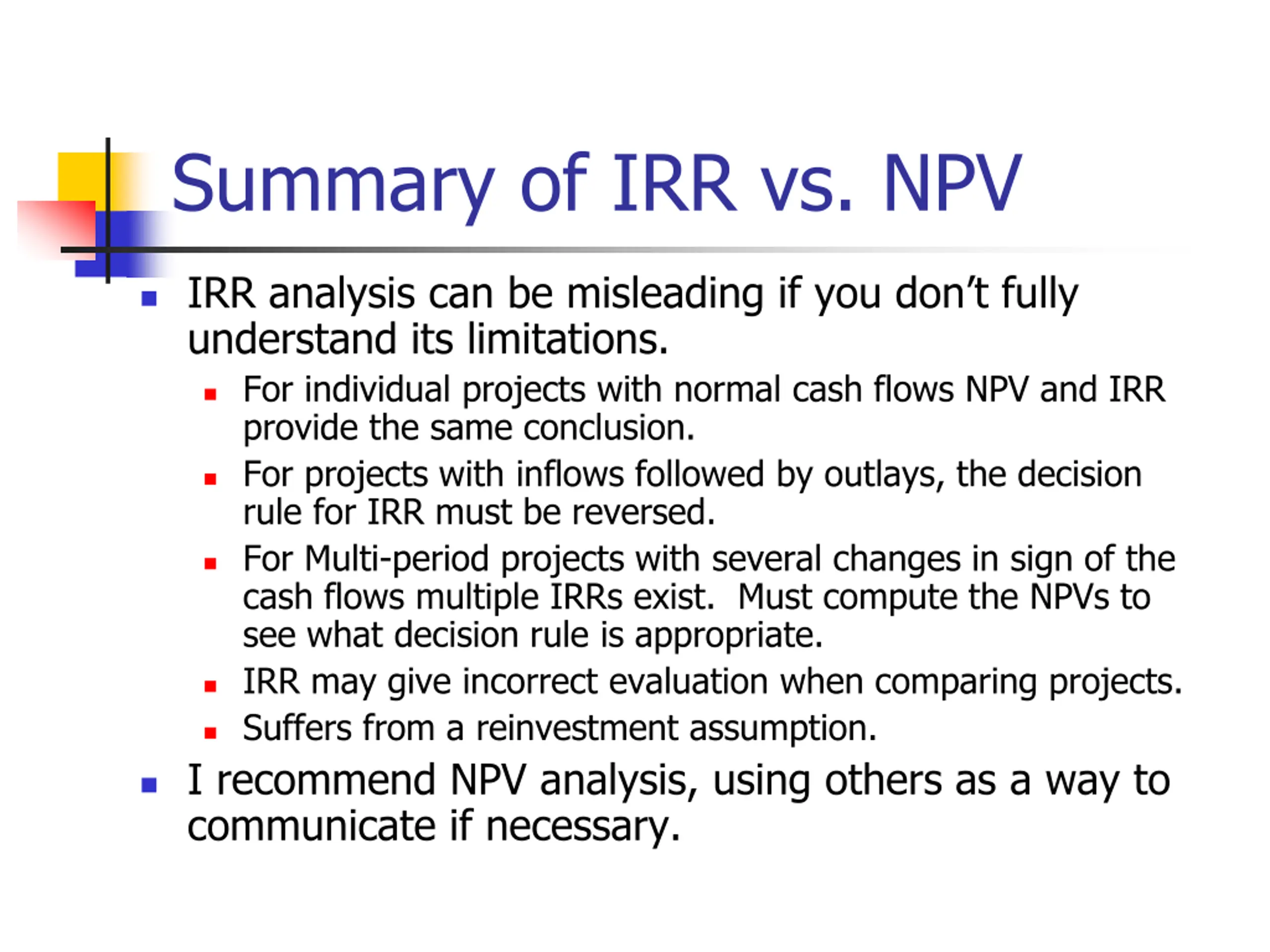

  15. Summary of IRR vs. NPV IRR analysis can be misleading if you don t fully understand its limitations. For individual projects with normal cash flows NPV and IRR provide the same conclusion. For projects with inflows followed by outlays, the decision rule for IRR must be reversed. For Multi-period projects with several changes in sign of the cash flows multiple IRRs exist. Must compute the NPVs to see what decision rule is appropriate. IRR may give incorrect evaluation when comparing projects. Suffers from a reinvestment assumption. I recommend NPV analysis, using others as a way to communicate if necessary.

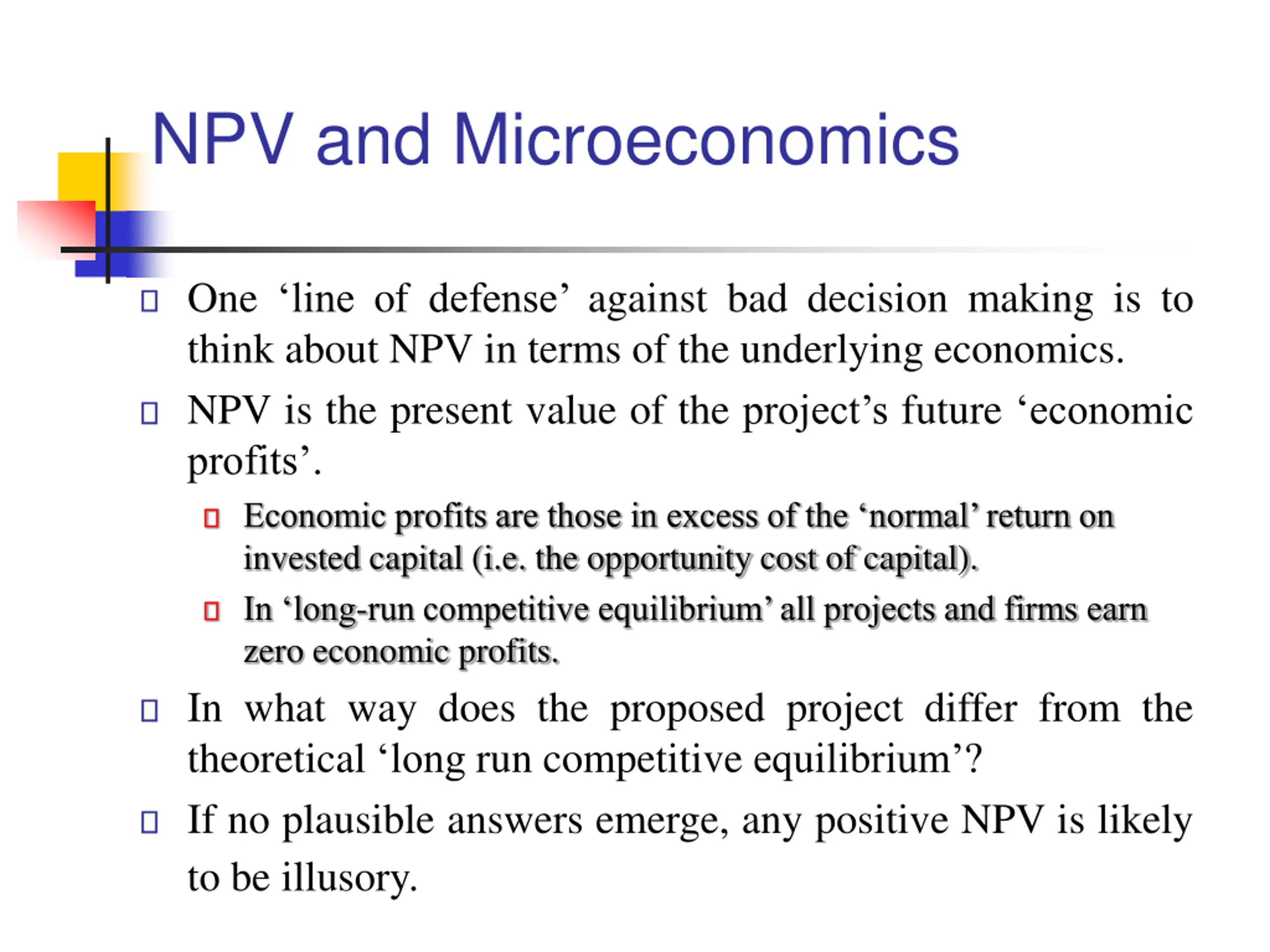

  16. NPV and Microeconomics One line of defense against bad decision making is to think about NPV in terms of the underlying economics. NPV is the present value of the project s future economic profits . Economic profits are those in excess of the normal return on invested capital (i.e. the opportunity cost of capital). In long-run competitive equilibrium all projects and firms earn zero economic profits. In what way does the proposed project differ from the theoretical long run competitive equilibrium ? If no plausible answers emerge, any positive NPV is likely to be illusory.

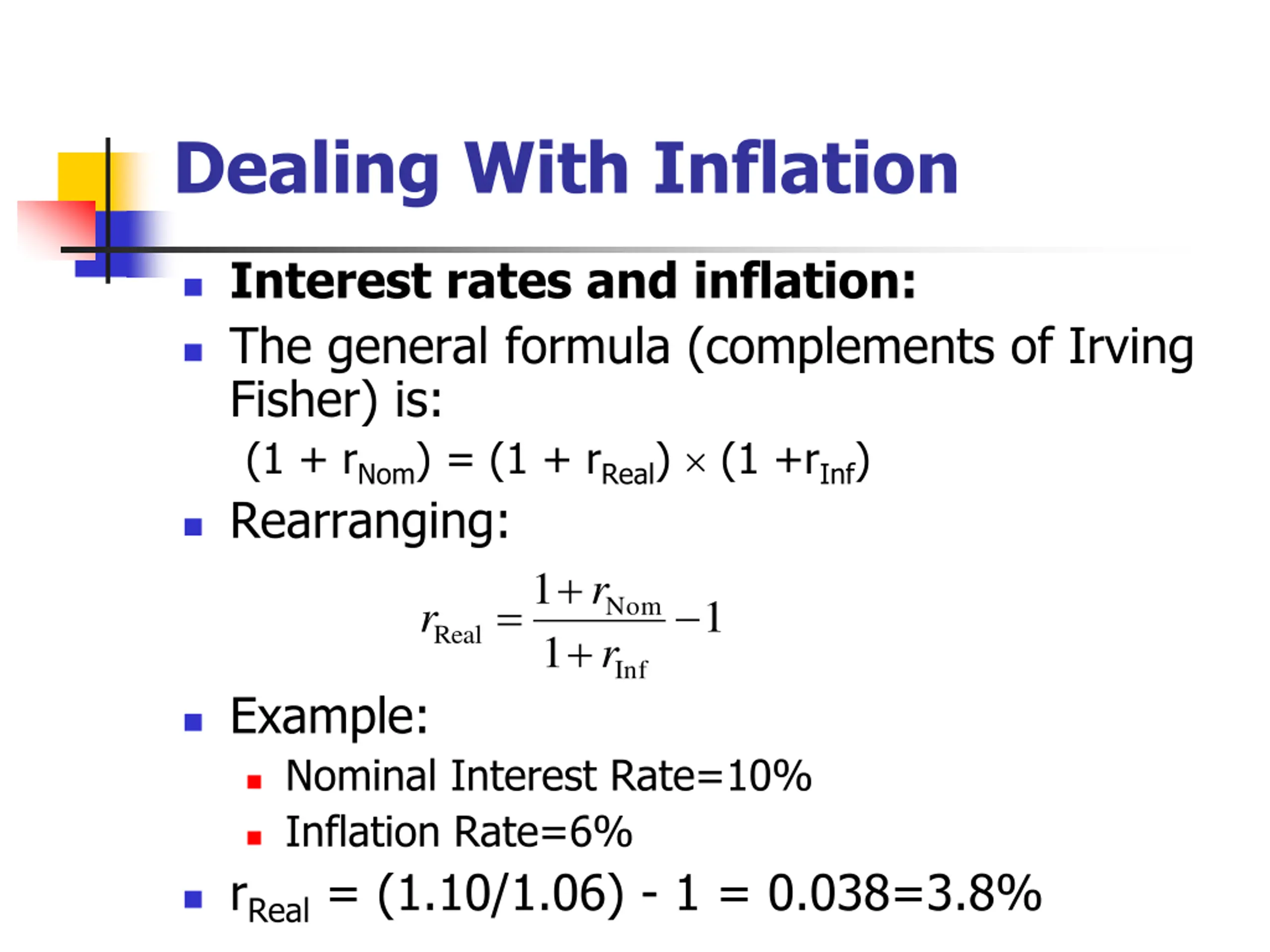

  17. Dealing With Inflation Interest rates and inflation: The general formula (complements of Irving Fisher) is: (1 + rNom) = (1 + rReal) (1 +rInf) Rearranging: 1 Nom Real + r + r = 1 r 1 Inf Example: Nominal Interest Rate=10% Inflation Rate=6% rReal = (1.10/1.06) - 1 = 0.038=3.8%

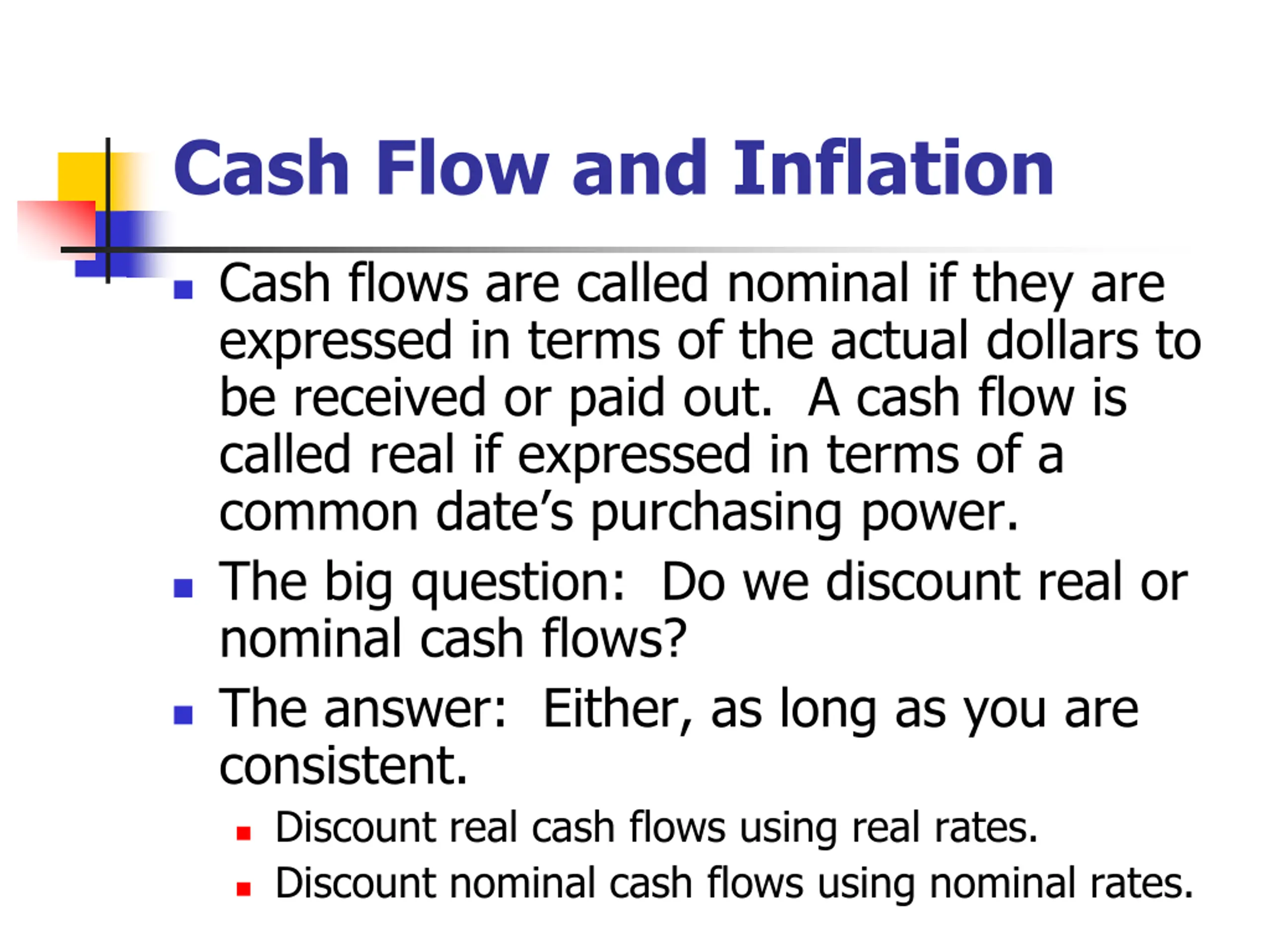

  18. Cash Flow and Inflation Cash flows are called nominal if they are expressed in terms of the actual dollars to be received or paid out. A cash flow is called real if expressed in terms of a common date s purchasing power. The big question: Do we discount real or nominal cash flows? The answer: Either, as long as you are consistent. Discount real cash flows using real rates. Discount nominal cash flows using nominal rates.

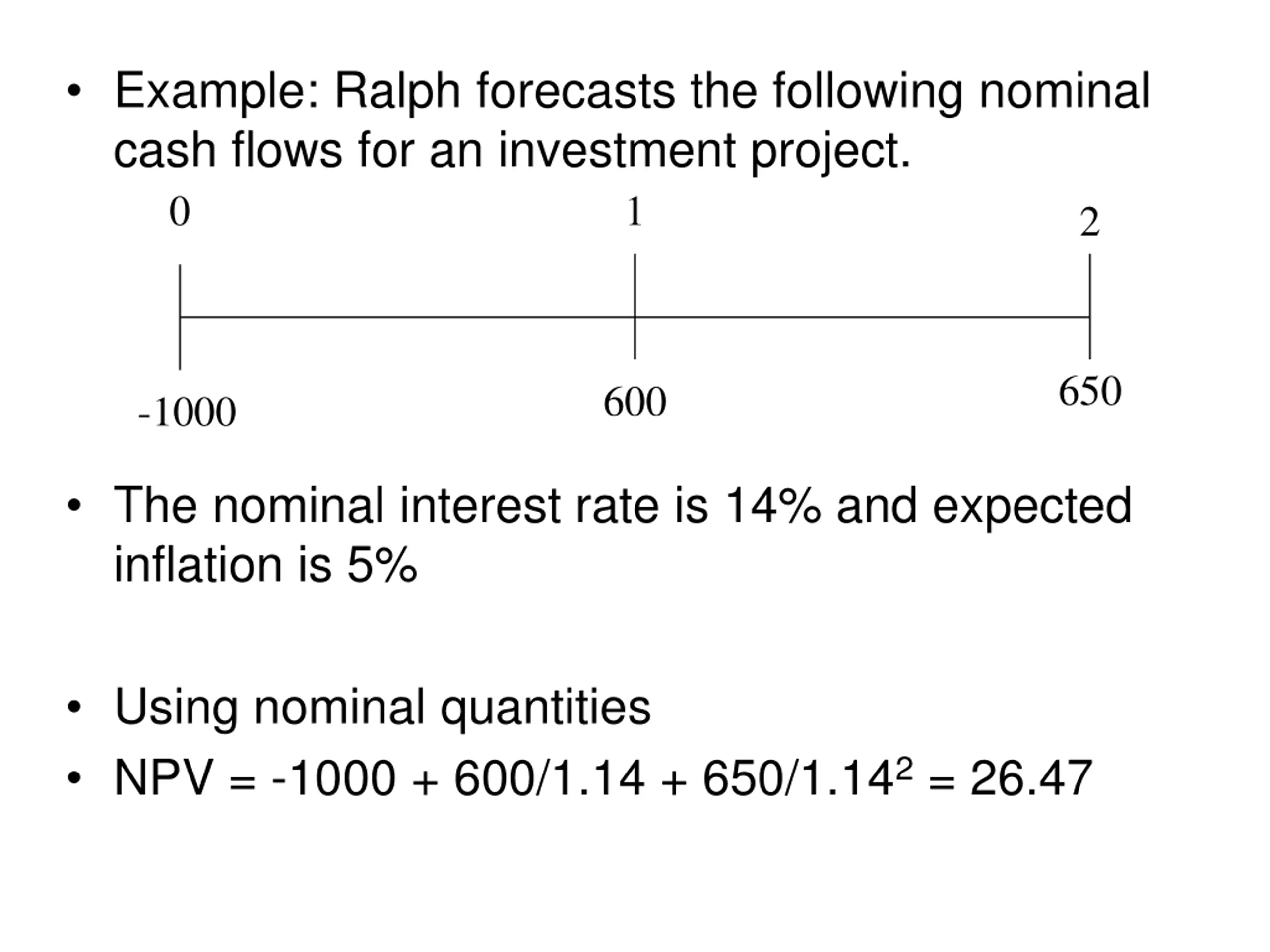

  19. Example: Ralph forecasts the following nominal cash flows for an investment project. 0 1 2 650 600 -1000 The nominal interest rate is 14% and expected inflation is 5% Using nominal quantities NPV = -1000 + 600/1.14 + 650/1.142 = 26.47

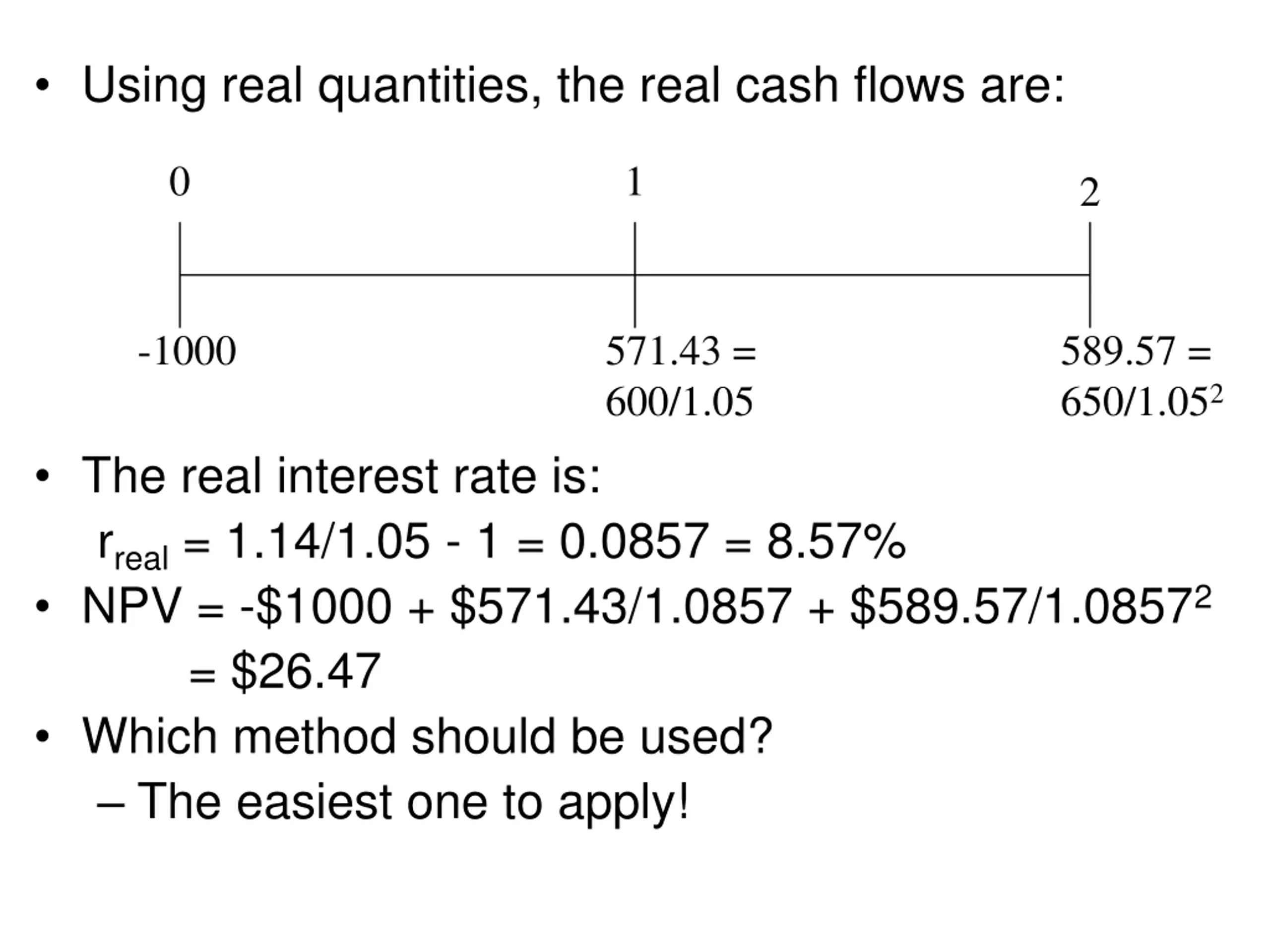

  20. Using real quantities, the real cash flows are: 0 1 2 -1000 571.43 = 600/1.05 589.57 = 650/1.052 The real interest rate is: rreal = 1.14/1.05 - 1 = 0.0857 = 8.57% NPV = -$1000 + $571.43/1.0857 + $589.57/1.08572 = $26.47 Which method should be used? The easiest one to apply!

  21. Brief Introduction to Real Options Is it useful to consider the option to defer making an investment? Project A will generate risk free cash flows of $10,000 per year forever. The risk free rate is 10% per year. Project A will take an immediate investment of $110,000 to launch. NPV = 10,000/(.10) - 110,000 = 100,000 - 110,000 = -$10,000 Someone offers you $1 for the rights to this project. Do you take it? Hint: Do gold mines that are not currently operated have a zero market value?

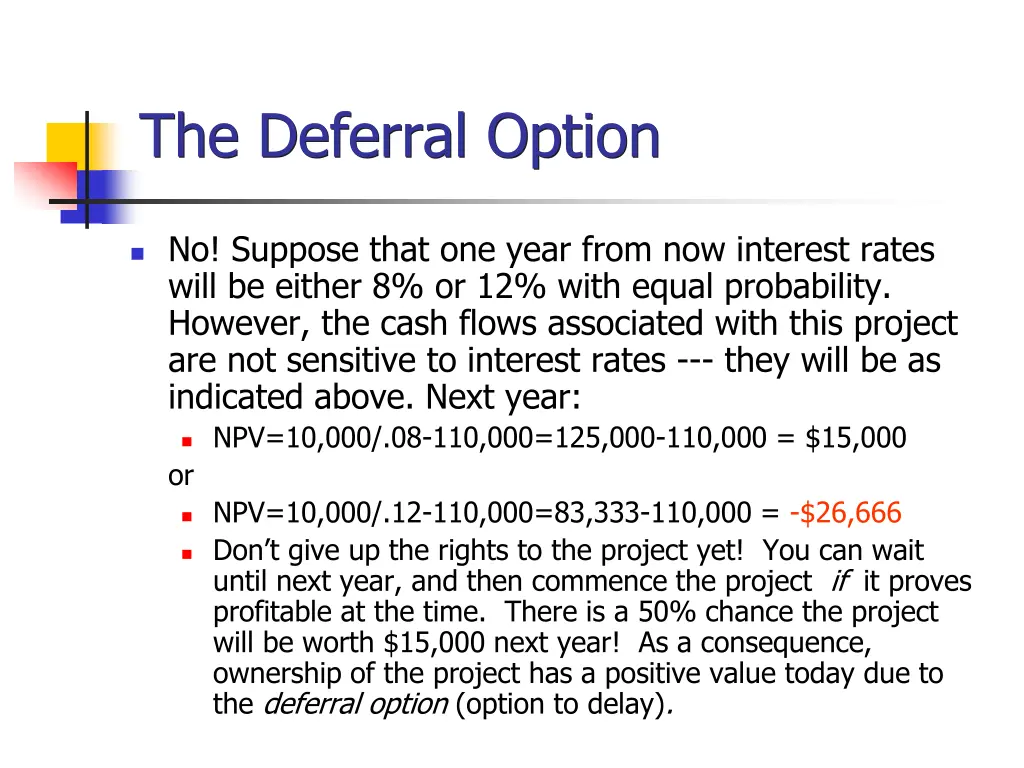

  22. The Deferral Option No! Suppose that one year from now interest rates will be either 8% or 12% with equal probability. However, the cash flows associated with this project are not sensitive to interest rates --- they will be as indicated above. Next year: NPV=10,000/.08-110,000=125,000-110,000 = $15,000 or NPV=10,000/.12-110,000=83,333-110,000 = -$26,666 Don t give up the rights to the project yet! You can wait until next year, and then commence the project if it proves profitable at the time. There is a 50% chance the project will be worth $15,000 next year! As a consequence, ownership of the project has a positive value today due to the deferral option (option to delay).

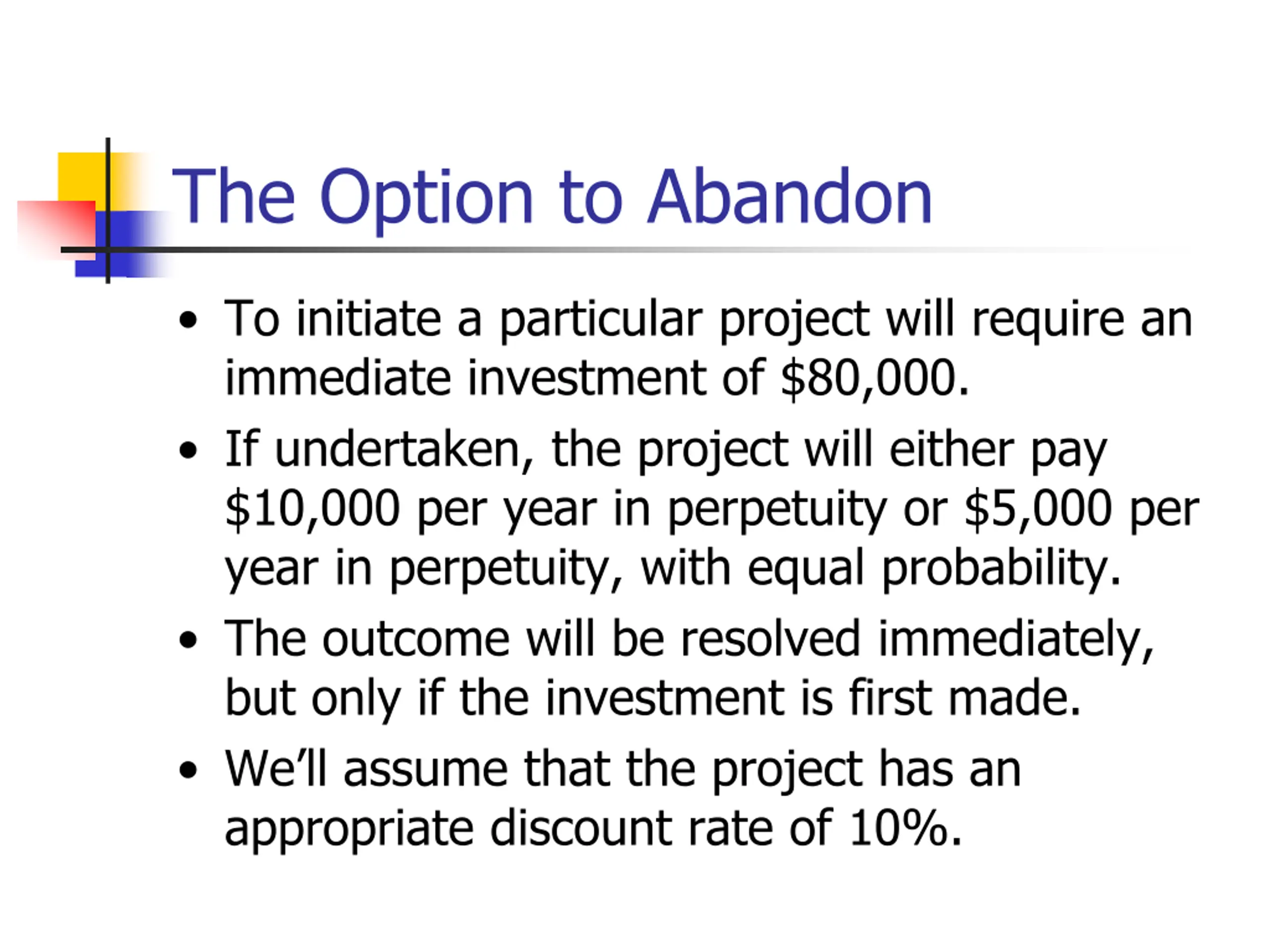

  23. The Option to Abandon To initiate a particular project will require an immediate investment of $80,000. If undertaken, the project will either pay $10,000 per year in perpetuity or $5,000 per year in perpetuity, with equal probability. The outcome will be resolved immediately, but only if the investment is first made. We ll assume that the project has an appropriate discount rate of 10%.

  24. The Option to Abandon NPV = -80,000 + [.5(10,000)/.10 + = -80,000 + [.5(100,000) + .5(50,000)] = -80,000 + [75,000] = - $5,000 .5(5,000)/.10] Suppose that the assets purchased to initiate this project have a liquidation value of $70,000 (i.e. you can sell them for use elsewhere after they are purchased). Then, the payoff to making the 80,000 initial investment is the maximum of the value from operating the project or $70,000. So

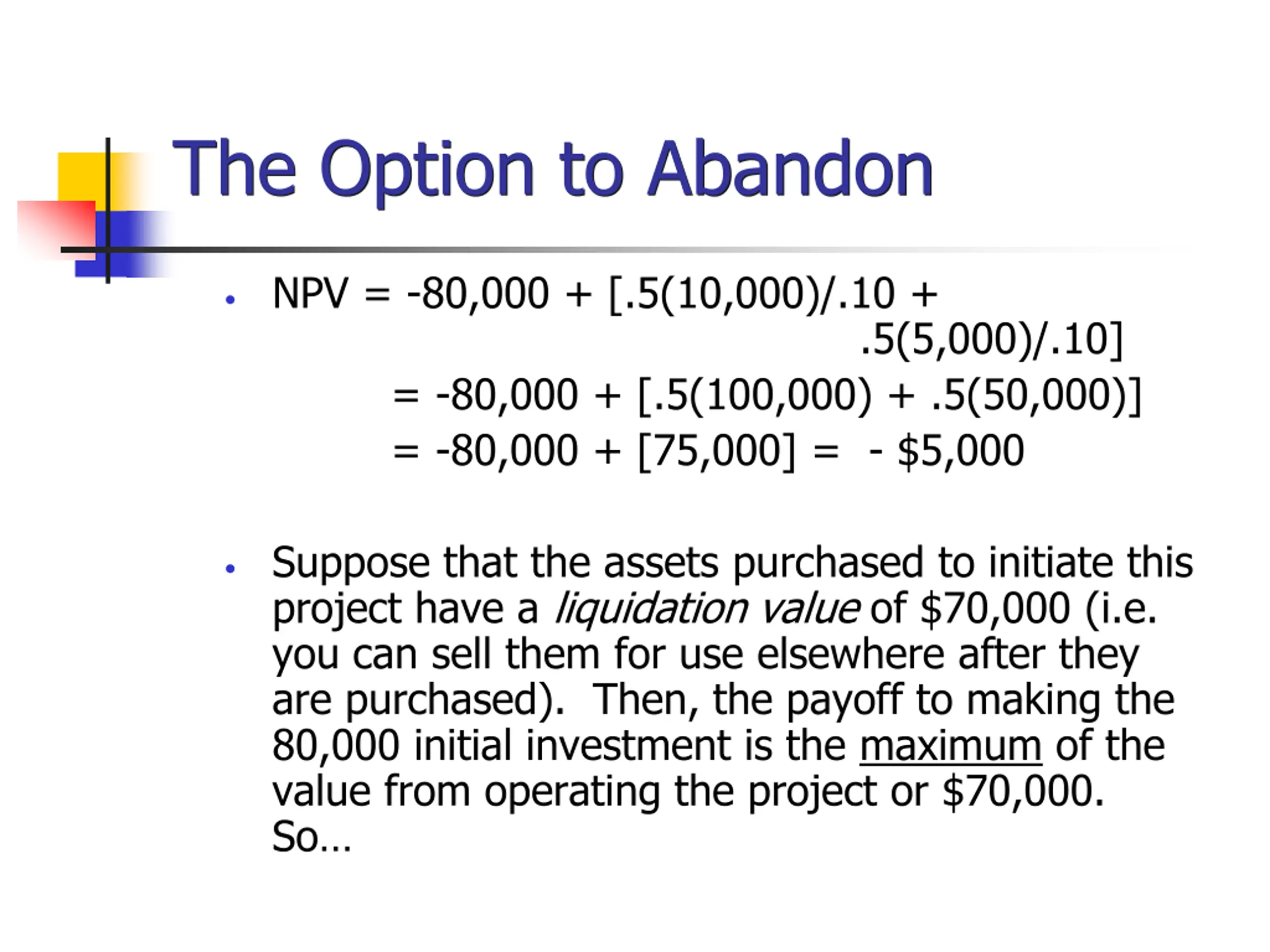

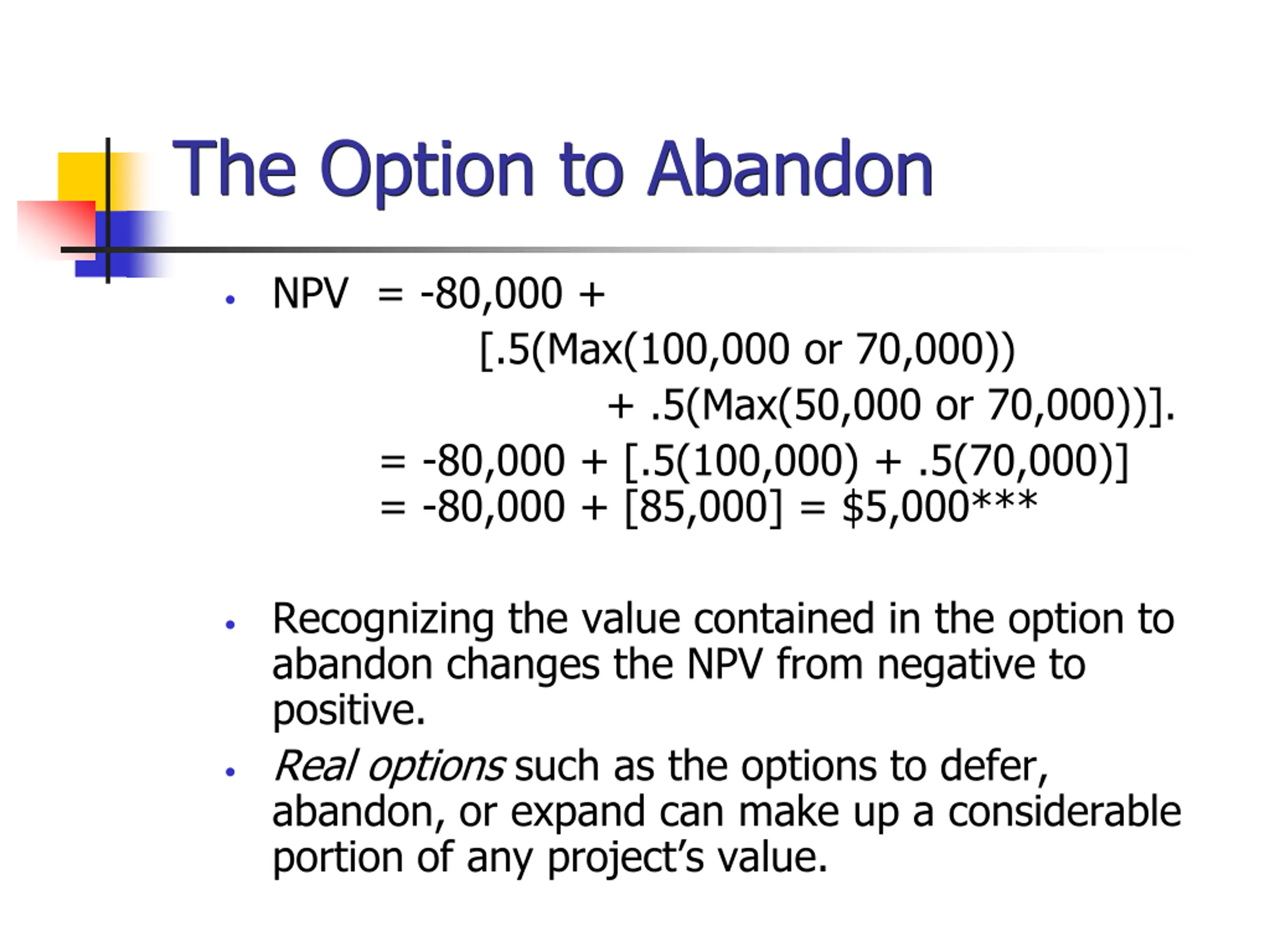

  25. The Option to Abandon NPV = -80,000 + = -80,000 + [.5(100,000) + .5(70,000)] = -80,000 + [85,000] = $5,000*** [.5(Max(100,000 or 70,000)) + .5(Max(50,000 or 70,000))]. Recognizing the value contained in the option to abandon changes the NPV from negative to positive. Real options such as the options to defer, abandon, or expand can make up a considerable portion of any project s value.
