Installation Progress at Thomas Jefferson National Accelerator Facility

jlab hall b hps installation july and august 2021 n.w
1 / 8
Embed
Share

Follow the installation progress at Thomas Jefferson National Accelerator Facility from July to August 2021, including tasks such as testing power supplies, removing equipment, installing cables, and aligning detectors.

  • Installation
  • Progress
  • Accelerator
  • Facility
  • Jefferson

Uploaded on | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

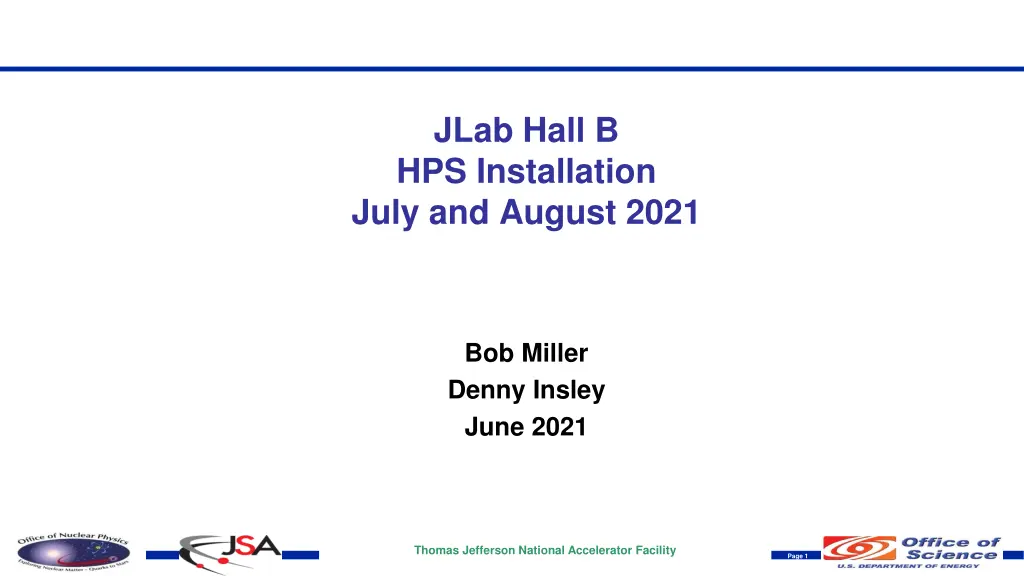

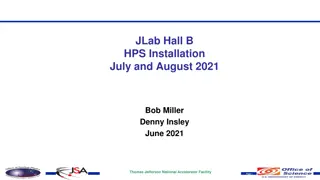

  1. JLab Hall B HPS Installation July and August 2021 Bob Miller Denny Insley June 2021 Thomas Jefferson National Accelerator Facility Page 1

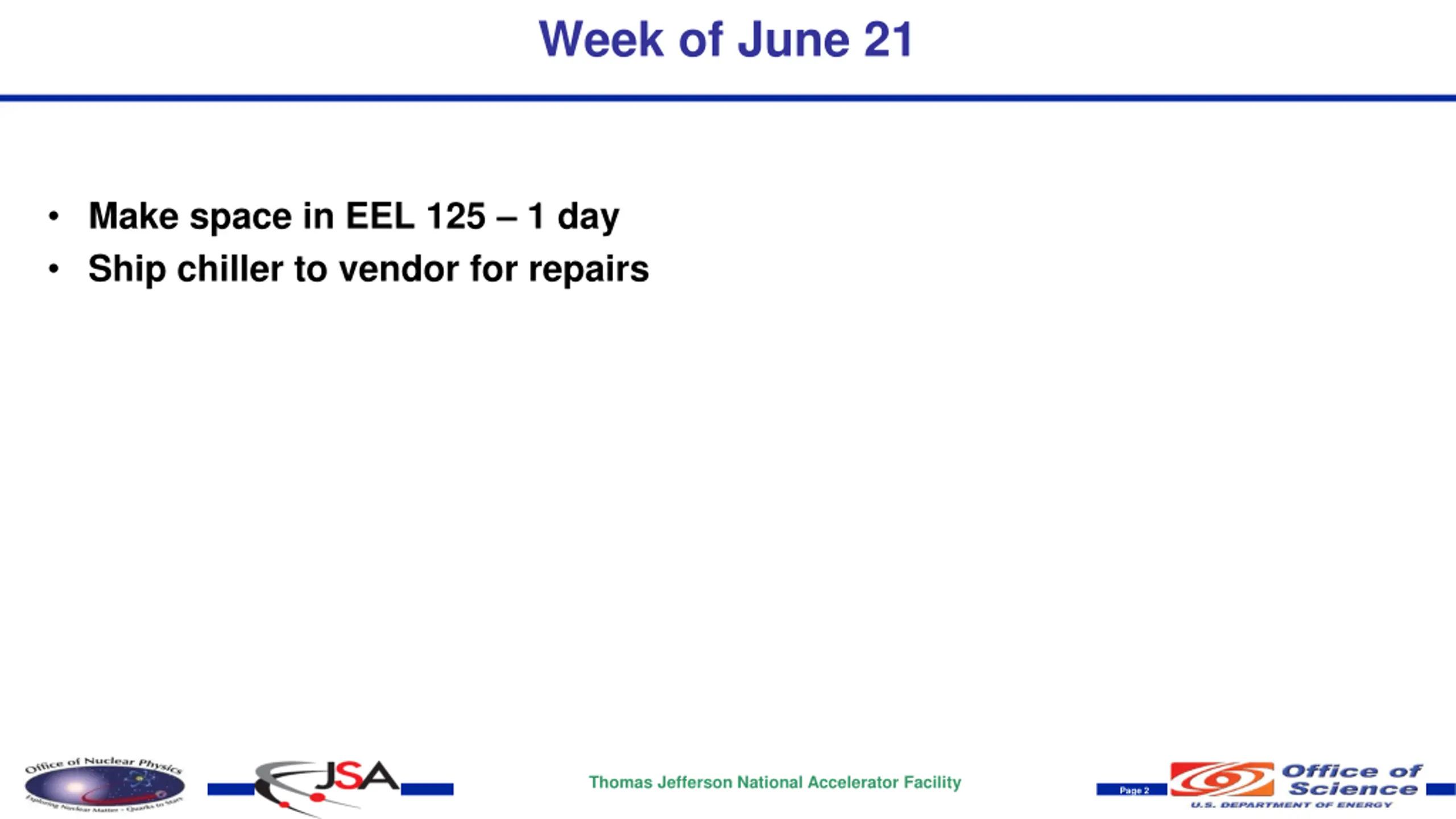

  2. Week of June 21 Make space in EEL 125 1 day Ship chiller to vendor for repairs Thomas Jefferson National Accelerator Facility Page 2

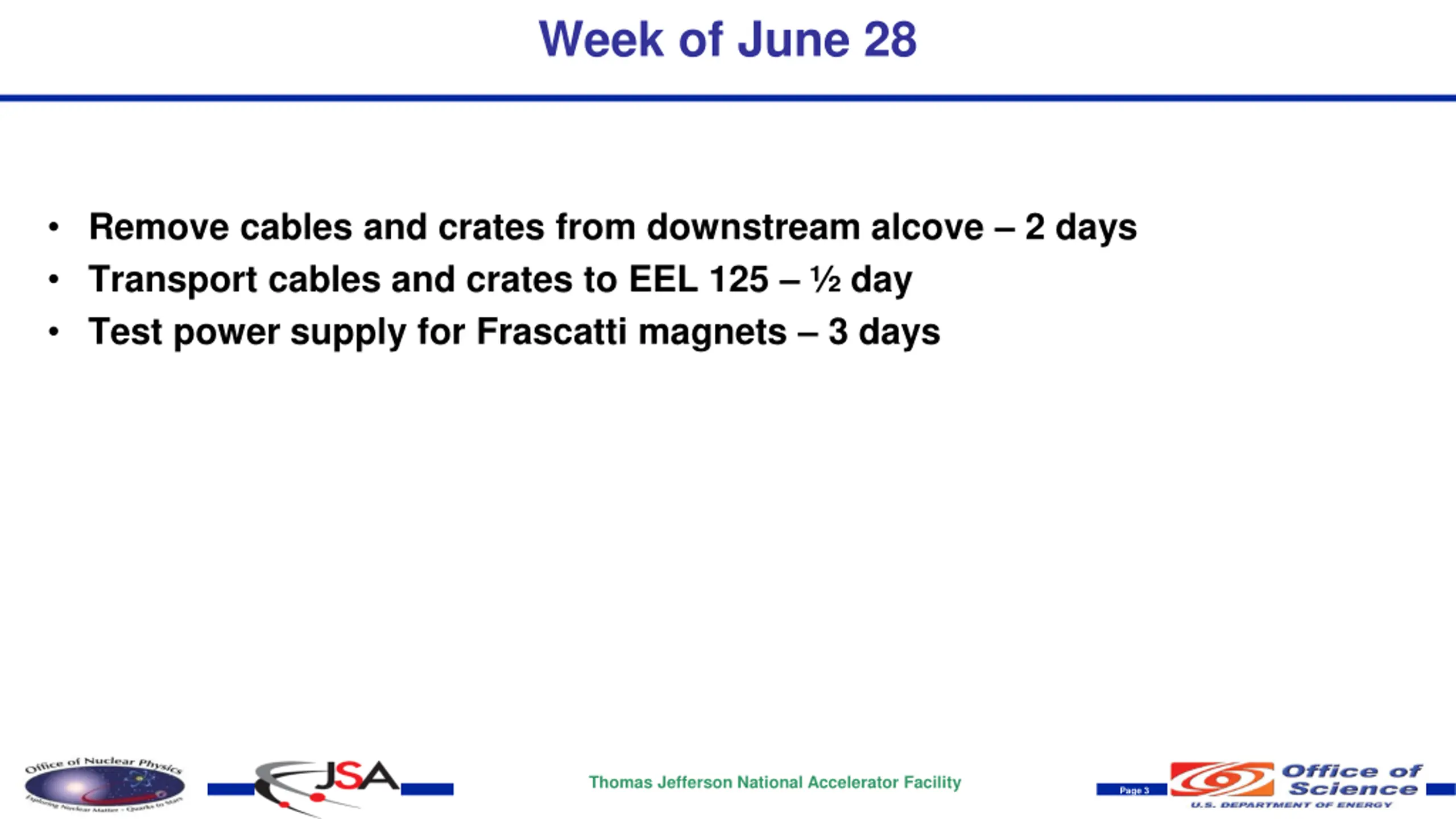

  3. Week of June 28 Remove cables and crates from downstream alcove 2 days Transport cables and crates to EEL 125 day Test power supply for Frascatti magnets 3 days Thomas Jefferson National Accelerator Facility Page 3

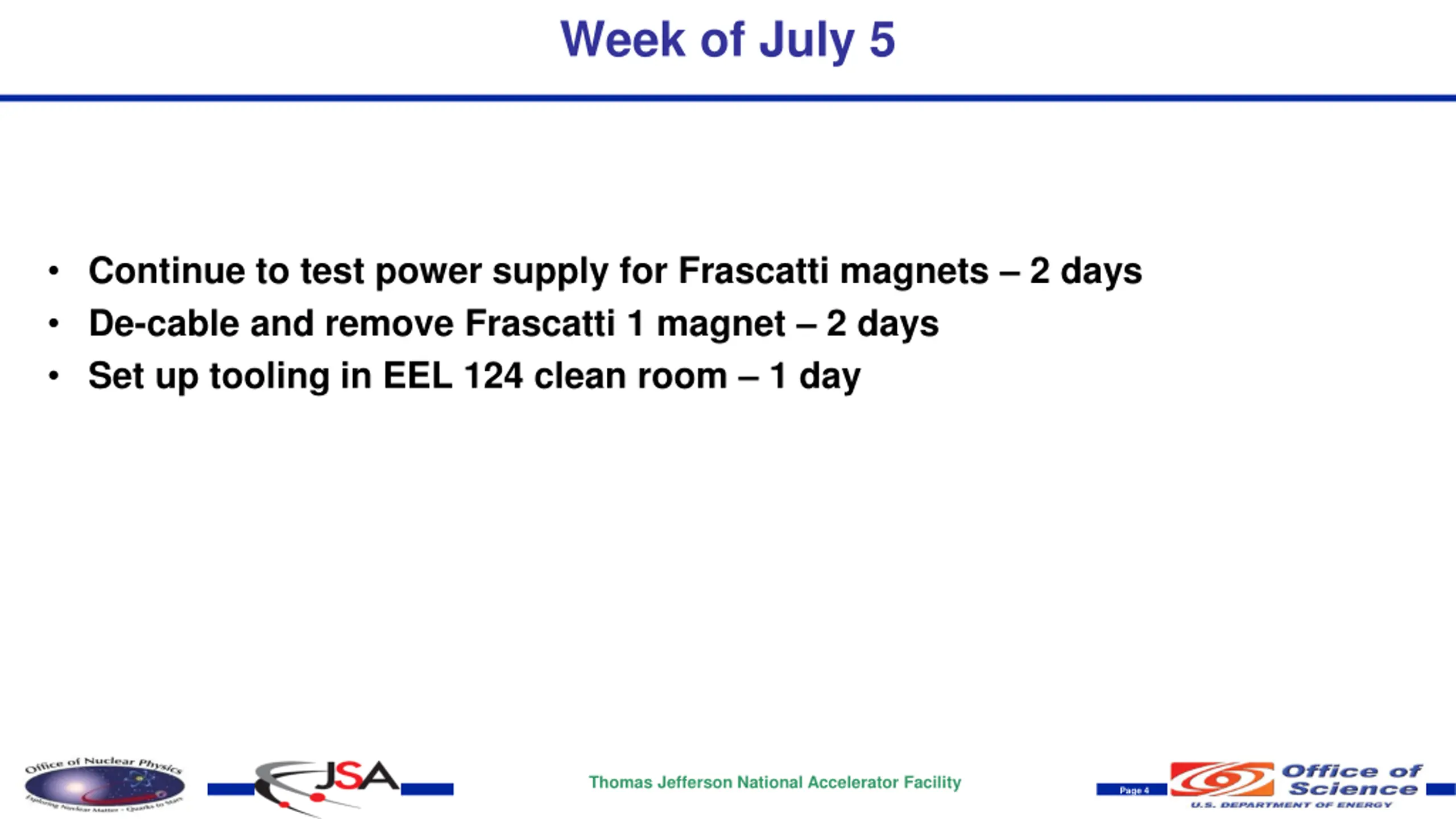

  4. Week of July 5 Continue to test power supply for Frascatti magnets 2 days De-cable and remove Frascatti 1 magnet 2 days Set up tooling in EEL 124 clean room 1 day Thomas Jefferson National Accelerator Facility Page 4

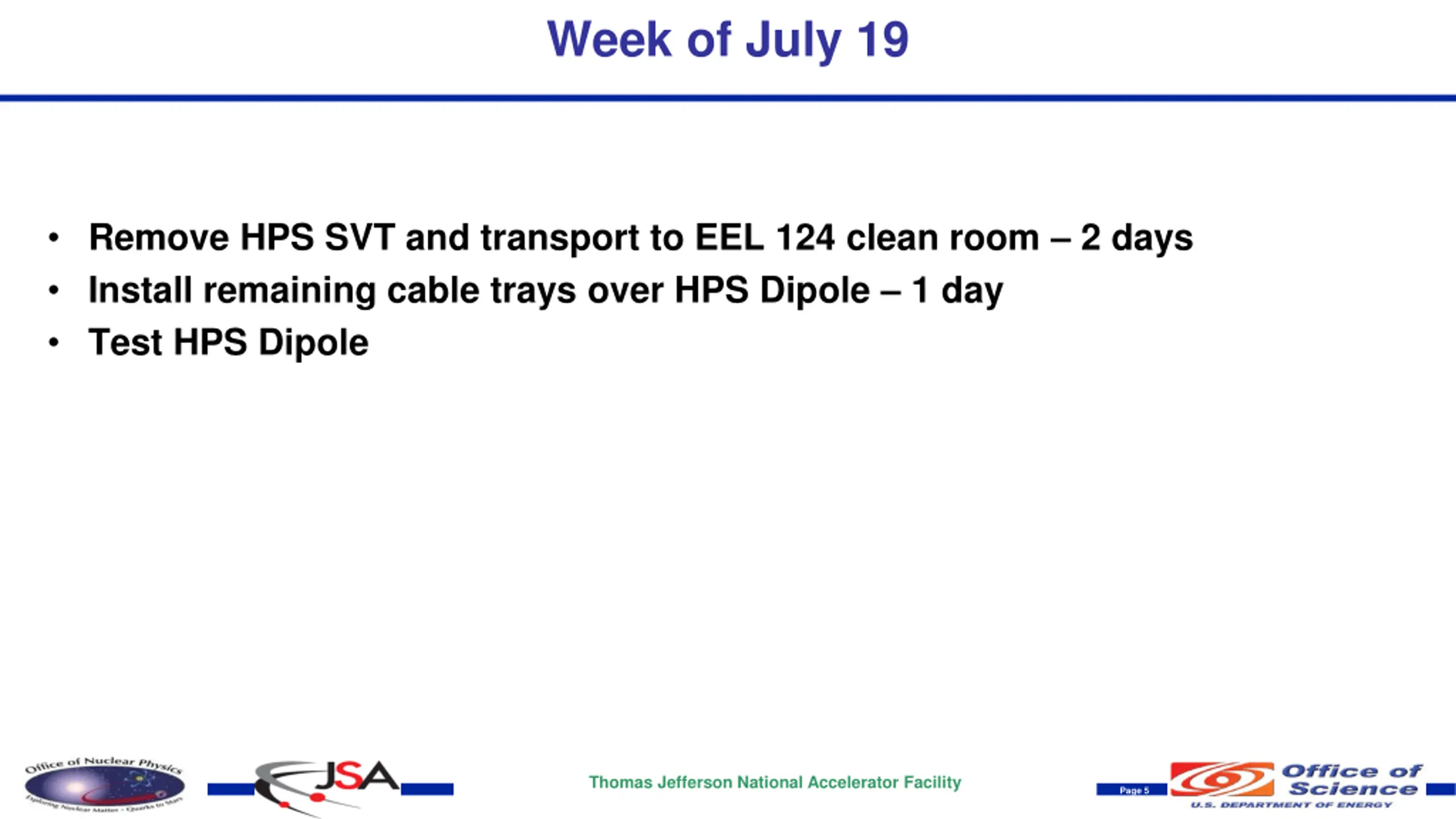

  5. Week of July 19 Remove HPS SVT and transport to EEL 124 clean room 2 days Install remaining cable trays over HPS Dipole 1 day Test HPS Dipole Thomas Jefferson National Accelerator Facility Page 5

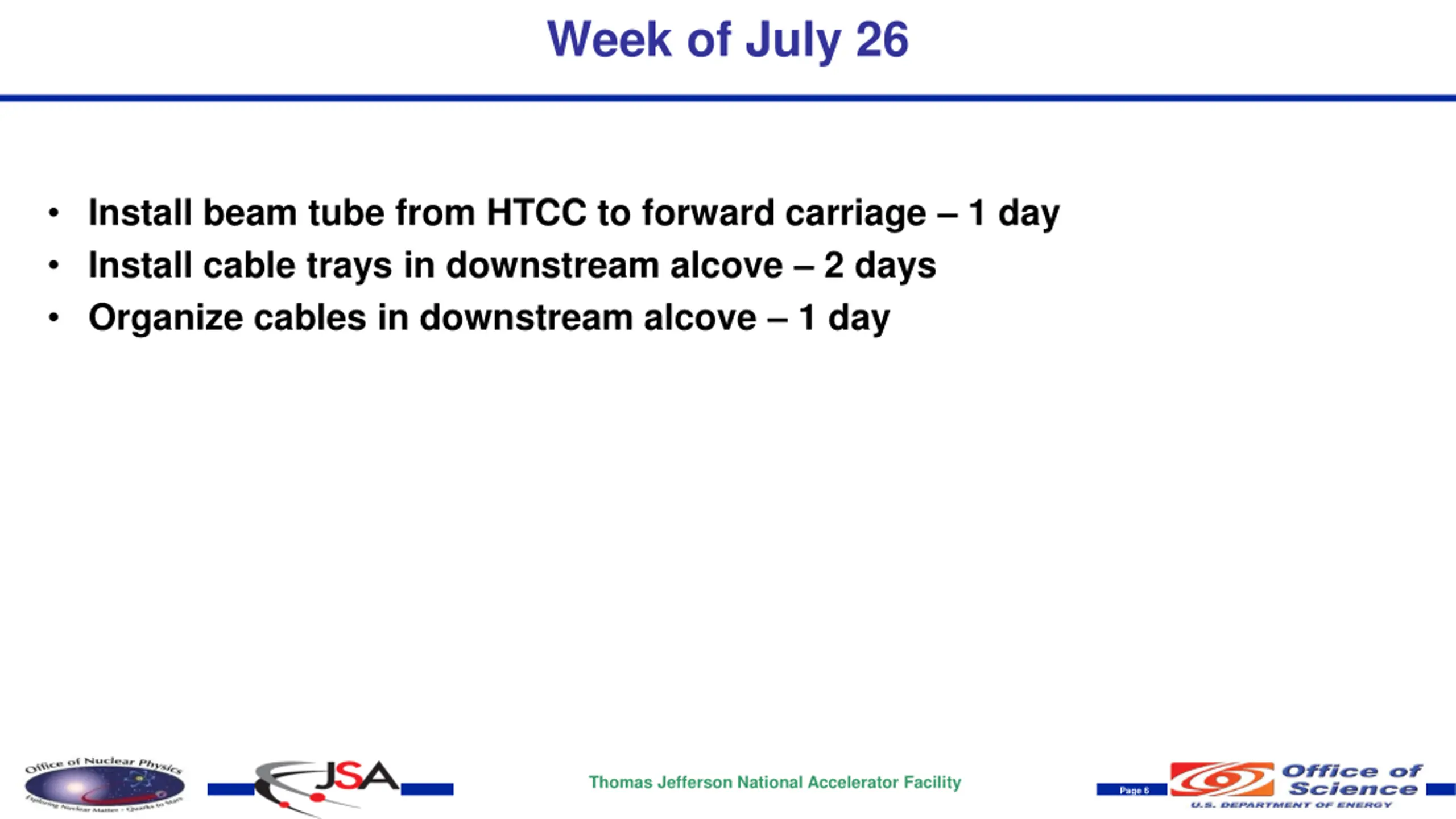

  6. Week of July 26 Install beam tube from HTCC to forward carriage 1 day Install cable trays in downstream alcove 2 days Organize cables in downstream alcove 1 day Thomas Jefferson National Accelerator Facility Page 6

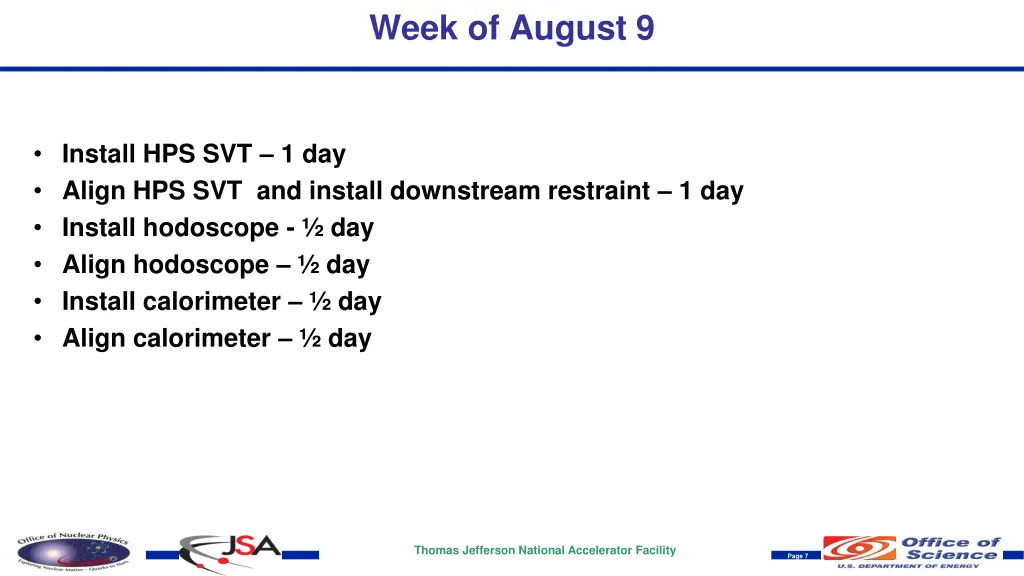

  7. Week of August 9 Install HPS SVT 1 day Align HPS SVT and install downstream restraint 1 day Install hodoscope - day Align hodoscope day Install calorimeter day Align calorimeter day Thomas Jefferson National Accelerator Facility Page 7

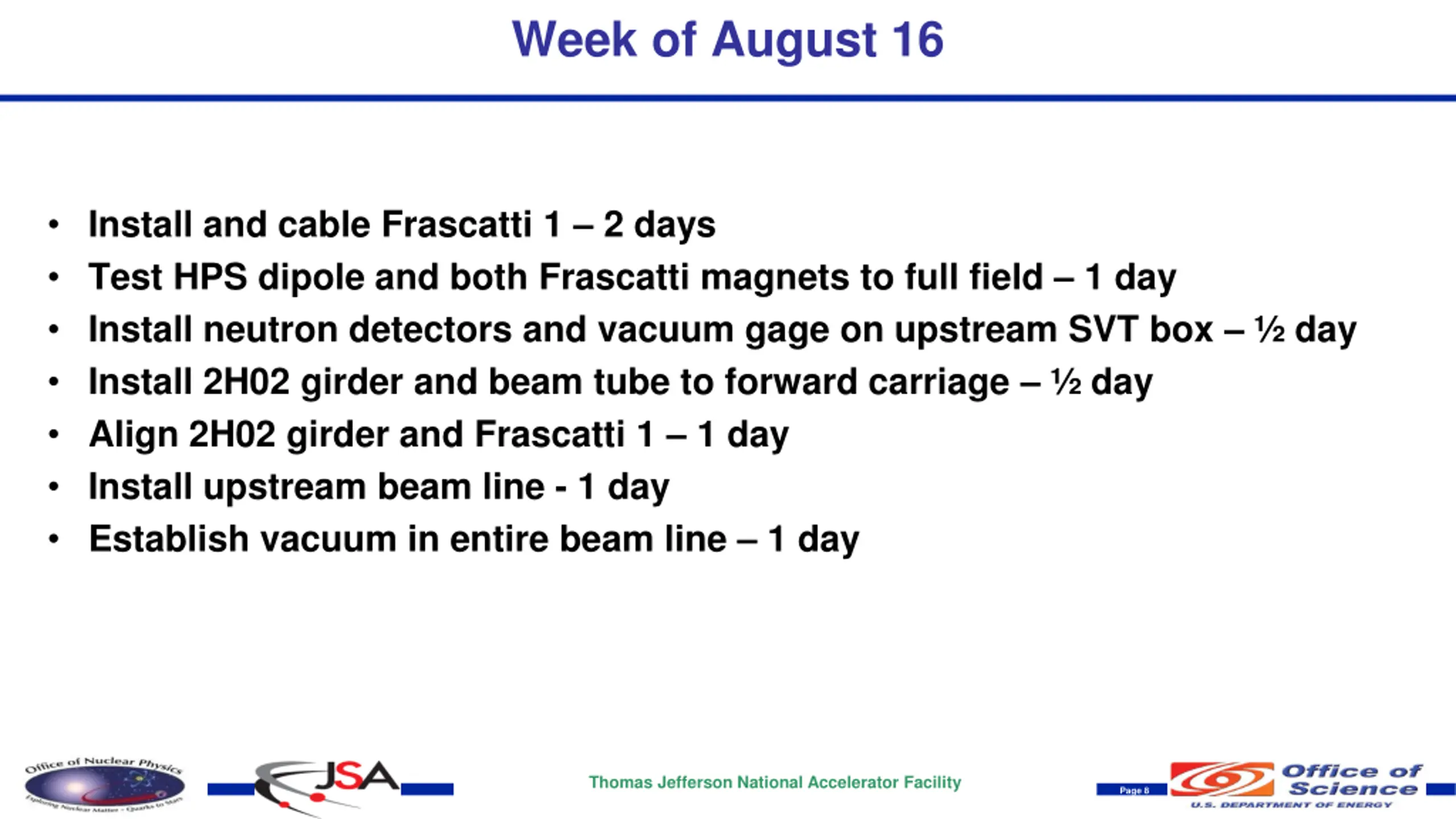

  8. Week of August 16 Install and cable Frascatti 1 2 days Test HPS dipole and both Frascatti magnets to full field 1 day Install neutron detectors and vacuum gage on upstream SVT box day Install 2H02 girder and beam tube to forward carriage day Align 2H02 girder and Frascatti 1 1 day Install upstream beam line - 1 day Establish vacuum in entire beam line 1 day Thomas Jefferson National Accelerator Facility Page 8
