Item 10a Otay River Estuary Restoration Project Mitigation for the Poseidon Carlsbad Desalination Plant CALIFORNIA COASTAL COMMISSION ENERGY, OCEAN RESOURCESAND FEDERAL CONSISTENCY SLIDE 1

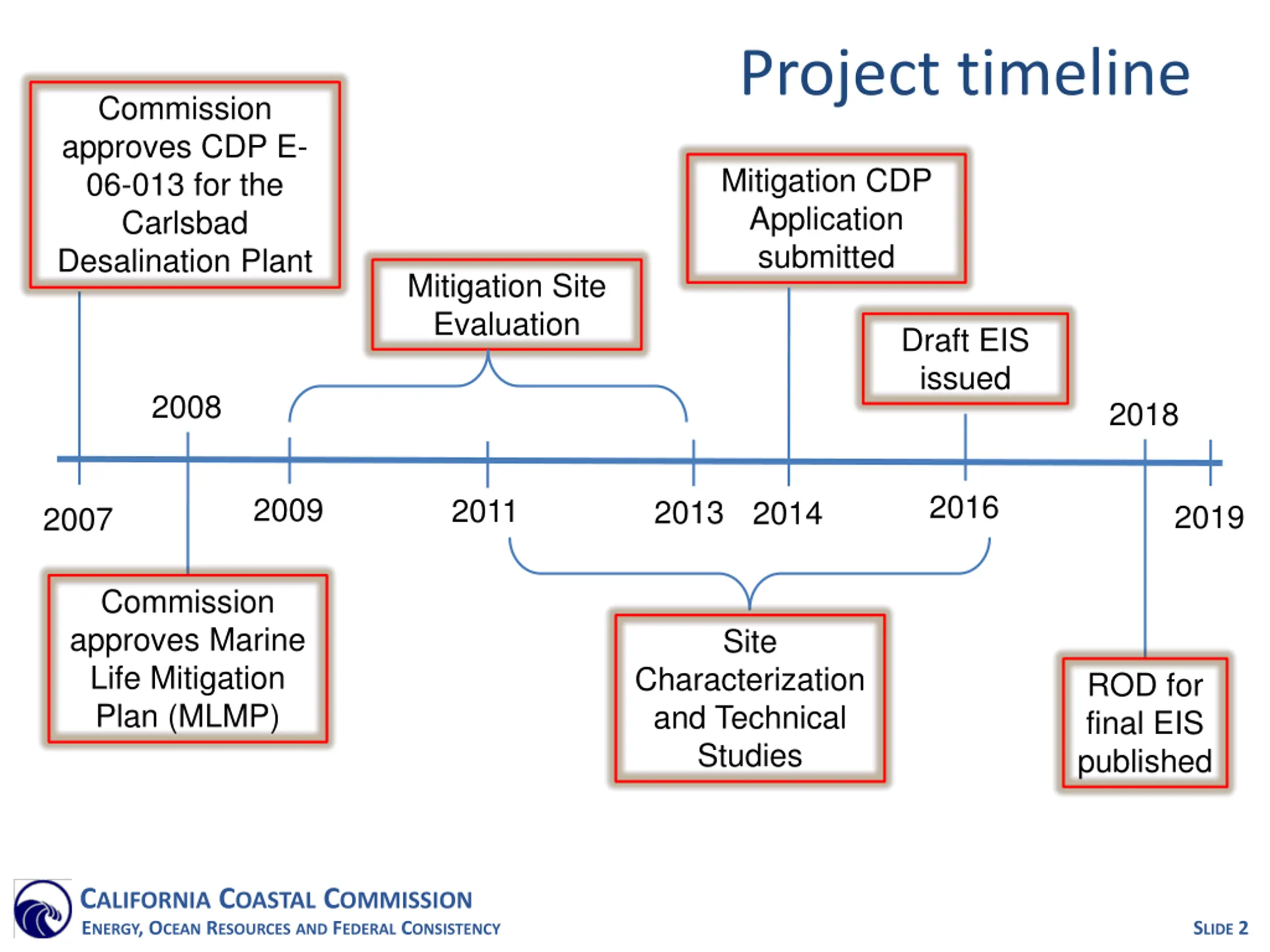

Project timeline Commission approves CDP E- 06-013 for the Carlsbad Desalination Plant Mitigation CDP Application submitted Mitigation Site Evaluation Draft EIS issued 2008 2018 2016 2009 2011 2013 2014 2019 2007 Commission approves Marine Life Mitigation Plan (MLMP) Site Characterization and Technical Studies ROD for final EIS published CALIFORNIA COASTAL COMMISSION ENERGY, OCEAN RESOURCESAND FEDERAL CONSISTENCY SLIDE 2

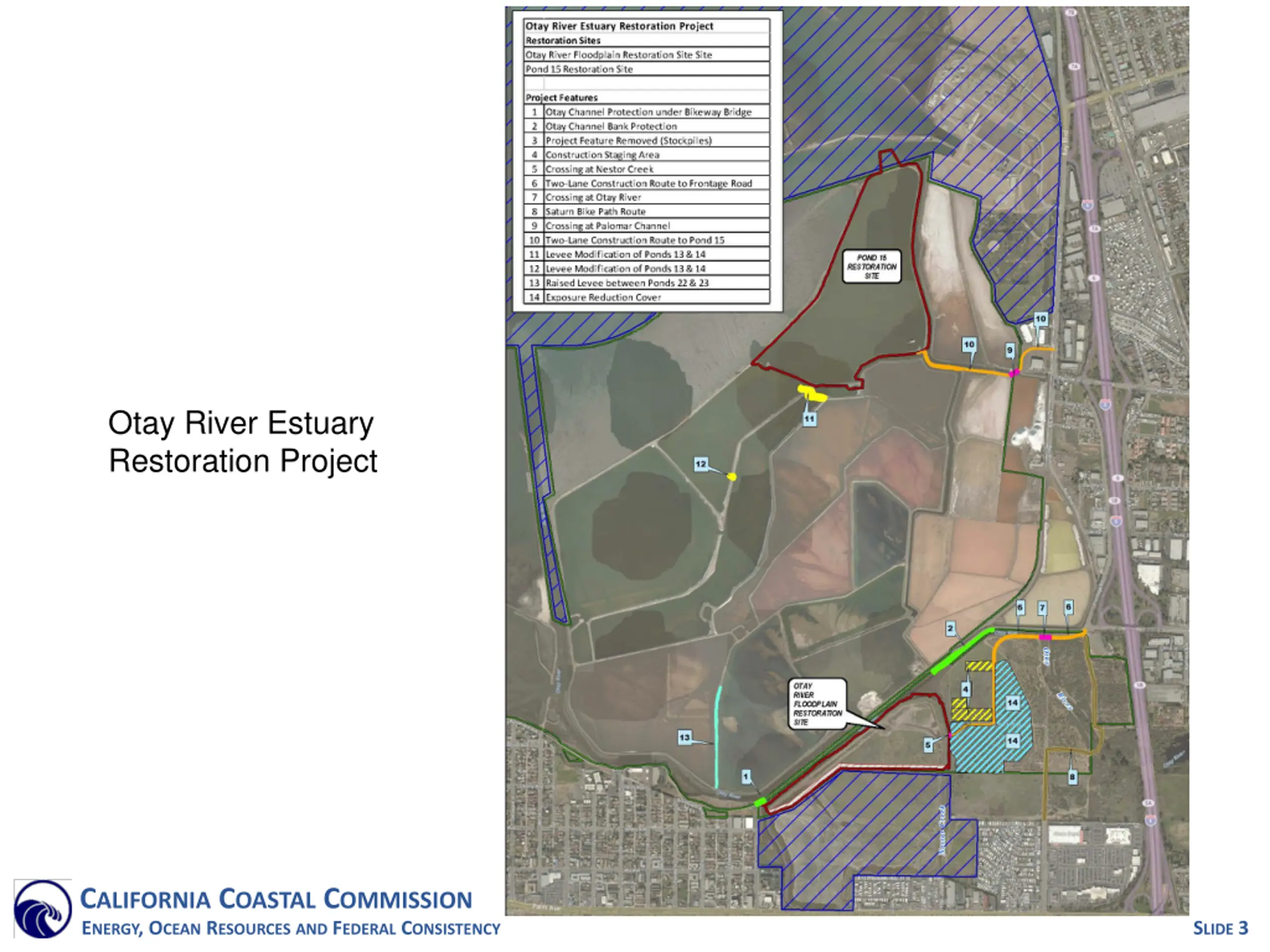

Otay River Estuary Restoration Project CALIFORNIA COASTAL COMMISSION ENERGY, OCEAN RESOURCESAND FEDERAL CONSISTENCY SLIDE 3

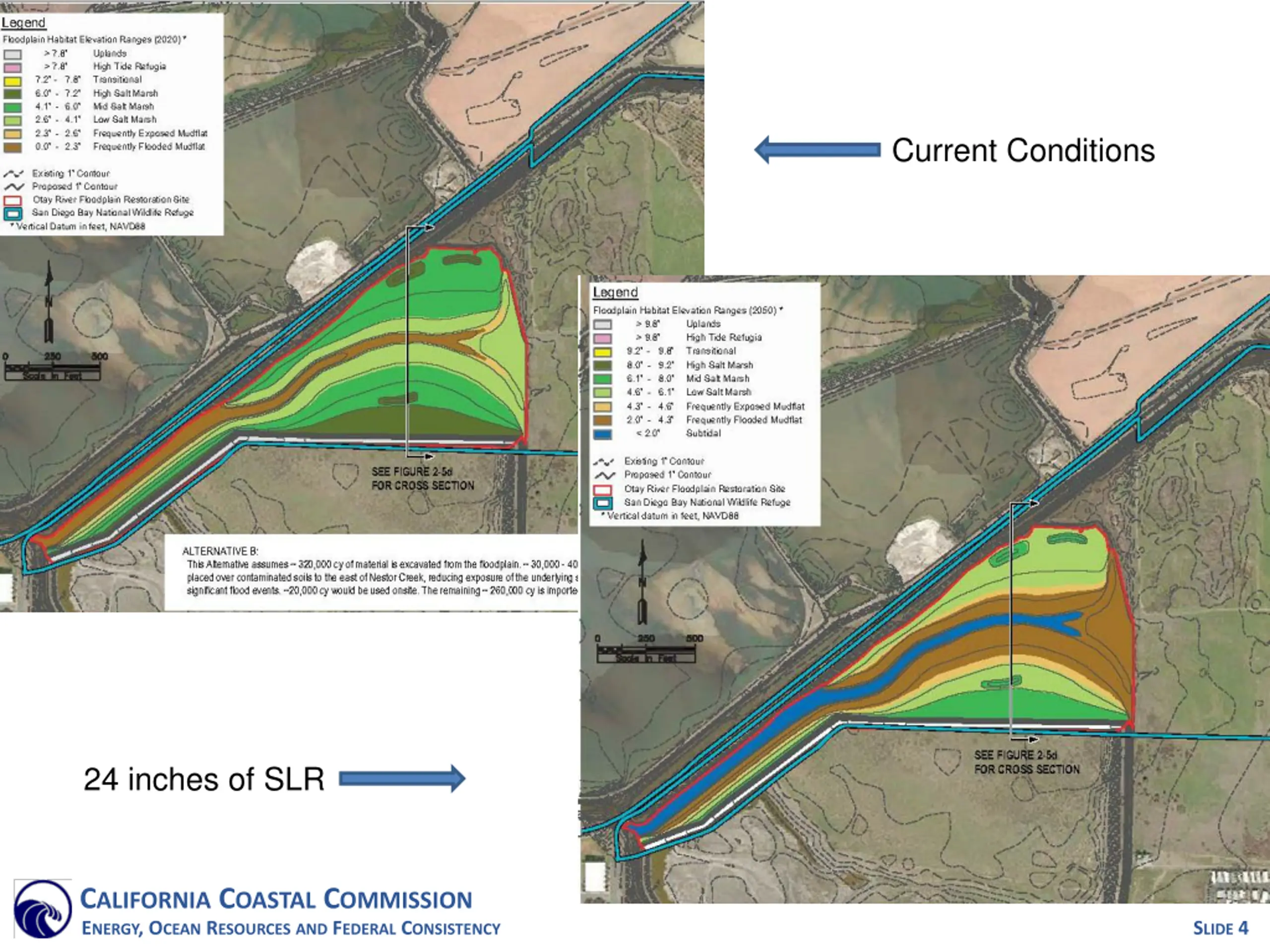

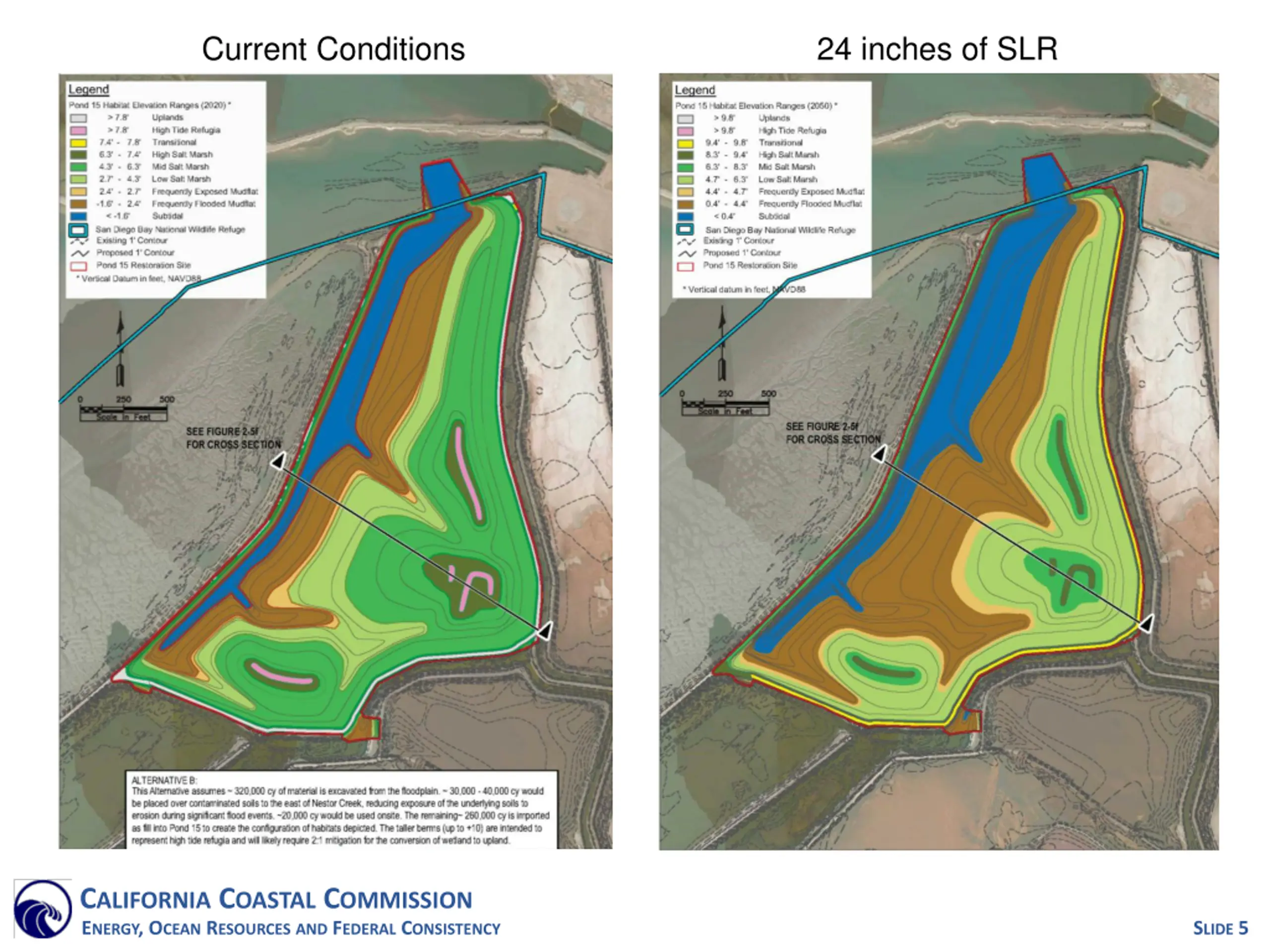

Current Conditions 24 inches of SLR CALIFORNIA COASTAL COMMISSION ENERGY, OCEAN RESOURCESAND FEDERAL CONSISTENCY SLIDE 4
Current Conditions 24 inches of SLR CALIFORNIA COASTAL COMMISSION ENERGY, OCEAN RESOURCESAND FEDERAL CONSISTENCY SLIDE 5
