Latest Updates on Gel Production and Testing at LNGS Facility
Discover the current status of the gel production and testing process at LNGS Facility in Napoli. Updates include the installation of new machines, technical tests before production runs, prerequisites for gel production, and more. Stay informed about the advancements in gel production technology for physics experiments.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
From GPM to 10 g Valeri Tioukov Napoli

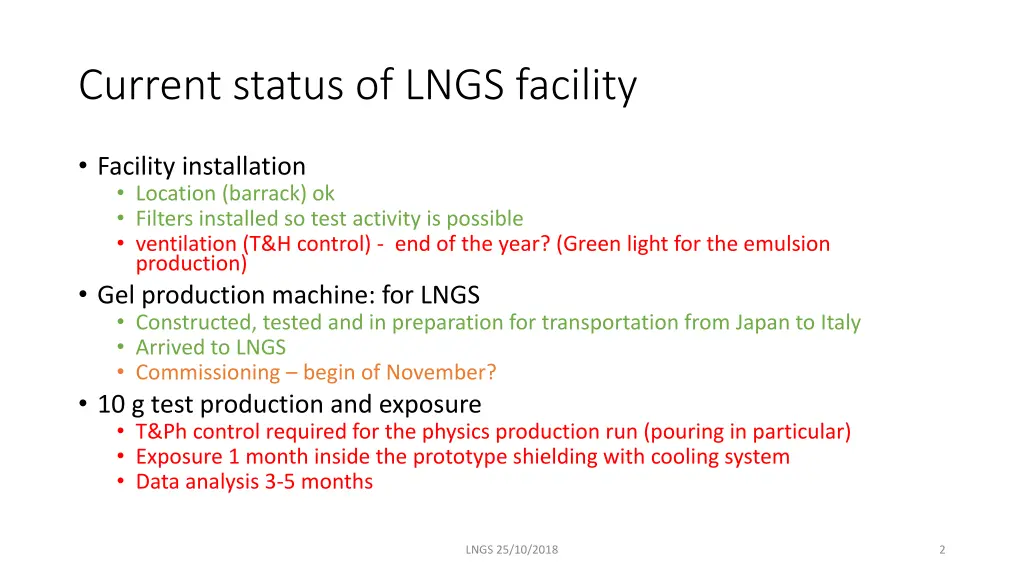

Current status of LNGS facility Facility installation Location (barrack) ok Filters installed so test activity is possible ventilation (T&H control) - end of the year? (Green light for the emulsion production) Gel production machine: for LNGS Constructed, tested and in preparation for transportation from Japan to Italy Arrived to LNGS Commissioning begin of November? 10 g test production and exposure T&Ph control required for the physics production run (pouring in particular) Exposure 1 month inside the prototype shielding with cooling system Data analysis 3-5 months LNGS 25/10/2018 2

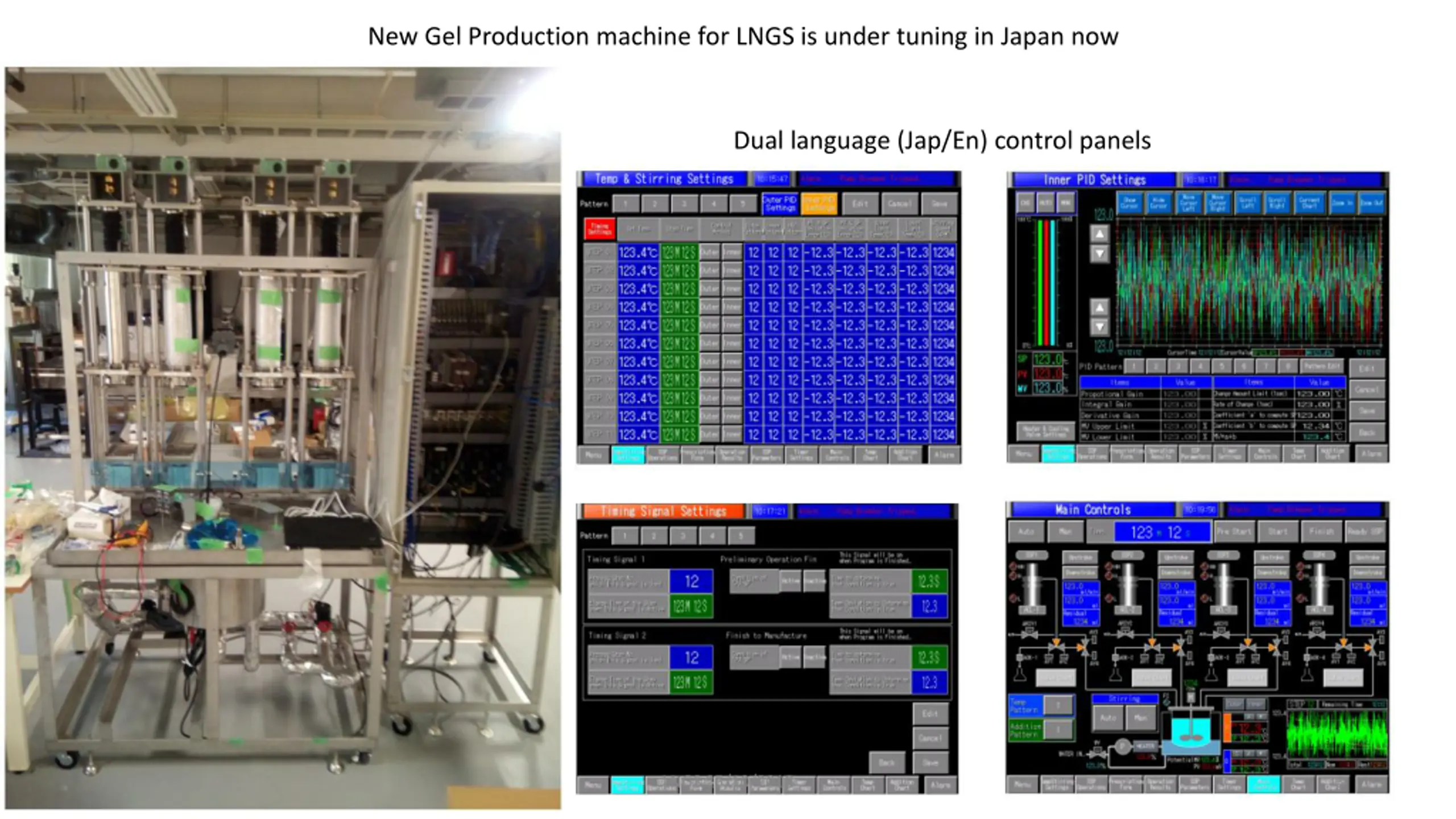

New Gel Production machine for LNGS is under tuning in Japan now Dual language (Jap/En) control panels LNGS 25/10/2018 3

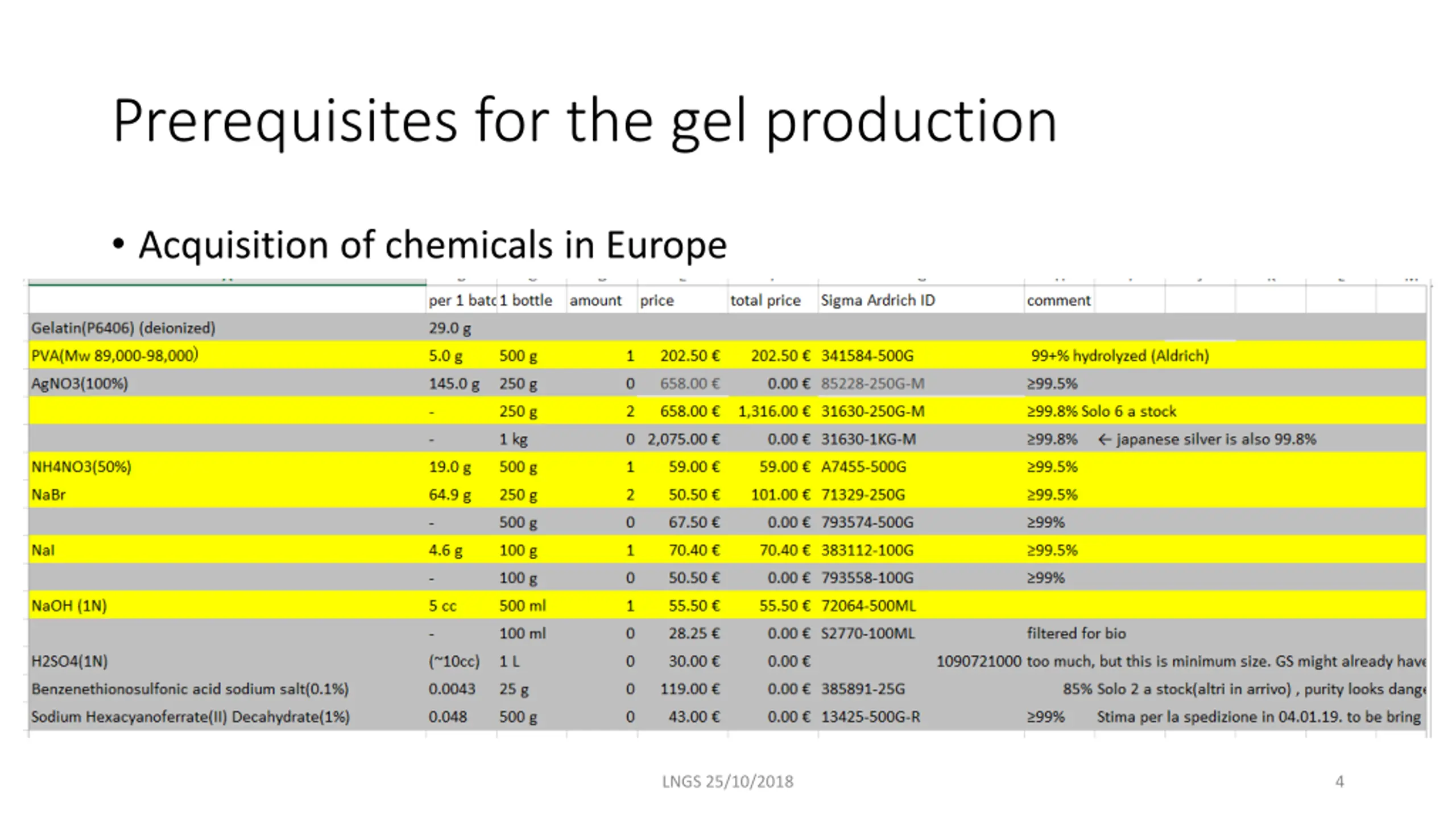

Prerequisites for the gel production Acquisition of chemicals in Europe LNGS 25/10/2018 4

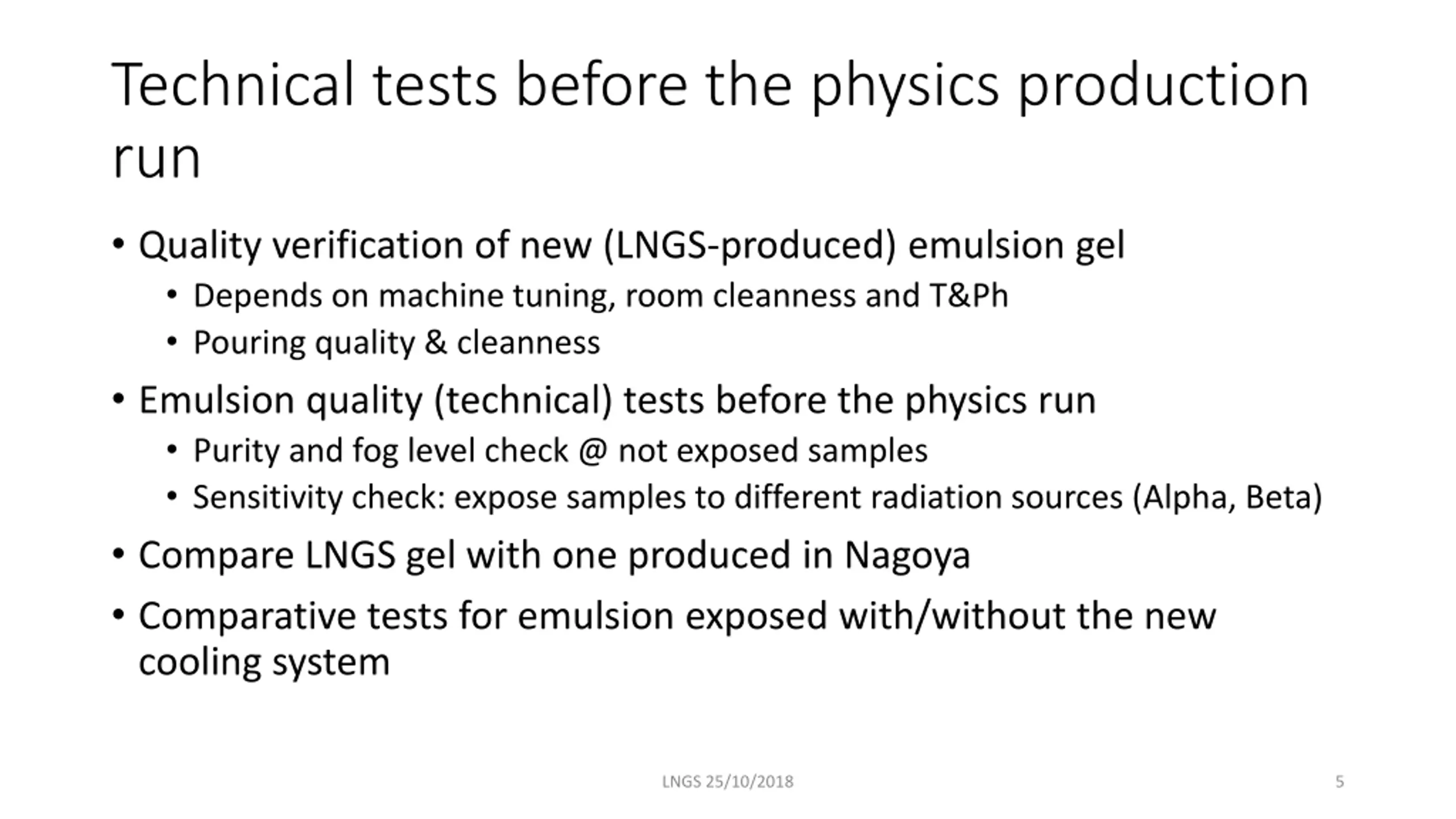

Technical tests before the physics production run Quality verification of new (LNGS-produced) emulsion gel Depends on machine tuning, room cleanness and T&Ph Pouring quality & cleanness Emulsion quality (technical) tests before the physics run Purity and fog level check @ not exposed samples Sensitivity check: expose samples to different radiation sources (Alpha, Beta) Compare LNGS gel with one produced in Nagoya Comparative tests for emulsion exposed with/without the new cooling system LNGS 25/10/2018 5
Machine and gel production tuning Just water demonstration run after assembling First batch(es) with chemicals and checking of the basic gel parameters PH, conductivity, etc Transparency spectrometer is required Cristal size check TEM is required possibly close to LNGS Sensitivity check: Alpha exposure, development and microscope check Dust check Next batch(es) cleaning of the gelatin and pouring conditions (new) Filtering of gelatin and other chemicals if necessary Repeat all above tests and confirm the low dust condition 10 g production LNGS 25/10/2018 6

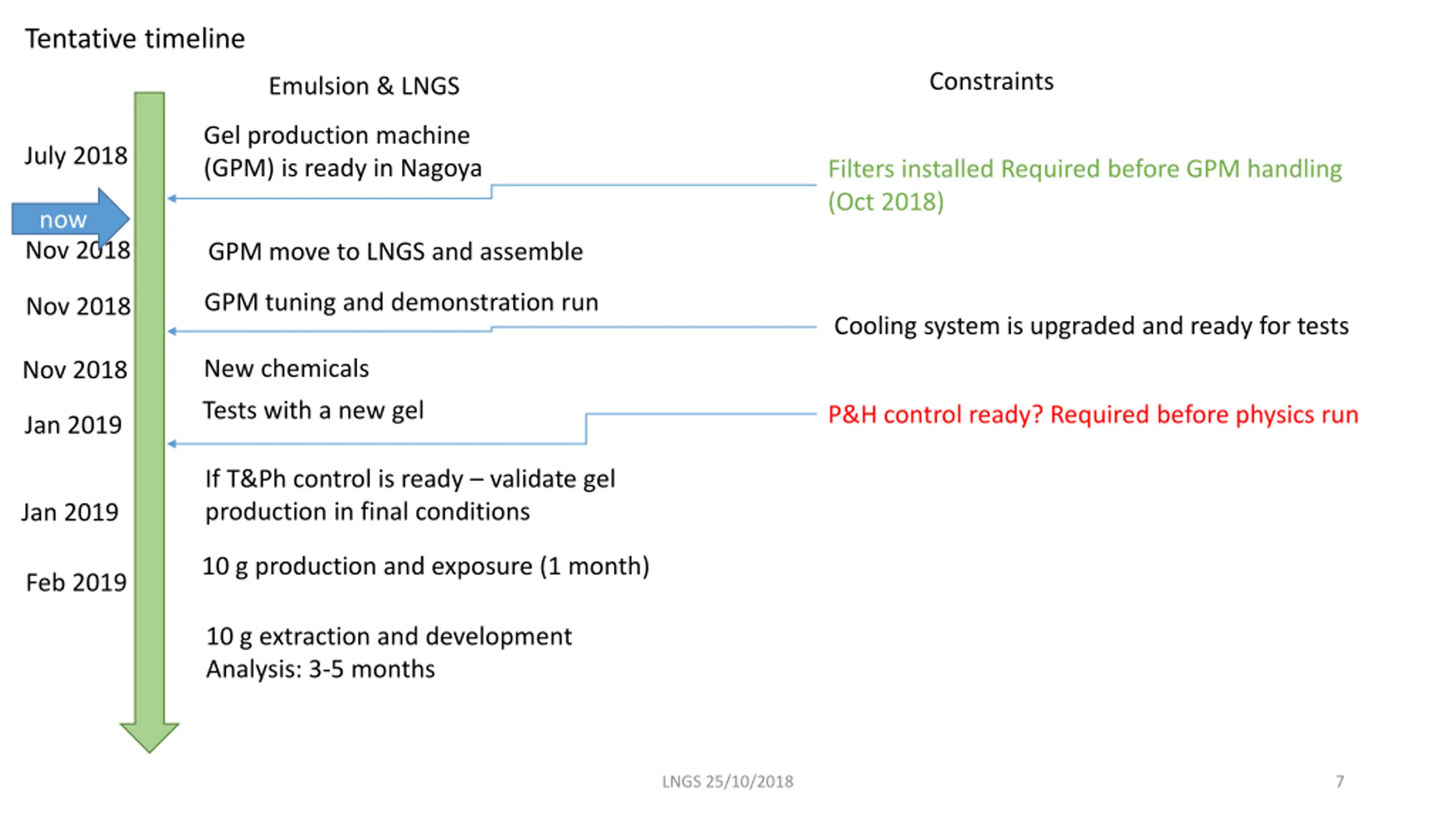

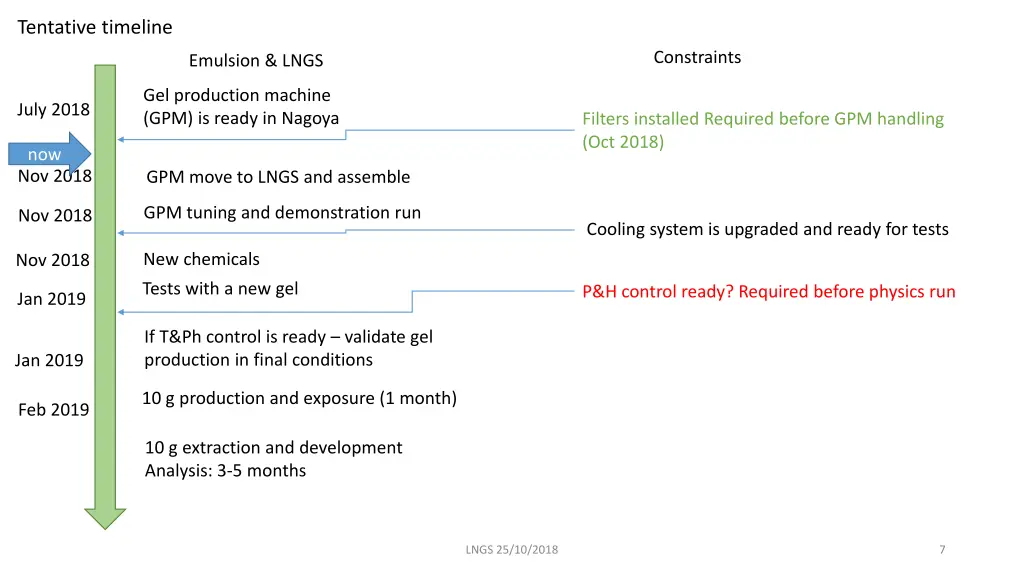

Tentative timeline Constraints Emulsion & LNGS Gel production machine (GPM) is ready in Nagoya July 2018 Filters installed Required before GPM handling (Oct 2018) now Nov 2018 GPM move to LNGS and assemble GPM tuning and demonstration run Nov 2018 Cooling system is upgraded and ready for tests New chemicals Nov 2018 Tests with a new gel P&H control ready? Required before physics run Jan 2019 If T&Ph control is ready validate gel production in final conditions Jan 2019 10 g production and exposure (1 month) Feb 2019 10 g extraction and development Analysis: 3-5 months LNGS 25/10/2018 7

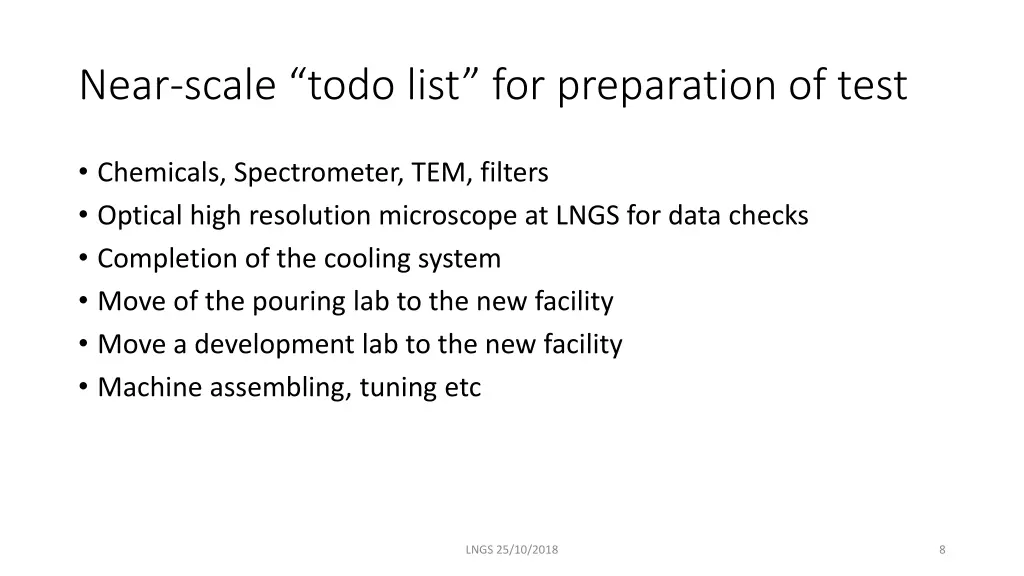

Near-scale todo list for preparation of test Chemicals, Spectrometer, TEM, filters Optical high resolution microscope at LNGS for data checks Completion of the cooling system Move of the pouring lab to the new facility Move a development lab to the new facility Machine assembling, tuning etc LNGS 25/10/2018 8

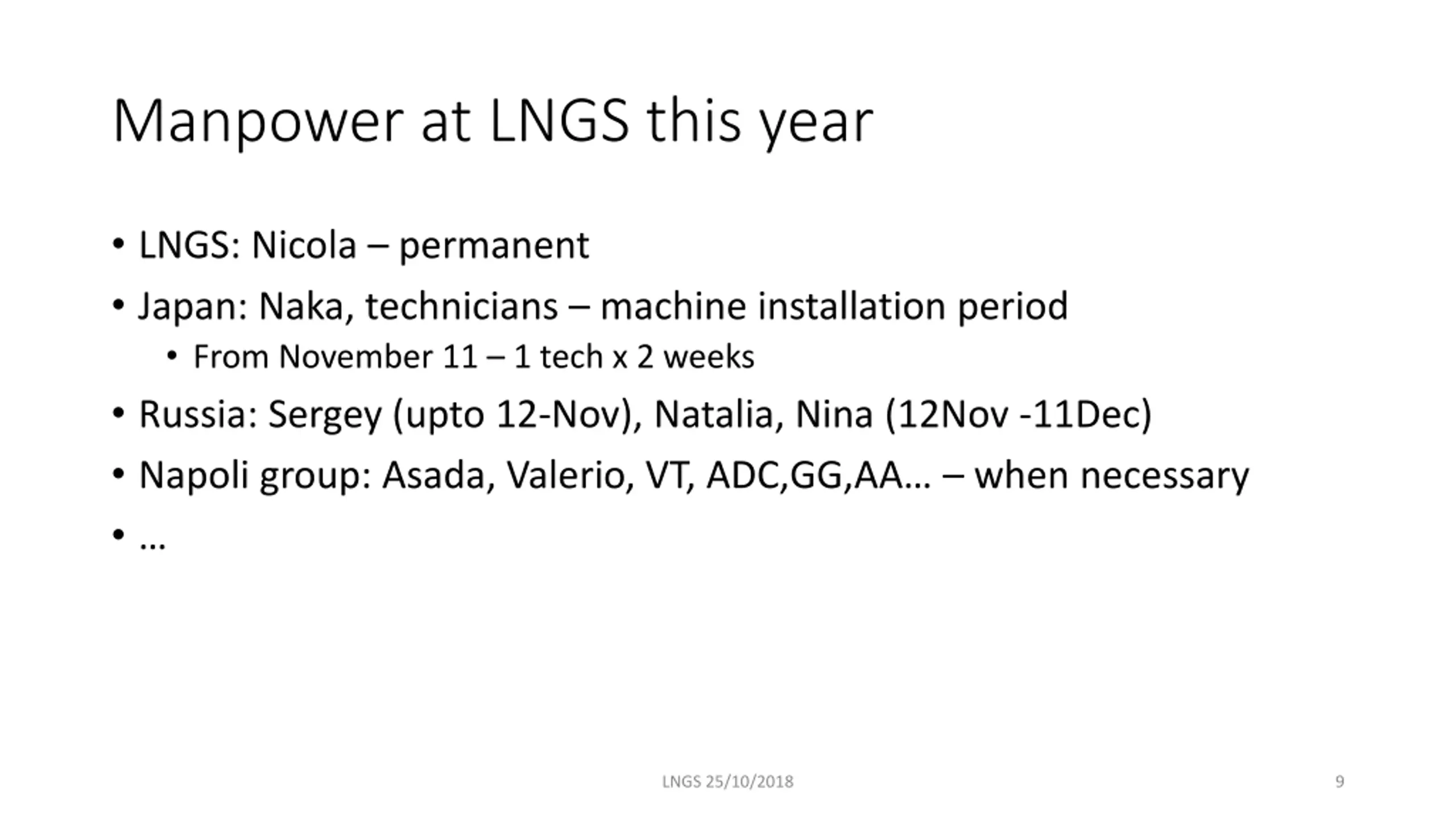

Manpower at LNGS this year LNGS: Nicola permanent Japan: Naka, technicians machine installation period From November 11 1 tech x 2 weeks Russia: Sergey (upto 12-Nov), Natalia, Nina (12Nov -11Dec) Napoli group: Asada, Valerio, VT, ADC,GG,AA when necessary LNGS 25/10/2018 9
