Legal Requirements and Deliverables for GLEB PT EB Monitoring
Explore the legal requirements and deliverables outlined for GLEB PT EB monitoring, including the preparation of reports, manuals, and timelines. Understand the monitoring focus, data provision, and approval processes by reviewing the provided content.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
EB Reporting PT David Gerbec EBSG 5th of March 2018 1

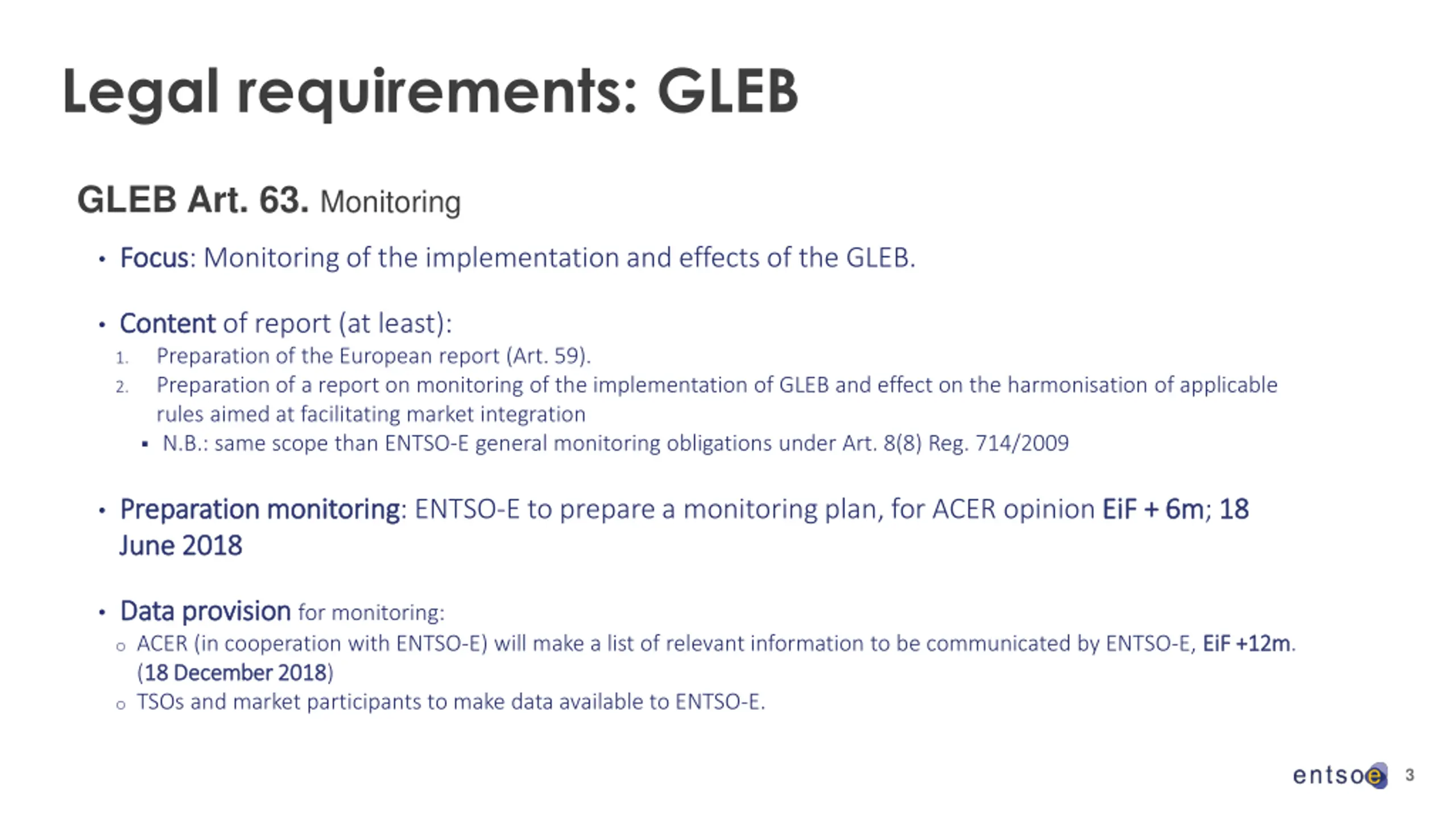

Legal requirements: GLEB GLEB Art. 63. Monitoring Focus Focus: Monitoring of the implementation and effects of the GLEB. Content Content of report (at least): Preparation of the European report (Art. 59). Preparation of a report on monitoring of the implementation of GLEB and effect on the harmonisation of applicable rules aimed at facilitating market integration N.B.: same scope than ENTSO-E general monitoring obligations under Art. 8(8) Reg. 714/2009 1. 2. Preparation monitoring Preparation monitoring: ENTSO-E to prepare a monitoring plan, for ACER opinion EiF + 6m June June 2018 2018 EiF + 6m; 18 18 Data provision Data provision for monitoring: o ACER (in cooperation with ENTSO-E) will make a list of relevant information to be communicated by ENTSO-E, EiF +12m (18 18 December 2018 December 2018) o TSOs and market participants to make data available to ENTSO-E. EiF +12m. 3

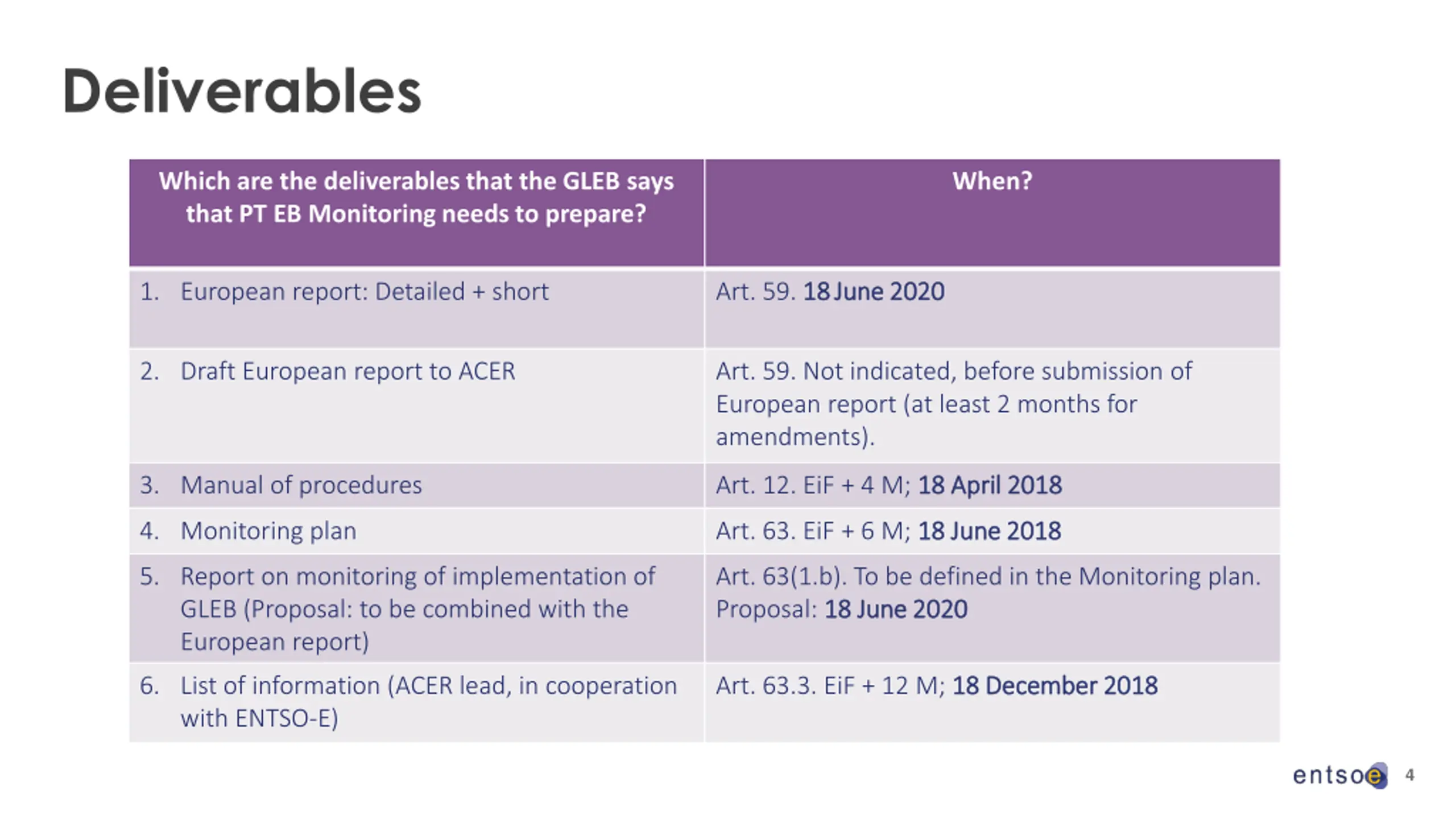

Deliverables Which are the deliverables that the GLEB says that PT EB Monitoring needs to prepare? When? 1. European report: Detailed + short Art. 59. 18 18June June2020 2020 2. Draft European report to ACER Art. 59. Not indicated, before submission of European report (at least 2 months for amendments). 3. Manual of procedures Art. 12. EiF + 4 M; 18 18 April April 2018 2018 4. Monitoring plan Art. 63. EiF + 6 M; 18 June 18 June2018 2018 5. Report on monitoring of implementation of GLEB (Proposal: to be combined with the European report) Art. 63(1.b). To be defined in the Monitoring plan. Proposal: 18 June 2020 18 June 2020 6. List of information (ACER lead, in cooperation with ENTSO-E) Art. 63.3. EiF + 12 M; 18 Decembe 18 December r 2018 2018 4

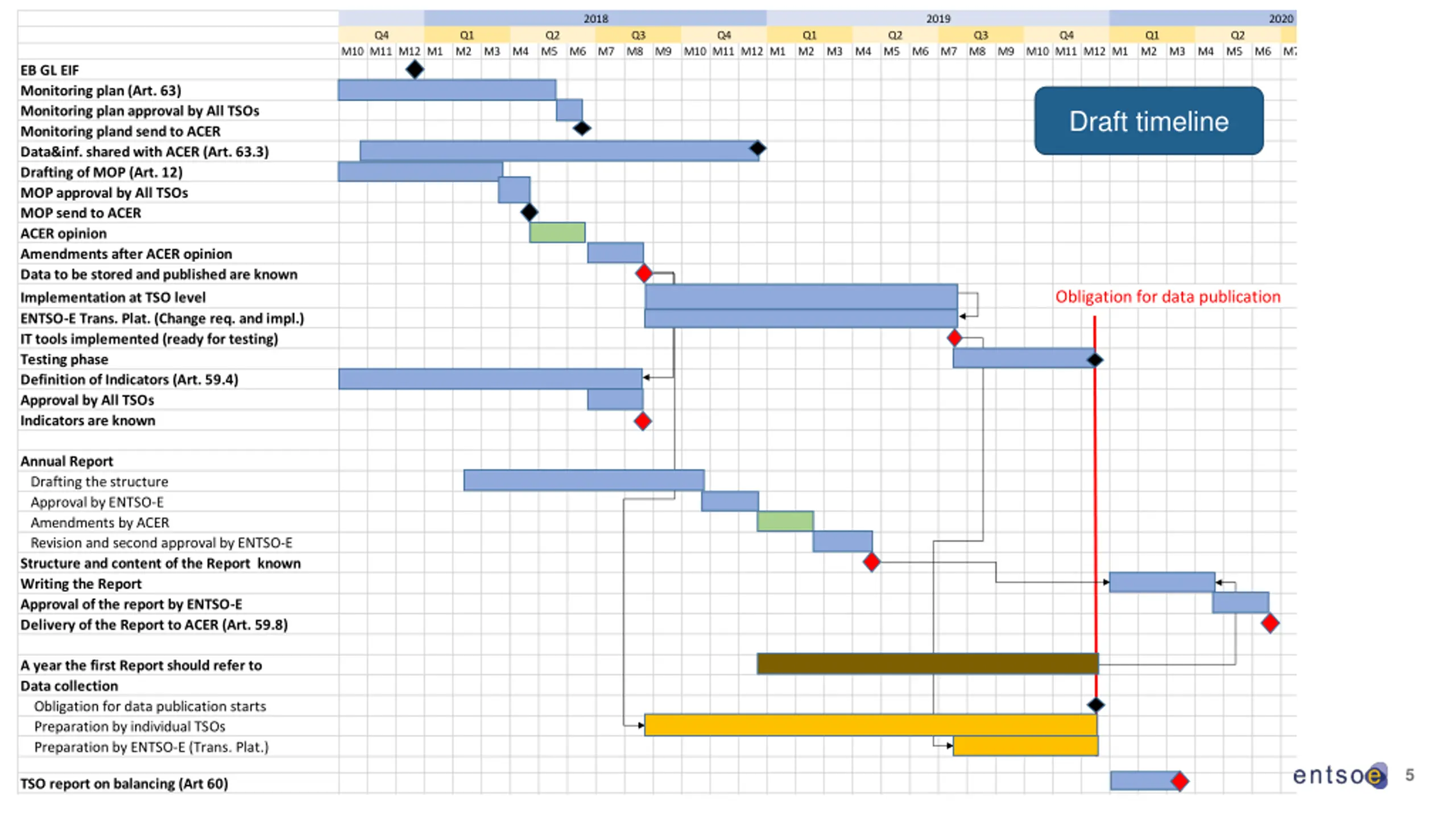

2018 2019 2020 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 M10 M11 M12 M1 M2 M3 M4 M5 M6 M7 M8 M9 M10 M11 M12 M1 M2 M3 M4 M5 M6 M7 M8 M9 M10 M11 M12 M1 M2 M3 M4 M5 M6 M7 M8 M9 M10 M11 M12 EB GL EIF Monitoring plan (Art. 63) Monitoring plan approval by All TSOs Monitoring pland send to ACER Data&inf. shared with ACER (Art. 63.3) Drafting of MOP (Art. 12) MOP approval by All TSOs MOP send to ACER ACER opinion Amendments after ACER opinion Data to be stored and published are known Implementation at TSO level ENTSO-E Trans. Plat. (Change req. and impl.) IT tools implemented (ready for testing) Testing phase Definition of Indicators (Art. 59.4) Approval by All TSOs Indicators are known Draft timeline Obligation for data publication Annual Report Drafting the structure Approval by ENTSO-E Amendments by ACER Revision and second approval by ENTSO-E Structure and content of the Report known Writing the Report Approval of the report by ENTSO-E Delivery of the Report to ACER (Art. 59.8) A year the first Report should refer to Data collection Obligation for data publication starts Preparation by individual TSOs Preparation by ENTSO-E (Trans. Plat.) 5 TSO report on balancing (Art 60)
