Mass Transition Timeline and Process Review for Effective Coordination

mass transition timeline process review n.w
1 / 10
Embed
Share

Explore the comprehensive timeline and processes involved in initiating a mass transition project from various entities like TDSP, ERCOT, and designated CRs. Learn about key milestones, notifications, and coordination calls essential for a successful transition.

  • Transition Timeline
  • Process Review
  • Coordination
  • ERCOT
  • Mass Transition

Uploaded on | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. Mass Transition Timeline & Process Review Jim Lee RMS Chair

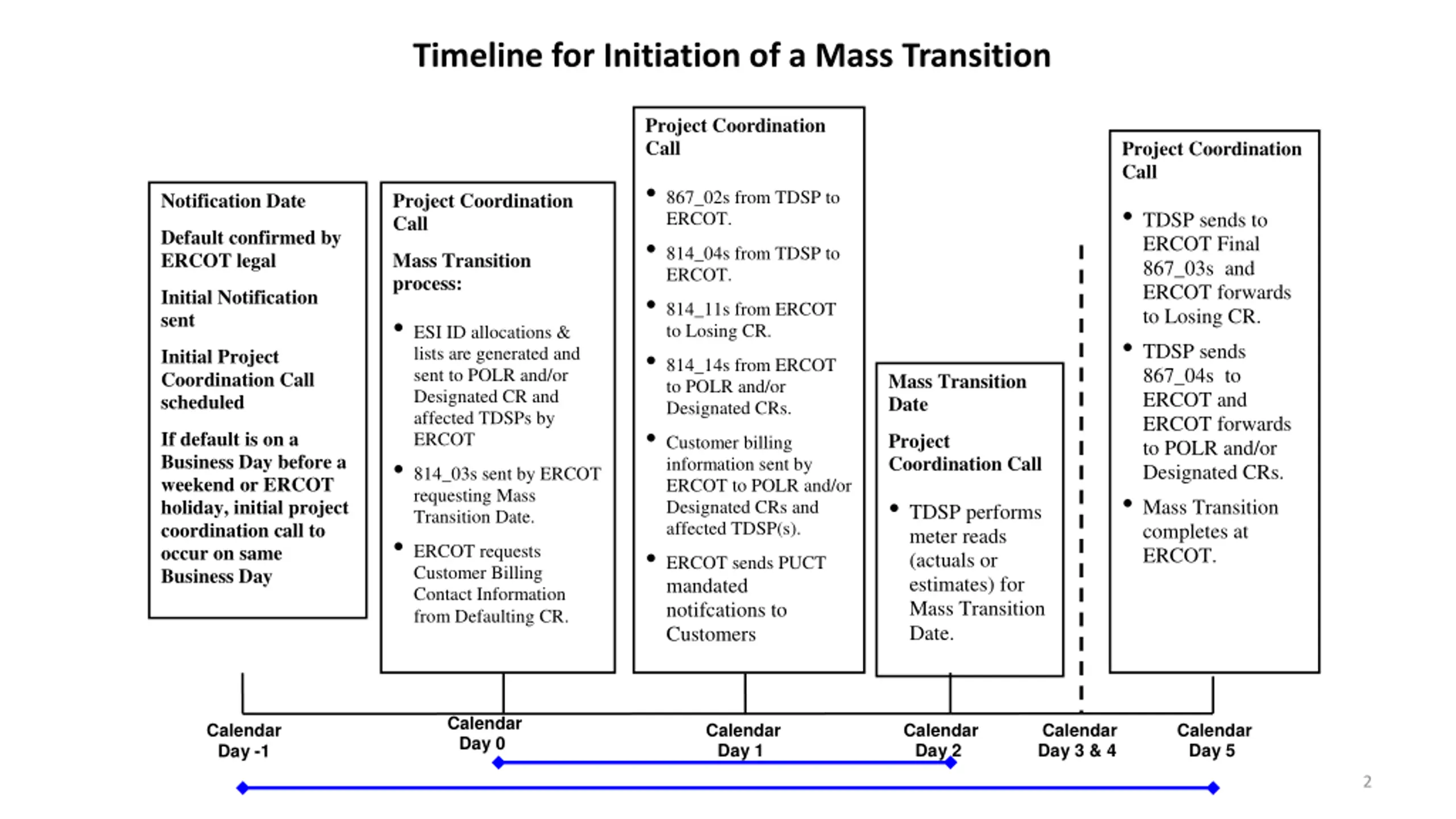

  2. Timeline for Initiation of a Mass Transition Project Coordination Call 867_02s from TDSP to ERCOT. 814_04s from TDSP to ERCOT. 814_11s from ERCOT to Losing CR. 814_14s from ERCOT to POLR and/or Designated CRs. Customer billing information sent by ERCOT to POLR and/or Designated CRs and affected TDSP(s). ERCOT sends PUCT mandated notifcations to Customers Project Coordination Call TDSP sends to ERCOT Final 867_03s and ERCOT forwards to Losing CR. TDSP sends 867_04s to ERCOT and ERCOT forwards to POLR and/or Designated CRs. Mass Transition completes at ERCOT. Notification Date Project Coordination Call Default confirmed by ERCOT legal Mass Transition process: ESI ID allocations & lists are generated and sent to POLR and/or Designated CR and affected TDSPs by ERCOT 814_03s sent by ERCOT requesting Mass Transition Date. ERCOT requests Customer Billing Contact Information from Defaulting CR. Initial Notification sent Initial Project Coordination Call scheduled Mass Transition Date If default is on a Business Day before a weekend or ERCOT holiday, initial project coordination call to occur on same Business Day Project Coordination Call TDSP performs meter reads (actuals or estimates) for Mass Transition Date. Calendar Day 0 Calendar Day -1 Calendar Day 1 Calendar Day 2 Calendar Day 3 & 4 Calendar Day 5 2

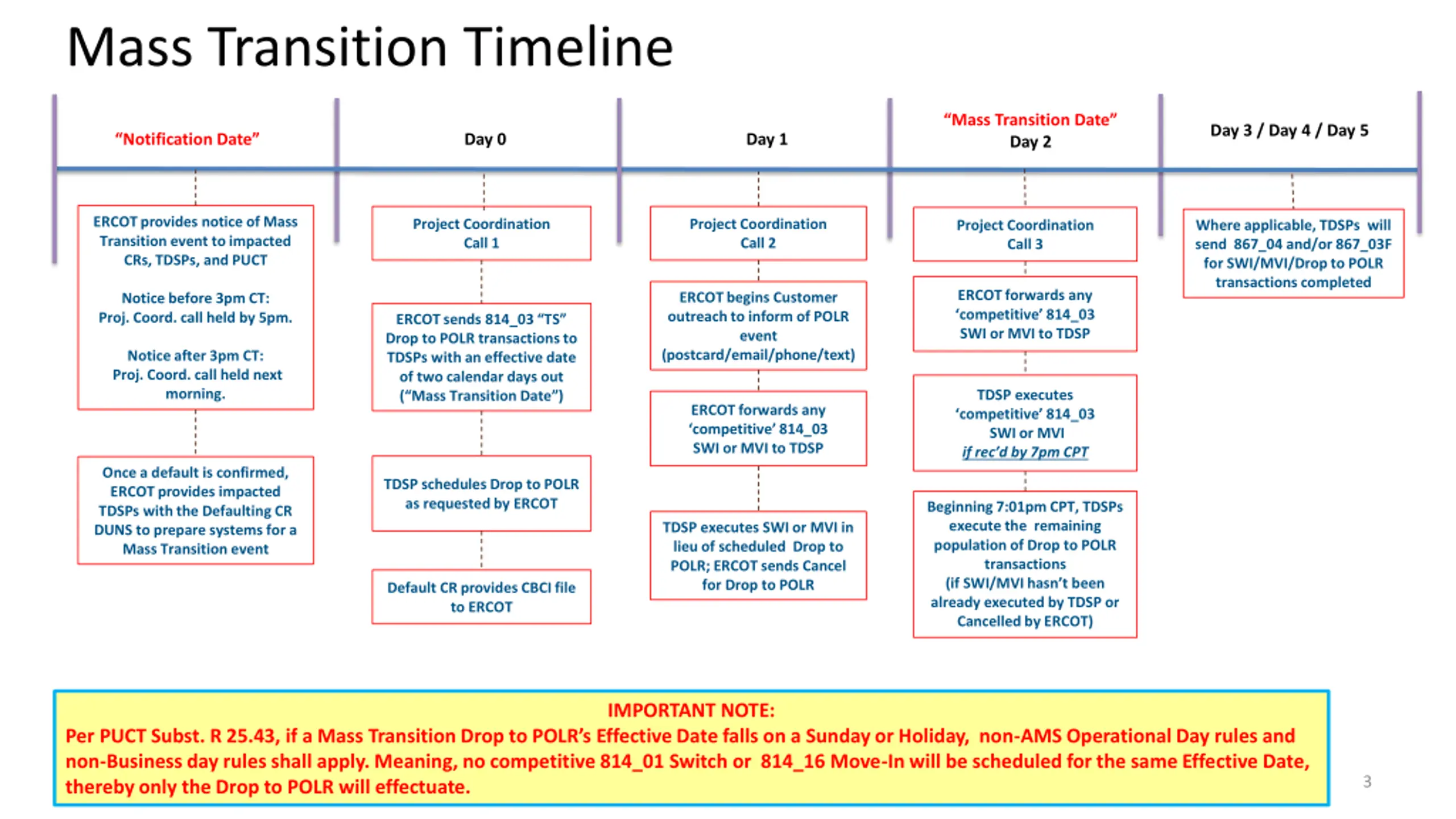

  3. Mass Transition Timeline Mass Transition Date Day 2 Day 3 / Day 4 / Day 5 Notification Date Day 0 Day 1 ERCOT provides notice of Mass Transition event to impacted CRs, TDSPs, and PUCT Project Coordination Call 1 Project Coordination Call 2 Where applicable, TDSPs will send 867_04 and/or 867_03F for SWI/MVI/Drop to POLR transactions completed Project Coordination Call 3 ERCOT forwards any competitive 814_03 SWI or MVI to TDSP ERCOT begins Customer outreach to inform of POLR event (postcard/email/phone/text) Notice before 3pm CT: Proj. Coord. call held by 5pm. ERCOT sends 814_03 TS Drop to POLR transactions to TDSPs with an effective date of two calendar days out ( Mass Transition Date ) Notice after 3pm CT: Proj. Coord. call held next morning. TDSP executes competitive 814_03 SWI or MVI if rec d by 7pm CPT ERCOT forwards any competitive 814_03 SWI or MVI to TDSP Once a default is confirmed, ERCOT provides impacted TDSPs with the Defaulting CR DUNS to prepare systems for a Mass Transition event TDSP schedules Drop to POLR as requested by ERCOT Beginning 7:01pm CPT, TDSPs execute the remaining population of Drop to POLR transactions (if SWI/MVI hasn t been already executed by TDSP or Cancelled by ERCOT) TDSP executes SWI or MVI in lieu of scheduled Drop to POLR; ERCOT sends Cancel for Drop to POLR Default CR provides CBCI file to ERCOT IMPORTANT NOTE: Per PUCT Subst. R 25.43, if a Mass Transition Drop to POLR s Effective Date falls on a Sunday or Holiday, non-AMS Operational Day rules and non-Business day rules shall apply. Meaning, no competitive 814_01 Switch or 814_16 Move-In will be scheduled for the same Effective Date, thereby only the Drop to POLR will effectuate. 3

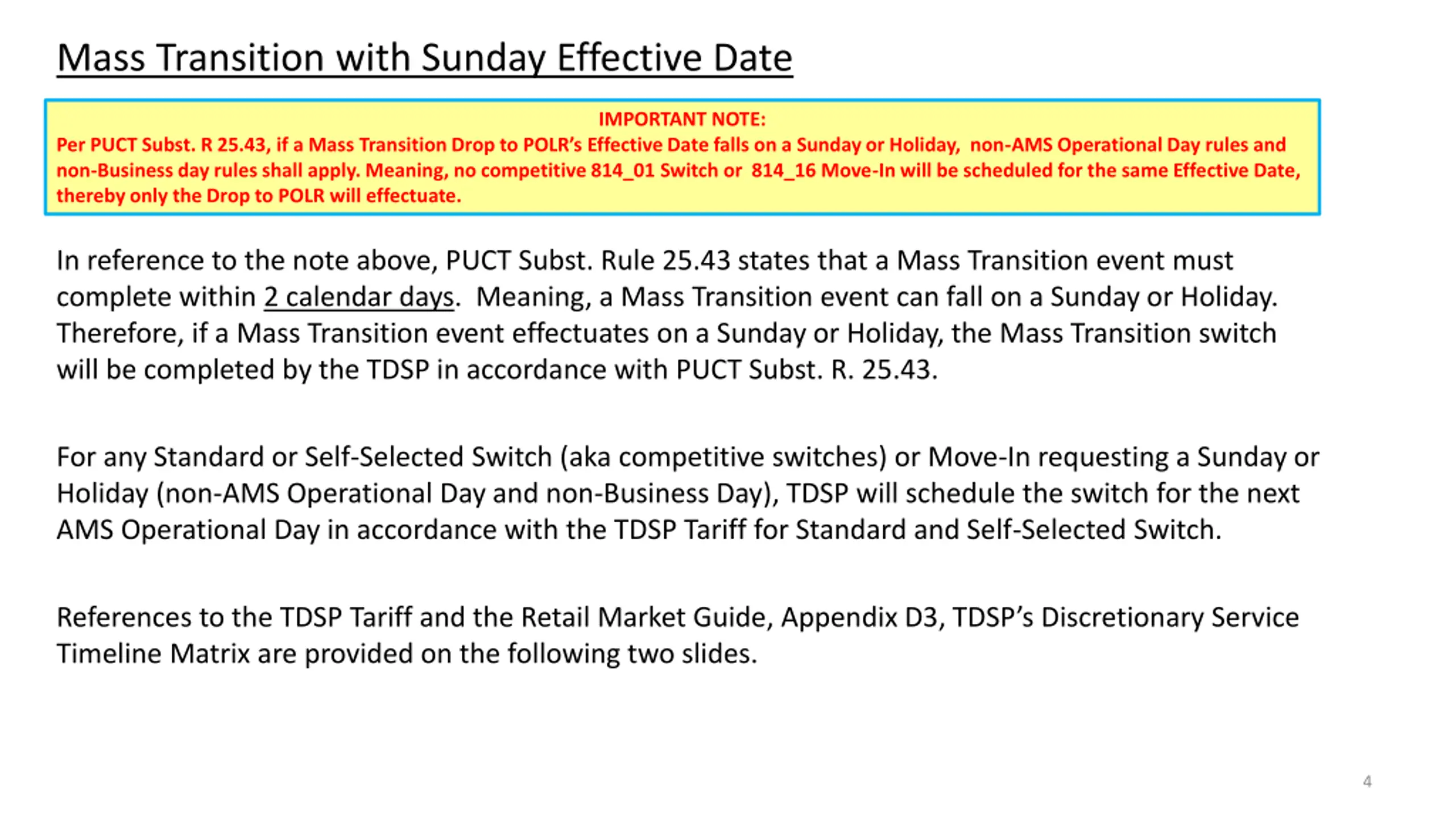

  4. Mass Transition with Sunday Effective Date IMPORTANT NOTE: Per PUCT Subst. R 25.43, if a Mass Transition Drop to POLR s Effective Date falls on a Sunday or Holiday, non-AMS Operational Day rules and non-Business day rules shall apply. Meaning, no competitive 814_01 Switch or 814_16 Move-In will be scheduled for the same Effective Date, thereby only the Drop to POLR will effectuate. In reference to the note above, PUCT Subst. Rule 25.43 states that a Mass Transition event must complete within 2 calendar days. Meaning, a Mass Transition event can fall on a Sunday or Holiday. Therefore, if a Mass Transition event effectuates on a Sunday or Holiday, the Mass Transition switch will be completed by the TDSP in accordance with PUCT Subst. R. 25.43. For any Standard or Self-Selected Switch (aka competitive switches) or Move-In requesting a Sunday or Holiday (non-AMS Operational Day and non-Business Day), TDSP will schedule the switch for the next AMS Operational Day in accordance with the TDSP Tariff for Standard and Self-Selected Switch. References to the TDSP Tariff and the Retail Market Guide, Appendix D3, TDSP s Discretionary Service Timeline Matrix are provided on the following two slides. 4

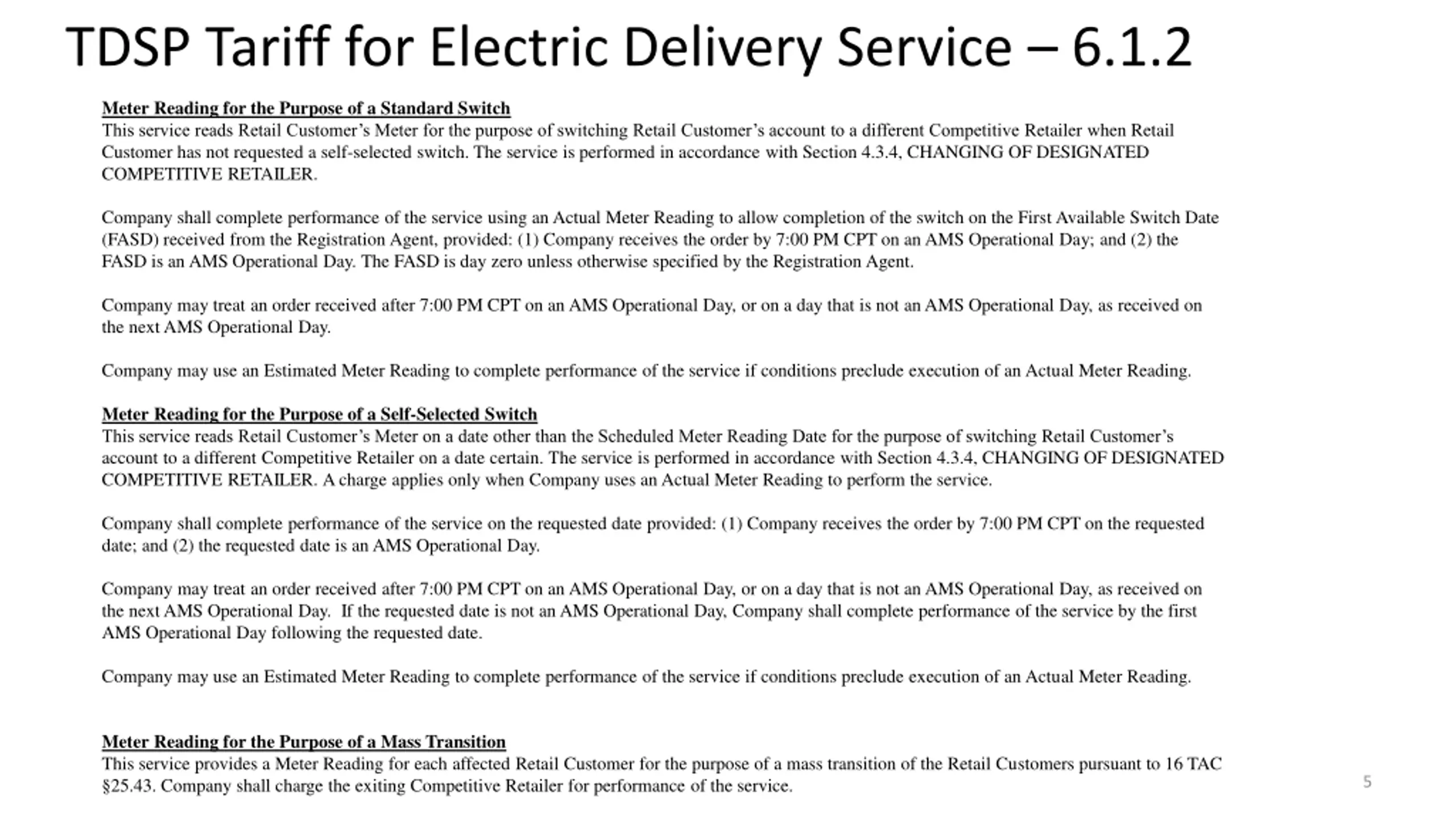

  5. TDSP Tariff for Electric Delivery Service 6.1.2 Meter Reading for the Purpose of a Standard Switch This service reads Retail Customer s Meter for the purpose of switching Retail Customer s account to a different Competitive Retailer when Retail Customer has not requested a self-selected switch. The service is performed in accordance with Section 4.3.4, CHANGING OF DESIGNATED COMPETITIVE RETAILER. Company shall complete performance of the service using an Actual Meter Reading to allow completion of the switch on the First Available Switch Date (FASD) received from the Registration Agent, provided: (1) Company receives the order by 7:00 PM CPT on an AMS Operational Day; and (2) the FASD is an AMS Operational Day. The FASD is day zero unless otherwise specified by the Registration Agent. Company may treat an order received after 7:00 PM CPT on an AMS Operational Day, or on a day that is not an AMS Operational Day, as received on the next AMS Operational Day. Company may use an Estimated Meter Reading to complete performance of the service if conditions preclude execution of an Actual Meter Reading. Meter Reading for the Purpose of a Self-Selected Switch This service reads Retail Customer s Meter on a date other than the Scheduled Meter Reading Date for the purpose of switching Retail Customer s account to a different Competitive Retailer on a date certain. The service is performed in accordance with Section 4.3.4, CHANGING OF DESIGNATED COMPETITIVE RETAILER. A charge applies only when Company uses an Actual Meter Reading to perform the service. Company shall complete performance of the service on the requested date provided: (1) Company receives the order by 7:00 PM CPT on the requested date; and (2) the requested date is an AMS Operational Day. Company may treat an order received after 7:00 PM CPT on an AMS Operational Day, or on a day that is not an AMS Operational Day, as received on the next AMS Operational Day. If the requested date is not an AMS Operational Day, Company shall complete performance of the service by the first AMS Operational Day following the requested date. Company may use an Estimated Meter Reading to complete performance of the service if conditions preclude execution of an Actual Meter Reading. Meter Reading for the Purpose of a Mass Transition This service provides a Meter Reading for each affected Retail Customer for the purpose of a mass transition of the Retail Customers pursuant to 16 TAC 25.43. Company shall charge the exiting Competitive Retailer for performance of the service. 5

  6. Retail Market Guide, Appendix D3 6

  7. Market Communications

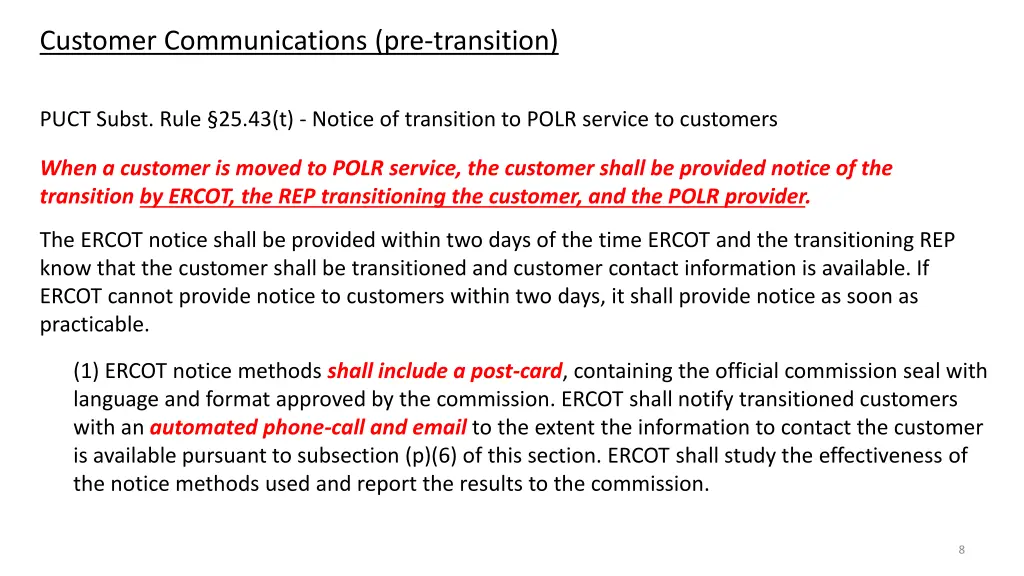

  8. Customer Communications (pre-transition) PUCT Subst. Rule 25.43(t) - Notice of transition to POLR service to customers When a customer is moved to POLR service, the customer shall be provided notice of the transition by ERCOT, the REP transitioning the customer, and the POLR provider. The ERCOT notice shall be provided within two days of the time ERCOT and the transitioning REP know that the customer shall be transitioned and customer contact information is available. If ERCOT cannot provide notice to customers within two days, it shall provide notice as soon as practicable. (1) ERCOT notice methods shall include a post-card, containing the official commission seal with language and format approved by the commission. ERCOT shall notify transitioned customers with an automated phone-call and email to the extent the information to contact the customer is available pursuant to subsection (p)(6) of this section. ERCOT shall study the effectiveness of the notice methods used and report the results to the commission. 8

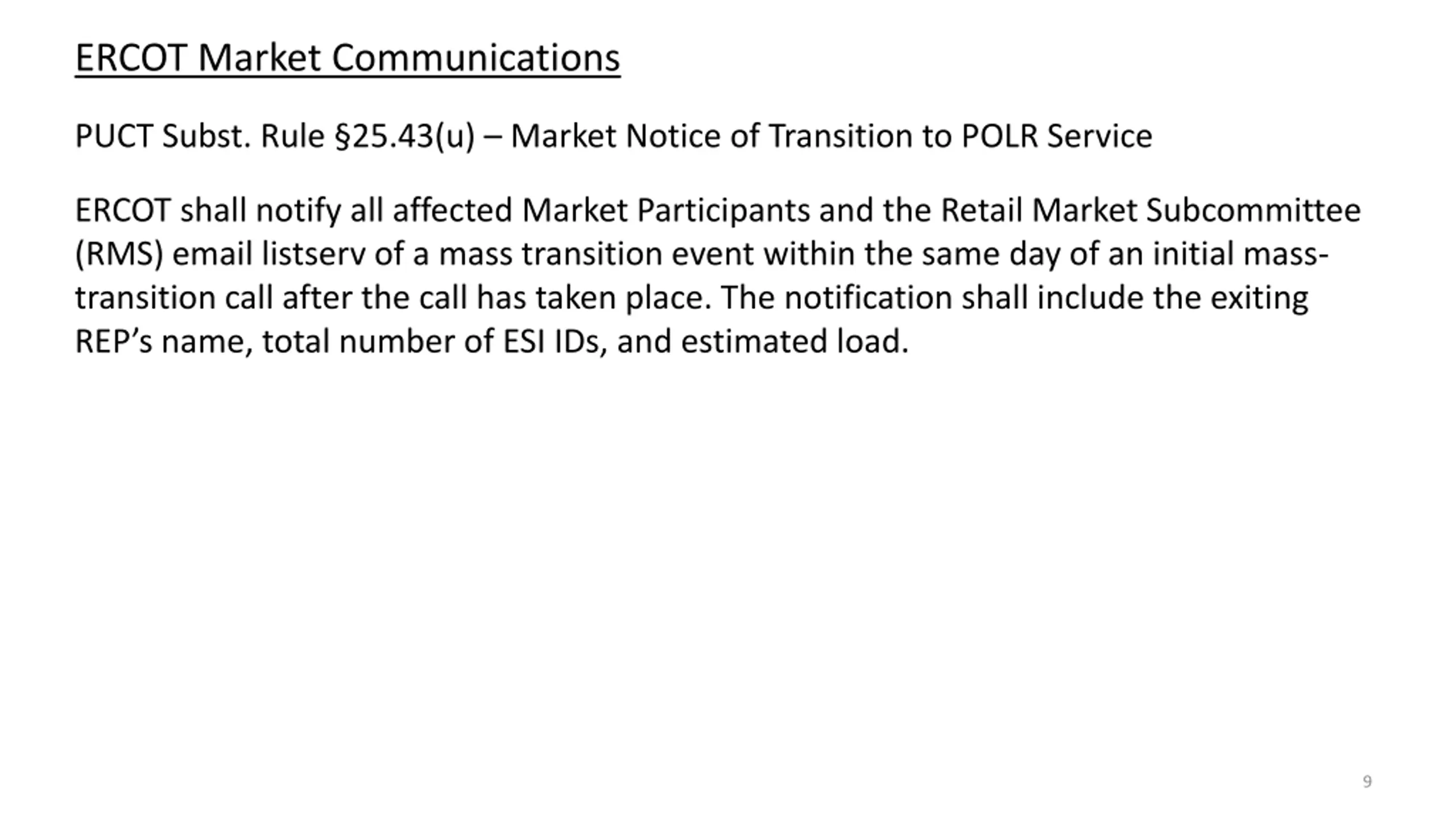

  9. ERCOT Market Communications PUCT Subst. Rule 25.43(u) Market Notice of Transition to POLR Service ERCOT shall notify all affected Market Participants and the Retail Market Subcommittee (RMS) email listserv of a mass transition event within the same day of an initial mass- transition call after the call has taken place. The notification shall include the exiting REP s name, total number of ESI IDs, and estimated load. 9

  10. Questions? 10
