MVTX Status and Plan Update for sPHENIX Project
"Stay informed about the latest updates and plans for the MVTX project under sPHENIX, including budget updates, contingency policies, and milestones alignment. Explore updated documents and progress reports to track the project's development."
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
MVTX Status and Plan Ming Liu 08/16/2019 4/13/2025 MVTX bi-weekly 1

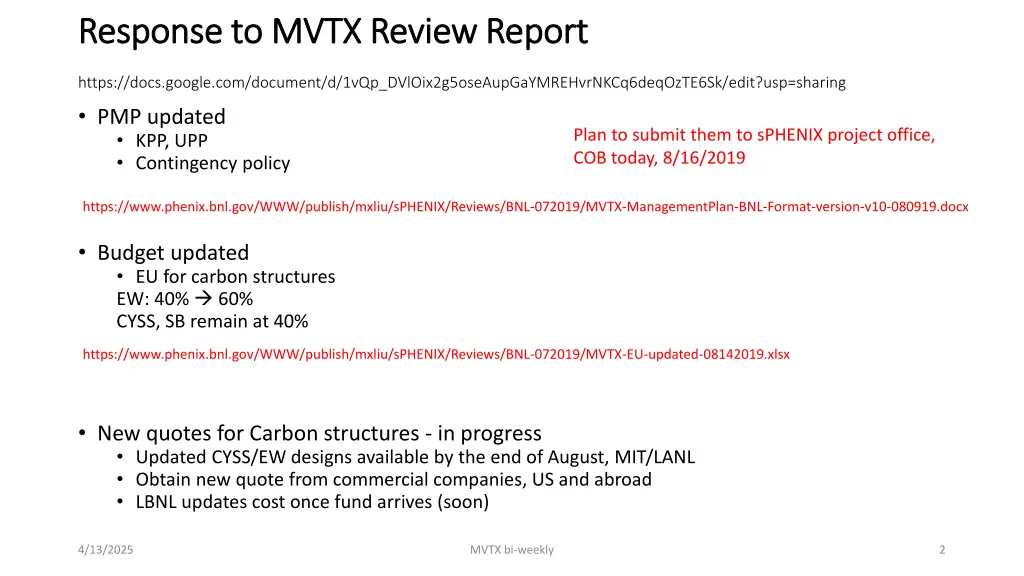

Response to MVTX Review Report Response to MVTX Review Report https://docs.google.com/document/d/1vQp_DVlOix2g5oseAupGaYMREHvrNKCq6deqOzTE6Sk/edit?usp=sharing PMP updated KPP, UPP Contingency policy Plan to submit them to sPHENIX project office, COB today, 8/16/2019 https://www.phenix.bnl.gov/WWW/publish/mxliu/sPHENIX/Reviews/BNL-072019/MVTX-ManagementPlan-BNL-Format-version-v10-080919.docx Budget updated EU for carbon structures EW: 40% 60% CYSS, SB remain at 40% https://www.phenix.bnl.gov/WWW/publish/mxliu/sPHENIX/Reviews/BNL-072019/MVTX-EU-updated-08142019.xlsx New quotes for Carbon structures - in progress Updated CYSS/EW designs available by the end of August, MIT/LANL Obtain new quote from commercial companies, US and abroad LBNL updates cost once fund arrives (soon) 4/13/2025 MVTX bi-weekly 2

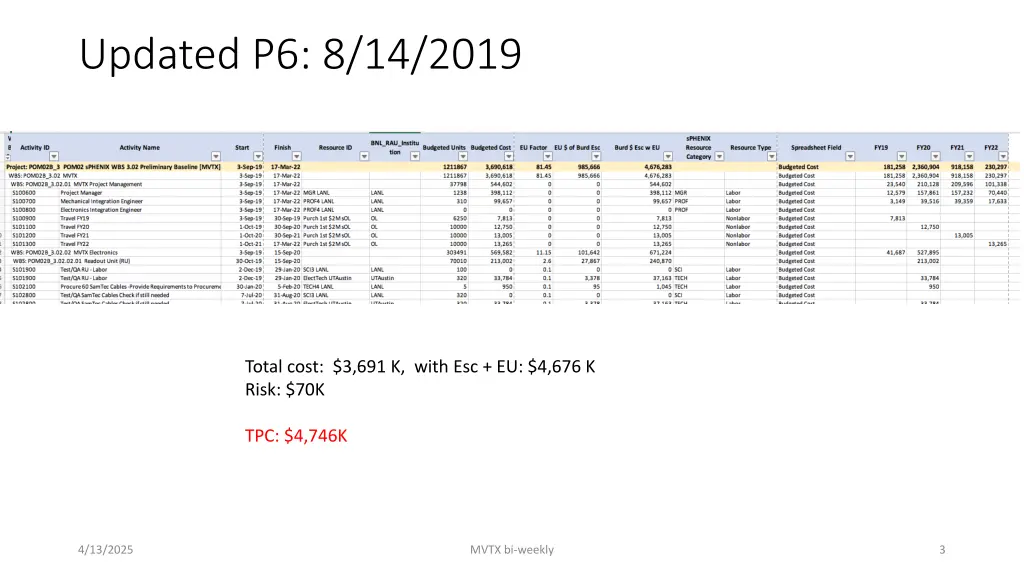

Updated P6: 8/14/2019 Total cost: $3,691 K, with Esc + EU: $4,676 K Risk: $70K TPC: $4,746K 4/13/2025 MVTX bi-weekly 3

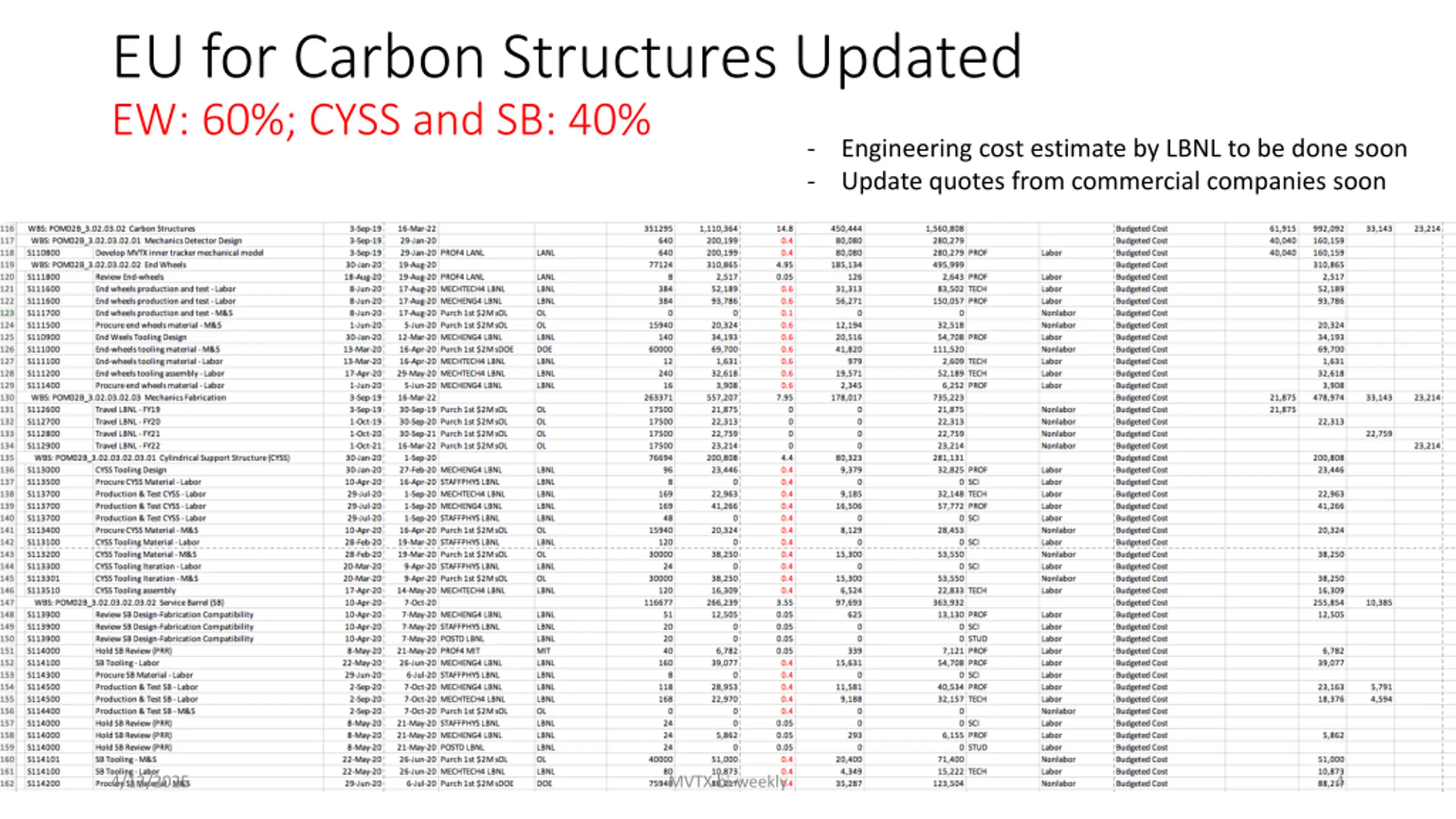

EU for Carbon Structures Updated EW: 60%; CYSS and SB: 40% - - Engineering cost estimate by LBNL to be done soon Update quotes from commercial companies soon 4/13/2025 MVTX bi-weekly 4

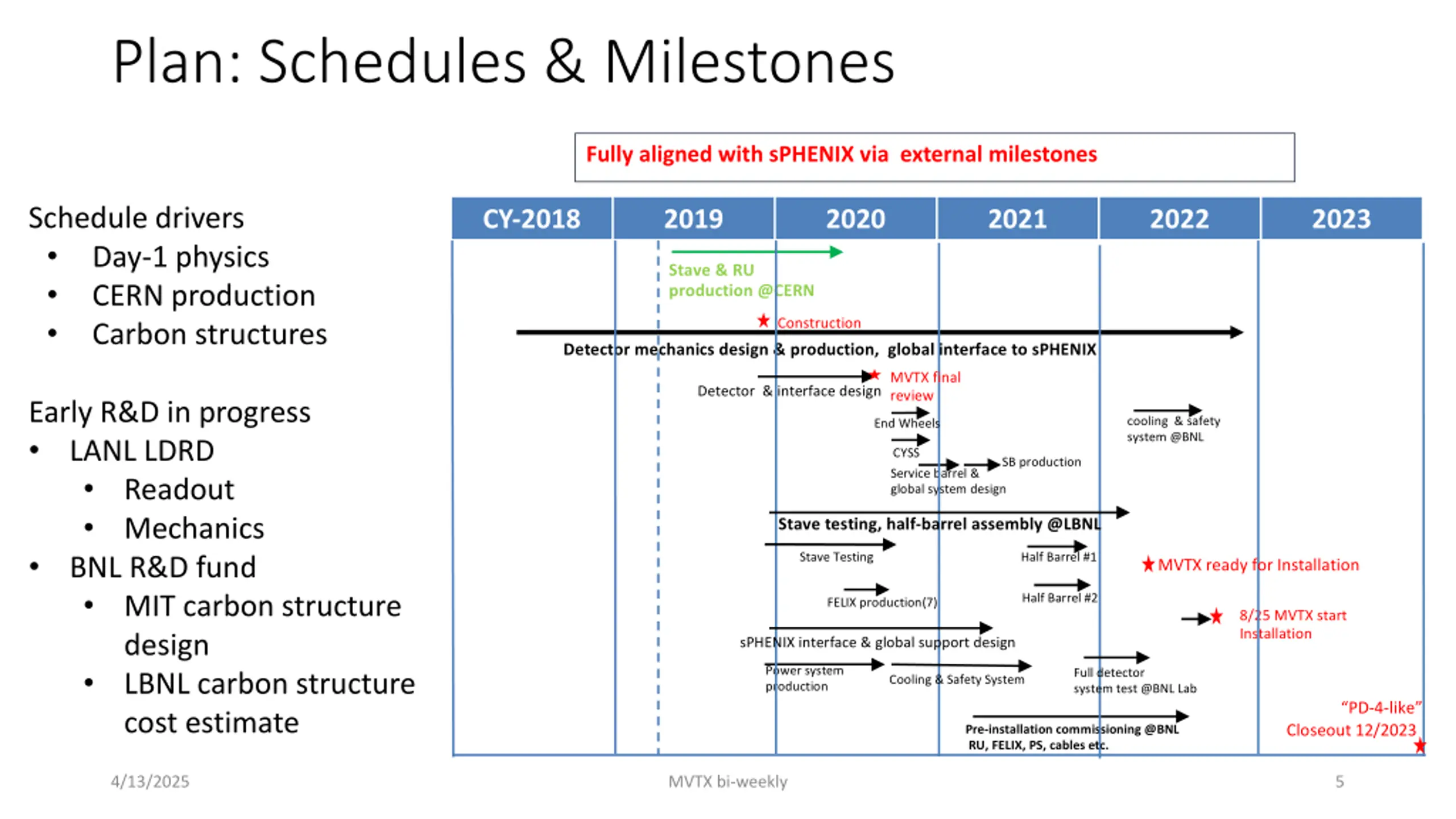

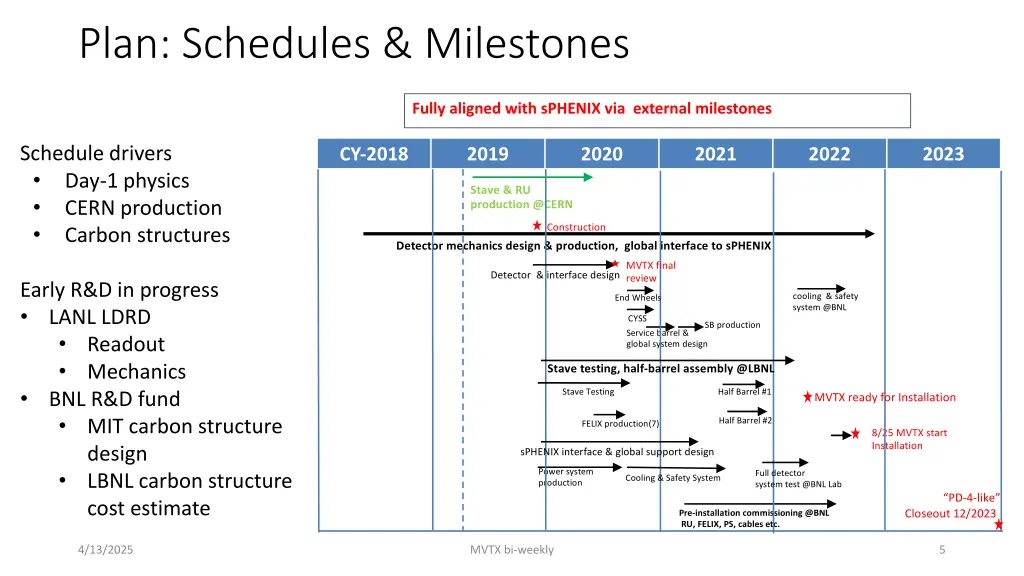

Plan: Schedules & Milestones Fully aligned with sPHENIX via external milestones Schedule drivers Day-1 physics CERN production Carbon structures CY-2018 2019 2020 2021 2022 2023 Stave & RU production @CERN Construction Detector mechanics design & production, global interface to sPHENIX MVTX final review Detector & interface design Early R&D in progress LANL LDRD Readout Mechanics BNL R&D fund MIT carbon structure design LBNL carbon structure cost estimate cooling & safety system @BNL End Wheels CYSS SB production Service barrel & global system design Stave testing, half-barrel assembly @LBNL Stave Testing Half Barrel #1 MVTX ready for Installation Half Barrel #2 FELIX production(7) 8/25 MVTX start Installation sPHENIX interface & global support design Power system production Full detector system test @BNL Lab Cooling & Safety System PD-4-like Closeout 12/2023 Pre-installation commissioning @BNL RU, FELIX, PS, cables etc. 4/13/2025 MVTX bi-weekly 5

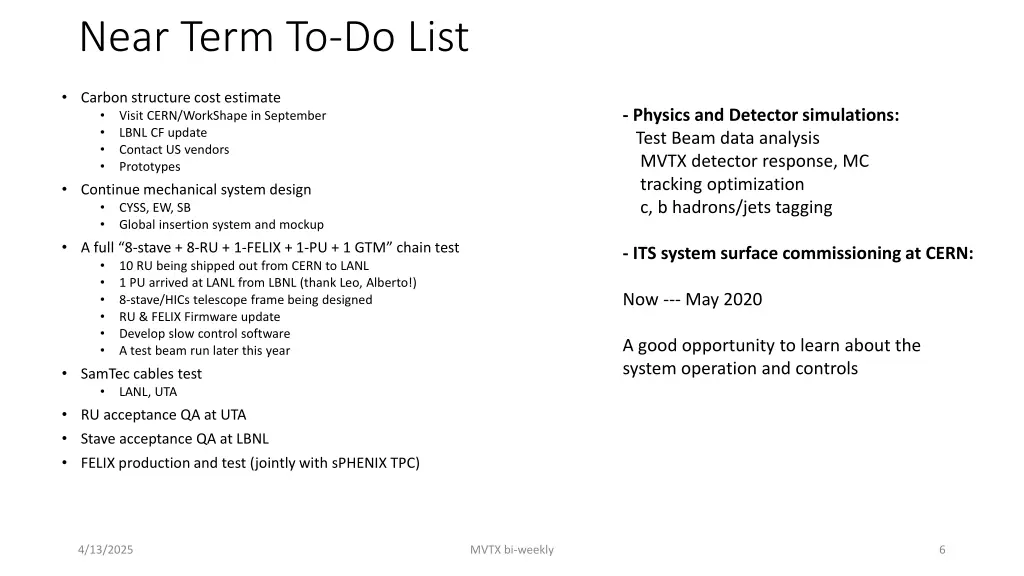

Near Term To-Do List Carbon structure cost estimate Visit CERN/WorkShape in September LBNL CF update Contact US vendors Prototypes Continue mechanical system design CYSS, EW, SB Global insertion system and mockup A full 8-stave + 8-RU + 1-FELIX + 1-PU + 1 GTM chain test 10 RU being shipped out from CERN to LANL 1 PU arrived at LANL from LBNL (thank Leo, Alberto!) 8-stave/HICs telescope frame being designed RU & FELIX Firmware update Develop slow control software A test beam run later this year SamTec cables test LANL, UTA RU acceptance QA at UTA Stave acceptance QA at LBNL FELIX production and test (jointly with sPHENIX TPC) - Physics and Detector simulations: Test Beam data analysis MVTX detector response, MC tracking optimization c, b hadrons/jets tagging - ITS system surface commissioning at CERN: Now --- May 2020 A good opportunity to learn about the system operation and controls 4/13/2025 MVTX bi-weekly 6

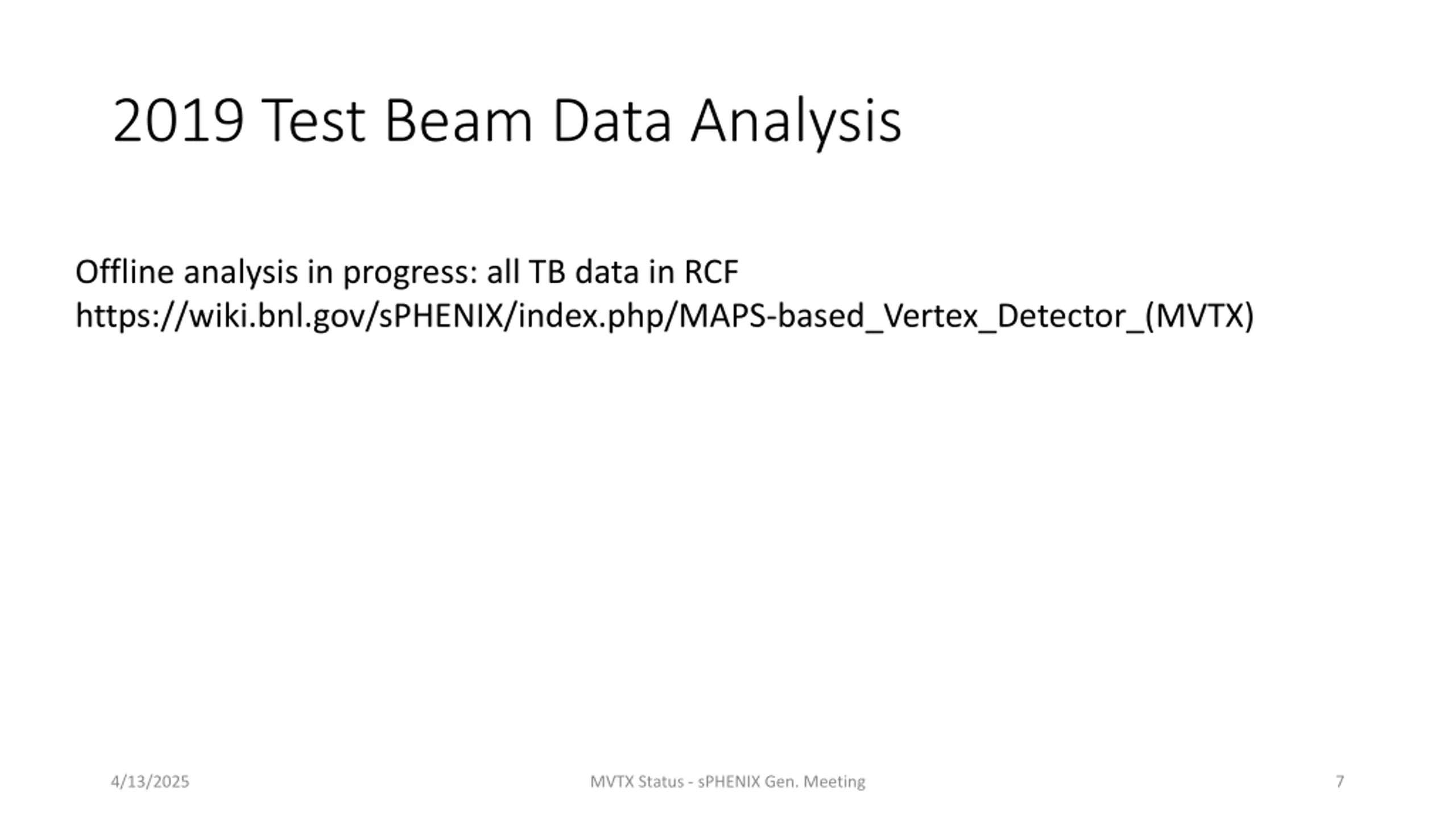

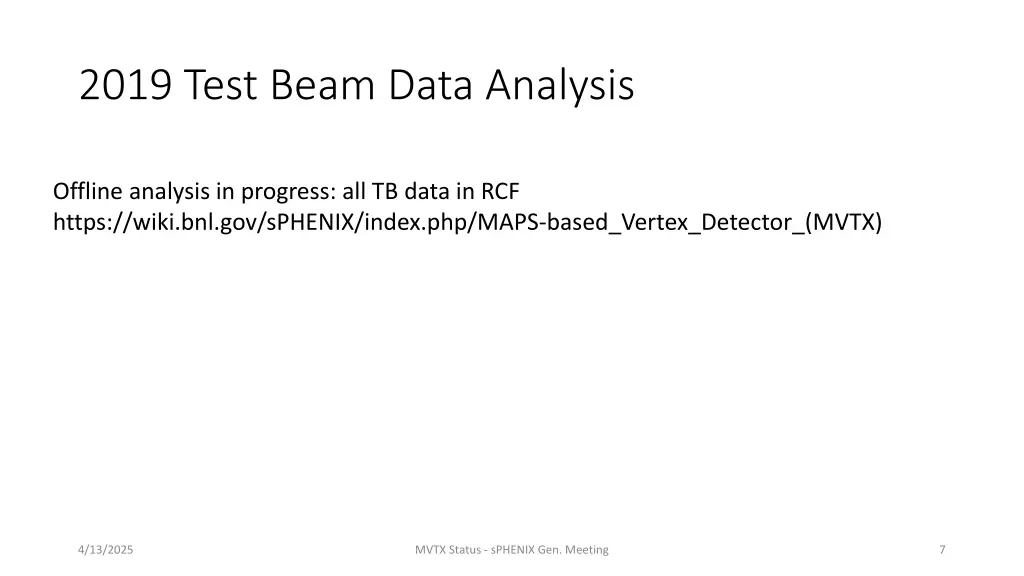

2019 Test Beam Data Analysis Offline analysis in progress: all TB data in RCF https://wiki.bnl.gov/sPHENIX/index.php/MAPS-based_Vertex_Detector_(MVTX) 4/13/2025 MVTX Status - sPHENIX Gen. Meeting 7
