NBCC (India) Limited
Construction and rectification progress report for the Crystal Homes project in Noida, Uttar Pradesh. Details include completion schedules for unfinished flats, external MEP works, and external development works. Progress photographs show blockwork, brickwork, conduit work, reinforcement work, and firefighting work in progress.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
NBCC (India) Limited (A Govt. of India Enterprise) PROGRESS REPORT CRYSTAL HOMES NOVEMBER 2020
Project Name:Construction/Rectification of Balance works / Left Out works of SILICON CITY PHASE -3 (CRYSTAL HOMES). Plot no. GH- 01, Sector-76,Noida, Uttar Pradesh.

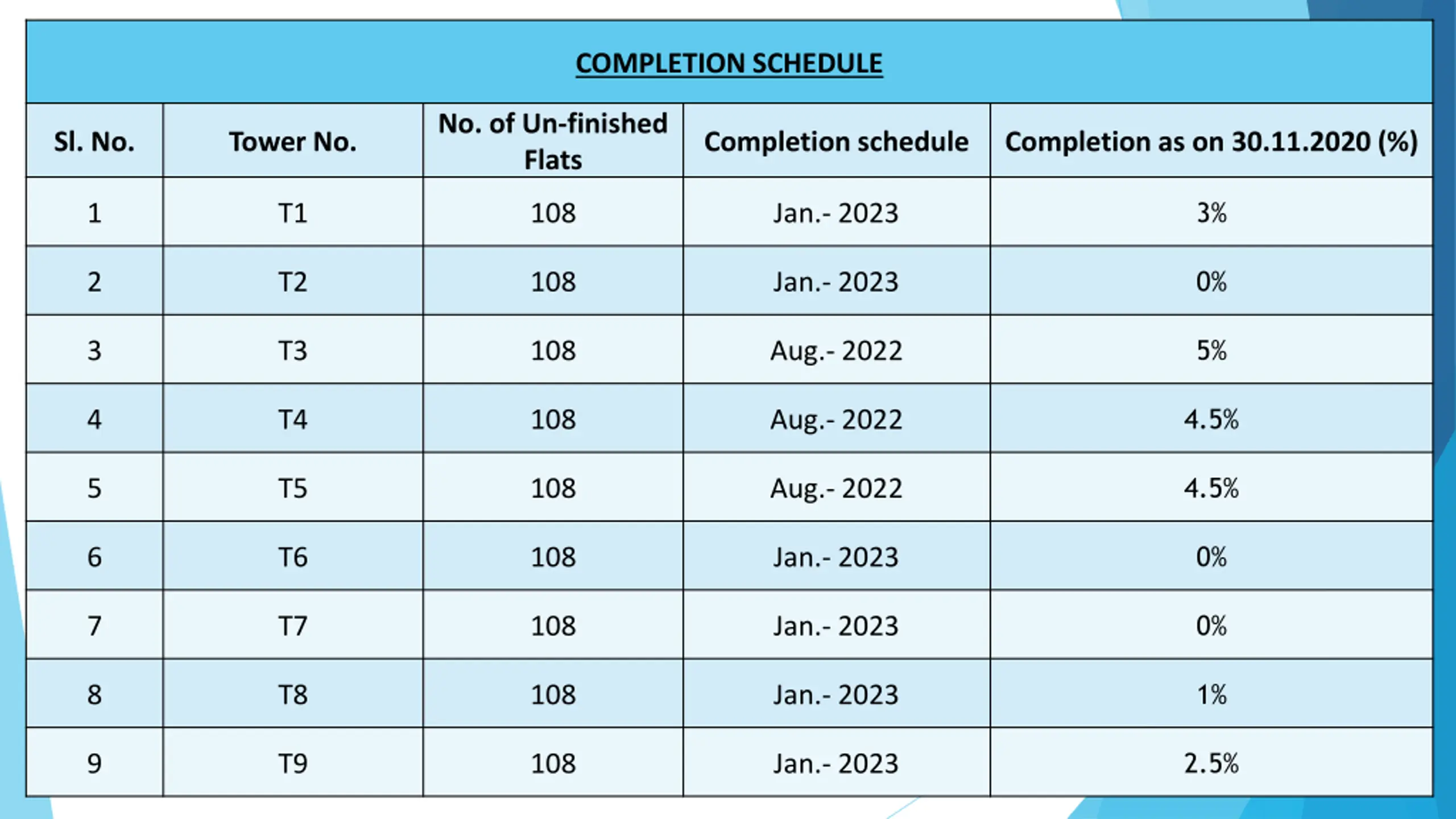

COMPLETION SCHEDULE No. of Un-finished Flats Sl. No. Tower No. Completion schedule Completion as on 30.11.2020 (%) 3% 1 T1 108 Jan.- 2023 0% 2 T2 108 Jan.- 2023 5% 3 T3 108 Aug.- 2022 4.5% 4 T4 108 Aug.- 2022 4.5% 5 T5 108 Aug.- 2022 0% 6 T6 108 Jan.- 2023 0% 7 T7 108 Jan.- 2023 1% 8 T8 108 Jan.- 2023 2.5% 9 T9 108 Jan.- 2023

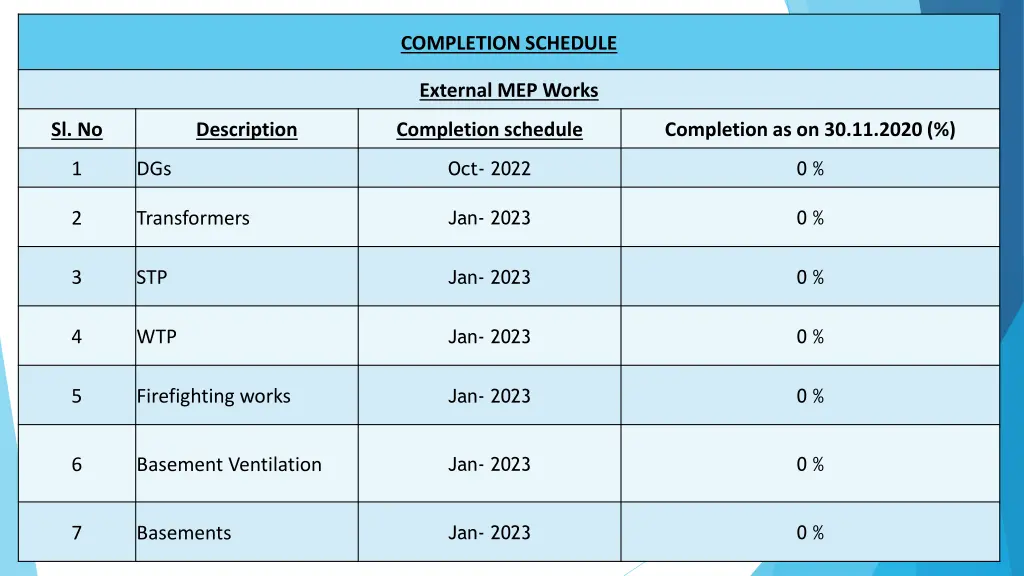

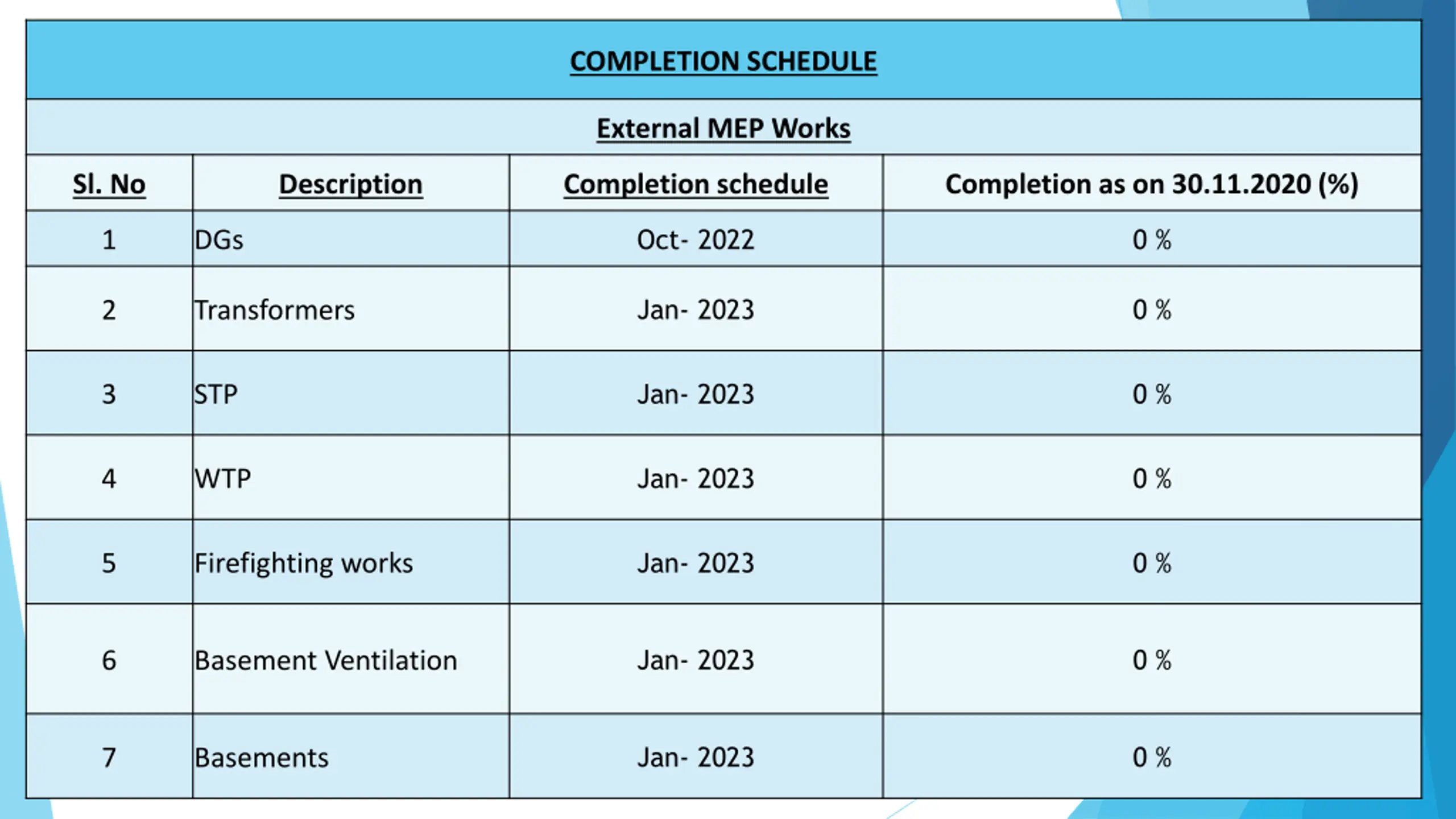

COMPLETION SCHEDULE External MEP Works Sl. No Description Completion schedule Completion as on 30.11.2020 (%) Oct- 2022 0 % 1 DGs Jan- 2023 0 % 2 Transformers Jan- 2023 0 % 3 STP Jan- 2023 0 % 4 WTP Jan- 2023 0 % 5 Firefighting works Jan- 2023 0 % 6 Basement Ventilation Jan- 2023 0 % 7 Basements

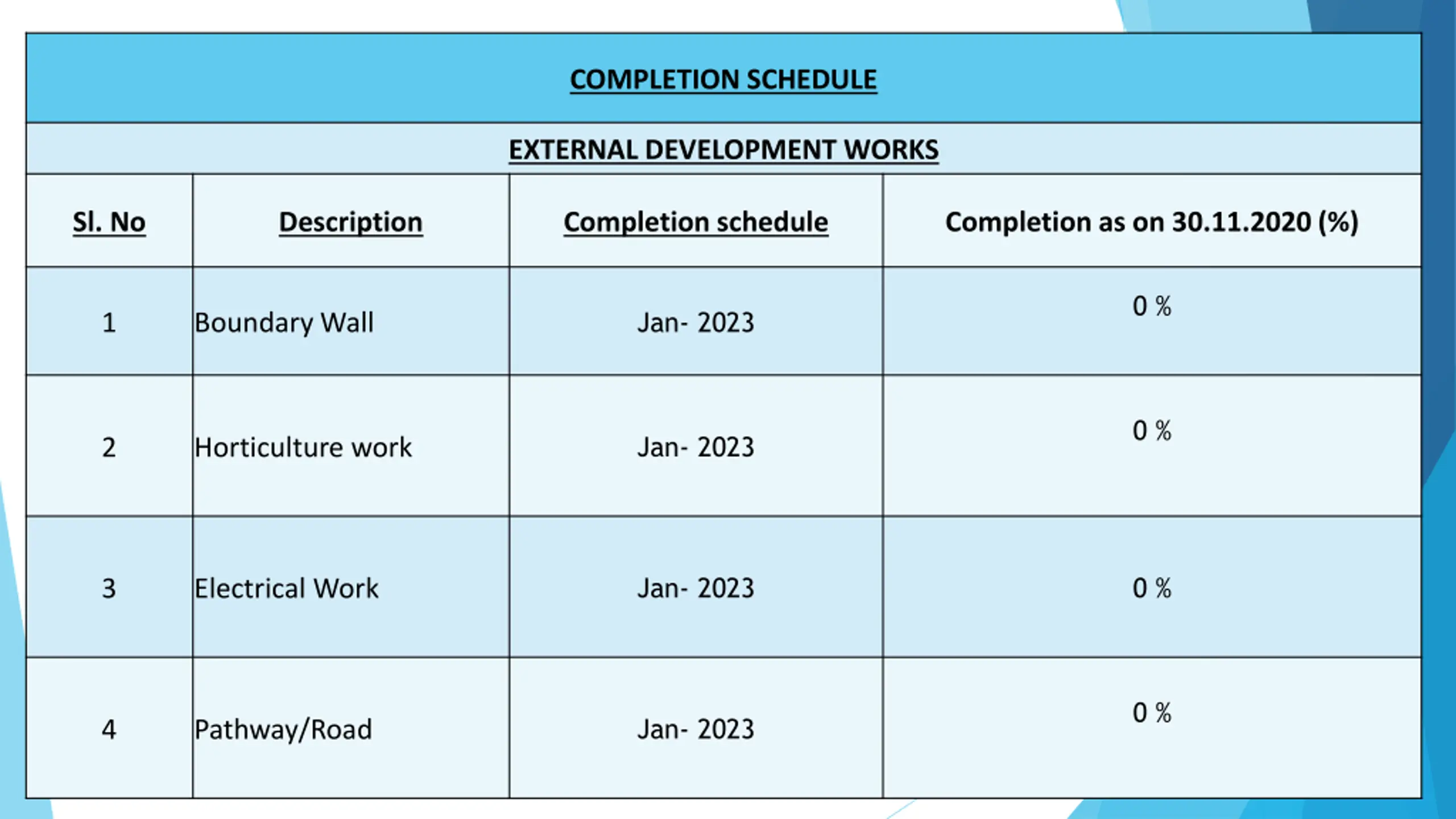

COMPLETION SCHEDULE EXTERNAL DEVELOPMENT WORKS Sl. No Description Completion schedule Completion as on 30.11.2020 (%) 0 % Jan- 2023 1 Boundary Wall 0 % Jan- 2023 2 Horticulture work Jan- 2023 0 % 3 Electrical Work 0 % Jan- 2023 4 Pathway/Road

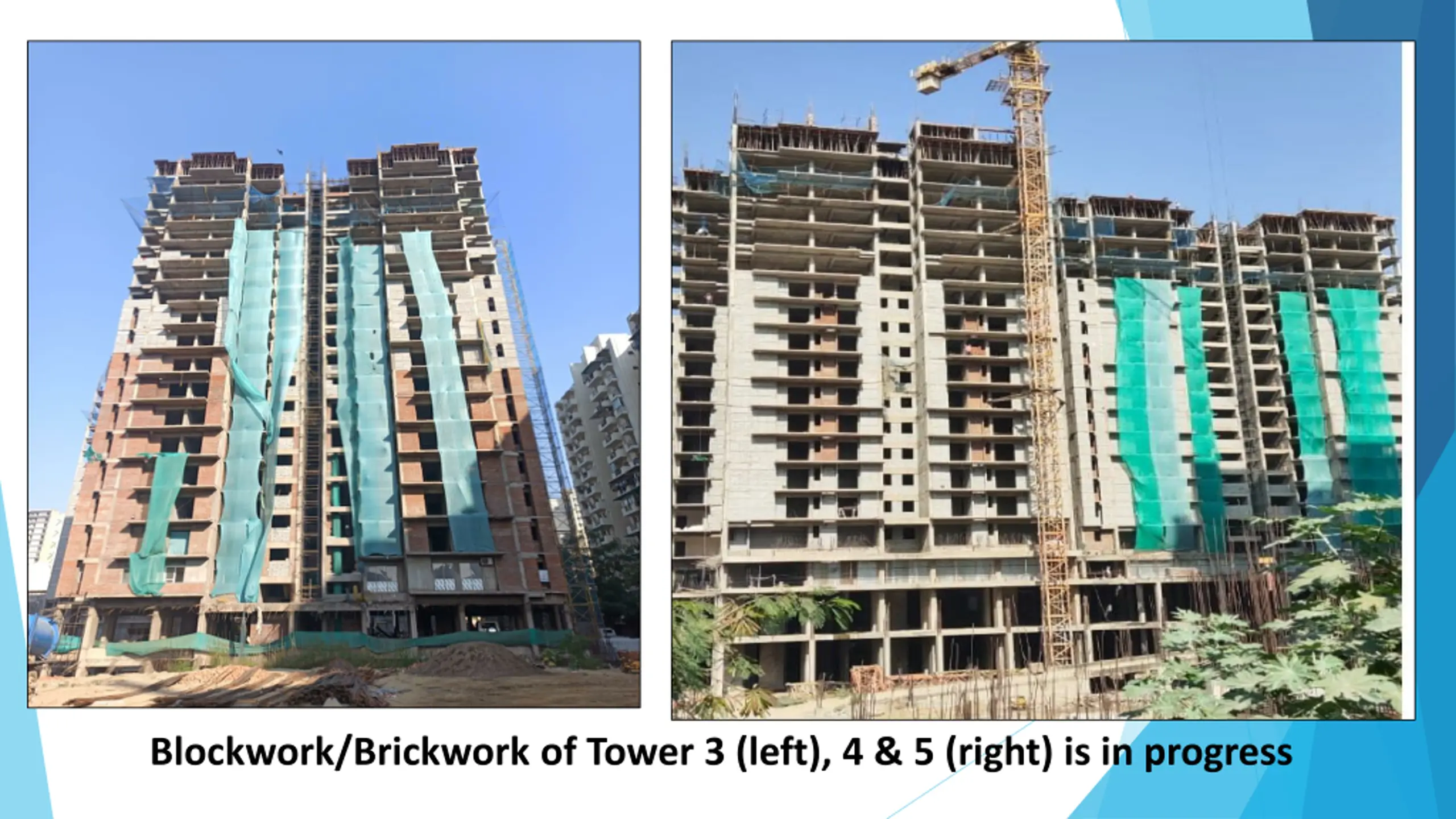

Blockwork/Brickwork of Tower 3 (left), 4 & 5 (right) is in progress
