Ohio Department of Transportation Consultant Evaluation System Changes 2014 Details
Explore the changes in the Ohio Department of Transportation Consultant Evaluation System in 2014, including the transition from a 10-8-5-1 rating scale to a 1-10 scale. Learn about the implementation schedule, plan, and new rating scales for project management and feedback forms.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
Ohio Department of Transportation Consultant Evaluation System Scoring System Changes 2014

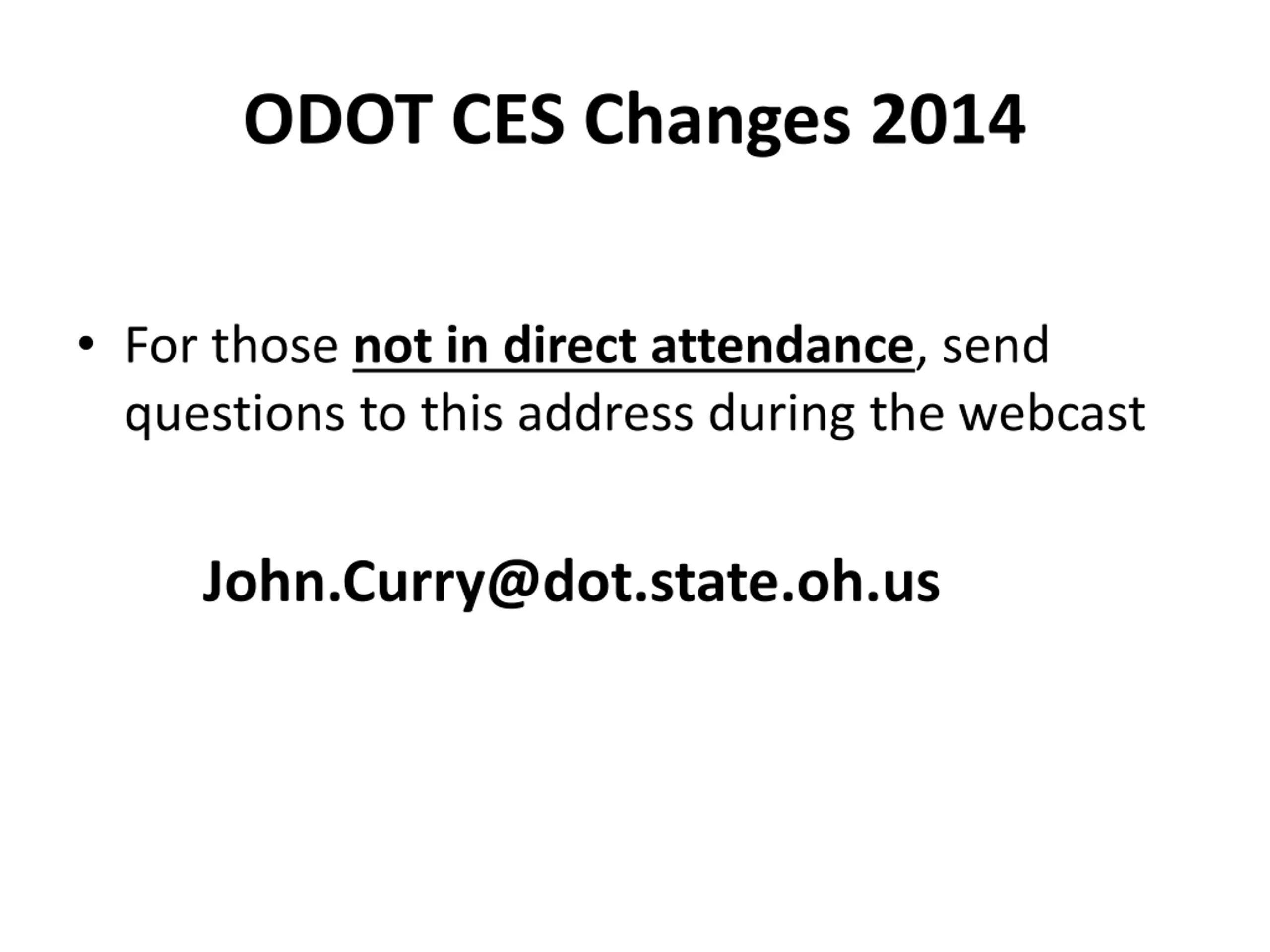

ODOT CES Changes 2014 For those not in direct attendance, send questions to this address during the webcast John.Curry@dot.state.oh.us

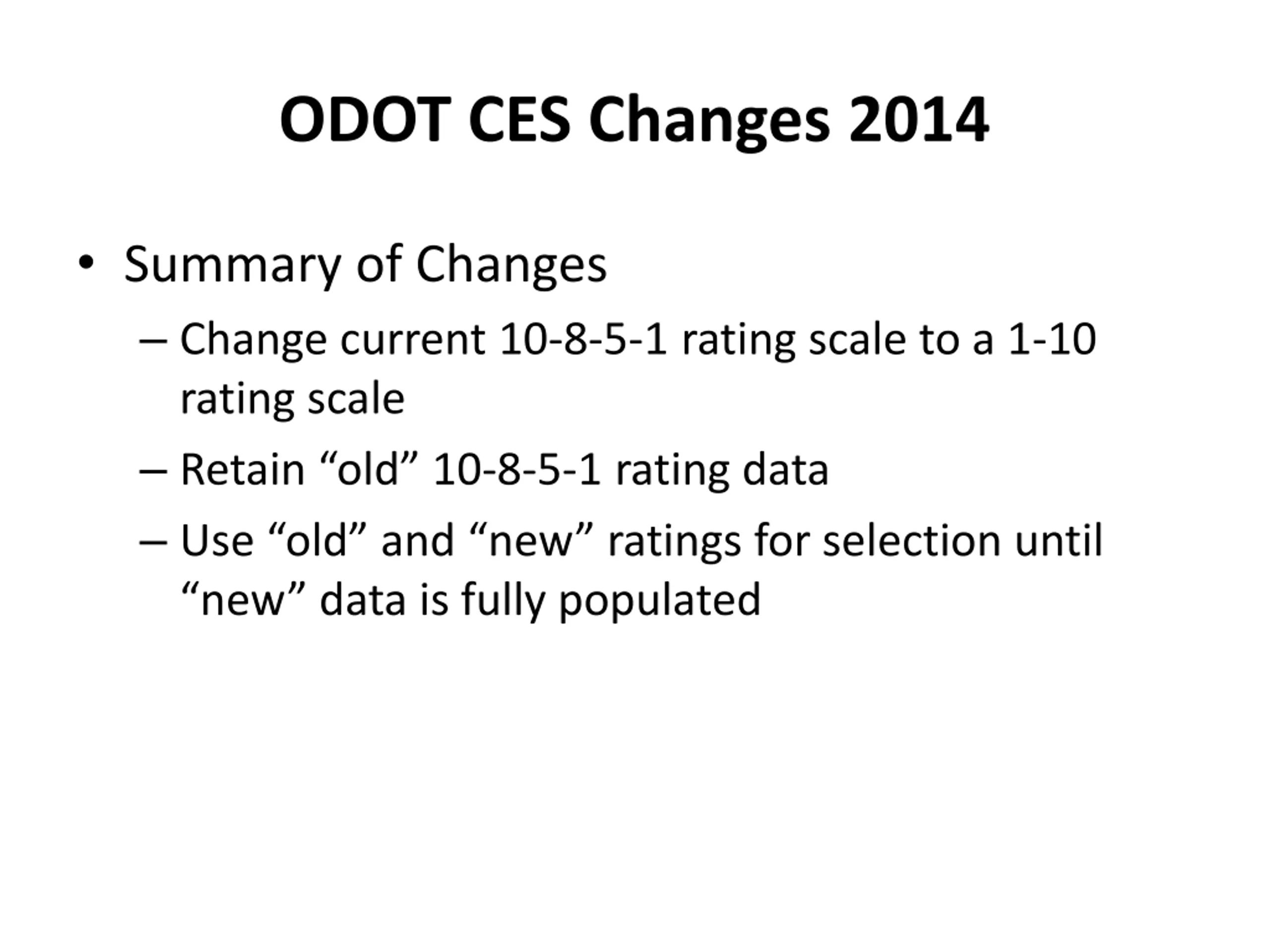

ODOT CES Changes 2014 Summary of Changes Change current 10-8-5-1 rating scale to a 1-10 rating scale Retain old 10-8-5-1 rating data Use old and new ratings for selection until new data is fully populated

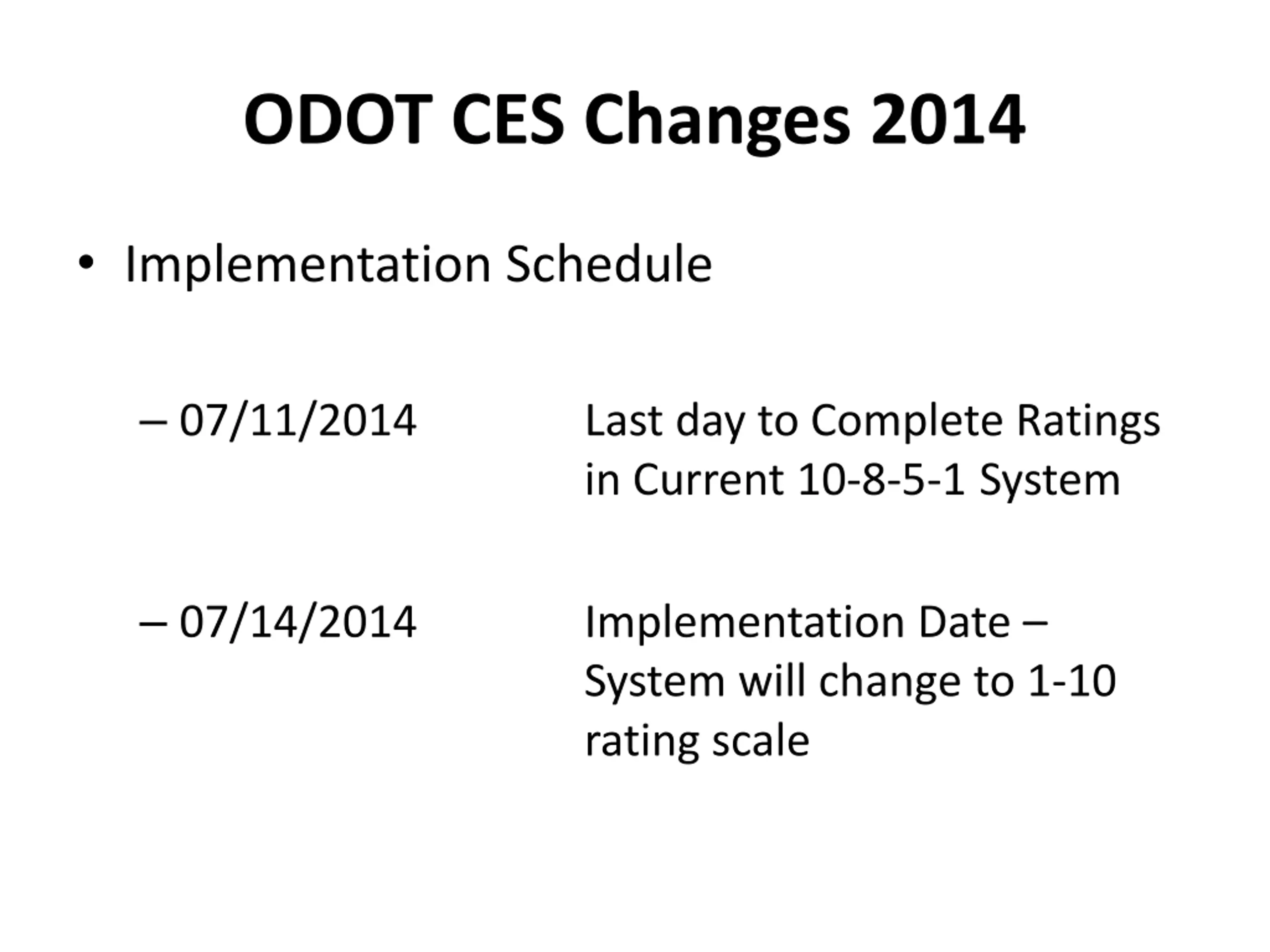

ODOT CES Changes 2014 Implementation Schedule 07/11/2014 Last day to Complete Ratings in Current 10-8-5-1 System 07/14/2014 Implementation Date System will change to 1-10 rating scale

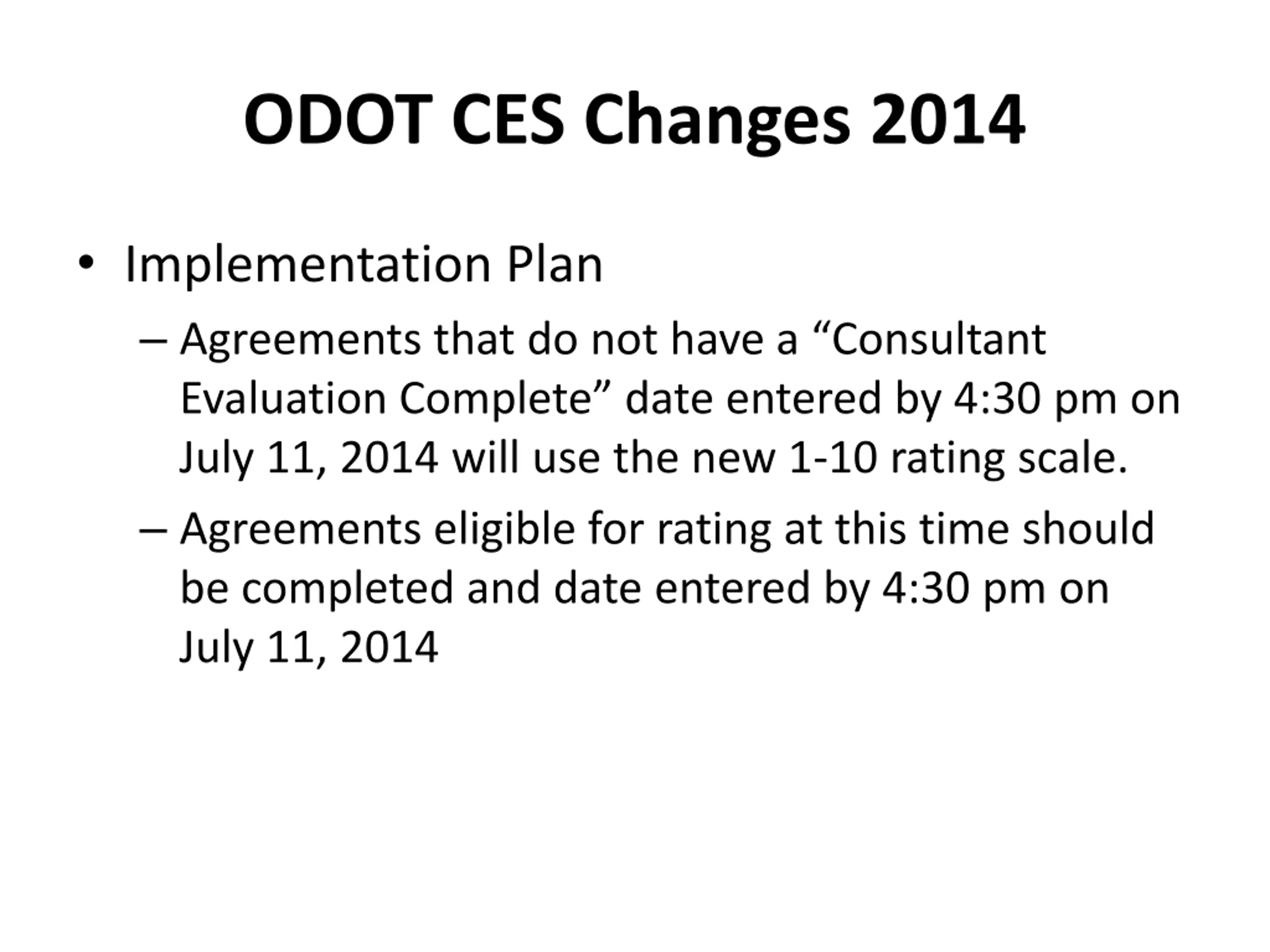

ODOT CES Changes 2014 Implementation Plan Agreements that do not have a Consultant Evaluation Complete date entered by 4:30 pm on July 11, 2014 will use the new 1-10 rating scale. Agreements eligible for rating at this time should be completed and date entered by 4:30 pm on July 11, 2014

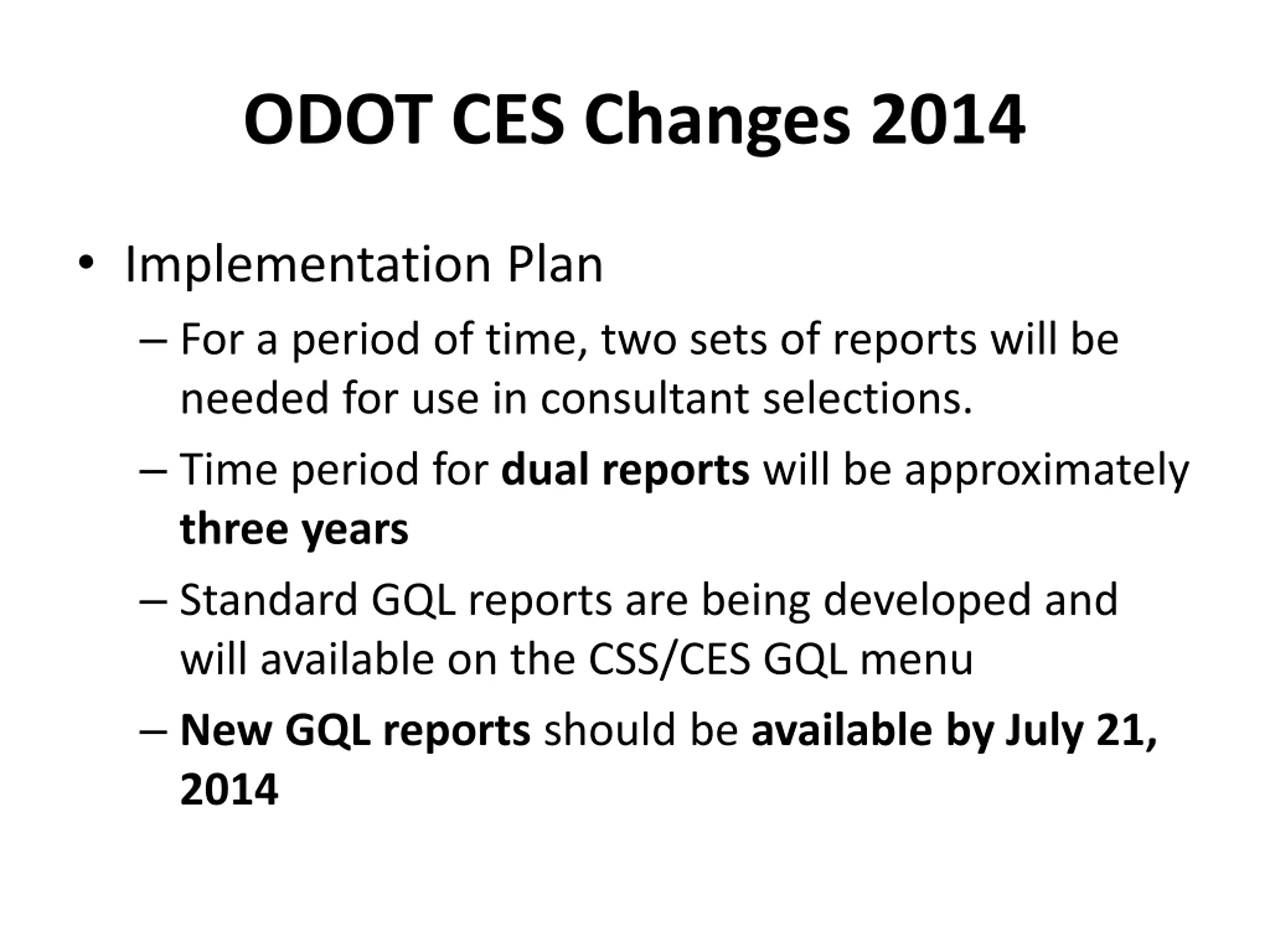

ODOT CES Changes 2014 Implementation Plan For a period of time, two sets of reports will be needed for use in consultant selections. Time period for dual reports will be approximately three years Standard GQL reports are being developed and will available on the CSS/CES GQL menu New GQL reports should be available by July 21, 2014
New CES Rating Scales Project Management ratings will use the standard scale and definitions used for all technical ratings. Timeliness ratings Final and Intermediate Submittals use new definitions based on a 1- 10 scale Construction and Right of Way Acquisition feedback forms will also use the standard 1- 10 scale

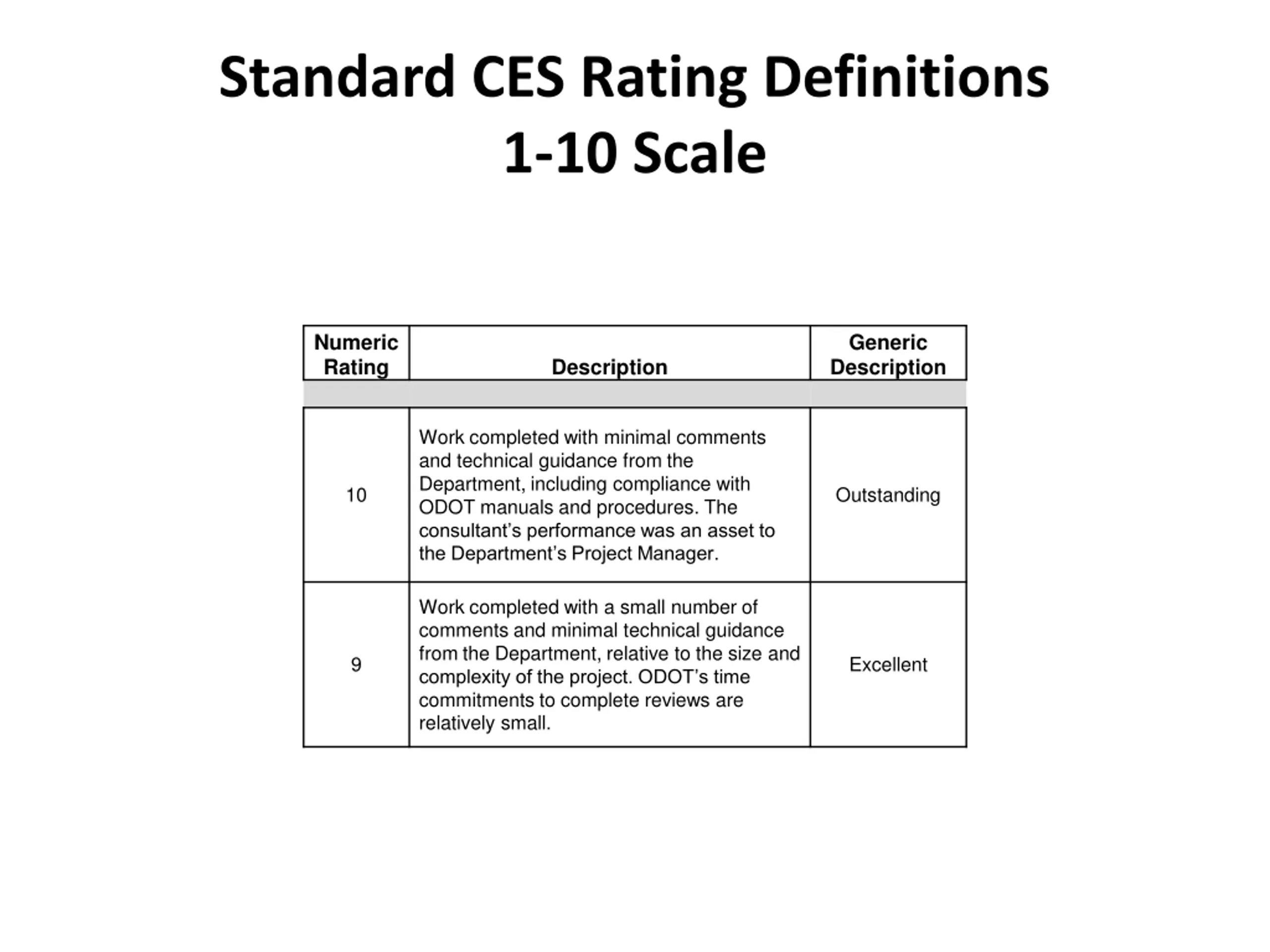

Standard CES Rating Definitions 1-10 Scale Numeric Rating Generic Description Description Work completed with minimal comments and technical guidance from the Department, including compliance with ODOT manuals and procedures. The consultant s performance was an asset to the Department s Project Manager. 10 Outstanding Work completed with a small number of comments and minimal technical guidance from the Department, relative to the size and complexity of the project. ODOT s time commitments to complete reviews are relatively small. 9 Excellent

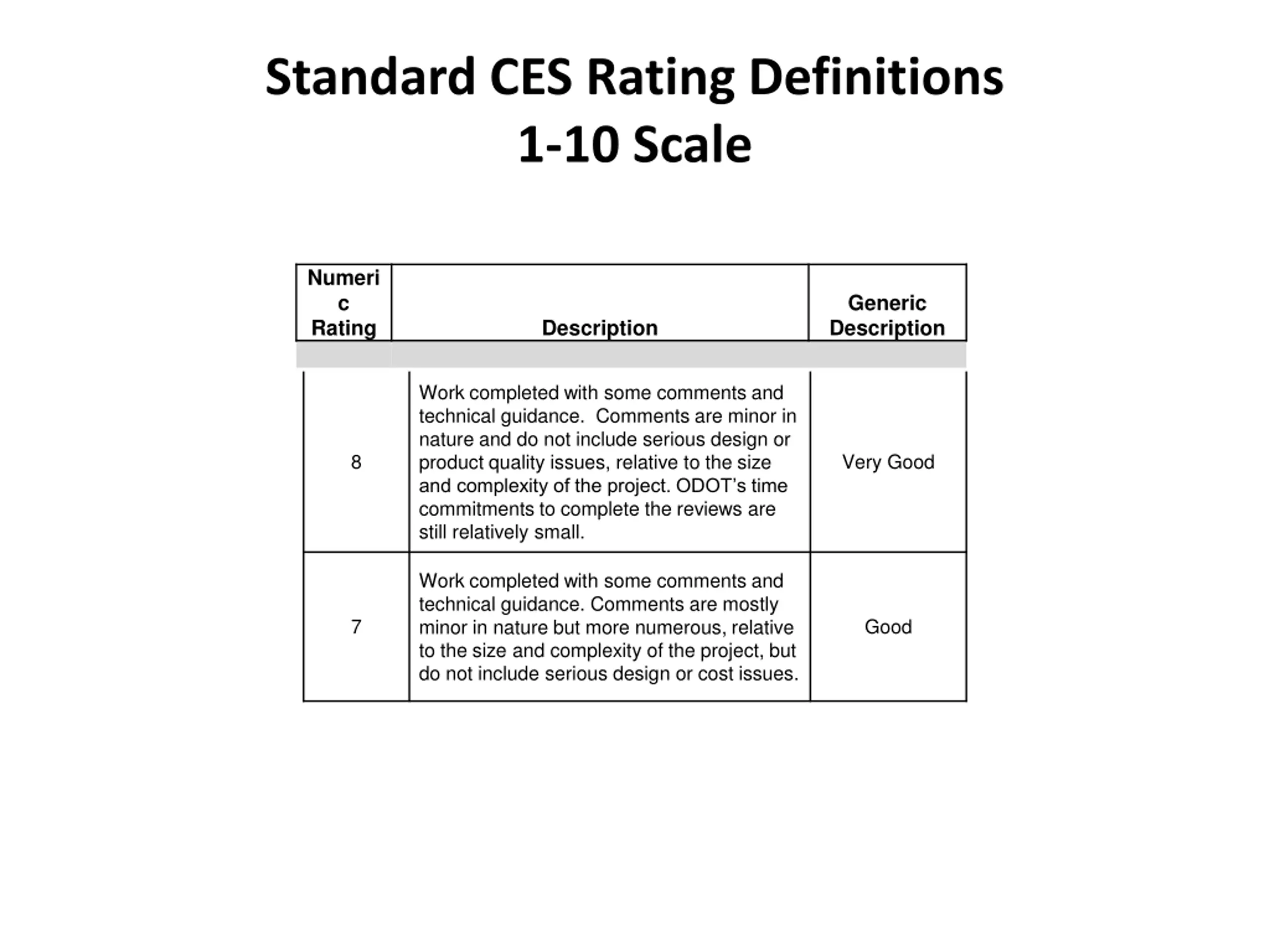

Standard CES Rating Definitions 1-10 Scale Numeri c Rating Generic Description Description Work completed with some comments and technical guidance. Comments are minor in nature and do not include serious design or product quality issues, relative to the size and complexity of the project. ODOT s time commitments to complete the reviews are still relatively small. 8 Very Good Work completed with some comments and technical guidance. Comments are mostly minor in nature but more numerous, relative to the size and complexity of the project, but do not include serious design or cost issues. 7 Good

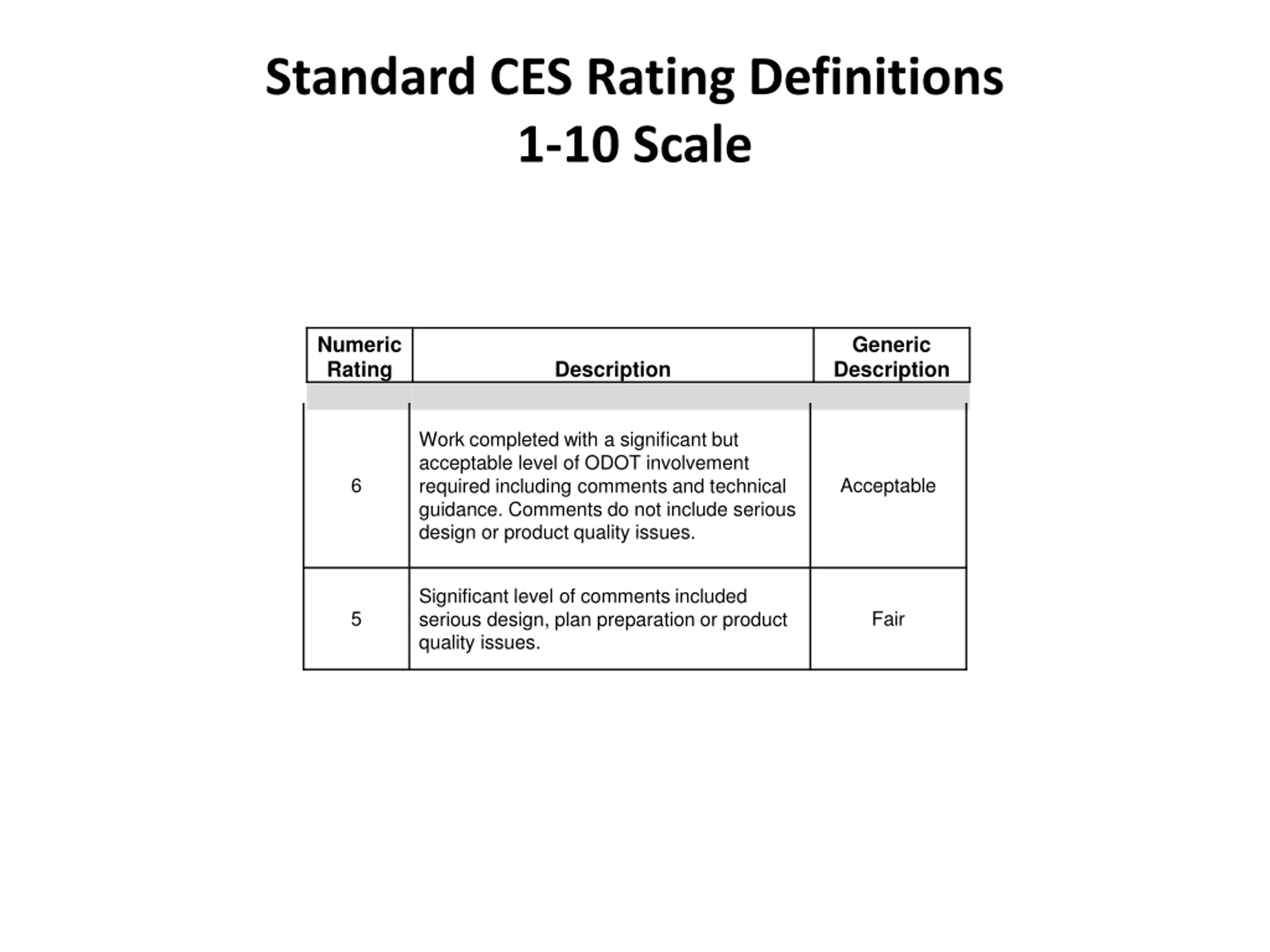

Standard CES Rating Definitions 1-10 Scale Numeric Rating Generic Description Description Work completed with a significant but acceptable level of ODOT involvement required including comments and technical guidance. Comments do not include serious design or product quality issues. 6 Acceptable Significant level of comments included serious design, plan preparation or product quality issues. 5 Fair

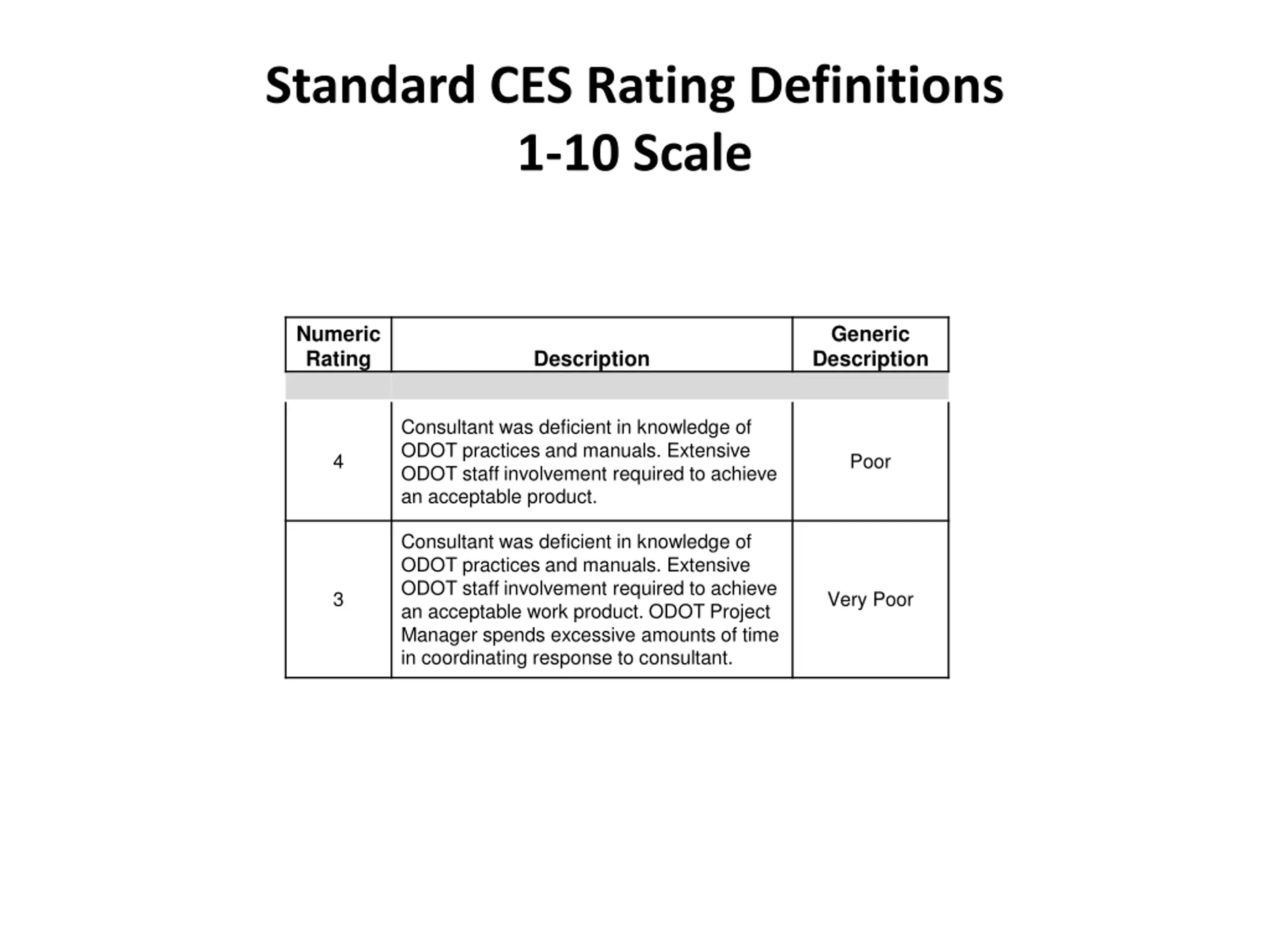

Standard CES Rating Definitions 1-10 Scale Numeric Rating Generic Description Description Consultant was deficient in knowledge of ODOT practices and manuals. Extensive ODOT staff involvement required to achieve an acceptable product. 4 Poor Consultant was deficient in knowledge of ODOT practices and manuals. Extensive ODOT staff involvement required to achieve an acceptable work product. ODOT Project Manager spends excessive amounts of time in coordinating response to consultant. 3 Very Poor

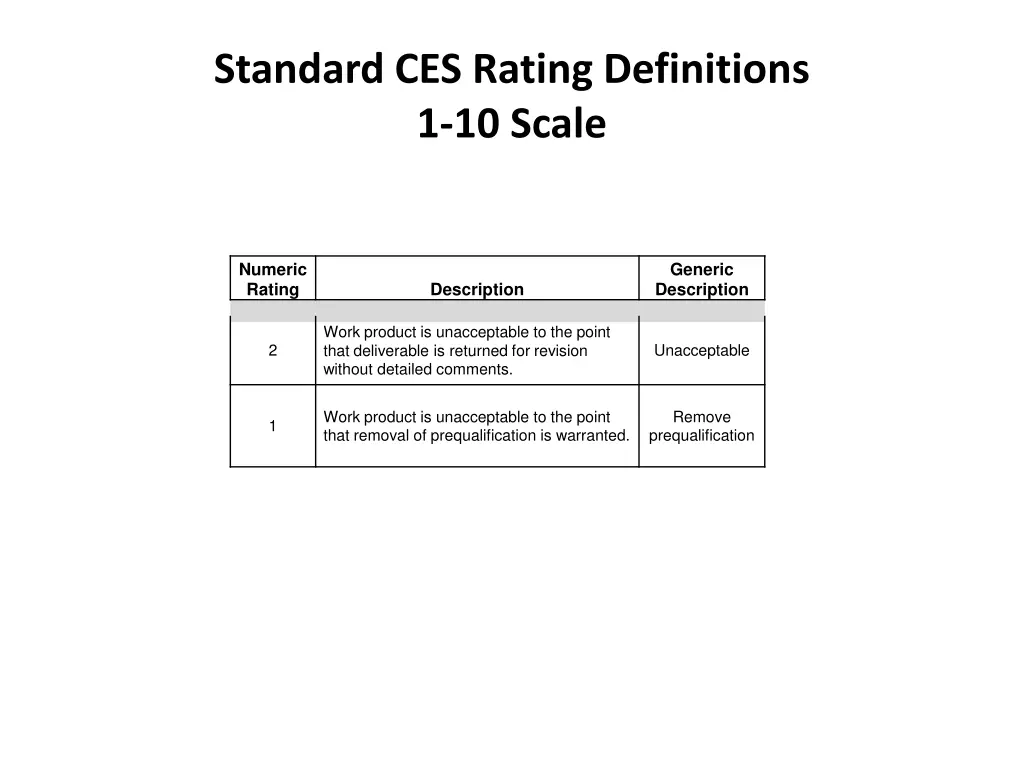

Standard CES Rating Definitions 1-10 Scale Numeric Rating Generic Description Description Work product is unacceptable to the point that deliverable is returned for revision without detailed comments. 2 Unacceptable Work product is unacceptable to the point that removal of prequalification is warranted. Remove prequalification 1

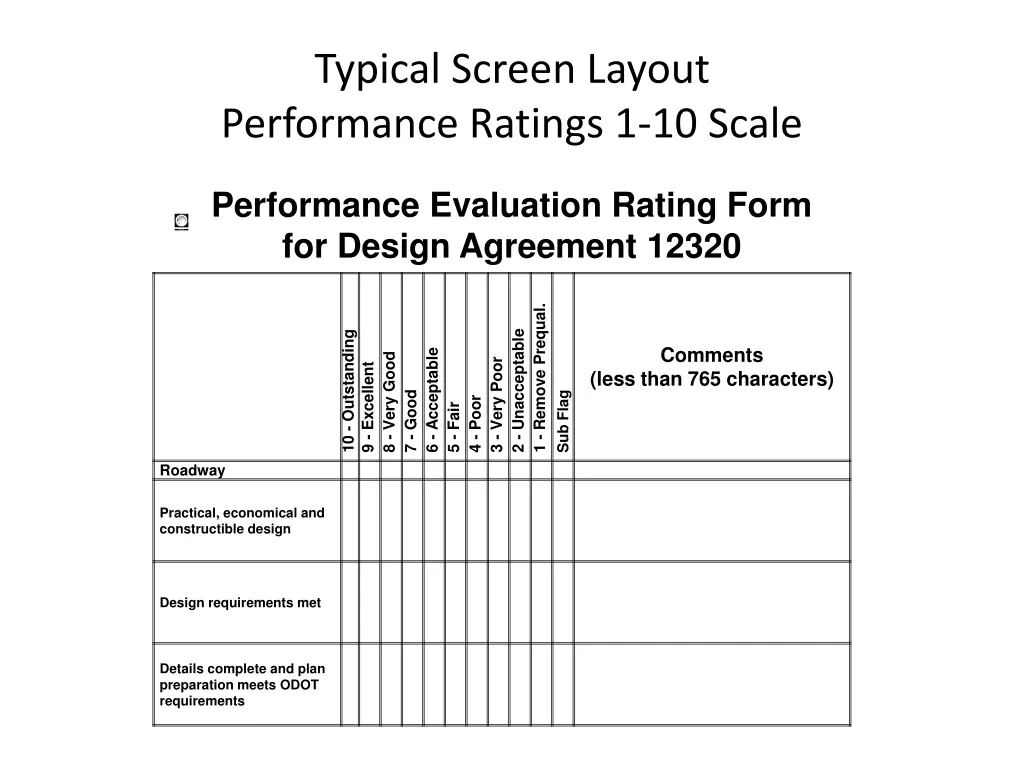

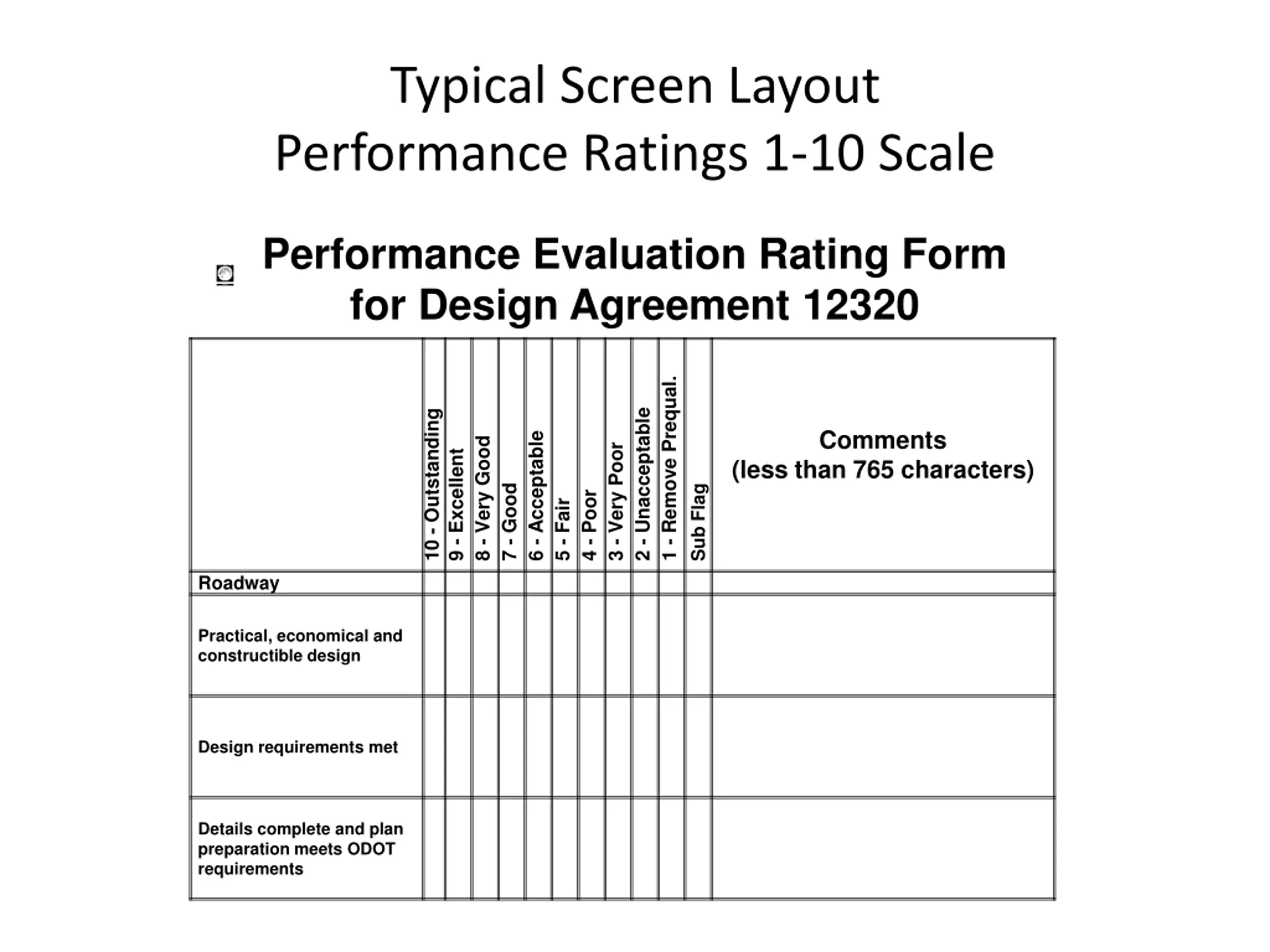

Typical Screen Layout Performance Ratings 1-10 Scale Performance Evaluation Rating Form for Design Agreement 12320 1 - Remove Prequal. 2 - Unacceptable 10 - Outstanding Comments 6 - Acceptable 8 - Very Good 3 - Very Poor 9 - Excellent (less than 765 characters) 7 - Good Sub Flag 4 - Poor 5 - Fair Roadway Practical, economical and constructible design Design requirements met Details complete and plan preparation meets ODOT requirements

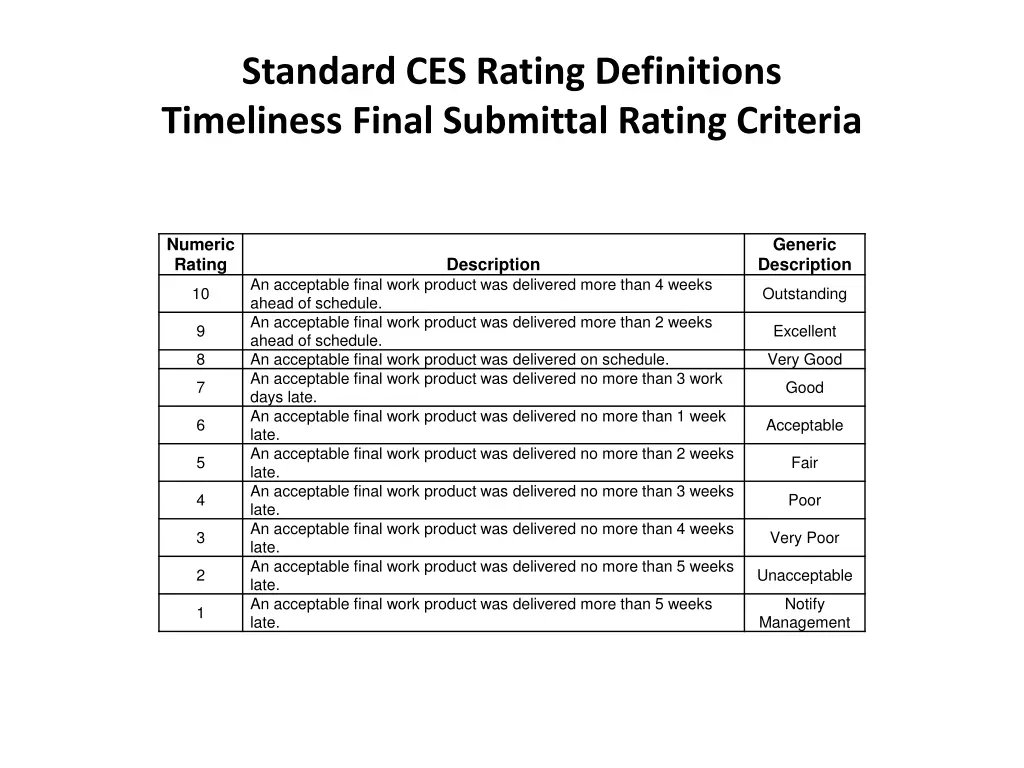

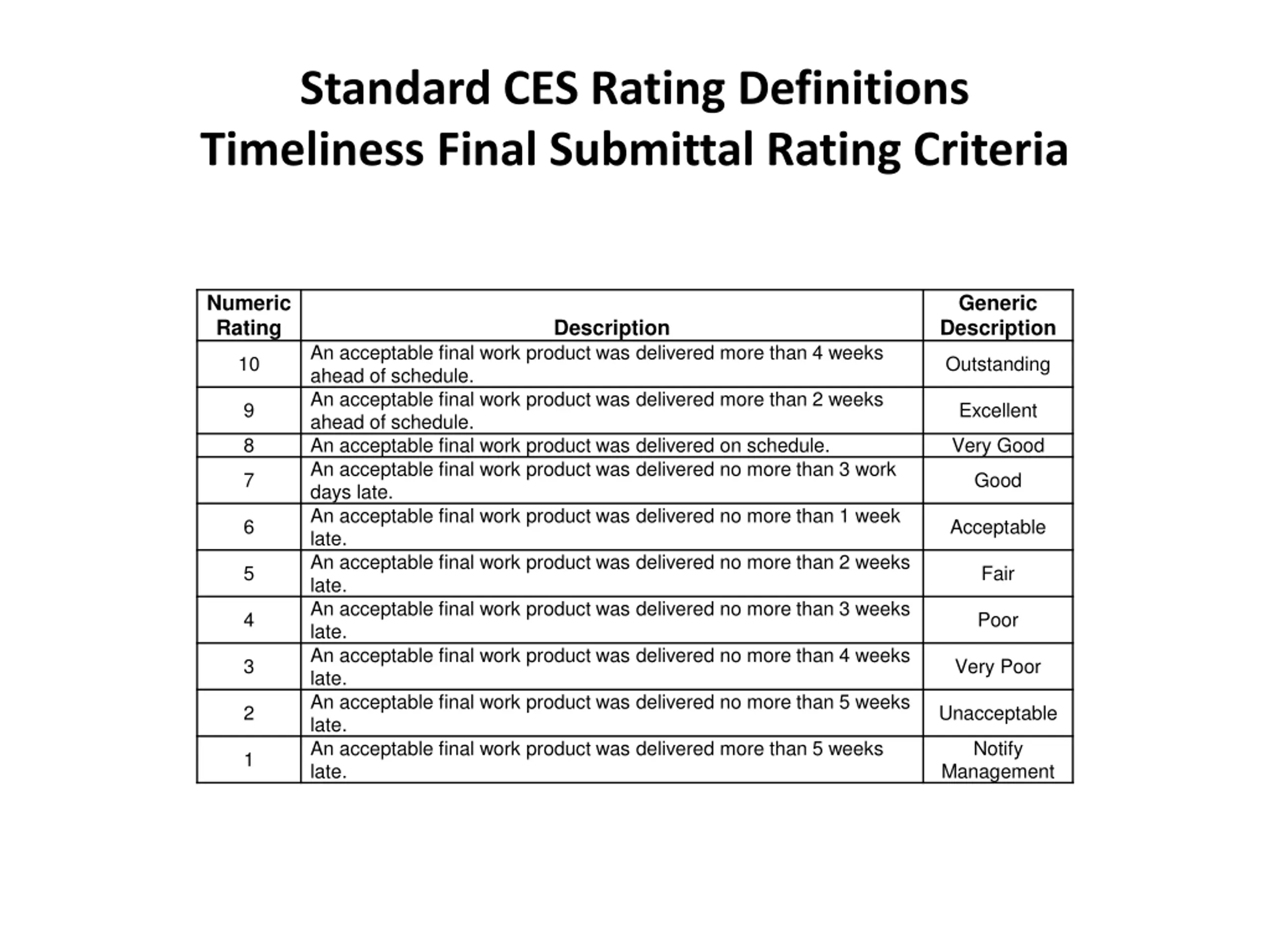

Standard CES Rating Definitions Timeliness Final Submittal Rating Criteria Numeric Rating Generic Description Description An acceptable final work product was delivered more than 4 weeks ahead of schedule. An acceptable final work product was delivered more than 2 weeks ahead of schedule. An acceptable final work product was delivered on schedule. An acceptable final work product was delivered no more than 3 work days late. An acceptable final work product was delivered no more than 1 week late. An acceptable final work product was delivered no more than 2 weeks late. An acceptable final work product was delivered no more than 3 weeks late. An acceptable final work product was delivered no more than 4 weeks late. An acceptable final work product was delivered no more than 5 weeks late. An acceptable final work product was delivered more than 5 weeks late. 10 Outstanding 9 Excellent 8 Very Good 7 Good 6 Acceptable 5 Fair 4 Poor 3 Very Poor 2 Unacceptable Notify 1 Management

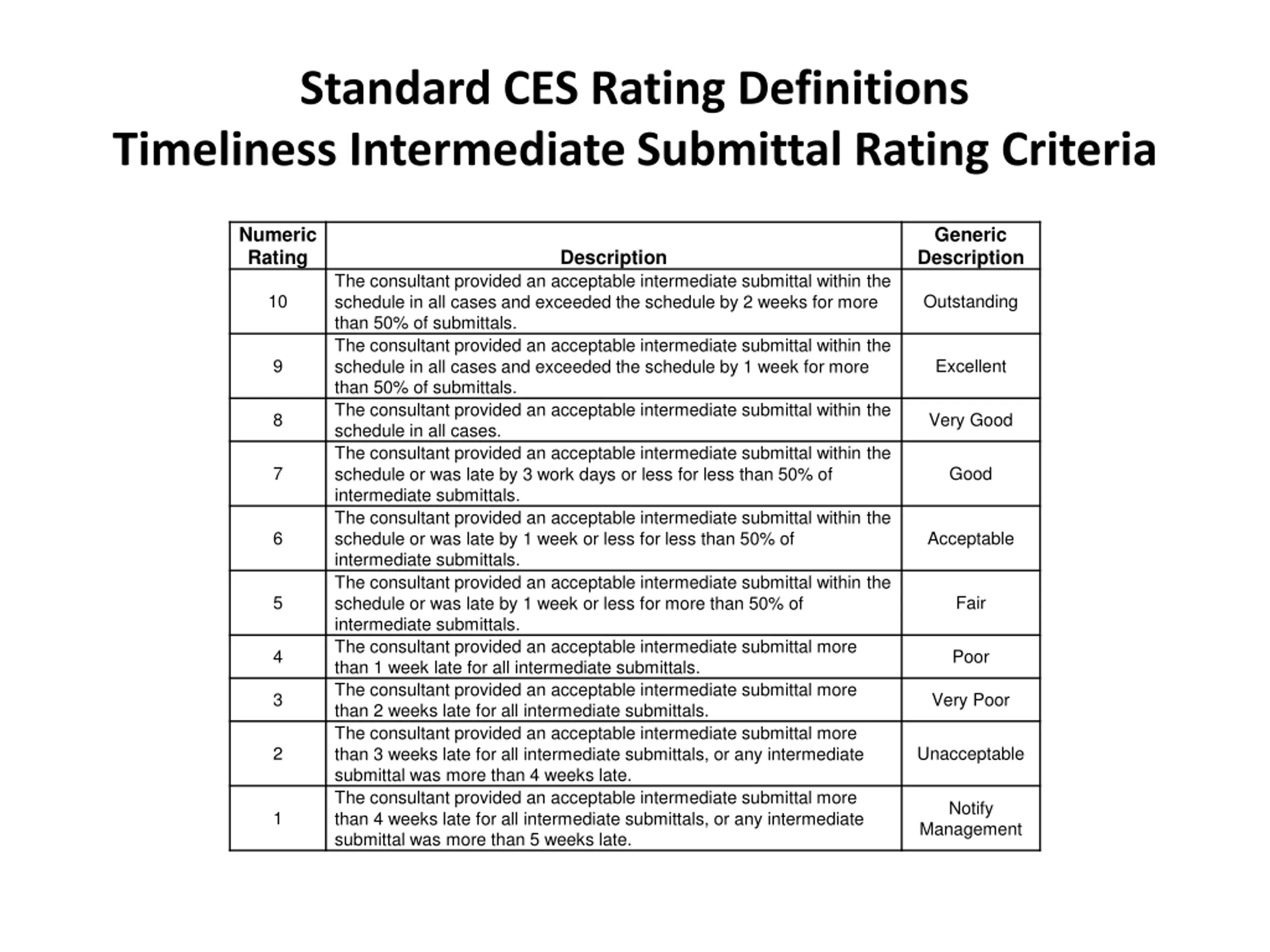

Standard CES Rating Definitions Timeliness Intermediate Submittal Rating Criteria Numeric Rating Generic Description Description The consultant provided an acceptable intermediate submittal within the schedule in all cases and exceeded the schedule by 2 weeks for more than 50% of submittals. The consultant provided an acceptable intermediate submittal within the schedule in all cases and exceeded the schedule by 1 week for more than 50% of submittals. The consultant provided an acceptable intermediate submittal within the schedule in all cases. The consultant provided an acceptable intermediate submittal within the schedule or was late by 3 work days or less for less than 50% of intermediate submittals. The consultant provided an acceptable intermediate submittal within the schedule or was late by 1 week or less for less than 50% of intermediate submittals. The consultant provided an acceptable intermediate submittal within the schedule or was late by 1 week or less for more than 50% of intermediate submittals. The consultant provided an acceptable intermediate submittal more than 1 week late for all intermediate submittals. The consultant provided an acceptable intermediate submittal more than 2 weeks late for all intermediate submittals. The consultant provided an acceptable intermediate submittal more than 3 weeks late for all intermediate submittals, or any intermediate submittal was more than 4 weeks late. The consultant provided an acceptable intermediate submittal more than 4 weeks late for all intermediate submittals, or any intermediate submittal was more than 5 weeks late. 10 Outstanding 9 Excellent 8 Very Good 7 Good 6 Acceptable 5 Fair 4 Poor 3 Very Poor 2 Unacceptable Notify 1 Management
ODOT CSS/CES Users Login Procedures Effective July 14, 2014 ODOT CSS/CES Users will begin accessing the system using their Windows ID and Password currently used for start-up and Ellis access
