Overview of Tender Package & Procurement Procedures

Overview of Tender Package & Procurement Procedures
Slide Note
Embed
Share

Detailed overview of the tender package for service procurement, including the use of UN framework, ICAO procurement code, terms and conditions, and evaluation process. Highlights process evaluation, negotiations, and service order acceptance.

  • Tender Package
  • Procurement Procedures
  • Service Order
  • Evaluation Process
  • ICAO

Uploaded on Mar 10, 2025 | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

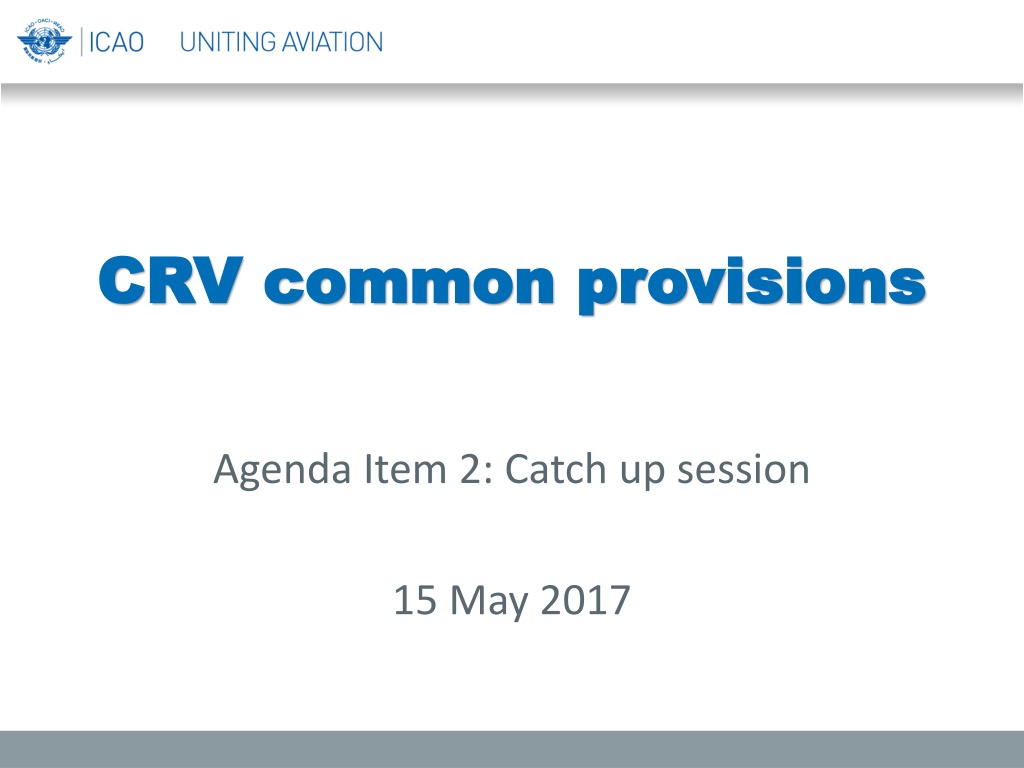

  1. CRV common provisions CRV common provisions Agenda Item 2: Catch up session 15 May 2017

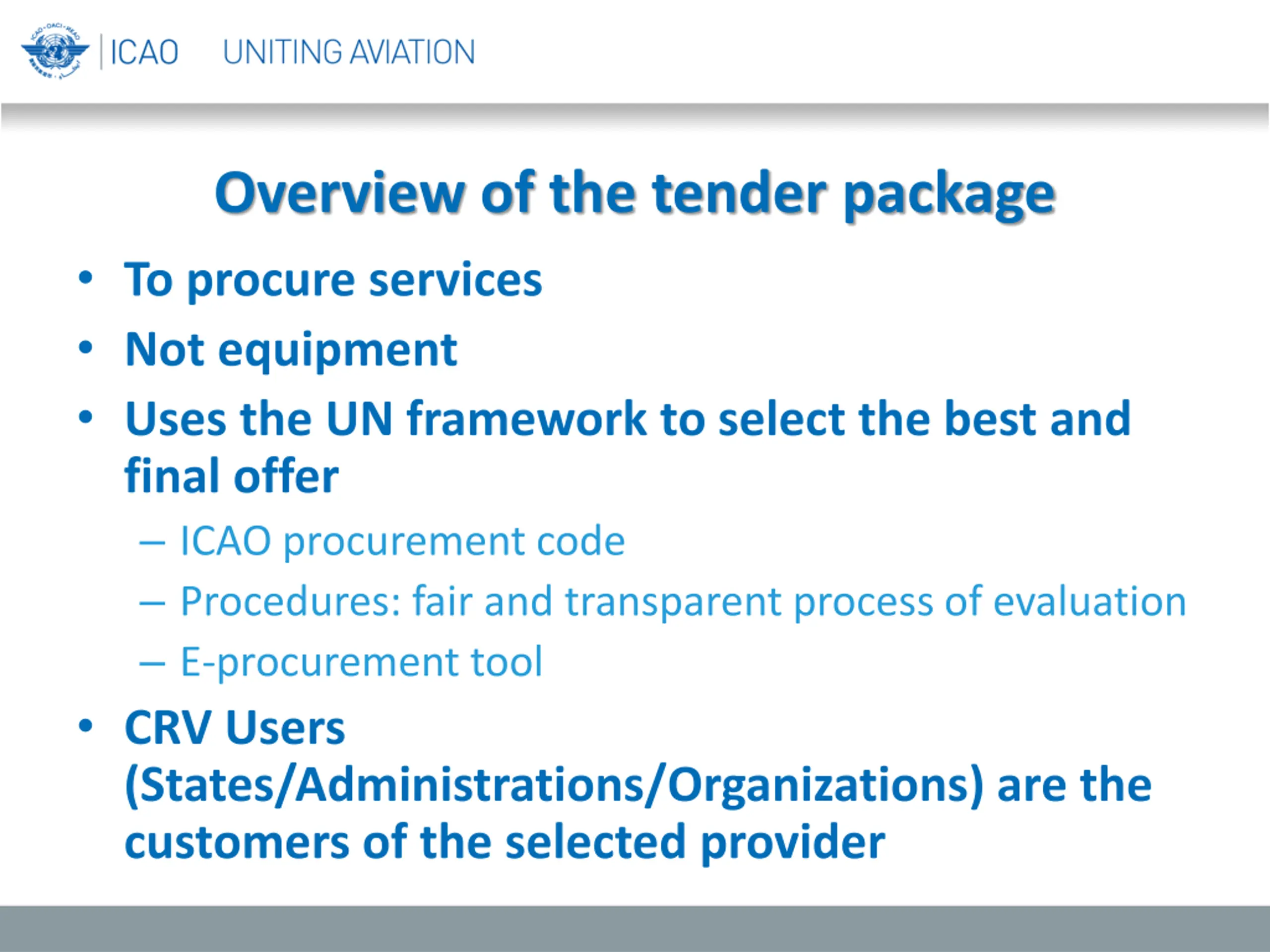

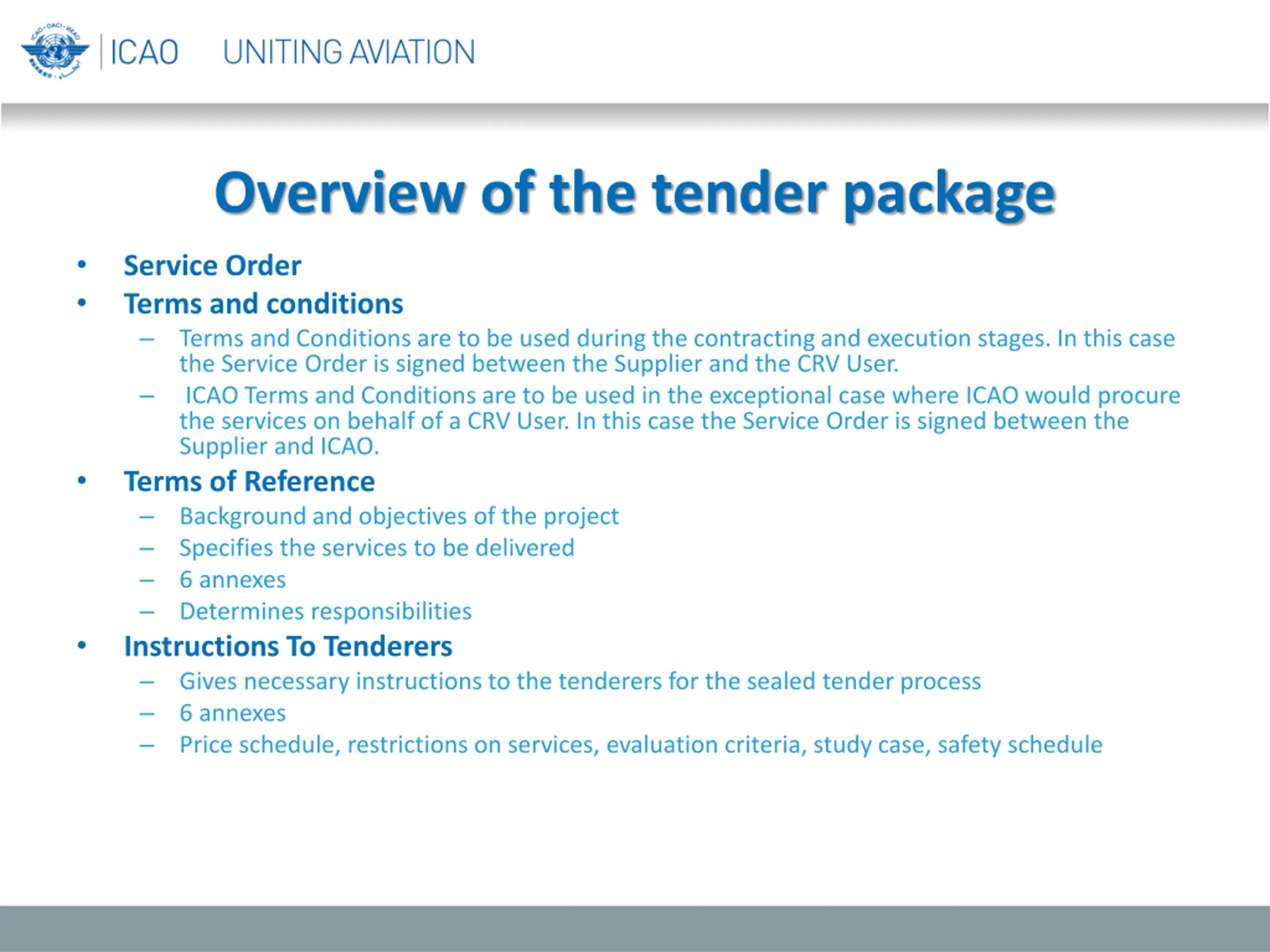

  2. Overview of the tender package To procure services Not equipment Uses the UN framework to select the best and final offer ICAO procurement code Procedures: fair and transparent process of evaluation E-procurement tool CRV Users (States/Administrations/Organizations) are the customers of the selected provider

  3. Overview of the tender package Service Order Terms and conditions Terms and Conditions are to be used during the contracting and execution stages. In this case the Service Order is signed between the Supplier and the CRV User. ICAO Terms and Conditions are to be used in the exceptional case where ICAO would procure the services on behalf of a CRV User. In this case the Service Order is signed between the Supplier and ICAO. Terms of Reference Background and objectives of the project Specifies the services to be delivered 6 annexes Determines responsibilities Instructions To Tenderers Gives necessary instructions to the tenderers for the sealed tender process 6 annexes Price schedule, restrictions on services, evaluation criteria, study case, safety schedule

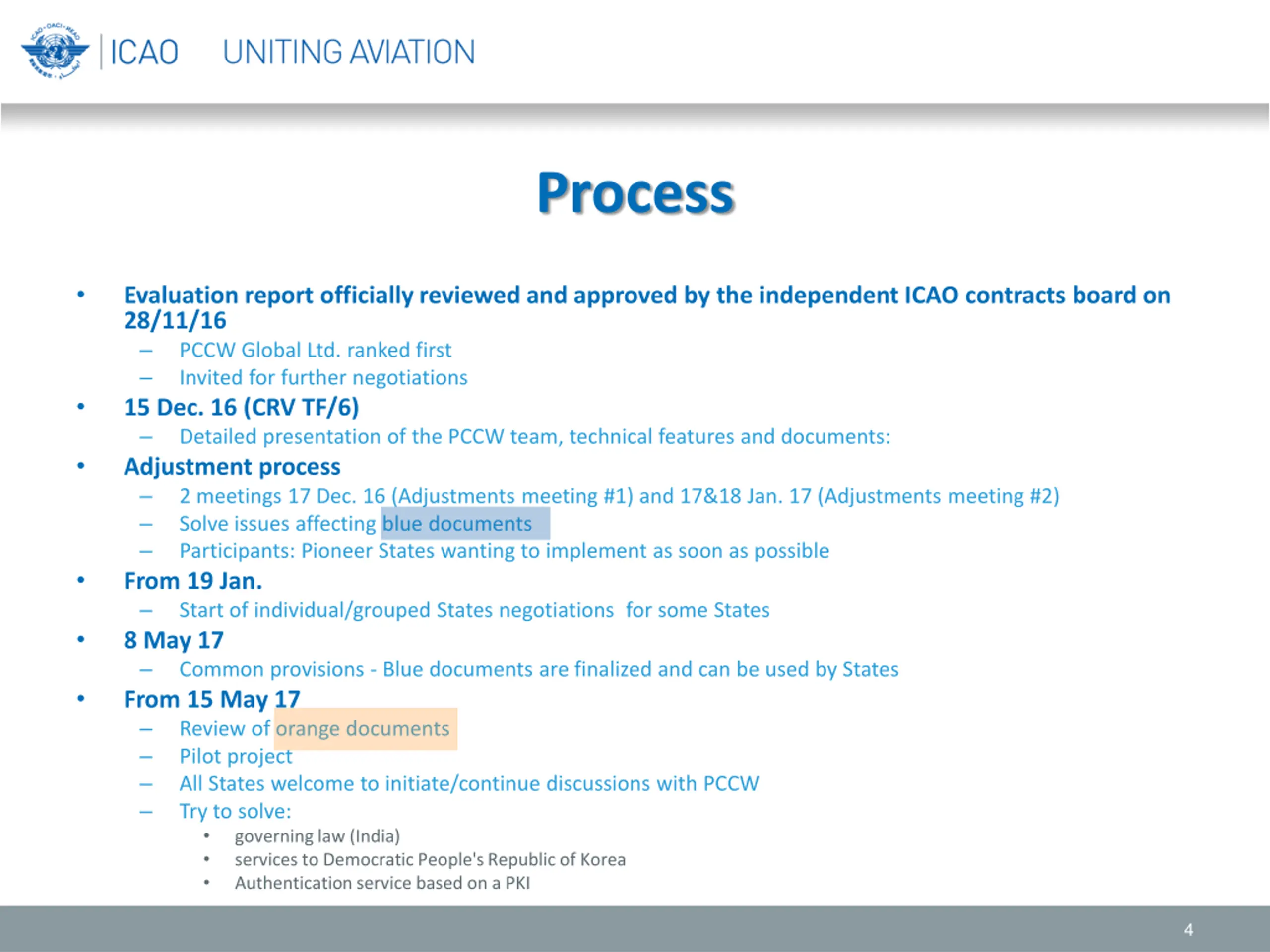

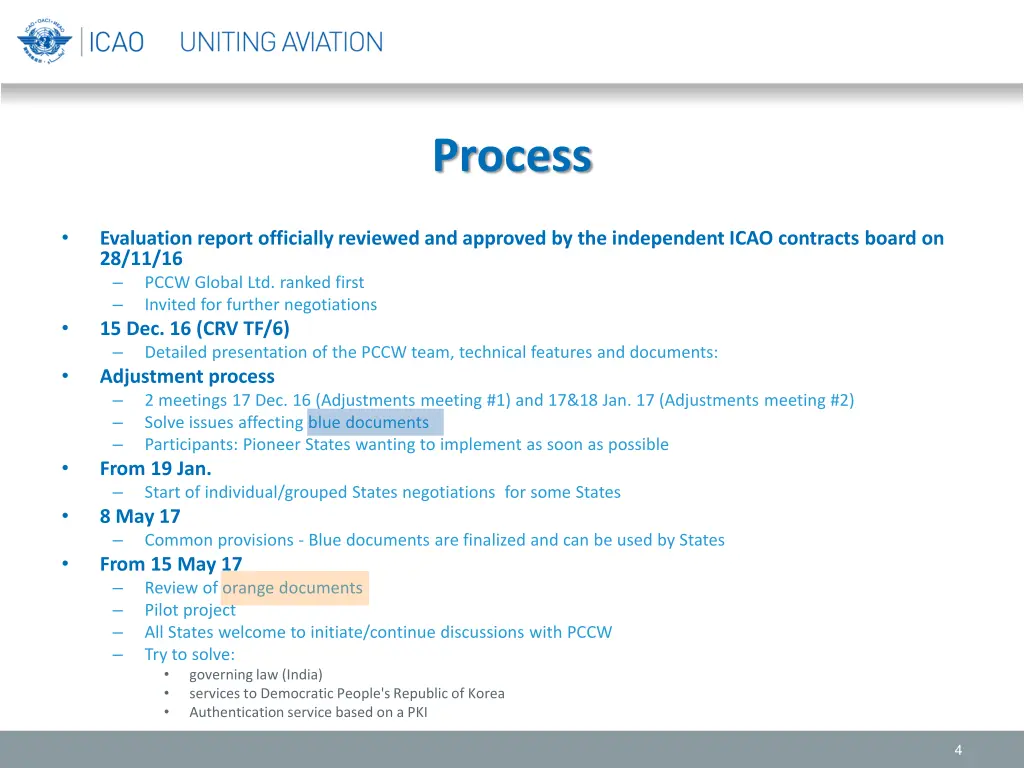

  4. Process Evaluation report officially reviewed and approved by the independent ICAO contracts board on 28/11/16 PCCW Global Ltd. ranked first Invited for further negotiations 15 Dec. 16 (CRV TF/6) Detailed presentation of the PCCW team, technical features and documents: Adjustment process 2 meetings 17 Dec. 16 (Adjustments meeting #1) and 17&18 Jan. 17 (Adjustments meeting #2) Solve issues affecting blue documents Participants: Pioneer States wanting to implement as soon as possible From 19 Jan. Start of individual/grouped States negotiations for some States 8 May 17 Common provisions - Blue documents are finalized and can be used by States From 15 May 17 Review of orange documents Pilot project All States welcome to initiate/continue discussions with PCCW Try to solve: governing law (India) services to Democratic People's Republic of Korea Authentication service based on a PKI 4

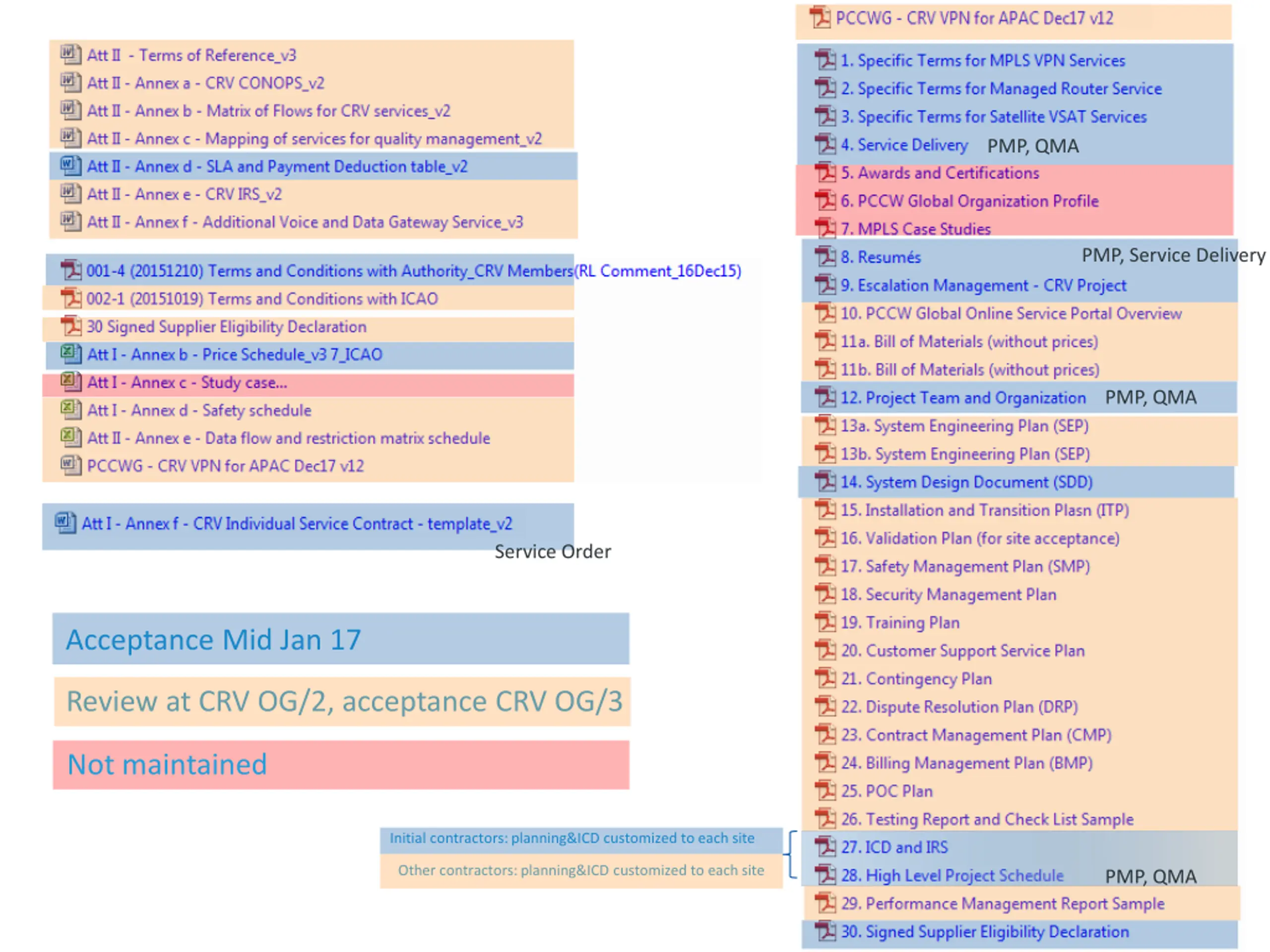

  5. PMP, QMA PMP, Service Delivery PMP, QMA Service Order Acceptance Mid Jan 17 Review at CRV OG/2, acceptance CRV OG/3 Not maintained Initial contractors: planning&ICD customized to each site Other contractors: planning&ICD customized to each site PMP, QMA

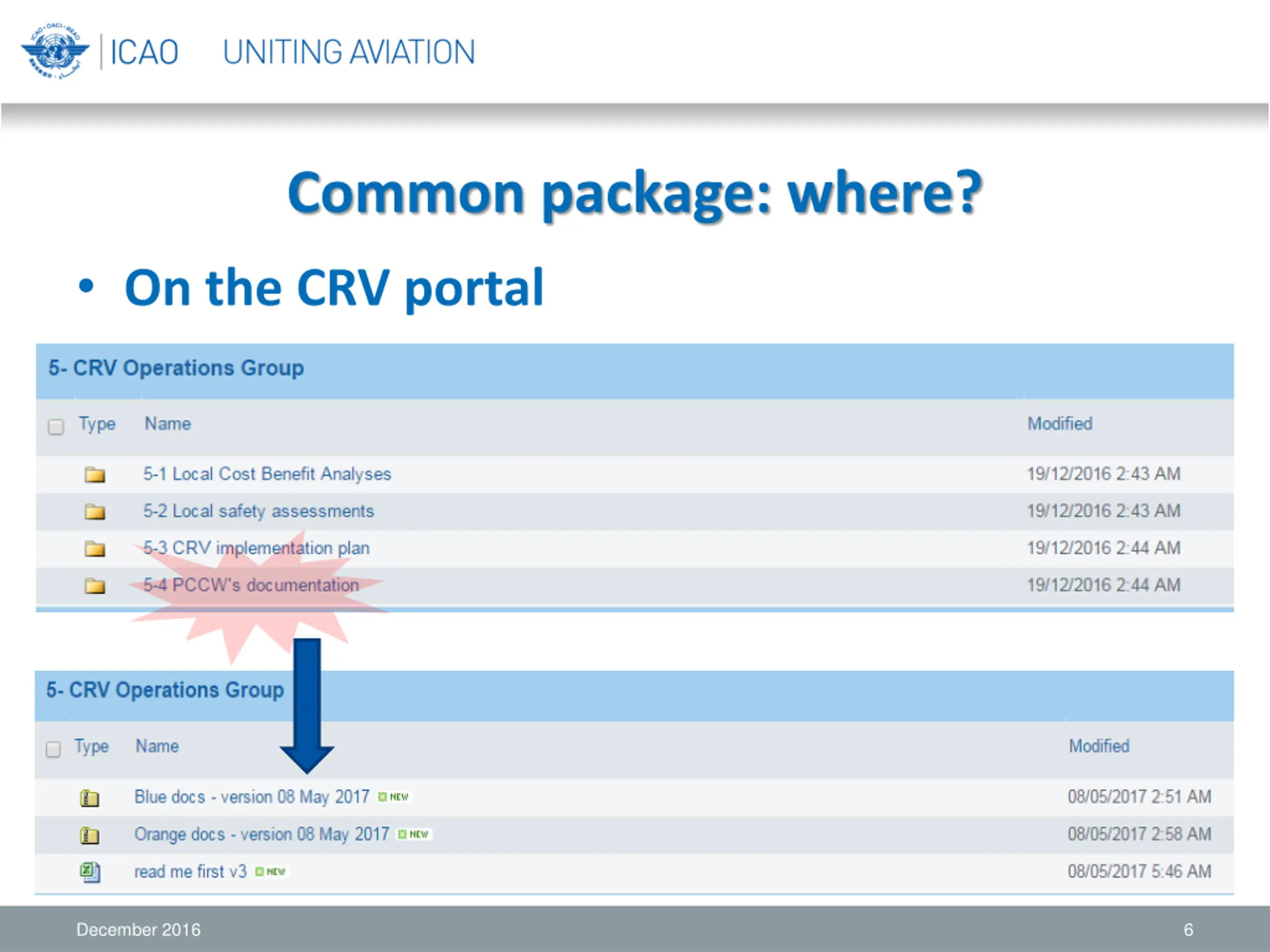

  6. Common package: where? On the CRV portal December 2016 6

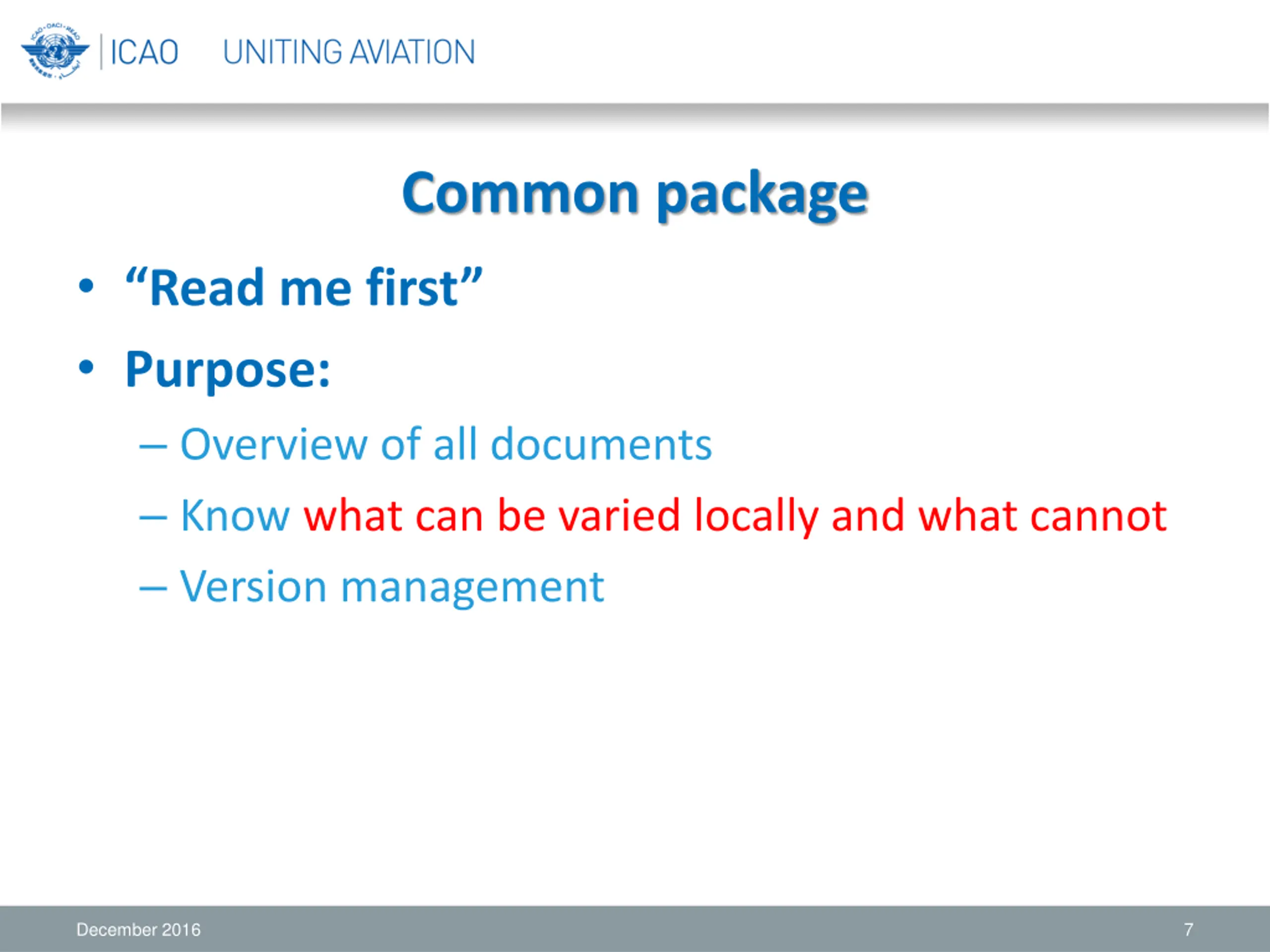

  7. Common package Read me first Purpose: Overview of all documents Know what can be varied locally and what cannot Version management December 2016 7

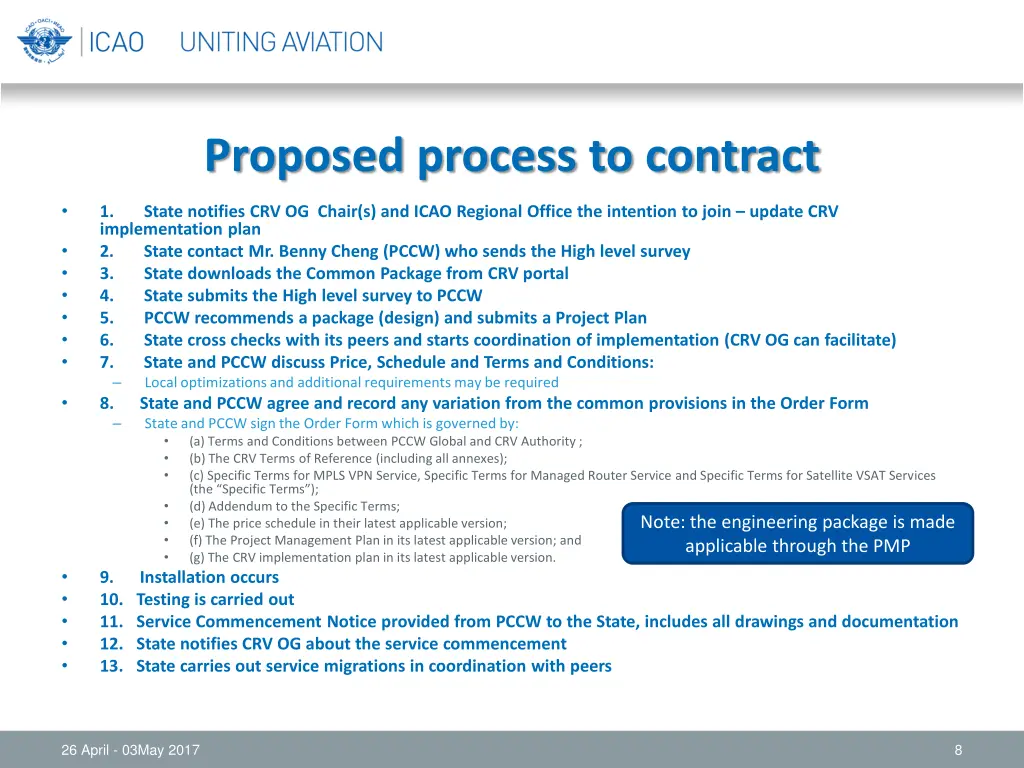

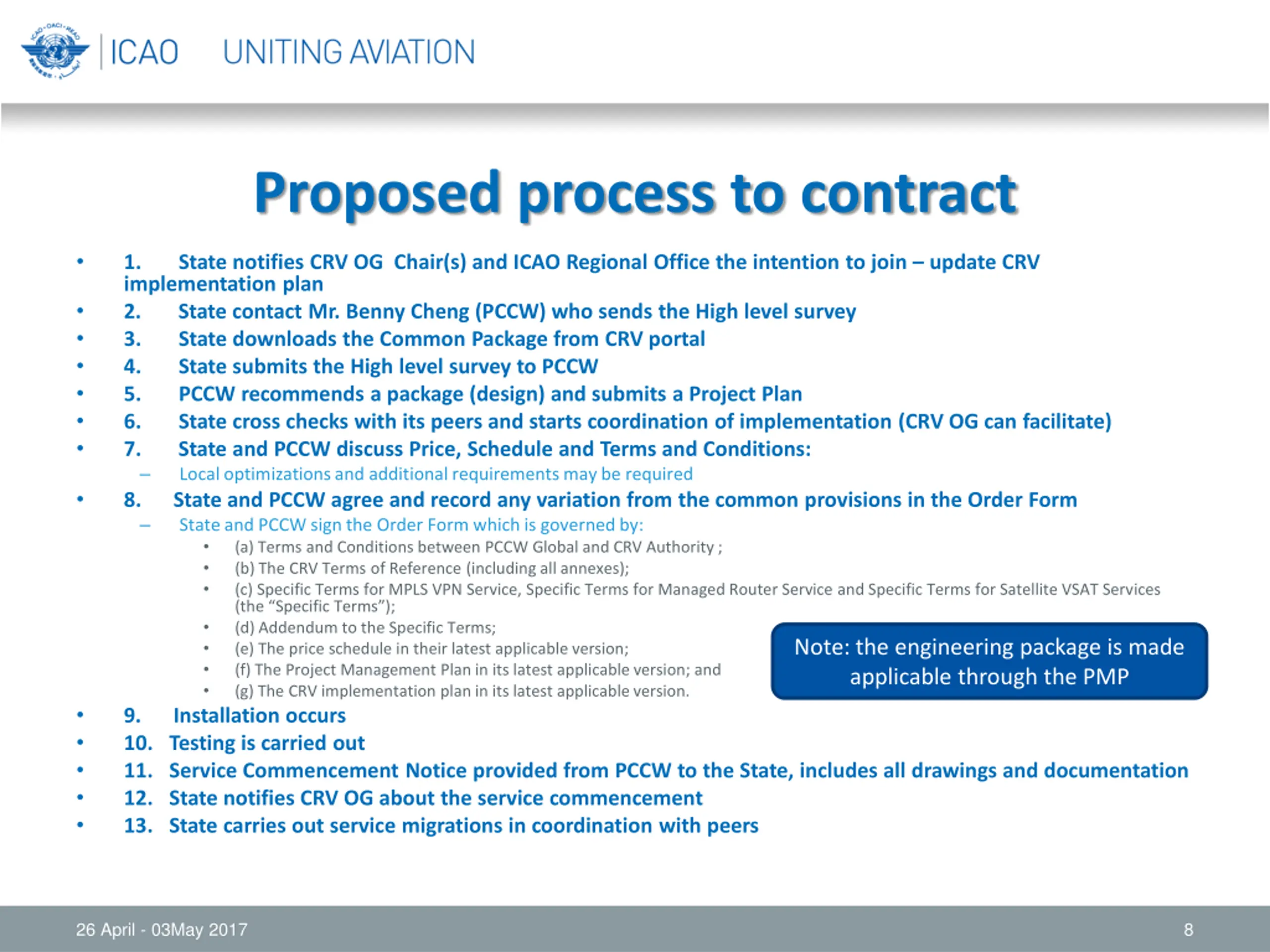

  8. Proposed process to contract 1. implementation plan 2. State contact Mr. Benny Cheng (PCCW) who sends the High level survey 3. State downloads the Common Package from CRV portal 4. State submits the High level survey to PCCW 5. PCCW recommends a package (design) and submits a Project Plan 6. State cross checks with its peers and starts coordination of implementation (CRV OG can facilitate) 7. State and PCCW discuss Price, Schedule and Terms and Conditions: Local optimizations and additional requirements may be required 8. State and PCCW agree and record any variation from the common provisions in the Order Form State and PCCW sign the Order Form which is governed by: (a) Terms and Conditions between PCCW Global and CRV Authority ; (b) The CRV Terms of Reference (including all annexes); (c) Specific Terms for MPLS VPN Service, Specific Terms for Managed Router Service and Specific Terms for Satellite VSAT Services (the Specific Terms ); (d) Addendum to the Specific Terms; (e) The price schedule in their latest applicable version; (f) The Project Management Plan in its latest applicable version; and (g) The CRV implementation plan in its latest applicable version. 9. Installation occurs 10. Testing is carried out 11. Service Commencement Notice provided from PCCW to the State, includes all drawings and documentation 12. State notifies CRV OG about the service commencement 13. State carries out service migrations in coordination with peers State notifies CRV OG Chair(s) and ICAO Regional Office the intention to join update CRV Note: the engineering package is made applicable through the PMP 26 April - 03May 2017 8
