Provider Directory Advisory Committee Meeting Overview
This overview provides insights into the Provider Directory Advisory Committee meeting held on March 15, 2017. The agenda covered introductions, charter, work plan discussions, updates on HIT portfolio and common credentialing, as well as presentations on HIT Commons. It also delves into the reporting structure and key acronyms related to the health IT oversight galaxy in Oregon.
Download Presentation
Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
Provider Directory Advisory Committee Meeting March 15, 2017

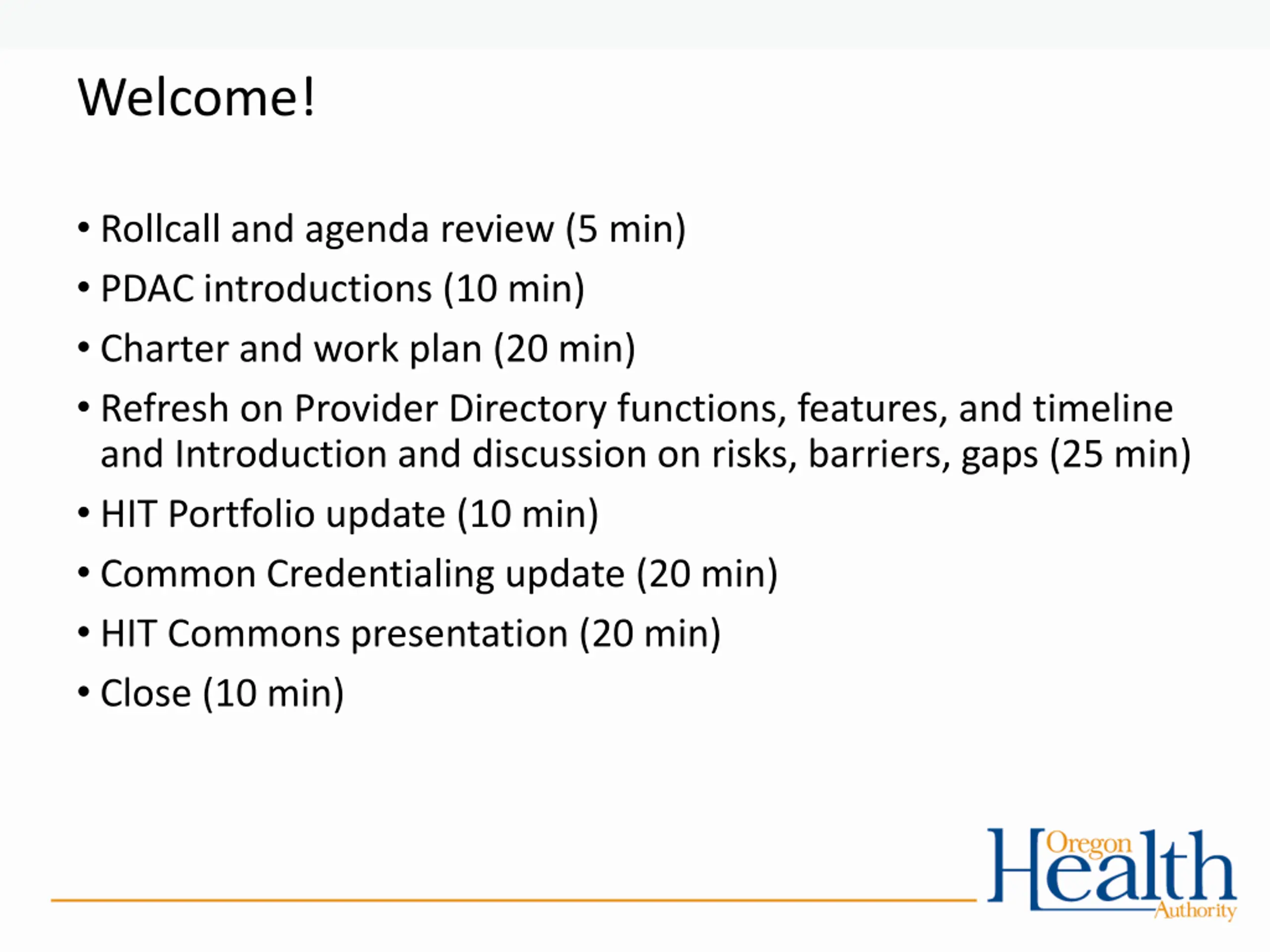

Welcome! Rollcall and agenda review (5 min) PDAC introductions (10 min) Charter and work plan (20 min) Refresh on Provider Directory functions, features, and timeline and Introduction and discussion on risks, barriers, gaps (25 min) HIT Portfolio update (10 min) Common Credentialing update (20 min) HIT Commons presentation (20 min) Close (10 min)

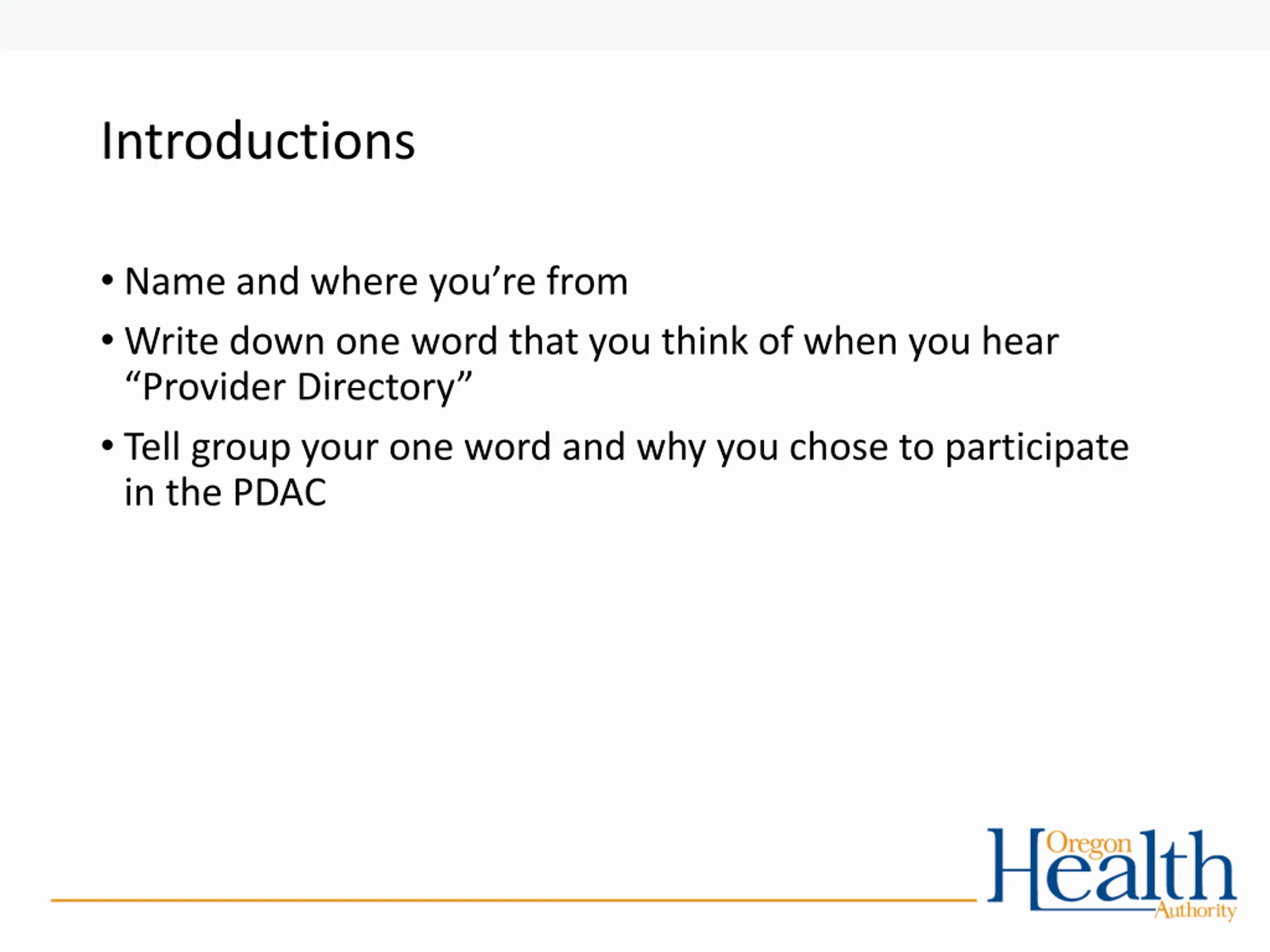

Introductions Name and where you re from Write down one word that you think of when you hear Provider Directory Tell group your one word and why you chose to participate in the PDAC
PDAC Charter and Work Plan Karen Hale

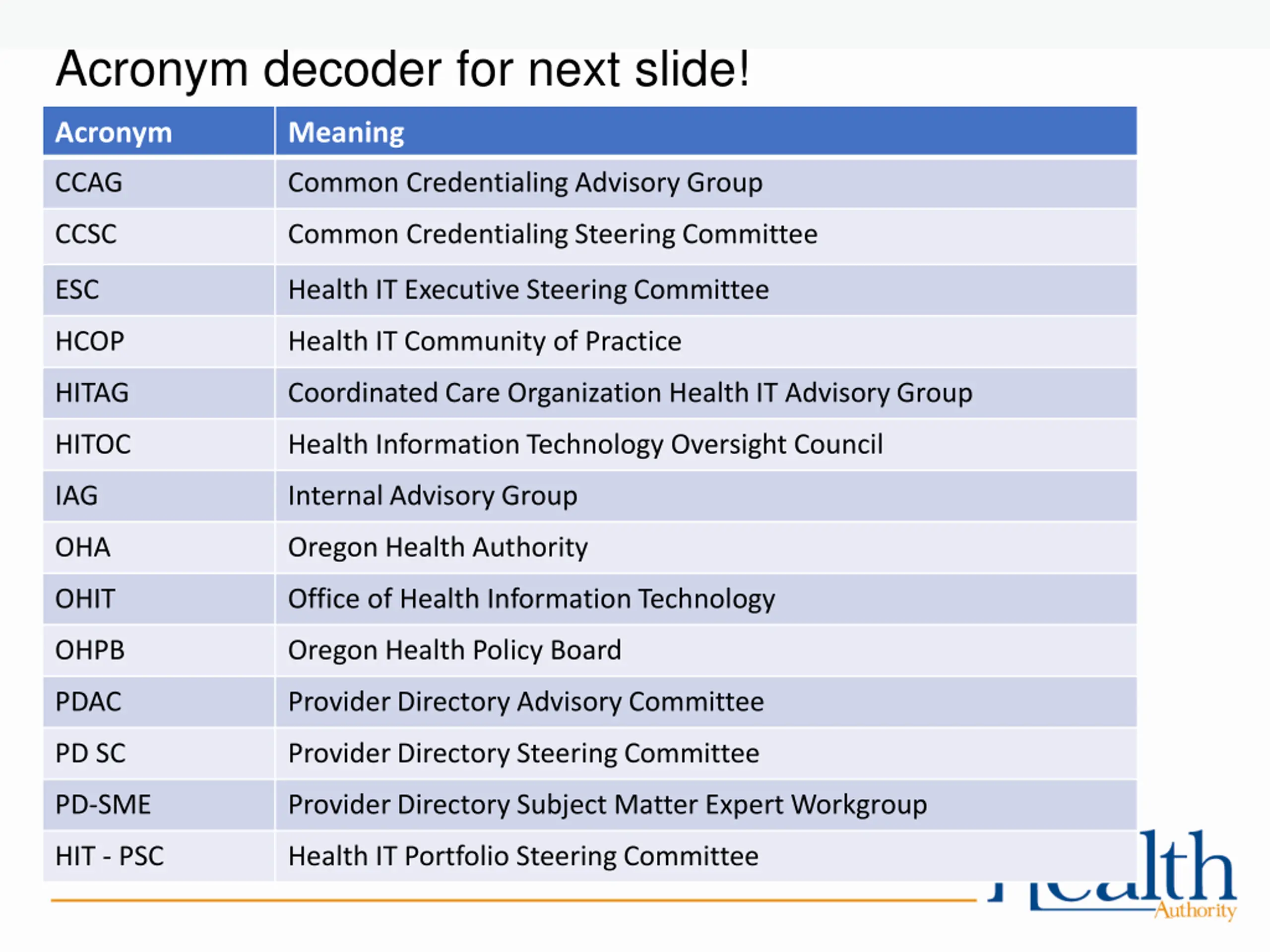

Acronym decoder for next slide! Acronym Meaning CCAG Common Credentialing Advisory Group CCSC Common Credentialing Steering Committee ESC Health IT Executive Steering Committee HCOP Health IT Community of Practice HITAG Coordinated Care Organization Health IT Advisory Group HITOC Health Information Technology Oversight Council IAG Internal Advisory Group OHA Oregon Health Authority OHIT Office of Health Information Technology OHPB Oregon Health Policy Board PDAC Provider Directory Advisory Committee PD SC Provider Directory Steering Committee PD-SME Provider Directory Subject Matter Expert Workgroup HIT - PSC Health IT Portfolio Steering Committee

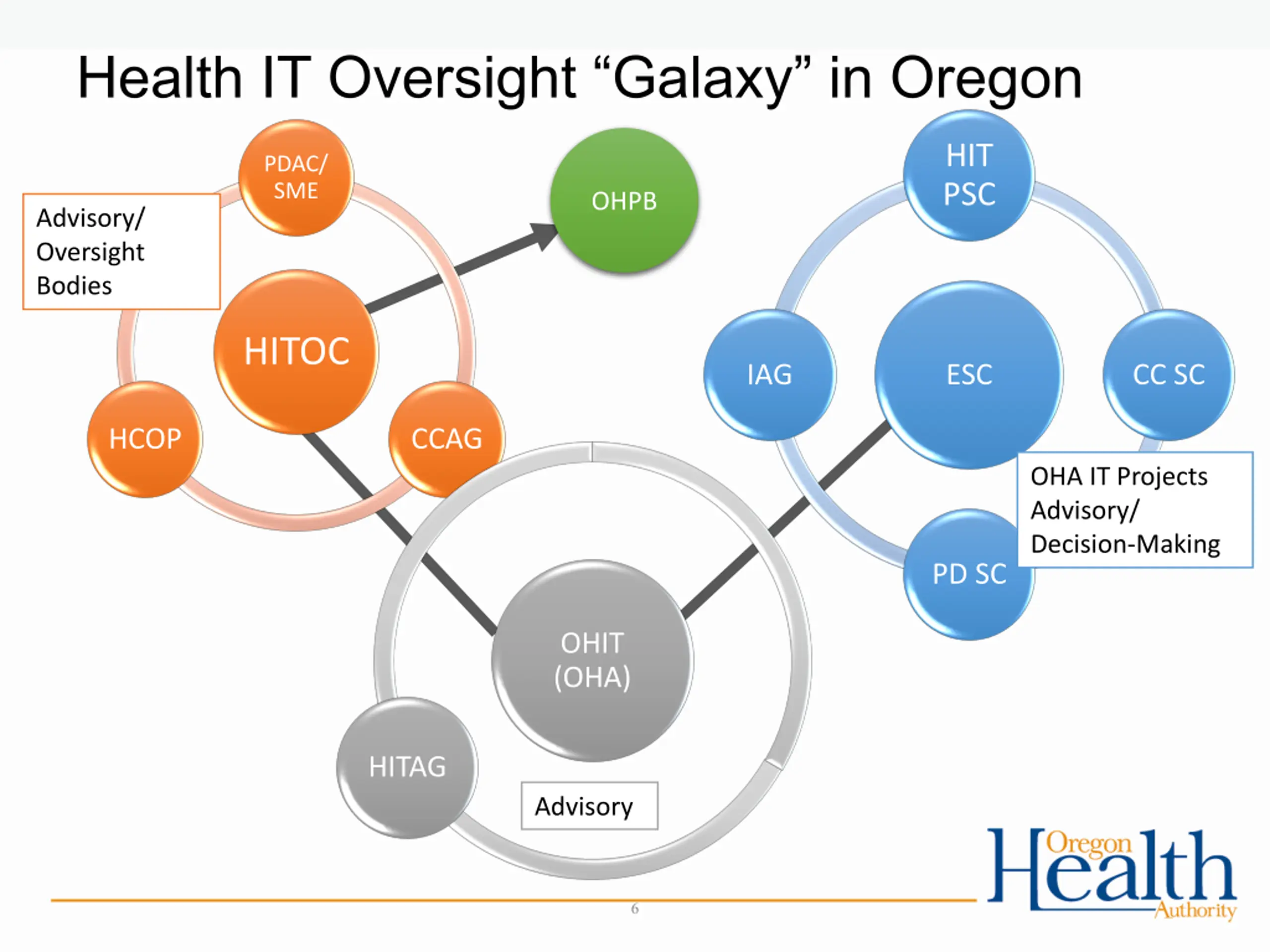

Health IT Oversight Galaxy in Oregon HIT PSC PDAC/ SME OHPB Advisory/ Oversight Bodies HITOC IAG ESC CC SC HCOP CCAG OHA IT Projects Advisory/ Decision-Making PD SC OHIT (OHA) HITAG Advisory 6

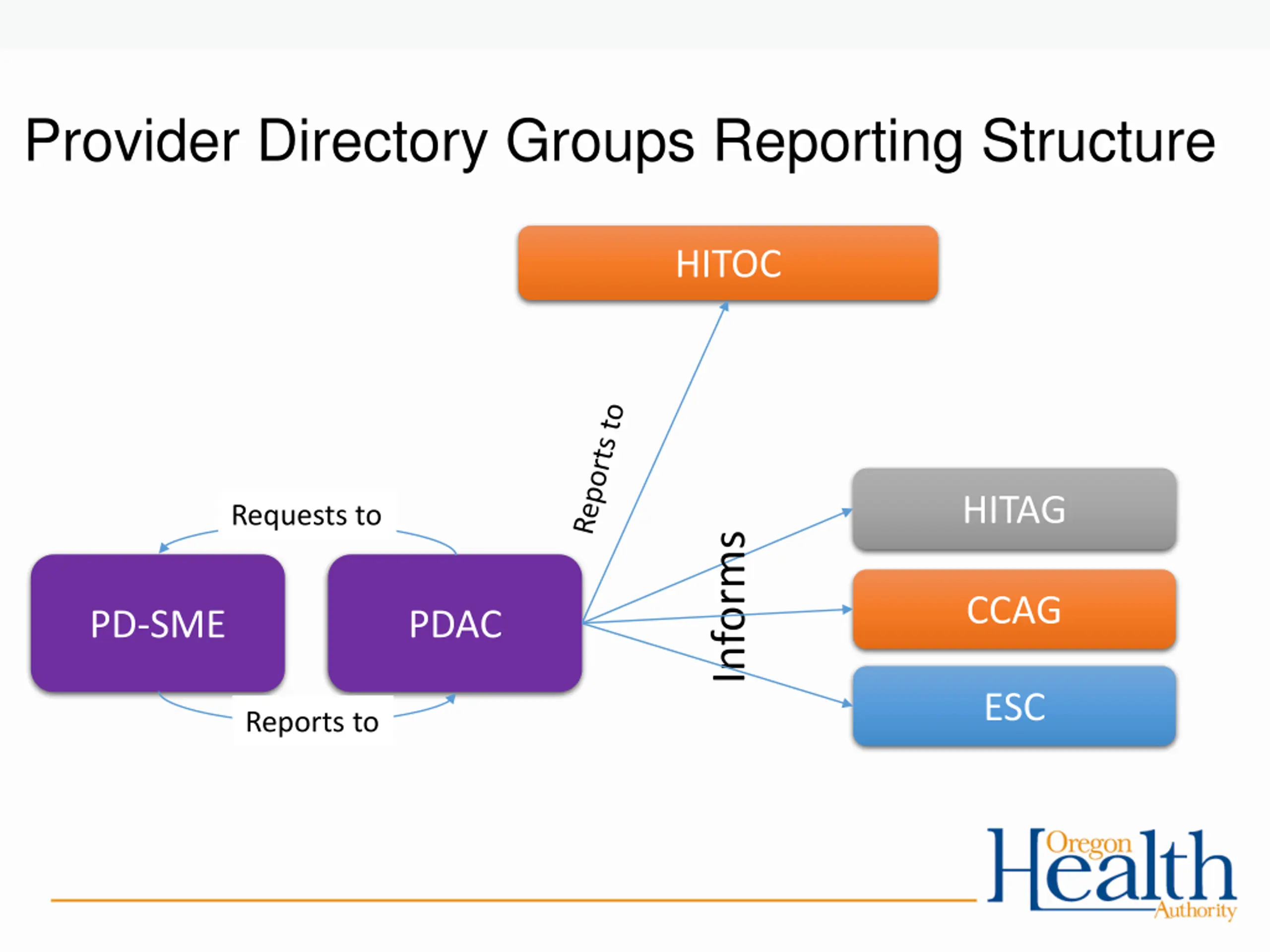

Provider Directory Groups Reporting Structure HITOC HITAG Requests to Informs CCAG PD-SME PDAC ESC Reports to

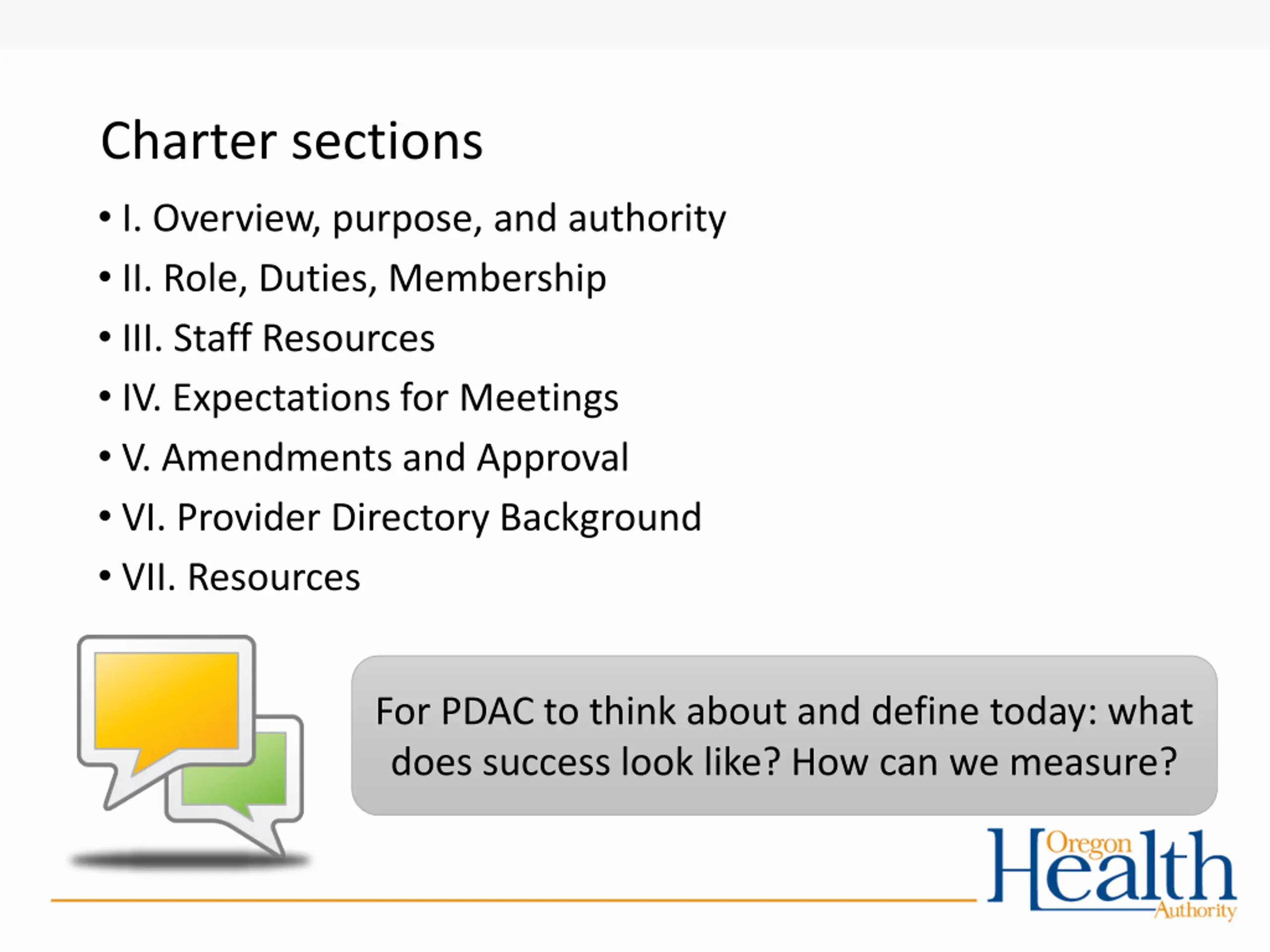

Charter sections I. Overview, purpose, and authority II. Role, Duties, Membership III. Staff Resources IV. Expectations for Meetings V. Amendments and Approval VI. Provider Directory Background VII. Resources For PDAC to think about and define today: what does success look like? How can we measure?

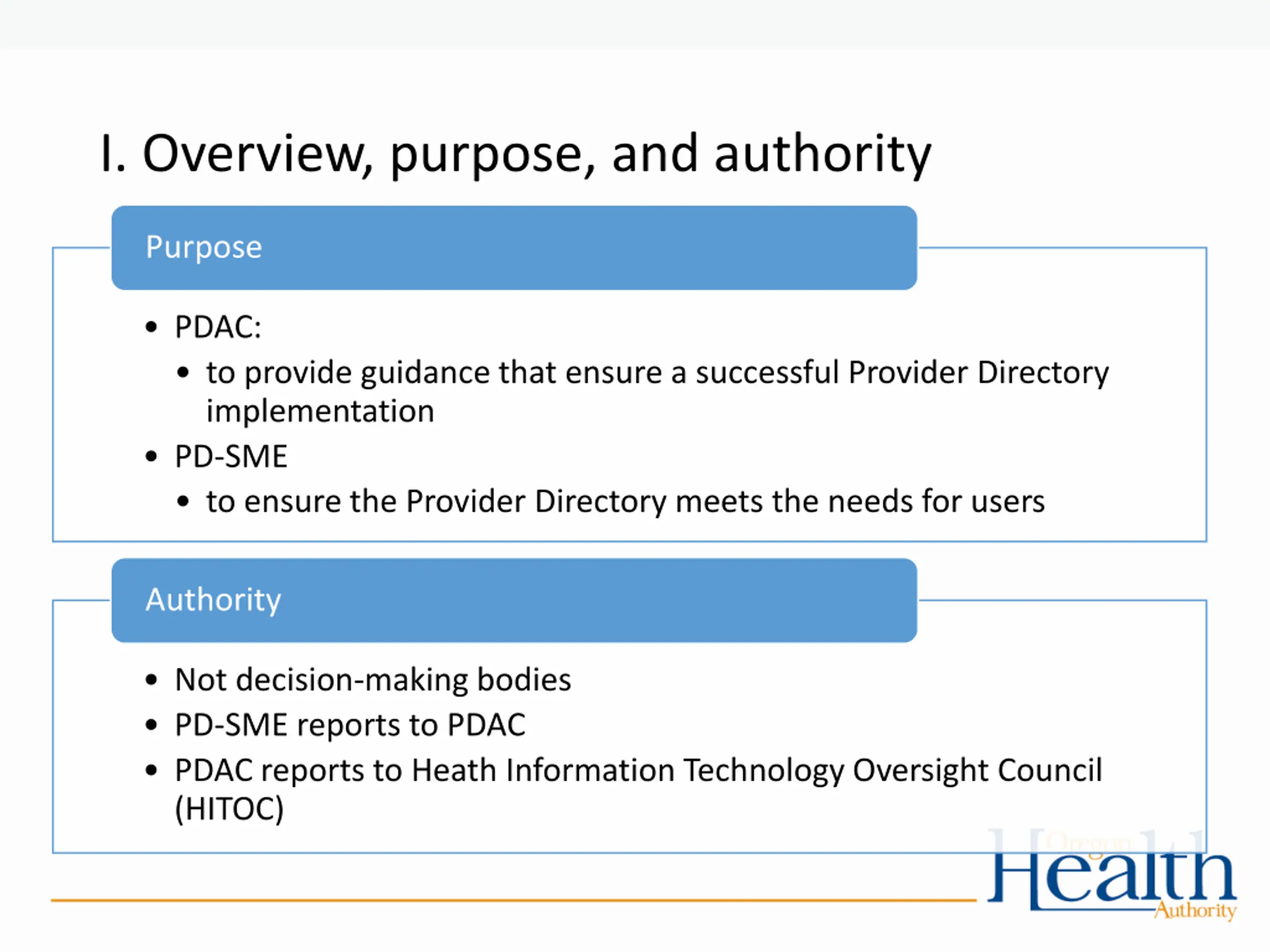

I. Overview, purpose, and authority Purpose PDAC: to provide guidance that ensure a successful Provider Directory implementation PD-SME to ensure the Provider Directory meets the needs for users Authority Not decision-making bodies PD-SME reports to PDAC PDAC reports to Heath Information Technology Oversight Council (HITOC)

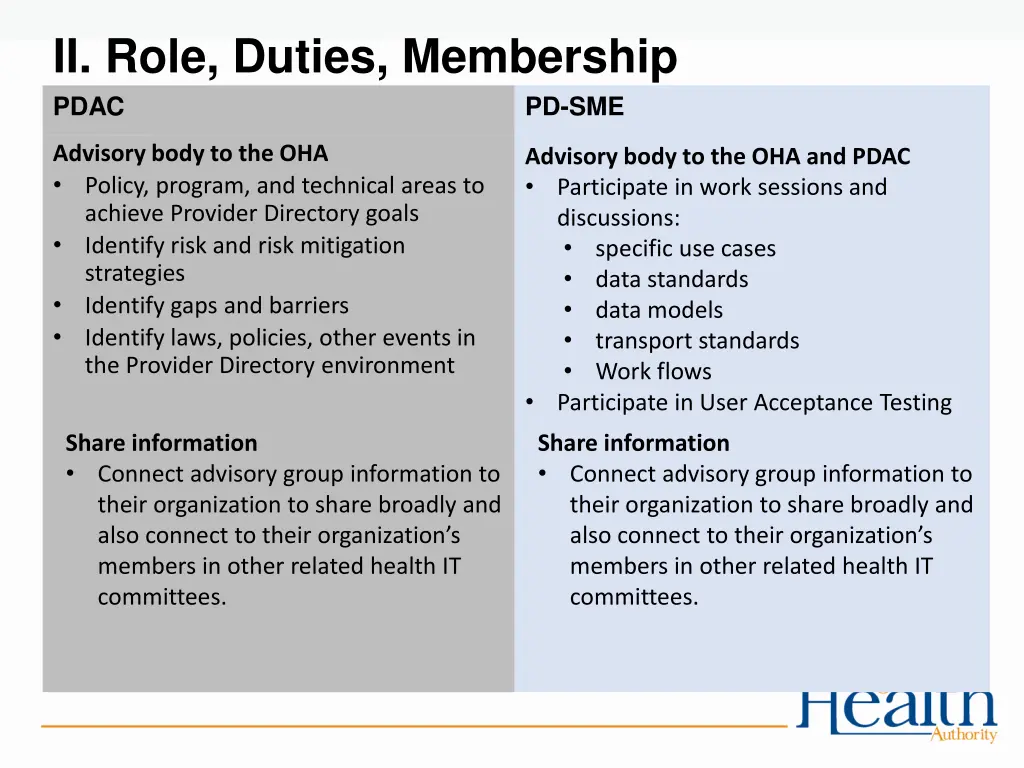

II. Role, Duties, Membership PDAC PD-SME Advisory body to the OHA Policy, program, and technical areas to achieve Provider Directory goals Identify risk and risk mitigation strategies Identify gaps and barriers Identify laws, policies, other events in the Provider Directory environment Advisory body to the OHA and PDAC Participate in work sessions and discussions: specific use cases data standards data models transport standards Work flows Participate in User Acceptance Testing Share information Connect advisory group information to their organization to share broadly and also connect to their organization s members in other related health IT committees. Share information Connect advisory group information to their organization to share broadly and also connect to their organization s members in other related health IT committees.
II. Role, Duties, Membership Decisions Decisions by the group will be made by consensus; PDAC and PD-SME are not decision making bodies but provide critical recommendations and advice to OHA for the implementation of the Provider Directory Membership terms 2017-2018 Membership Composition Hospitals Health Information Exchanges Health Plans CCOs Long term care Clinics and providers Behavioral Health Dental Independent Physician Association Healthcare Research Chair OHA will select the Chair from among the Members; Martin Martinez has been selected to serve as the PDAC chair

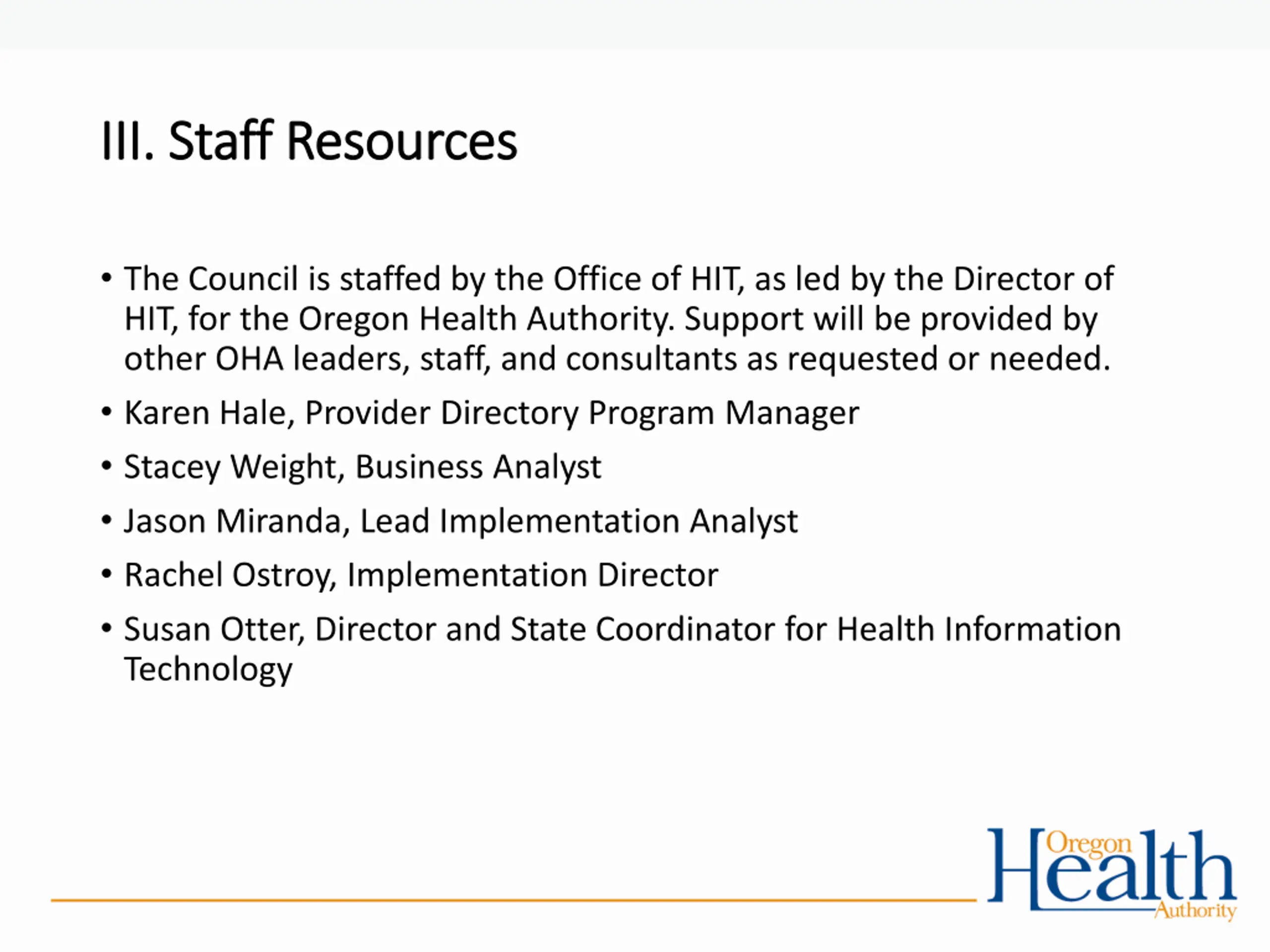

III. III. Staff Resources Staff Resources The Council is staffed by the Office of HIT, as led by the Director of HIT, for the Oregon Health Authority. Support will be provided by other OHA leaders, staff, and consultants as requested or needed. Karen Hale, Provider Directory Program Manager Stacey Weight, Business Analyst Jason Miranda, Lead Implementation Analyst Rachel Ostroy, Implementation Director Susan Otter, Director and State Coordinator for Health Information Technology

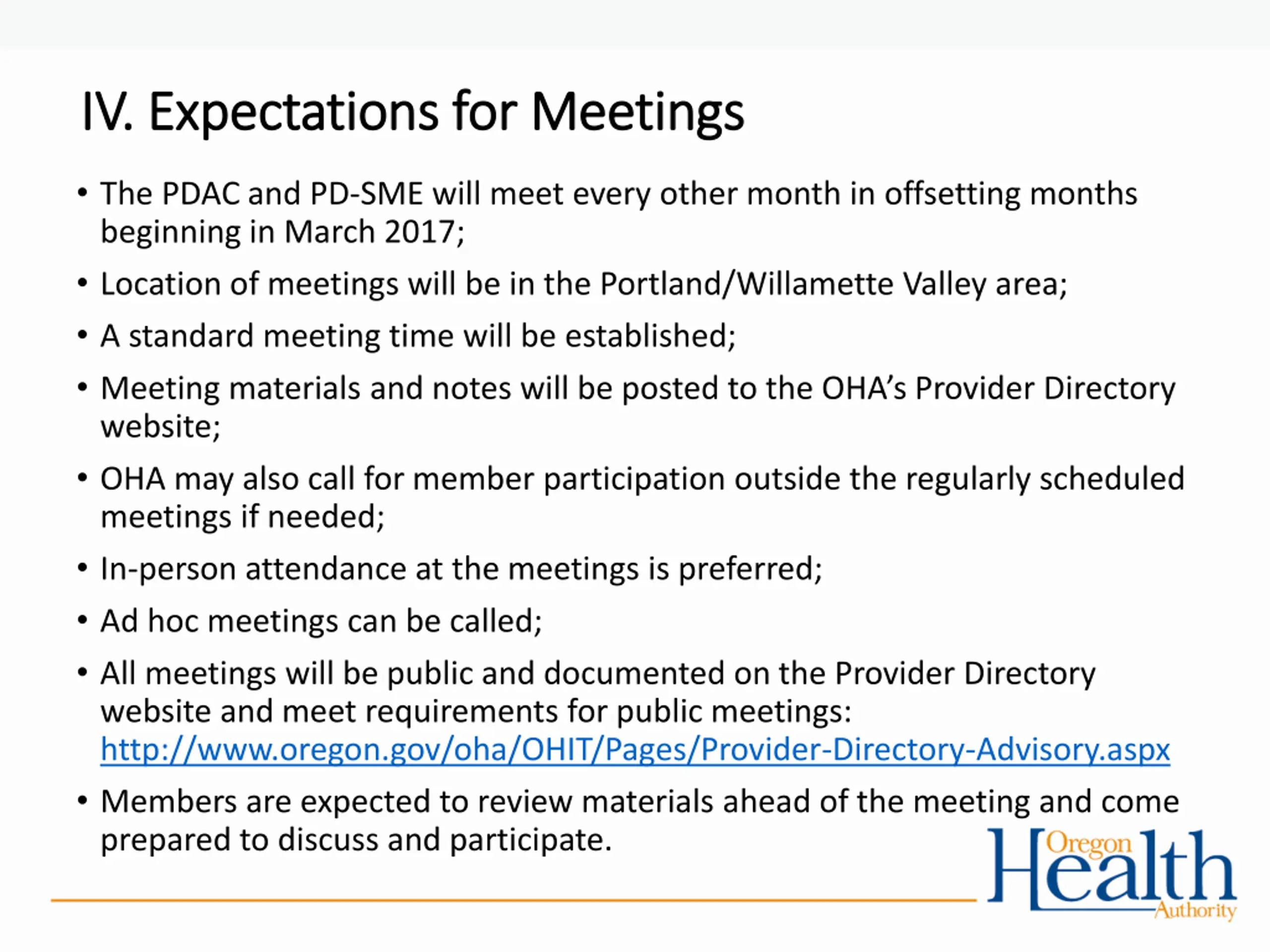

IV. Expectations for Meetings IV. Expectations for Meetings The PDAC and PD-SME will meet every other month in offsetting months beginning in March 2017; Location of meetings will be in the Portland/Willamette Valley area; A standard meeting time will be established; Meeting materials and notes will be posted to the OHA s Provider Directory website; OHA may also call for member participation outside the regularly scheduled meetings if needed; In-person attendance at the meetings is preferred; Ad hoc meetings can be called; All meetings will be public and documented on the Provider Directory website and meet requirements for public meetings: http://www.oregon.gov/oha/OHIT/Pages/Provider-Directory-Advisory.aspx Members are expected to review materials ahead of the meeting and come prepared to discuss and participate.

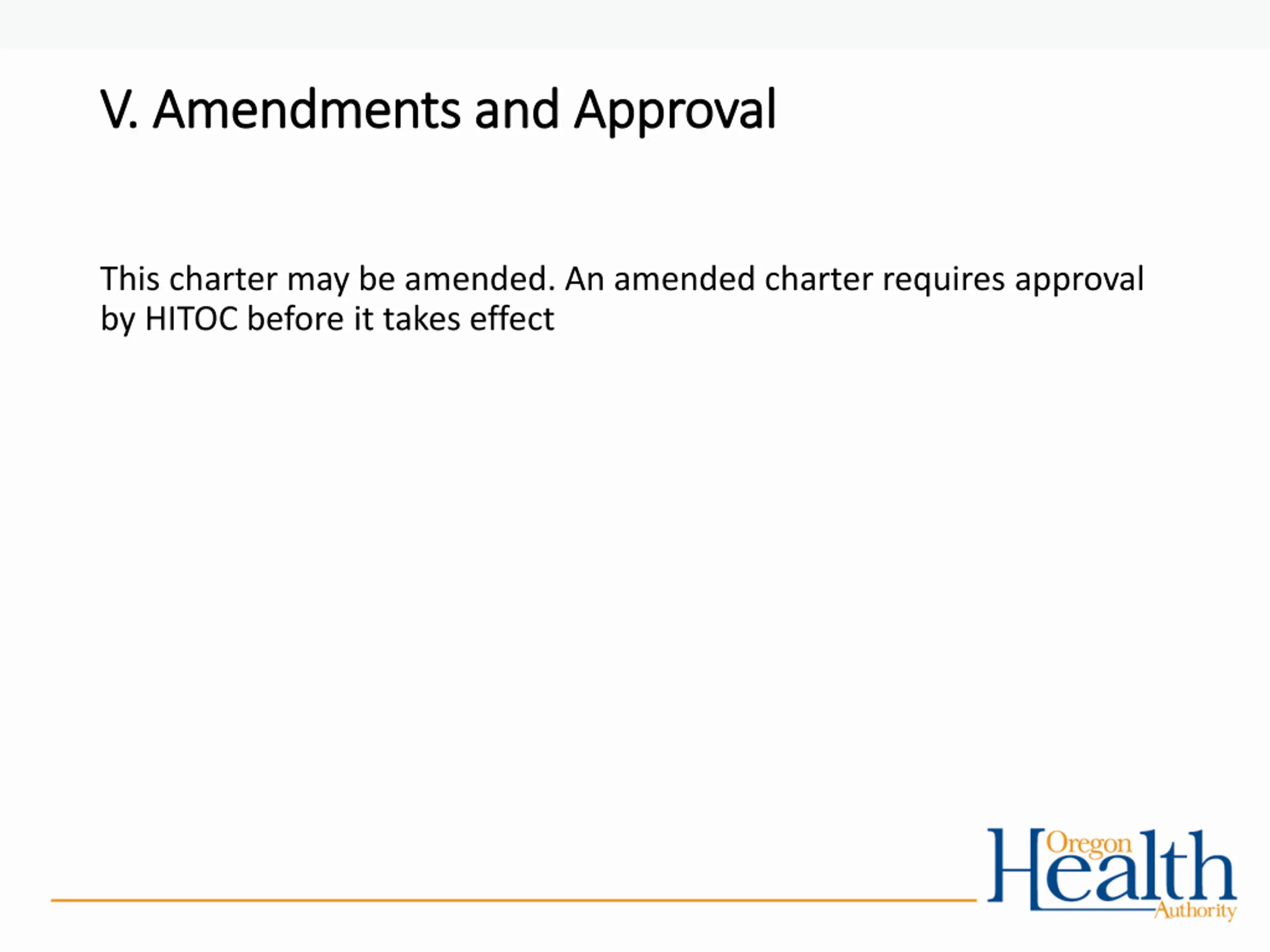

V. Amendments and Approval V. Amendments and Approval This charter may be amended. An amended charter requires approval by HITOC before it takes effect

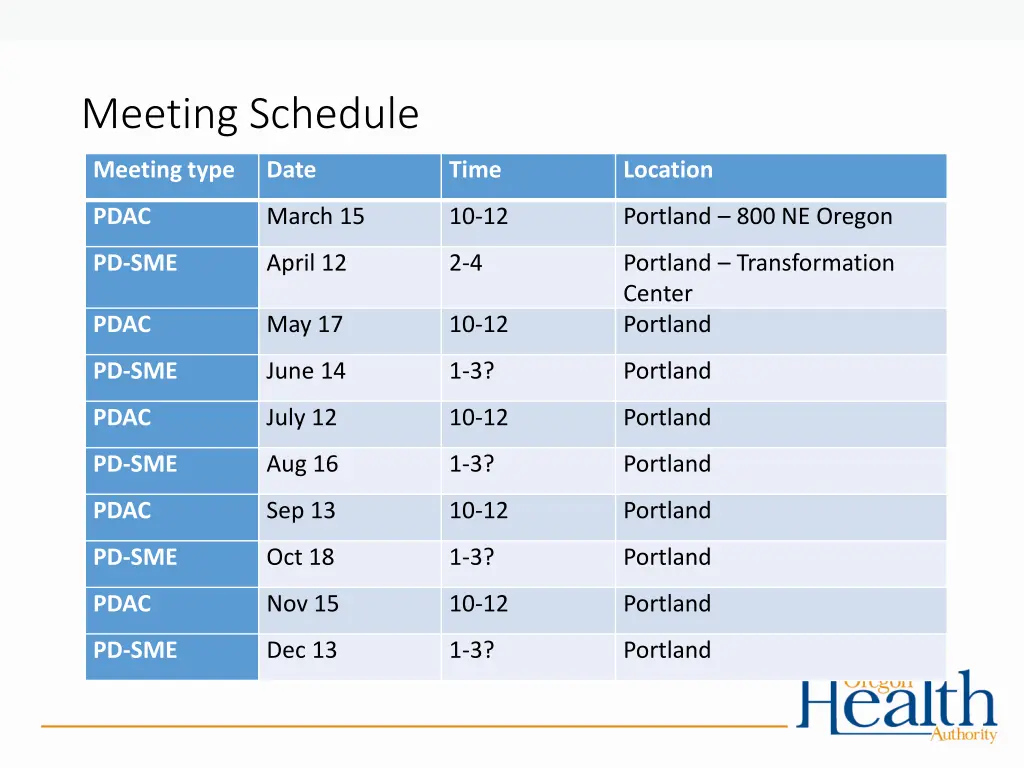

Meeting Schedule Meeting type Date Time Location PDAC March 15 10-12 Portland 800 NE Oregon PD-SME April 12 2-4 Portland Transformation Center Portland PDAC May 17 10-12 PD-SME June 14 1-3? Portland PDAC July 12 10-12 Portland PD-SME Aug 16 1-3? Portland PDAC Sep 13 10-12 Portland PD-SME Oct 18 1-3? Portland PDAC Nov 15 10-12 Portland PD-SME Dec 13 1-3? Portland
Priority buckets of work for the PDAC Governance policies/program/technical Data governance Program governance Communications strategies Marketing and Outreach Adoption and uptake strategies Fee structures and options Review work plan
Group discussion What are the objectives PDAC wants to achieve? What are measures that can be used to determine if we met our objectives?
Provider Directory Refresher, Critical Success Factors, and identification of risks, gaps, and barriers

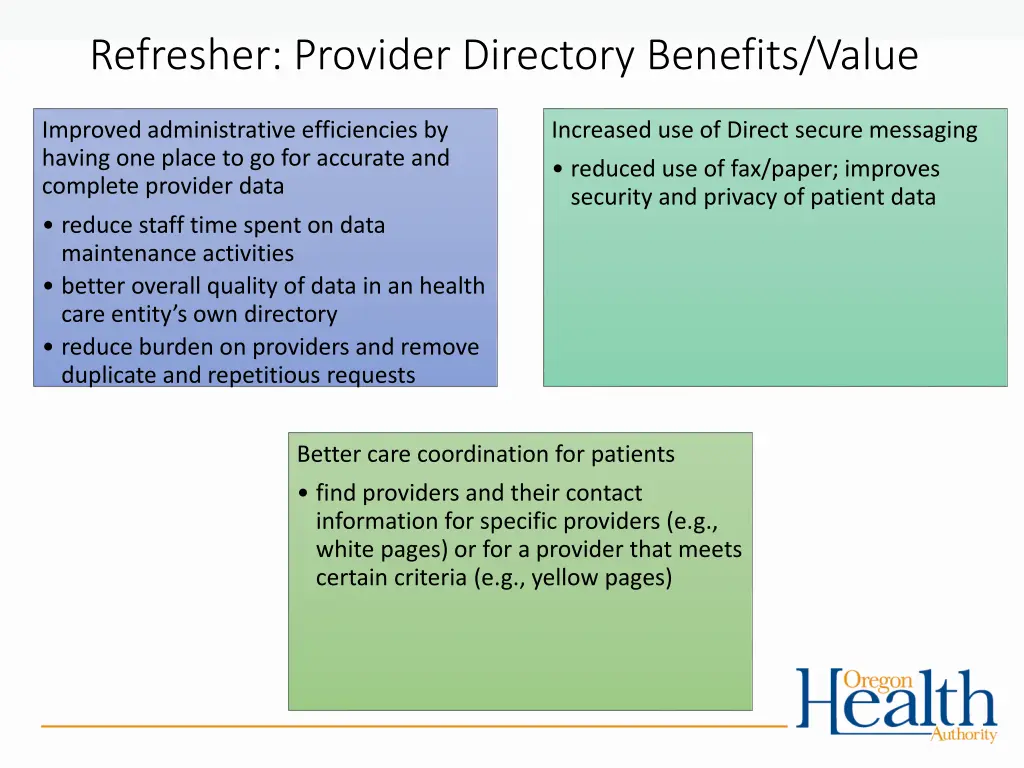

Refresher: Provider Directory Benefits/Value Improved administrative efficiencies by having one place to go for accurate and complete provider data Increased use of Direct secure messaging reduced use of fax/paper; improves security and privacy of patient data reduce staff time spent on data maintenance activities better overall quality of data in an health care entity s own directory reduce burden on providers and remove duplicate and repetitious requests Better care coordination for patients find providers and their contact information for specific providers (e.g., white pages) or for a provider that meets certain criteria (e.g., yellow pages)

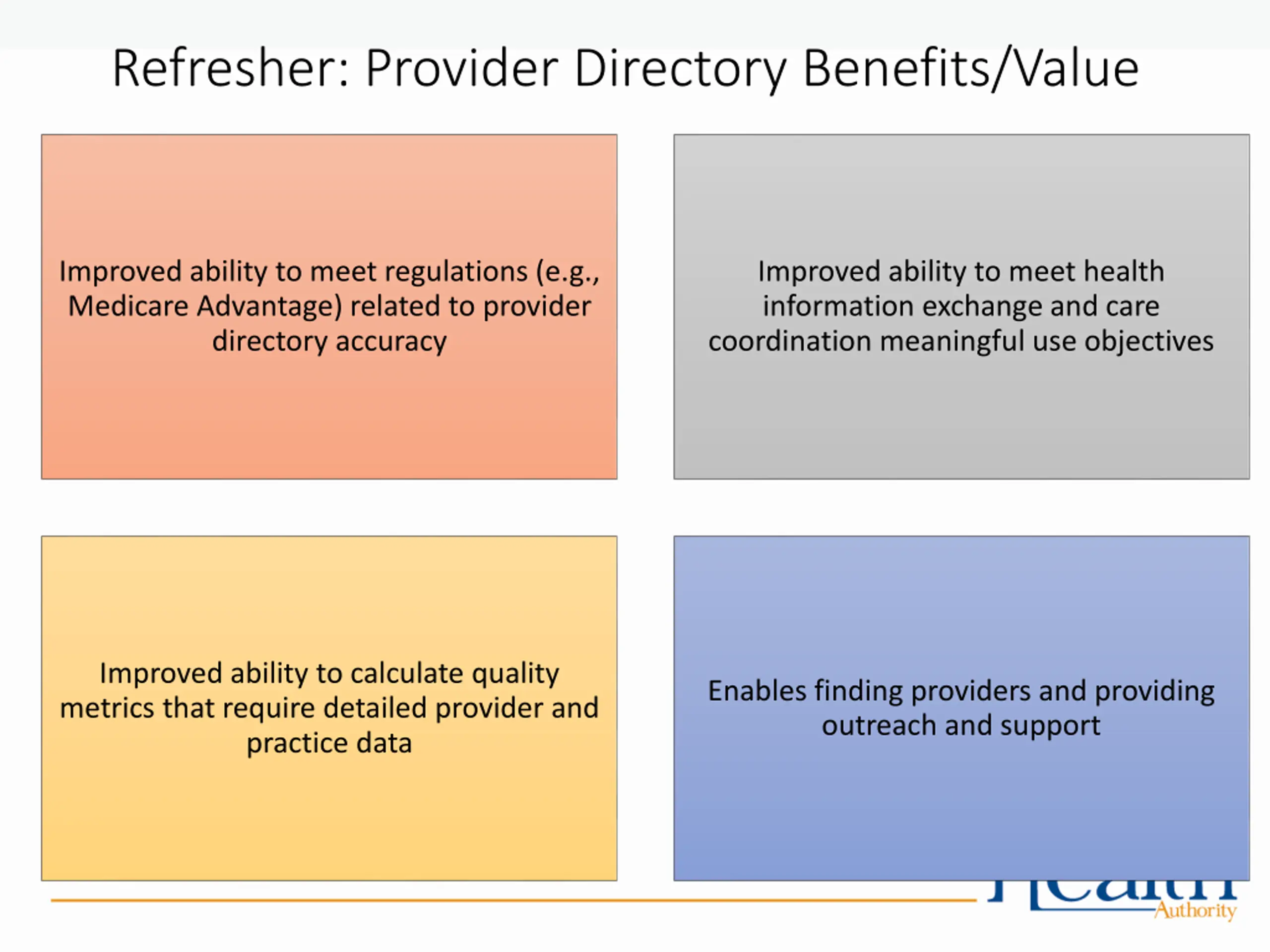

Refresher: Provider Directory Benefits/Value Improved ability to meet regulations (e.g., Medicare Advantage) related to provider directory accuracy Improved ability to meet health information exchange and care coordination meaningful use objectives Improved ability to calculate quality metrics that require detailed provider and practice data Enables finding providers and providing outreach and support

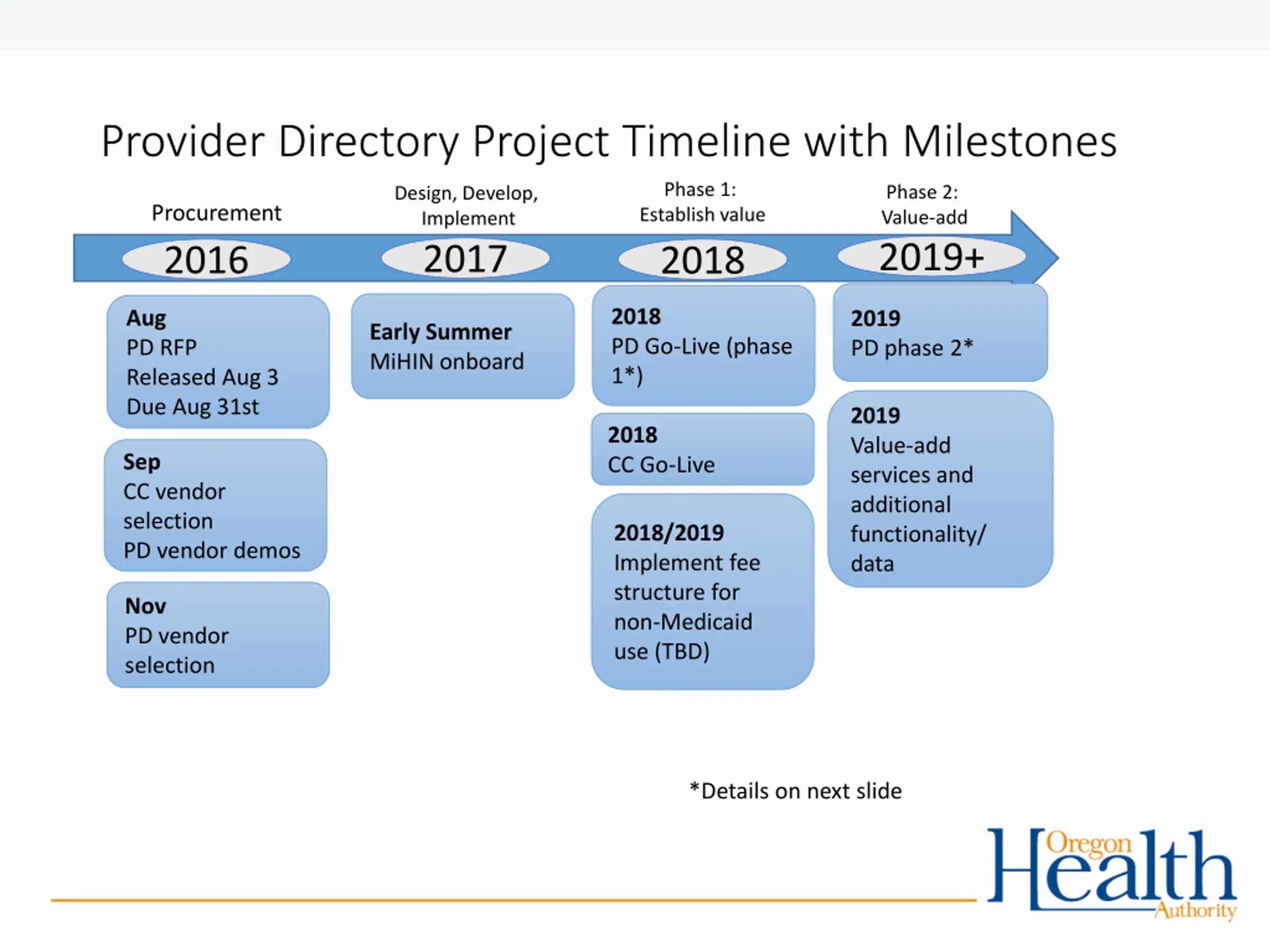

Provider Directory Project Timeline with Milestones Phase 1: Establish value Phase 2: Value-add Design, Develop, Implement Procurement 2019+ 2017 2016 2018 2018 PD Go-Live (phase 1*) Aug PD RFP Released Aug 3 Due Aug 31st 2019 PD phase 2* Early Summer MiHIN onboard 2019 Value-add services and additional functionality/ data 2018 CC Go-Live Sep CC vendor selection PD vendor demos 2018/2019 Implement fee structure for non-Medicaid use (TBD) Nov PD vendor selection *Details on next slide

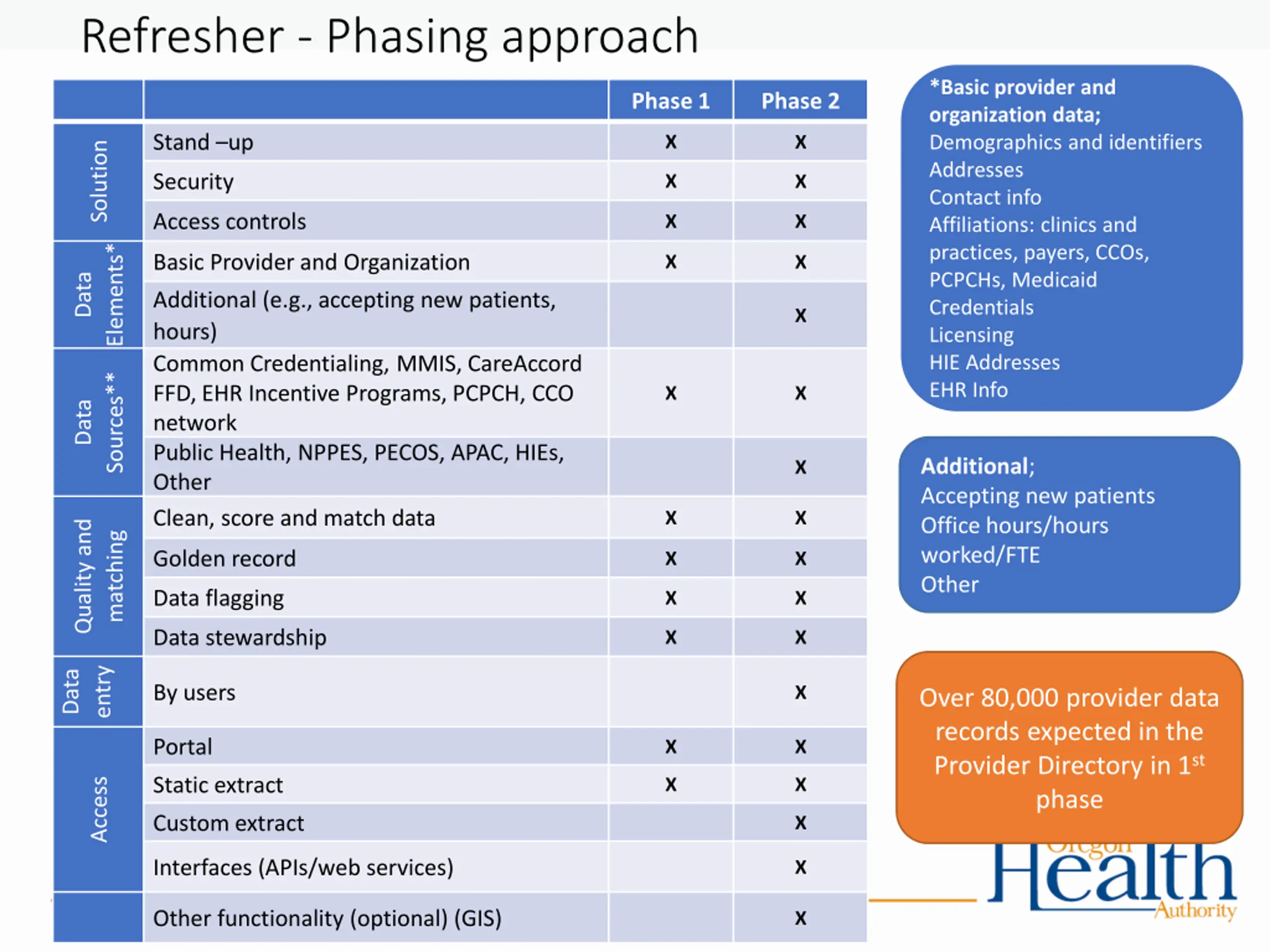

Refresher - Phasing approach *Basic provider and organization data; Demographicsandidentifiers Addresses Contact info Affiliations: clinics and practices, payers, CCOs, PCPCHs, Medicaid Credentials Licensing HIE Addresses EHR Info Phase 1 Phase 2 Stand up X X Solution Security X X Access controls X X Elements* Basic Provider and Organization X X Data Additional (e.g., accepting new patients, hours) Common Credentialing, MMIS, CareAccord FFD, EHR Incentive Programs, PCPCH, CCO network Public Health, NPPES, PECOS, APAC, HIEs, Other Clean, score and match data X Sources** X X Data Additional; Accepting new patients Office hours/hours worked/FTE Other X X X Quality and matching Golden record X X Data flagging X X Data stewardship X X Data entry By users X Over 80,000 provider data records expected in the Provider Directory in 1st phase Portal X X Static extract X X Access Custom extract X Interfaces (APIs/web services) X Other functionality (optional) (GIS) X

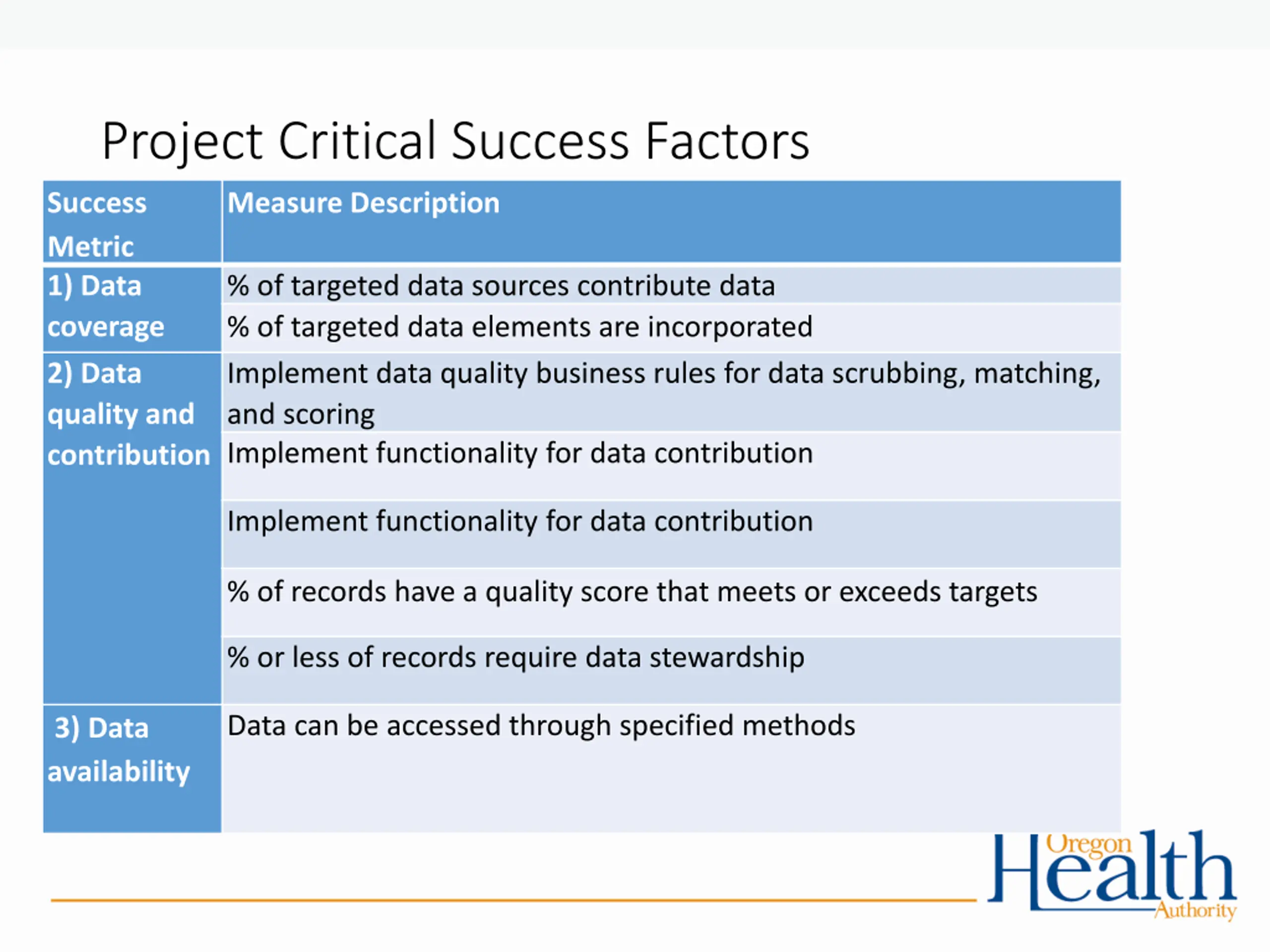

Project Critical Success Factors Success Metric 1) Data coverage % of targeted data elements are incorporated 2) Data quality and contribution Implement functionality for data contribution Measure Description % of targeted data sources contribute data Implement data quality business rules for data scrubbing, matching, and scoring Implement functionality for data contribution % of records have a quality score that meets or exceeds targets % or less of records require data stewardship Data can be accessed through specified methods 3) Data availability

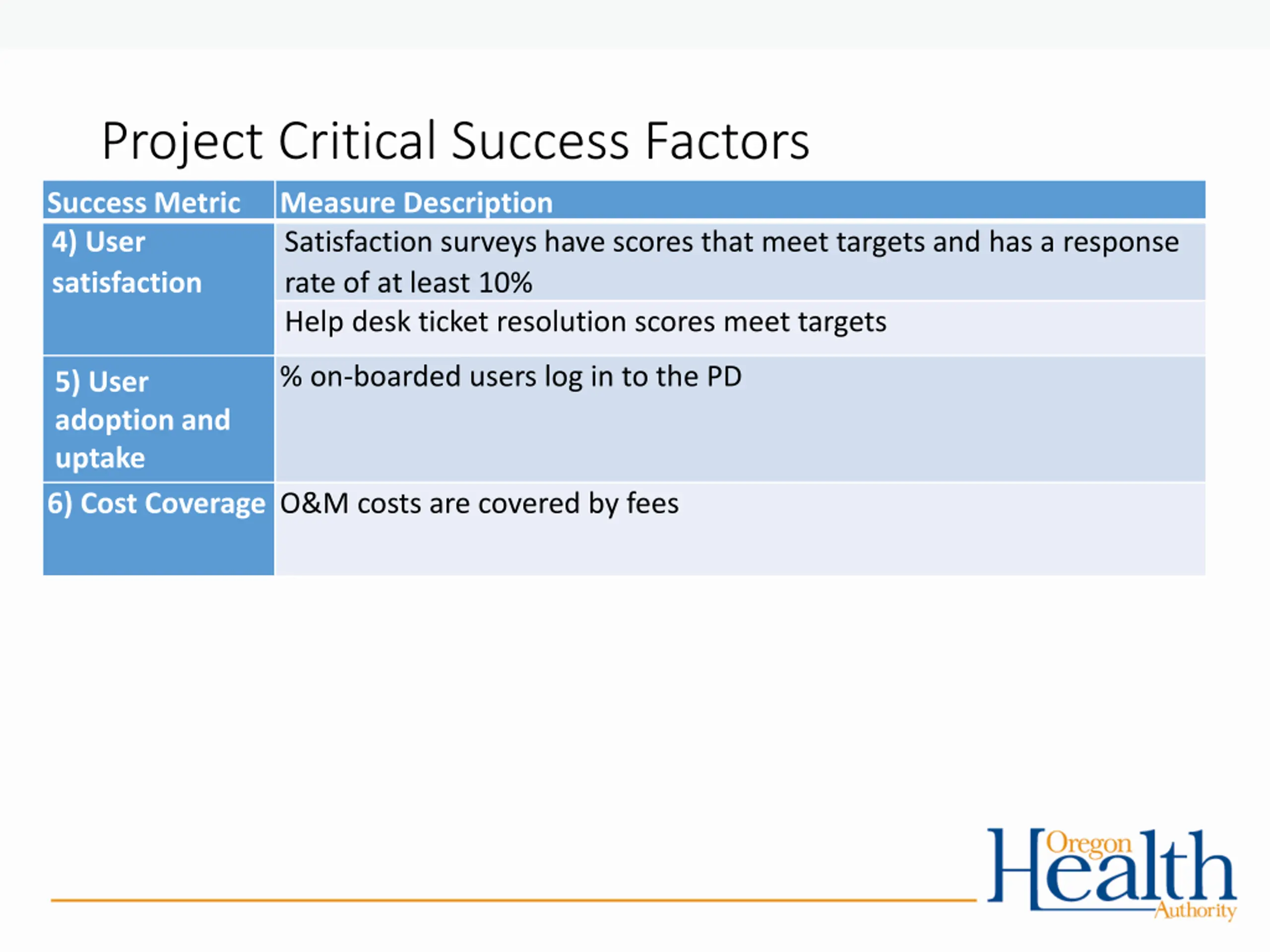

Project Critical Success Factors Success Metric Measure Description 4) User satisfaction rate of at least 10% Help desk ticket resolution scores meet targets Satisfaction surveys have scores that meet targets and has a response % on-boarded users log in to the PD 5) User adoption and uptake 6) Cost Coverage O&M costs are covered by fees
Risks, Barriers, Gaps When implementing the Provider Directory, 1) What are some of the risks that may impact success? On a scale from 1-10 What is the likelihood that will happen? How much could it impact the Provider Directory? What strategies can be used to mitigate risks? 2) What are some of the barriers? gaps? countermeasures?

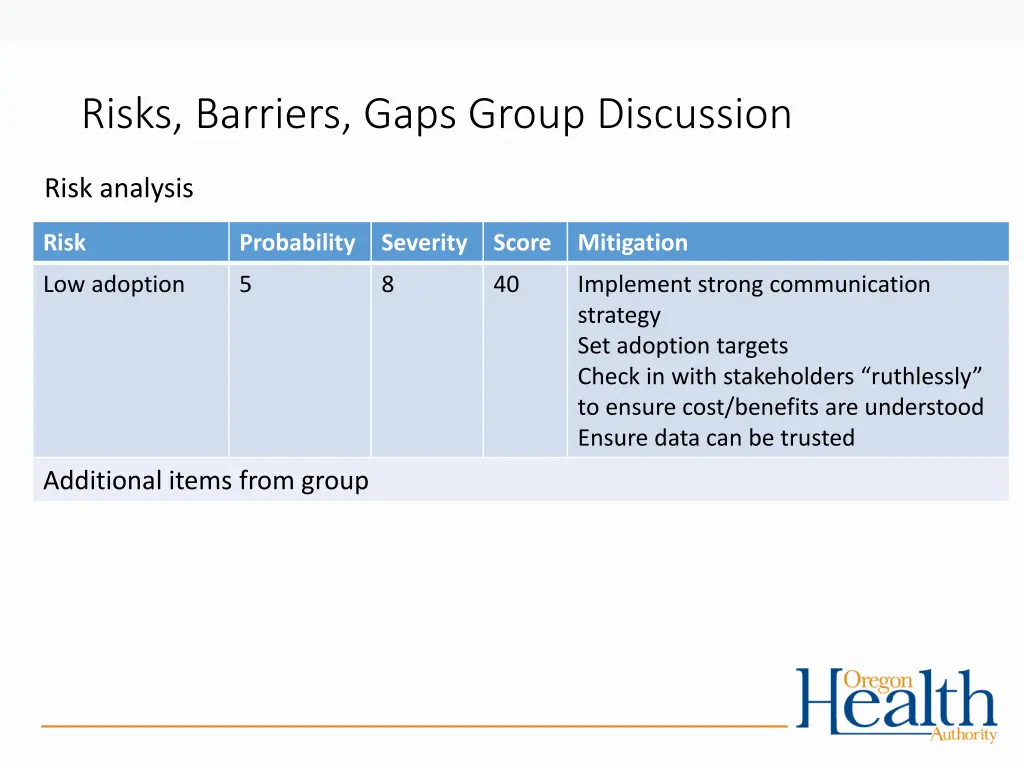

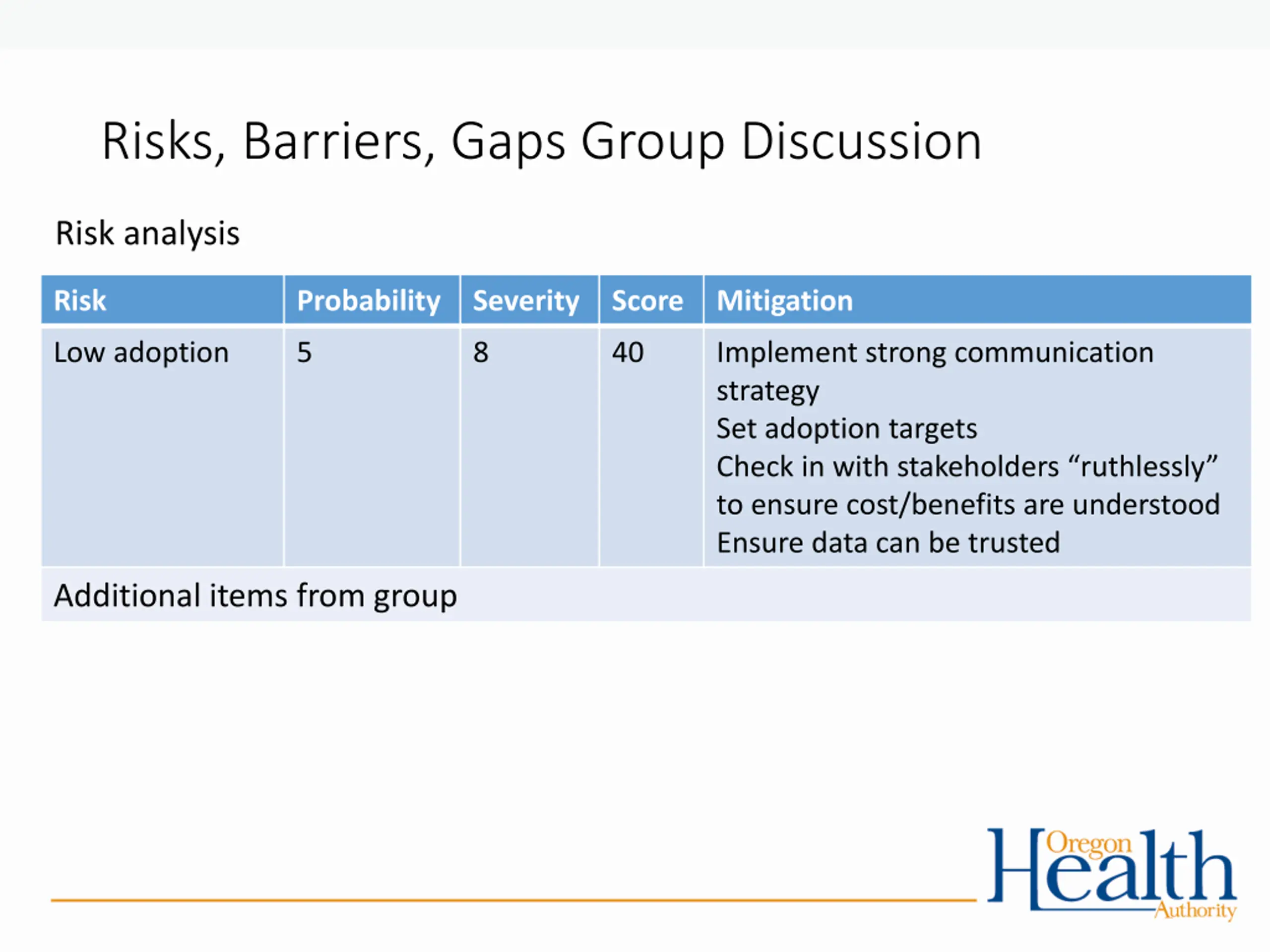

Risks, Barriers, Gaps Group Discussion Risk analysis Risk Probability Severity Score Mitigation Low adoption 5 8 40 Implement strong communication strategy Set adoption targets Check in with stakeholders ruthlessly to ensure cost/benefits are understood Ensure data can be trusted Additional items from group

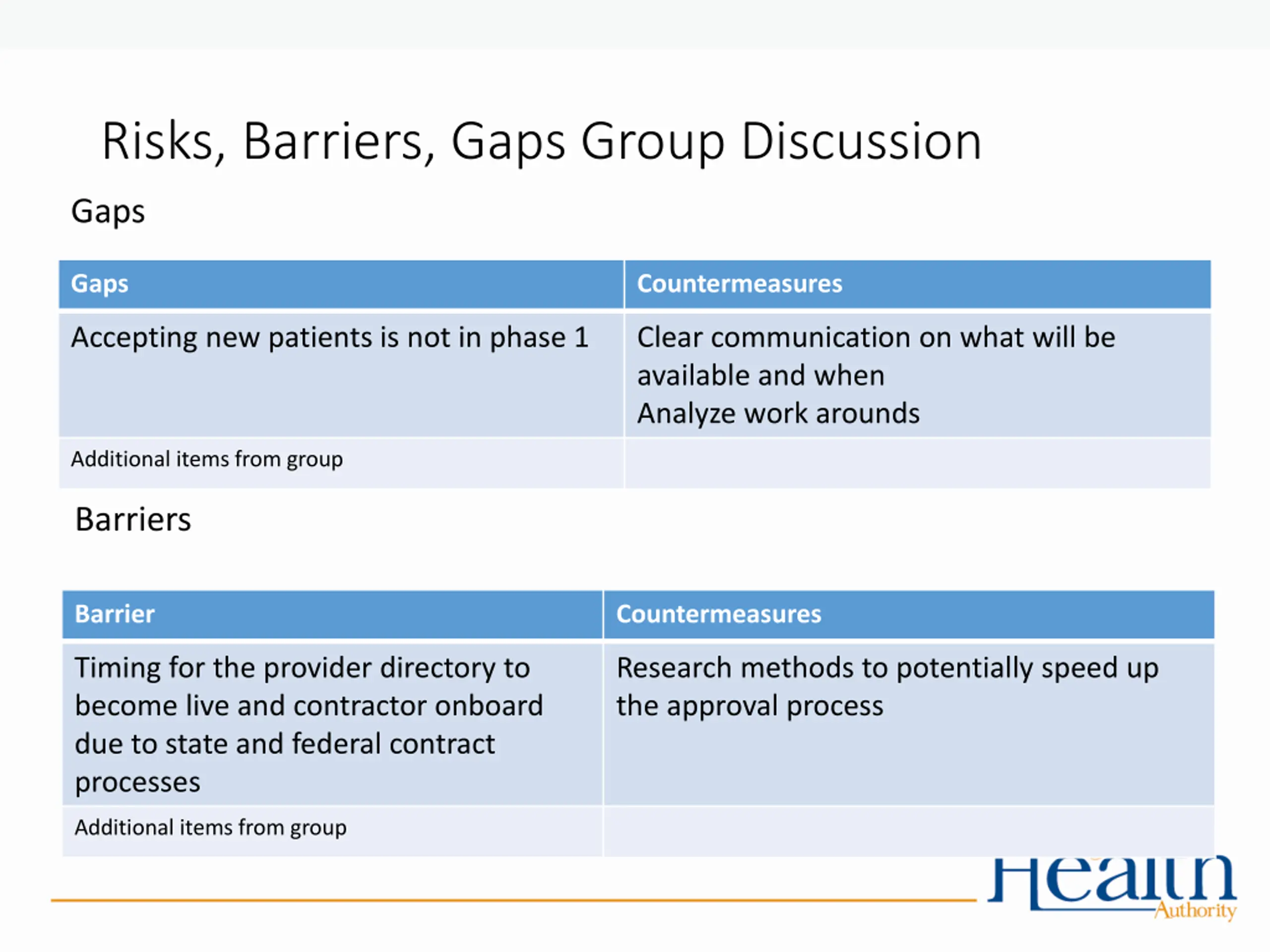

Risks, Barriers, Gaps Group Discussion Gaps Gaps Countermeasures Accepting new patients is not in phase 1 Clear communication on what will be available and when Analyze work arounds Additional items from group Barriers Barrier Countermeasures Timing for the provider directory to become live and contractor onboard due to state and federal contract processes Research methods to potentially speed up the approval process Additional items from group
HIT Portfolio Update Rachel Ostroy Implementation Director

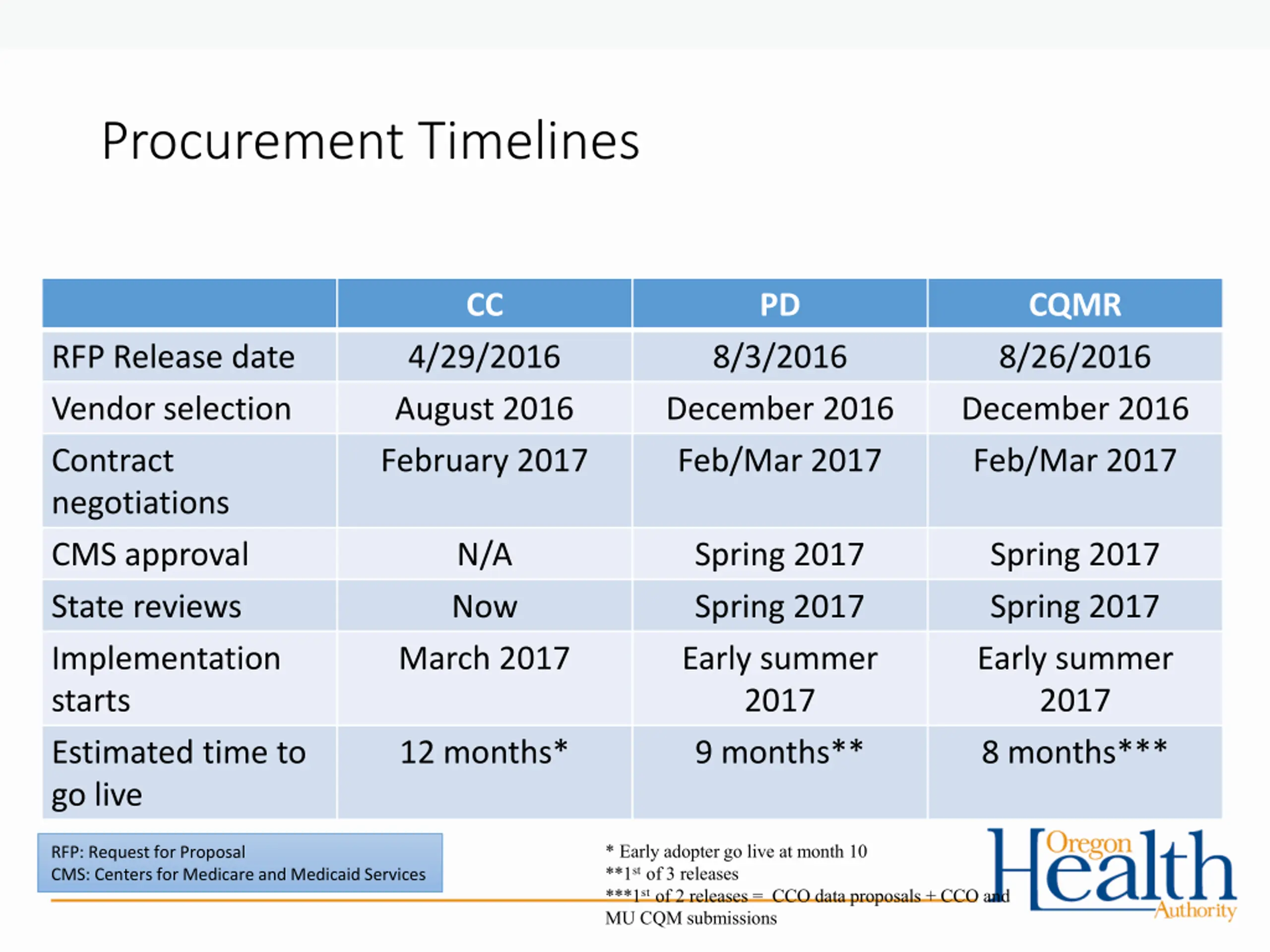

Procurement Timelines CC PD CQMR 8/26/2016 December 2016 Feb/Mar 2017 RFP Release date Vendor selection Contract negotiations CMS approval State reviews Implementation starts Estimated time to go live 4/29/2016 August 2016 February 2017 8/3/2016 December 2016 Feb/Mar 2017 N/A Now Spring 2017 Spring 2017 Early summer 2017 9 months** Spring 2017 Spring 2017 Early summer 2017 8 months*** March 2017 12 months* * Early adopter go live at month 10 **1st of 3 releases ***1st of 2 releases = CCO data proposals + CCO and MU CQM submissions RFP: Request for Proposal CMS: Centers for Medicare and Medicaid Services

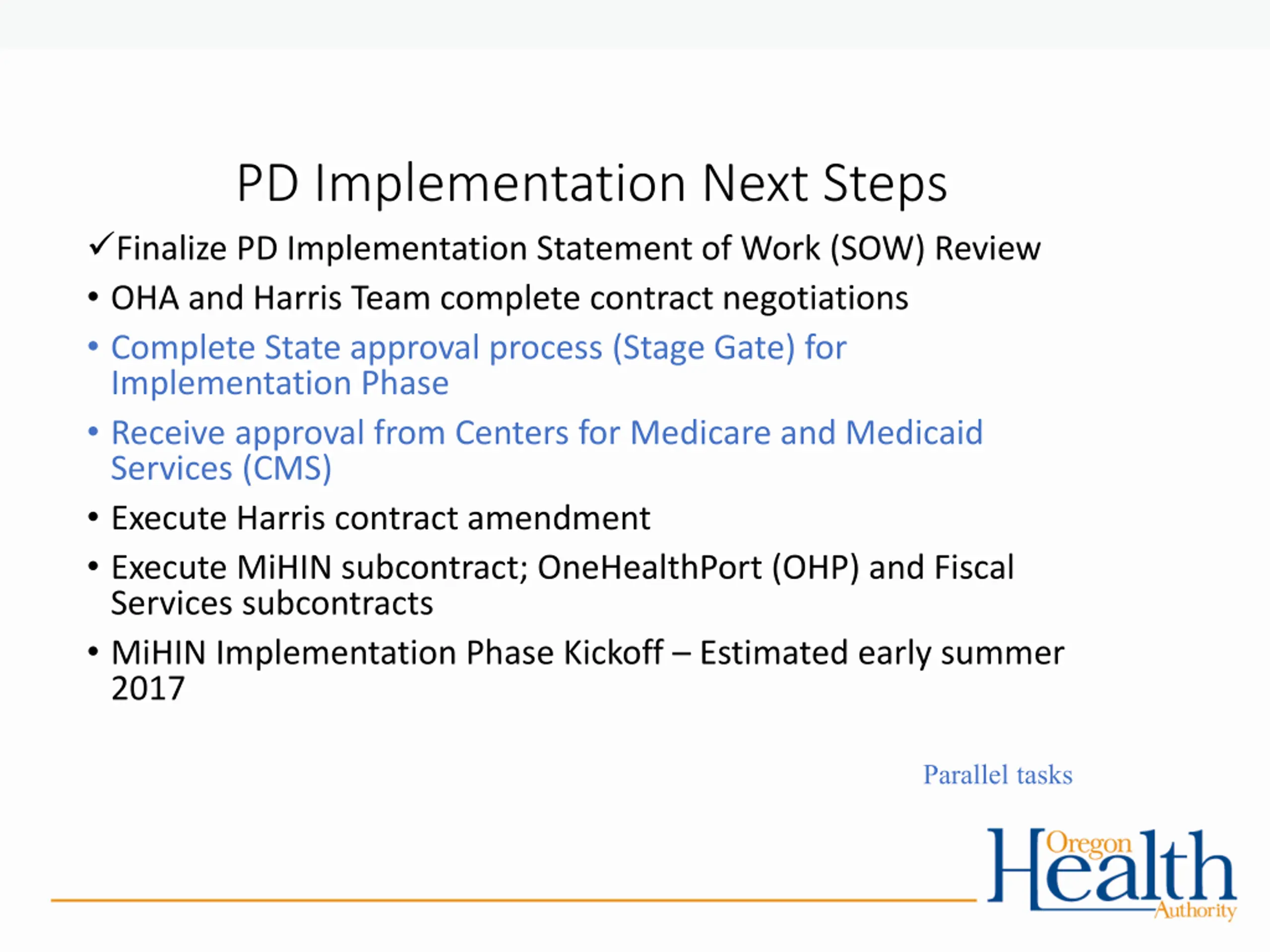

PD Implementation Next Steps Finalize PD Implementation Statement of Work (SOW) Review OHA and Harris Team complete contract negotiations Complete State approval process (Stage Gate) for Implementation Phase Receive approval from Centers for Medicare and Medicaid Services (CMS) Execute Harris contract amendment Execute MiHIN subcontract; OneHealthPort (OHP) and Fiscal Services subcontracts MiHIN Implementation Phase Kickoff Estimated early summer 2017 Parallel tasks
The Oregon Common Credentialing Program March 15, 2017 Melissa Isavoran, Program Manager Health Policy & Analytics Office of Health Information Technology

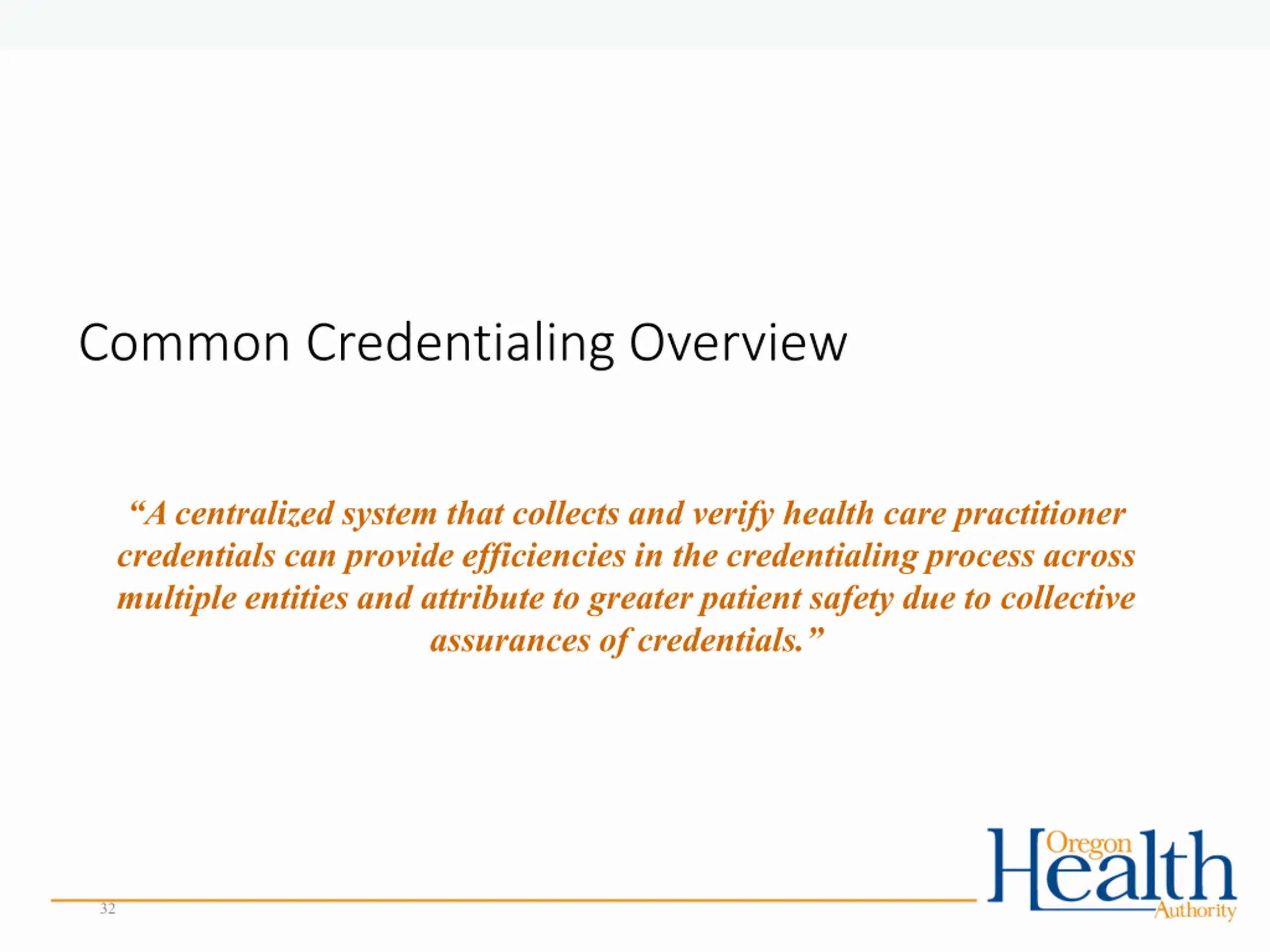

Common Credentialing Overview A centralized system that collects and verify health care practitioner credentials can provide efficiencies in the credentialing process across multiple entities and attribute to greater patient safety due to collective assurances of credentials. 32

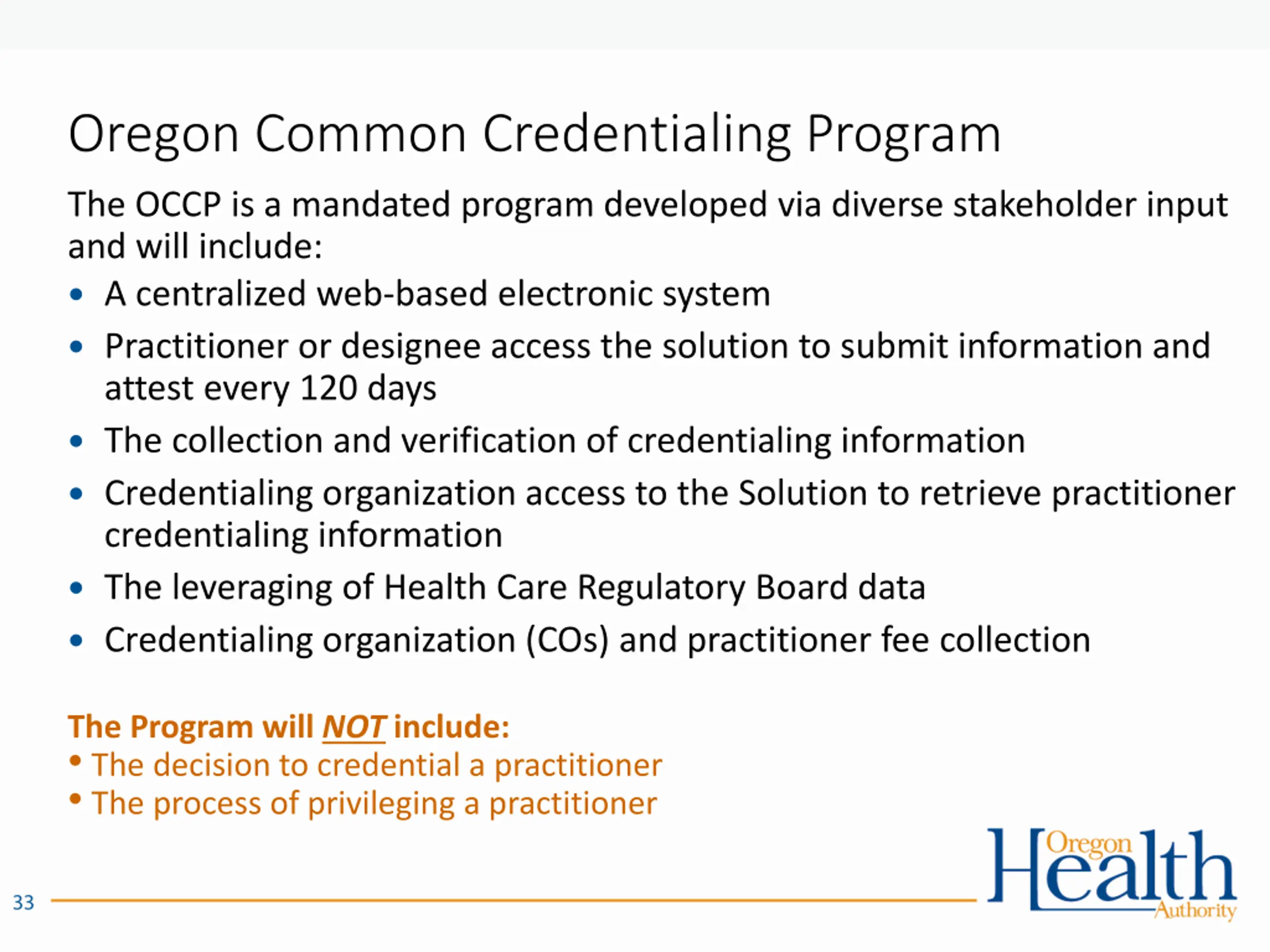

Oregon Common Credentialing Program The OCCP is a mandated program developed via diverse stakeholder input and will include: A centralized web-based electronic system Practitioner or designee access the solution to submit information and attest every 120 days The collection and verification of credentialing information Credentialing organization access to the Solution to retrieve practitioner credentialing information The leveraging of Health Care Regulatory Board data Credentialing organization (COs) and practitioner fee collection The Program will NOT include: The decision to credential a practitioner The process of privileging a practitioner

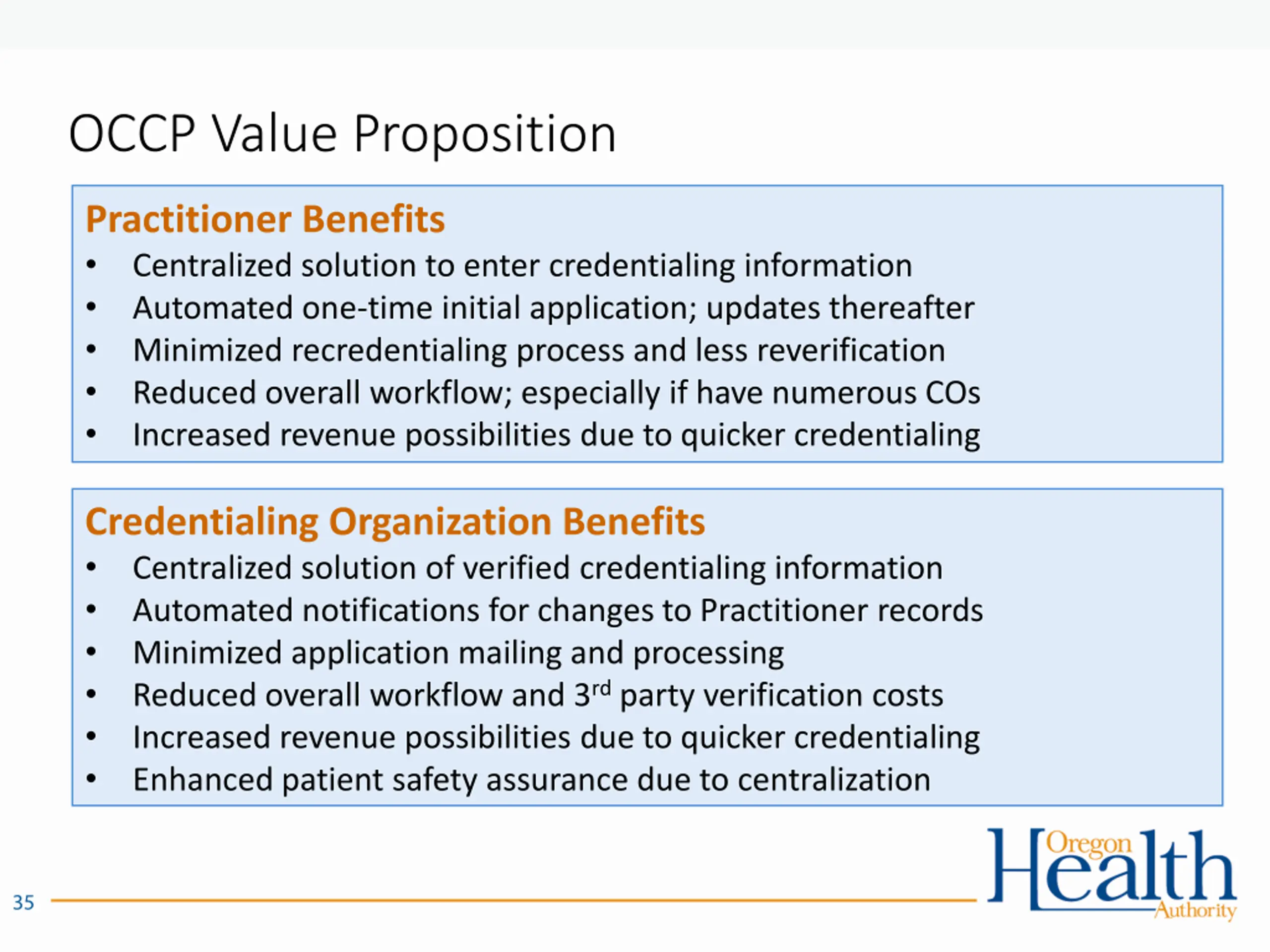

OCCP Value Proposition Practitioner Benefits Centralized solution to enter credentialing information Automated one-time initial application; updates thereafter Minimized recredentialing process and less reverification Reduced overall workflow; especially if have numerous COs Increased revenue possibilities due to quicker credentialing Credentialing Organization Benefits Centralized solution of verified credentialing information Automated notifications for changes to Practitioner records Minimized application mailing and processing Reduced overall workflow and 3rd party verification costs Increased revenue possibilities due to quicker credentialing Enhanced patient safety assurance due to centralization

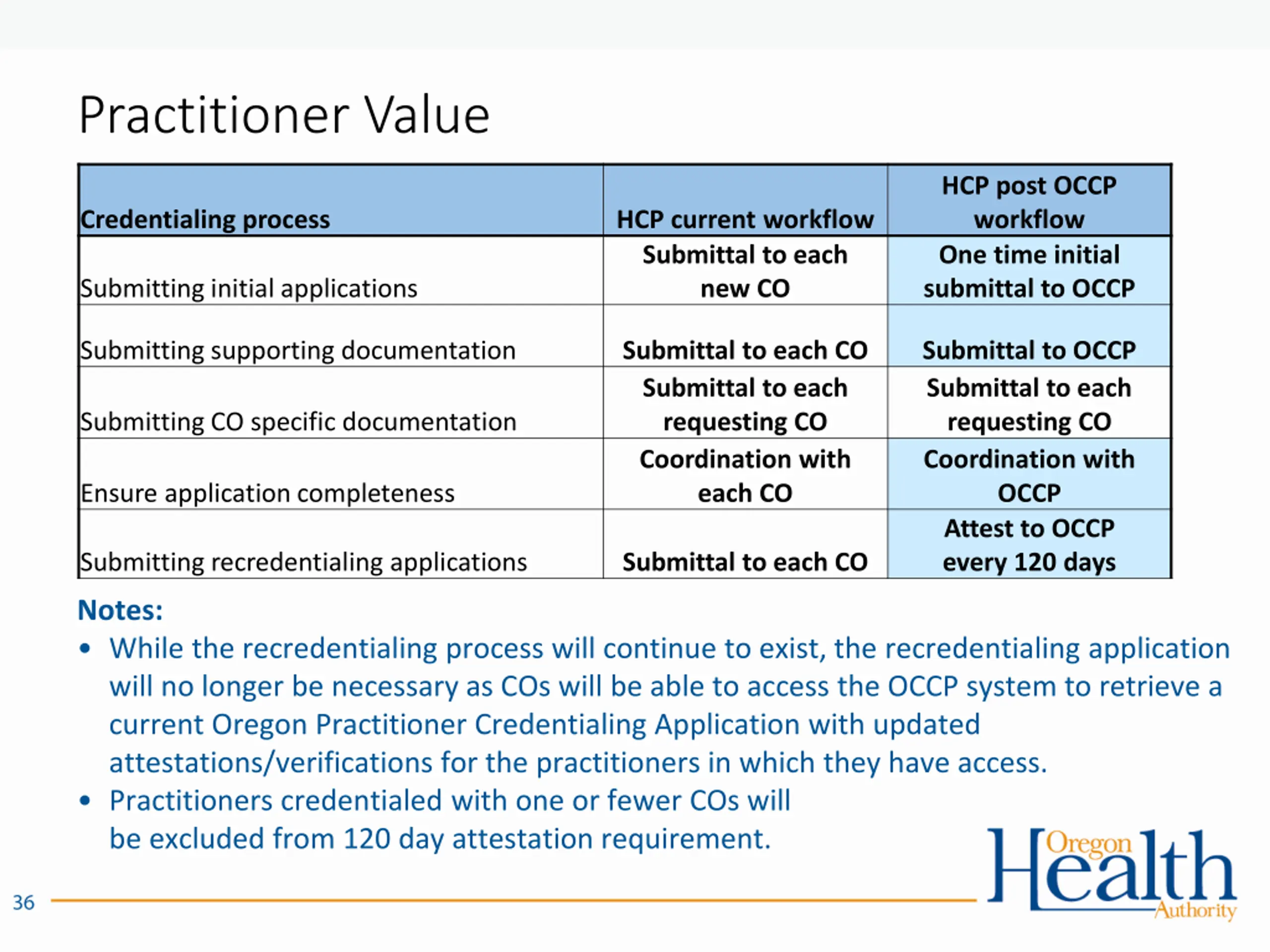

Practitioner Value HCP post OCCP workflow One time initial submittal to OCCP Credentialing process HCP current workflow Submittal to each new CO Submitting initial applications Submitting supporting documentation Submittal to each CO Submittal to each requesting CO Coordination with each CO Submittal to OCCP Submittal to each requesting CO Coordination with OCCP Attest to OCCP every 120 days Submitting CO specific documentation Ensure application completeness Submitting recredentialing applications Submittal to each CO Notes: While the recredentialing process will continue to exist, the recredentialing application will no longer be necessary as COs will be able to access the OCCP system to retrieve a current Oregon Practitioner Credentialing Application with updated attestations/verifications for the practitioners in which they have access. Practitioners credentialed with one or fewer COs will be excluded from 120 day attestation requirement.

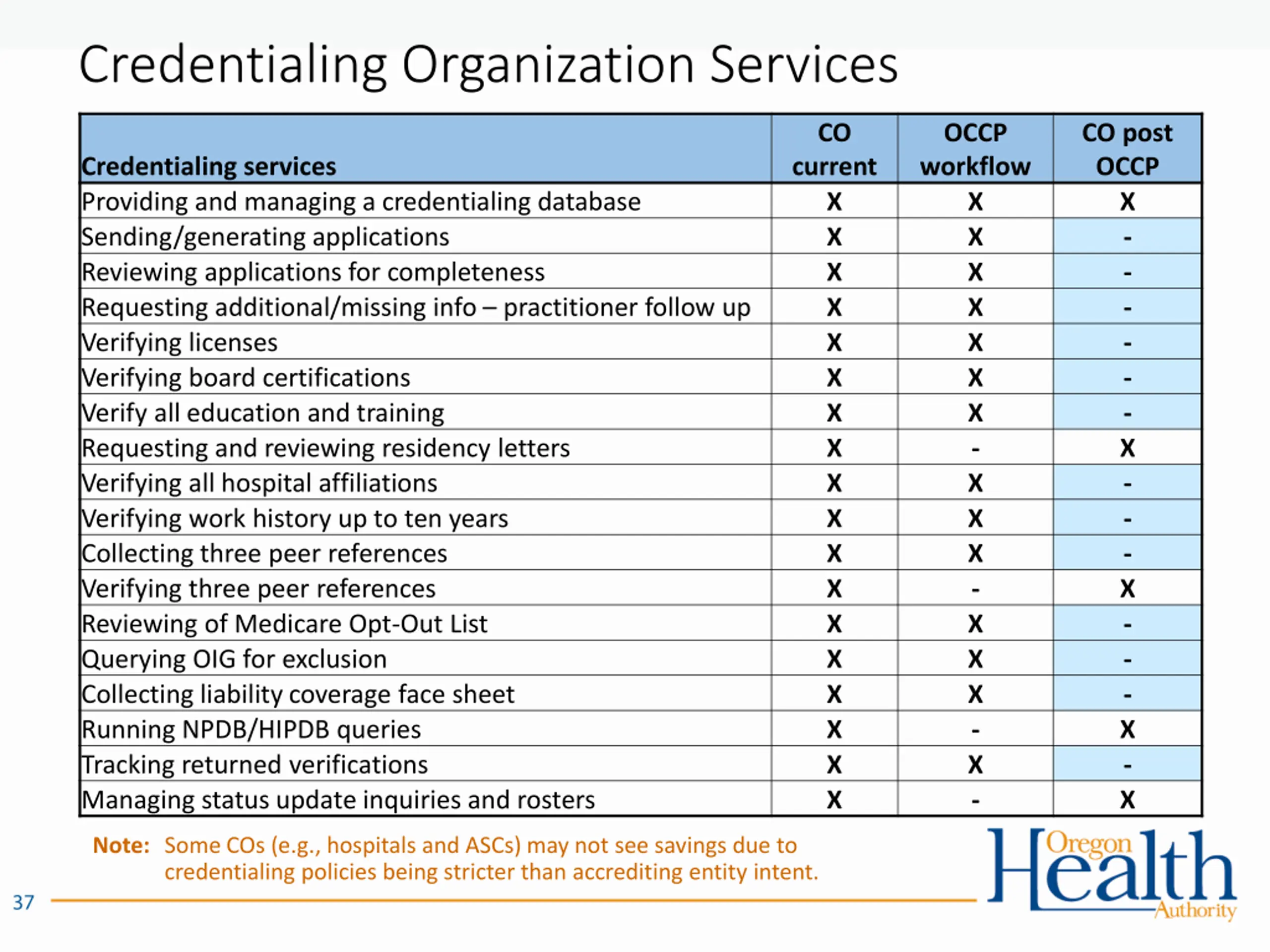

Credentialing Organization Services CO OCCP workflow X X X X X X X - X X X - X X X - X - CO post OCCP X - - - - - - X - - - X - - - X - X Credentialing services Providing and managing a credentialing database Sending/generating applications Reviewing applications for completeness Requesting additional/missing info practitioner follow up Verifying licenses Verifying board certifications Verify all education and training Requesting and reviewing residency letters Verifying all hospital affiliations Verifying work history up to ten years Collecting three peer references Verifying three peer references Reviewing of Medicare Opt-Out List Querying OIG for exclusion Collecting liability coverage face sheet Running NPDB/HIPDB queries Tracking returned verifications Managing status update inquiries and rosters current X X X X X X X X X X X X X X X X X X Note: Some COs (e.g., hospitals and ASCs) may not see savings due to credentialing policies being stricter than accrediting entity intent.

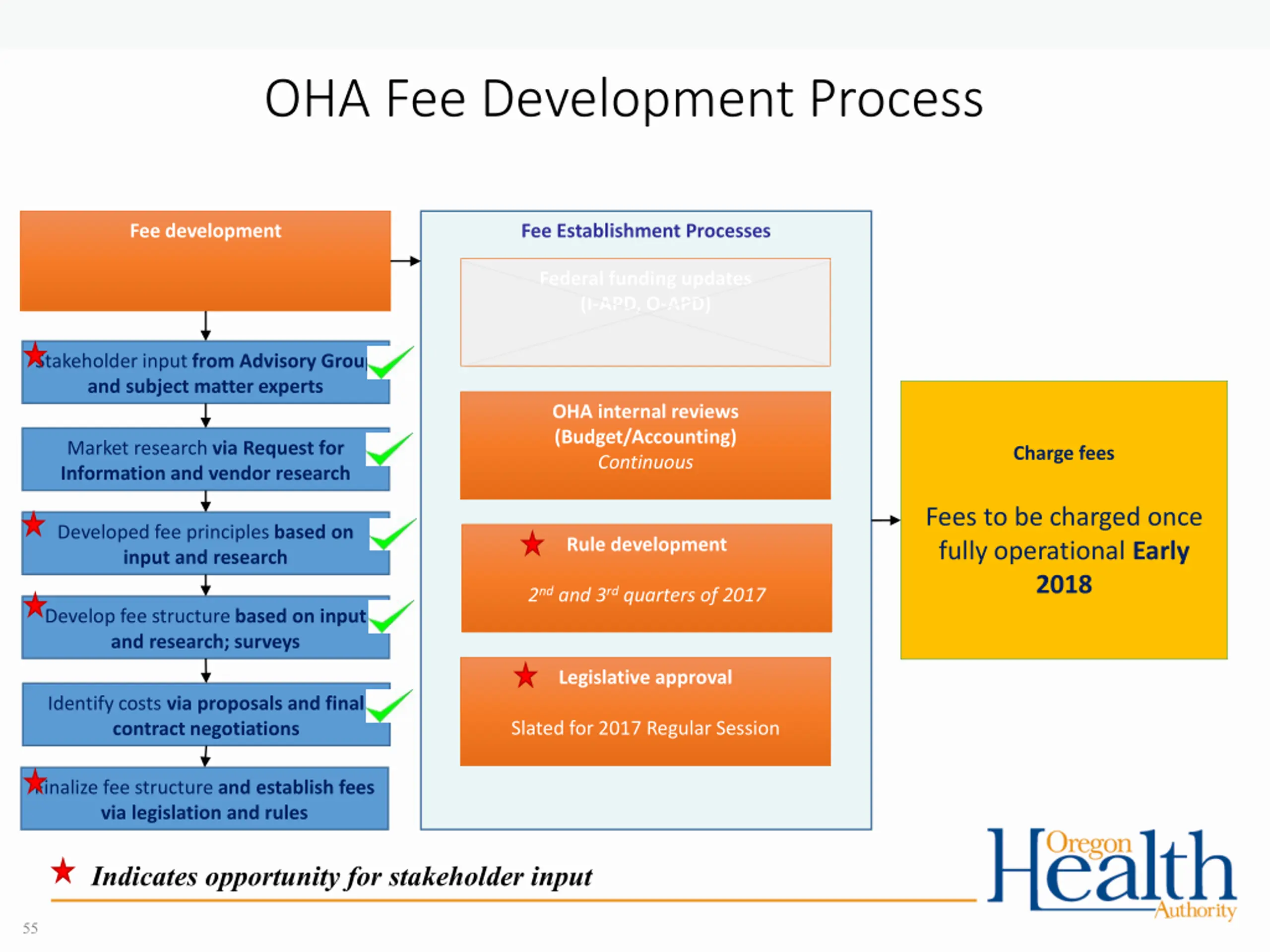

OHA Fee Development Process Fee development Fee Establishment Processes Federal funding updates (I-APD, O-APD) Stakeholder input from Advisory Group and subject matter experts OHA internal reviews (Budget/Accounting) Continuous Market research via Request for Information and vendor research Charge fees Fees to be charged once fully operational Early 2018 Developed fee principles based on input and research Rule development 2nd and 3rd quarters of 2017 Develop fee structure based on input and research; surveys Legislative approval Identify costs via proposals and final contract negotiations Slated for 2017 Regular Session Finalize fee structure and establish fees via legislation and rules Indicates opportunity for stakeholder input 55

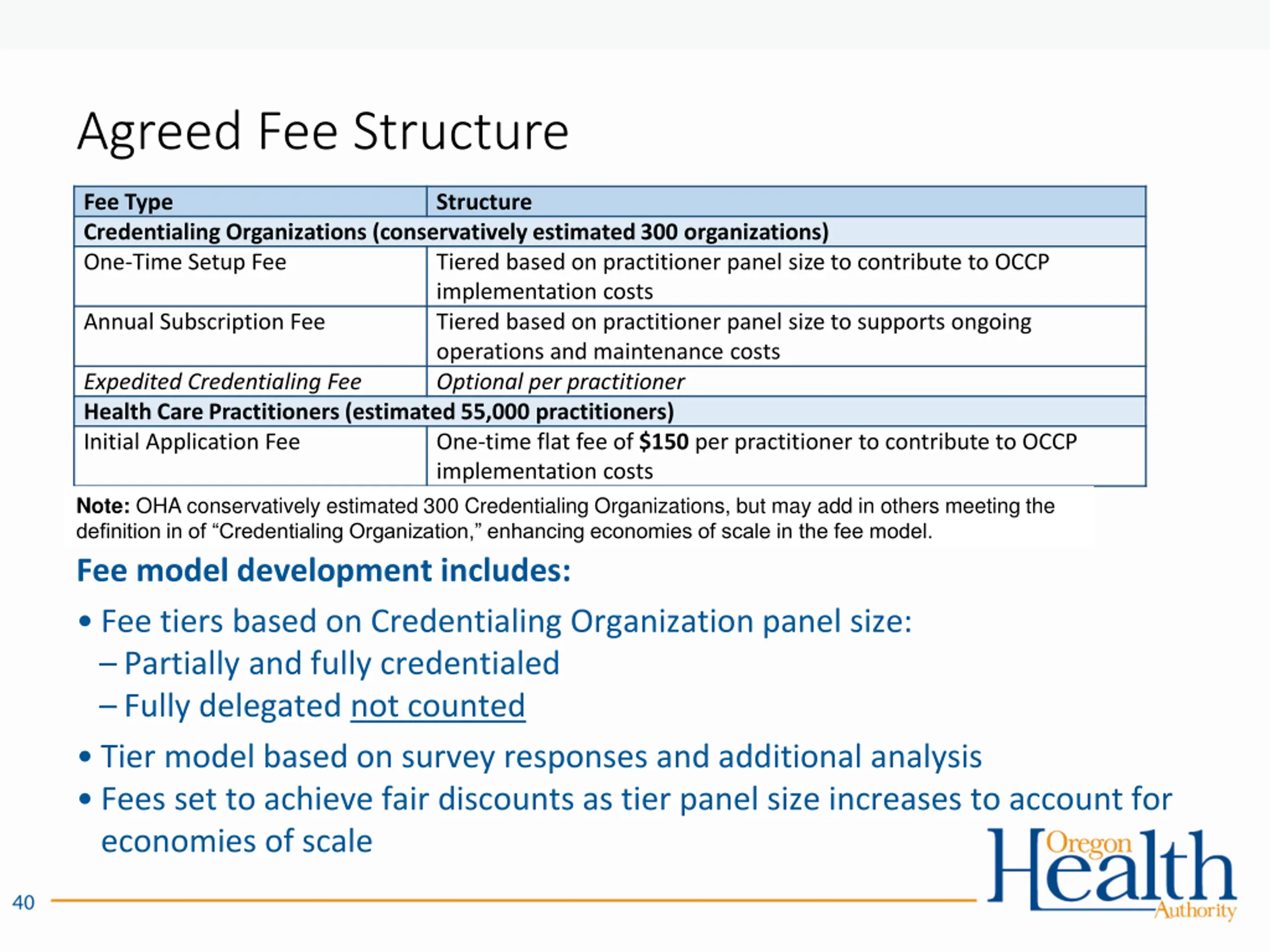

Agreed Fee Structure Fee Type Credentialing Organizations (conservatively estimated 300 organizations) One-Time Setup Fee Tiered based on practitioner panel size to contribute to OCCP implementation costs Annual Subscription Fee Tiered based on practitioner panel size to supports ongoing operations and maintenance costs Expedited Credentialing Fee Optional per practitioner Health Care Practitioners (estimated 55,000 practitioners) Initial Application Fee One-time flat fee of $150 per practitioner to contribute to OCCP implementation costs Note: OHA conservatively estimated 300 Credentialing Organizations, but may add in others meeting the definition in of Credentialing Organization, enhancing economies of scale in the fee model. Structure Fee model development includes: Fee tiers based on Credentialing Organization panel size: Partially and fully credentialed Fully delegated not counted Tier model based on survey responses and additional analysis Fees set to achieve fair discounts as tier panel size increases to account for economies of scale

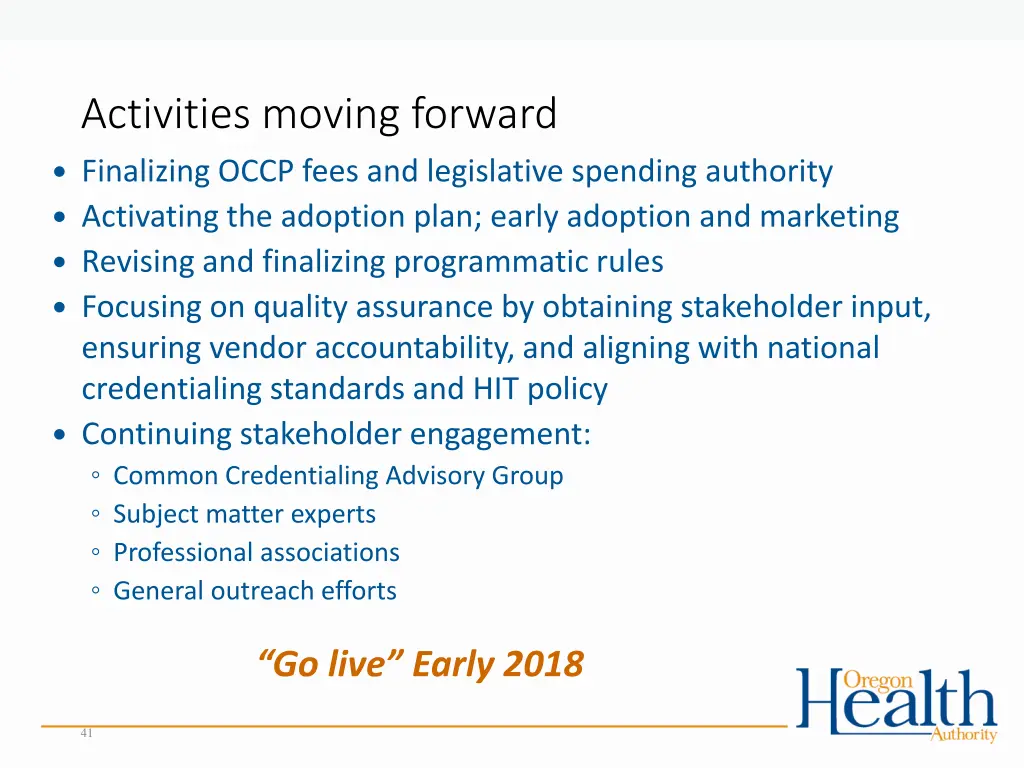

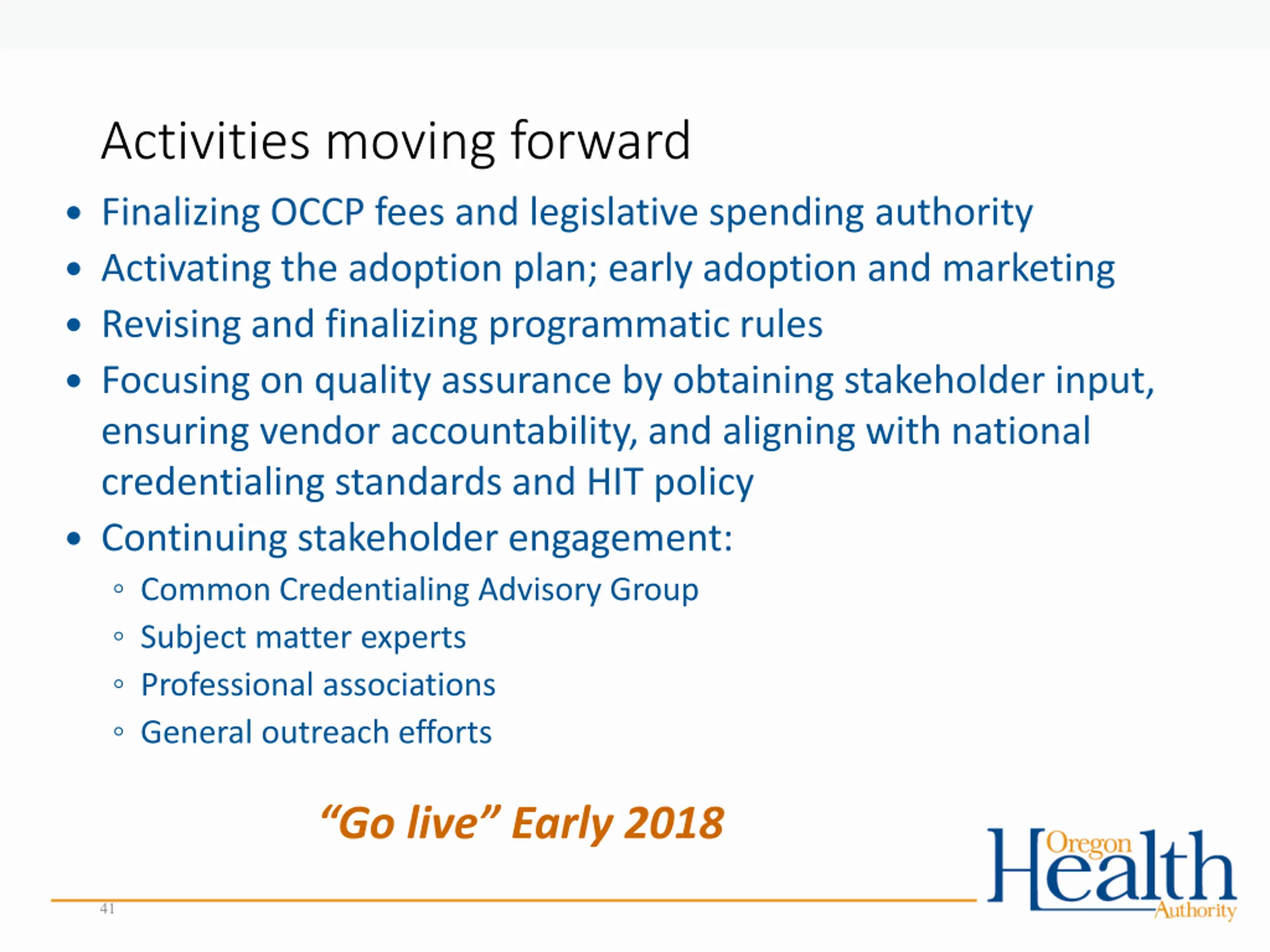

Activities moving forward Finalizing OCCP fees and legislative spending authority Activating the adoption plan; early adoption and marketing Revising and finalizing programmatic rules Focusing on quality assurance by obtaining stakeholder input, ensuring vendor accountability, and aligning with national credentialing standards and HIT policy Continuing stakeholder engagement: Common Credentialing Advisory Group Subject matter experts Professional associations General outreach efforts Go live Early 2018 41

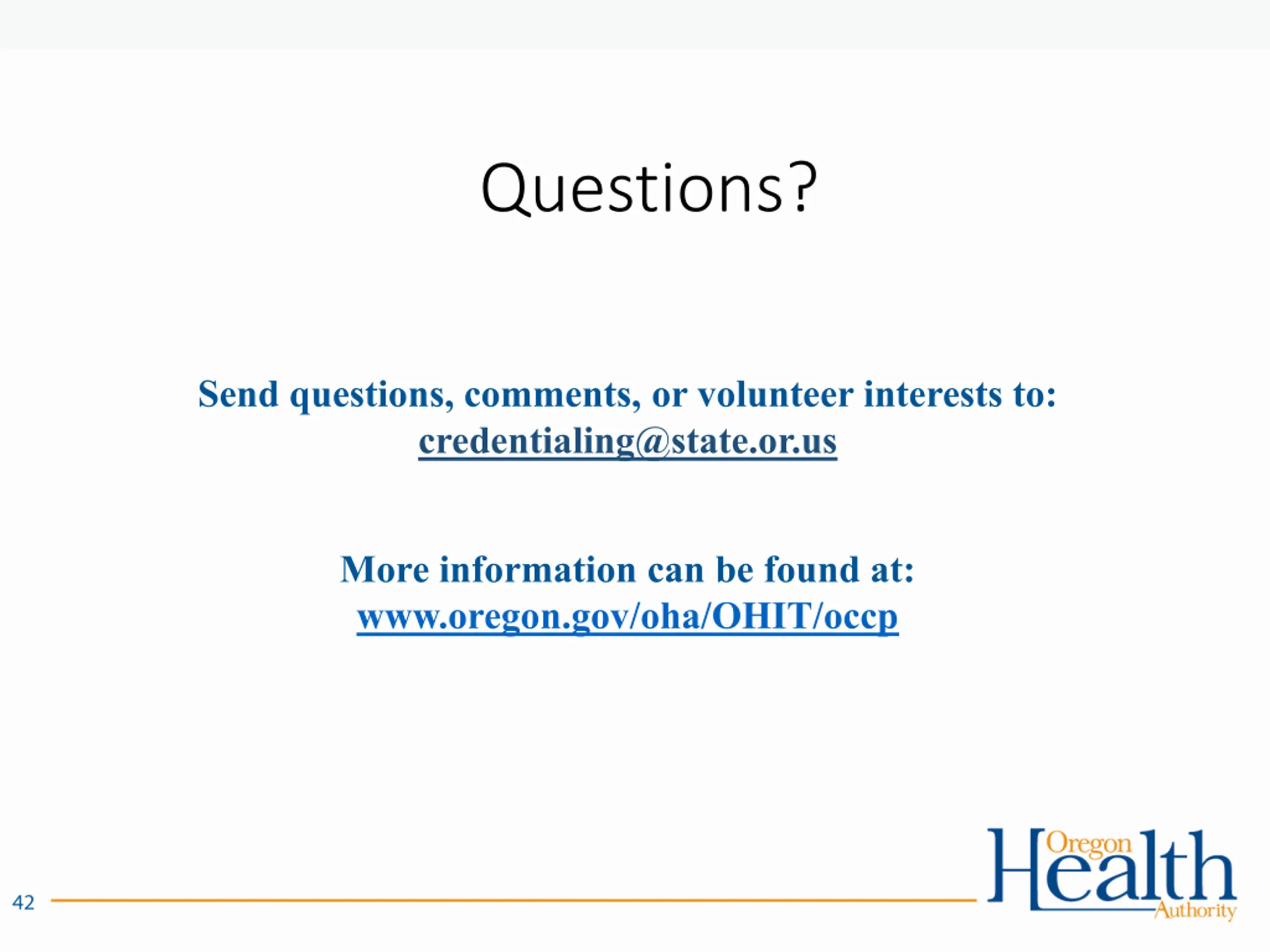

Questions? Send questions, comments, or volunteer interests to: credentialing@state.or.us More information can be found at: www.oregon.gov/oha/OHIT/occp
HIT Commons Sean Carey Lead Policy Analyst 43

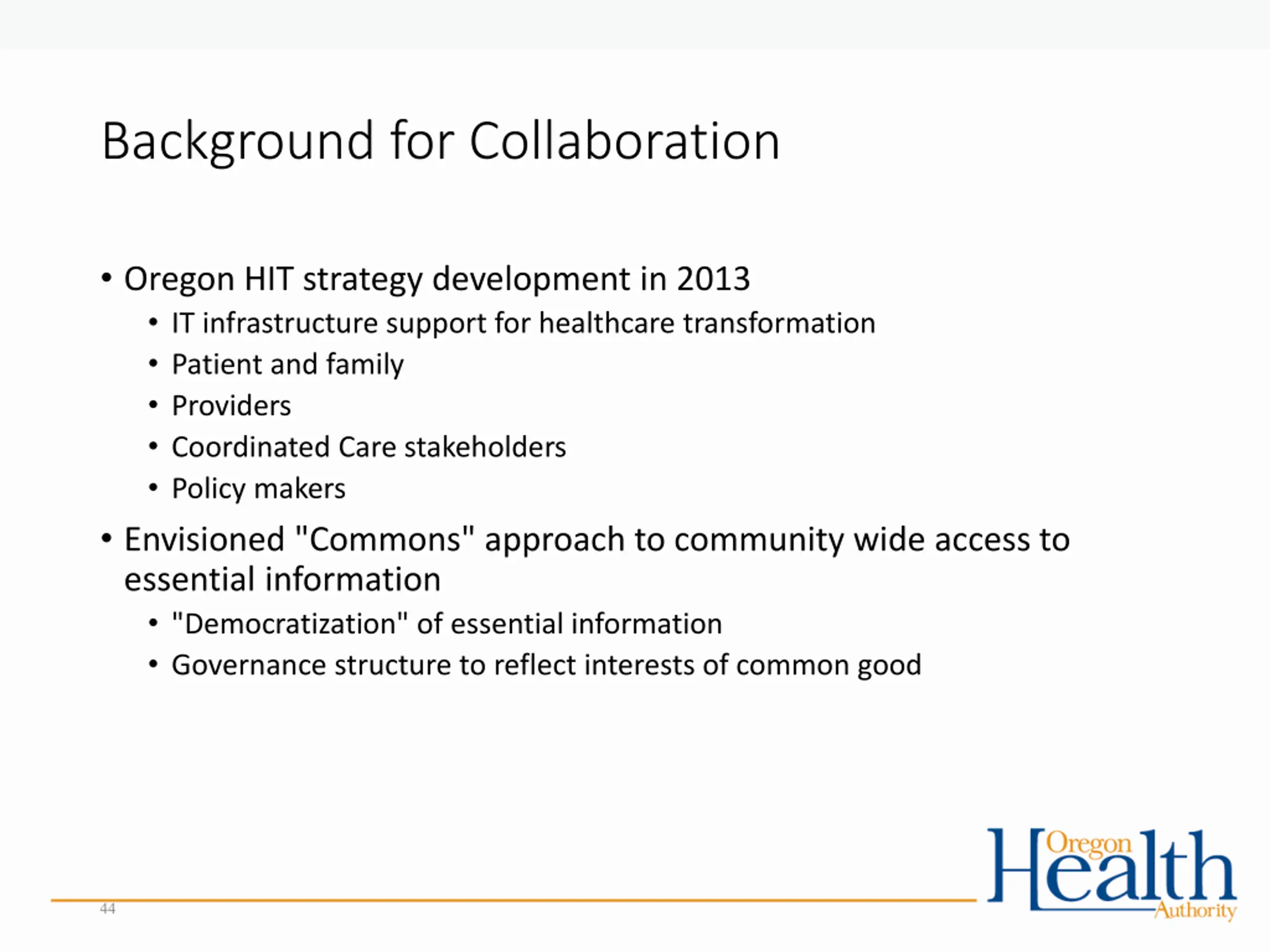

Background for Collaboration Oregon HIT strategy development in 2013 IT infrastructure support for healthcare transformation Patient and family Providers Coordinated Care stakeholders Policy makers Envisioned "Commons" approach to community wide access to essential information "Democratization" of essential information Governance structure to reflect interests of common good 44

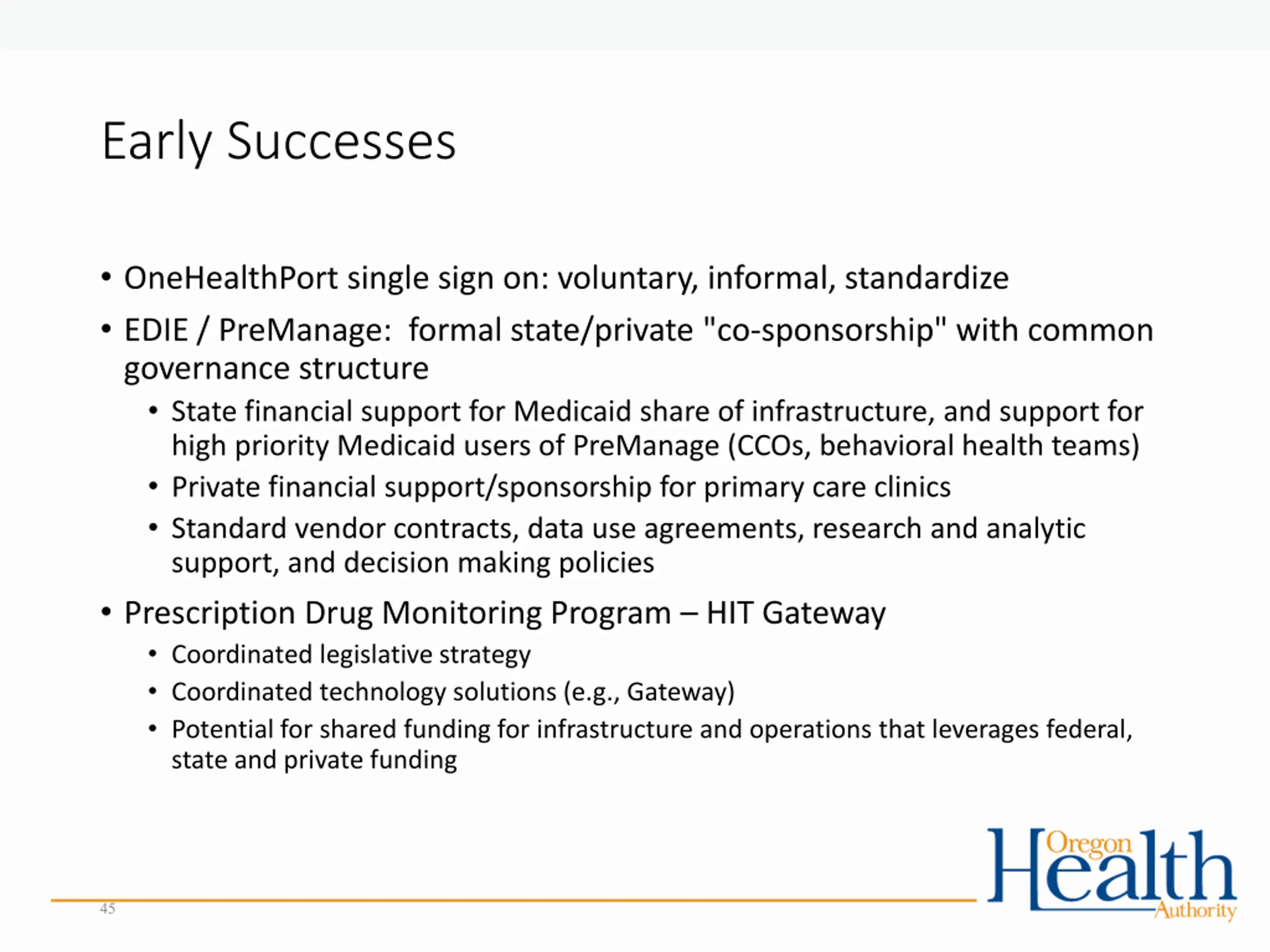

Early Successes OneHealthPort single sign on: voluntary, informal, standardize EDIE / PreManage: formal state/private "co-sponsorship" with common governance structure State financial support for Medicaid share of infrastructure, and support for high priority Medicaid users of PreManage (CCOs, behavioral health teams) Private financial support/sponsorship for primary care clinics Standard vendor contracts, data use agreements, research and analytic support, and decision making policies Prescription Drug Monitoring Program HIT Gateway Coordinated legislative strategy Coordinated technology solutions (e.g., Gateway) Potential for shared funding for infrastructure and operations that leverages federal, state and private funding 45

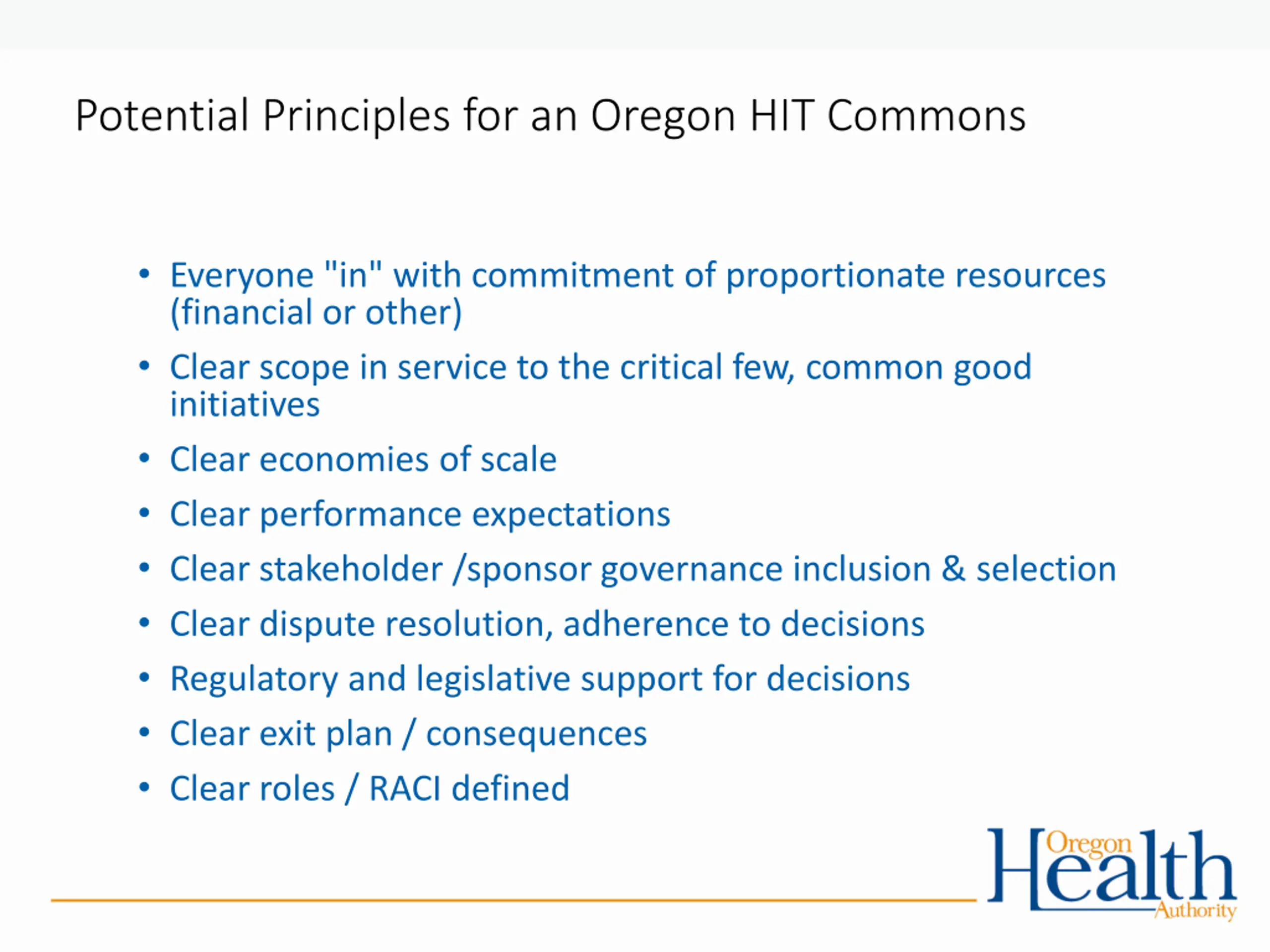

Potential Principles for an Oregon HIT Commons Everyone "in" with commitment of proportionate resources (financial or other) Clear scope in service to the critical few, common good initiatives Clear economies of scale Clear performance expectations Clear stakeholder /sponsor governance inclusion & selection Clear dispute resolution, adherence to decisions Regulatory and legislative support for decisions Clear exit plan / consequences Clear roles / RACI defined

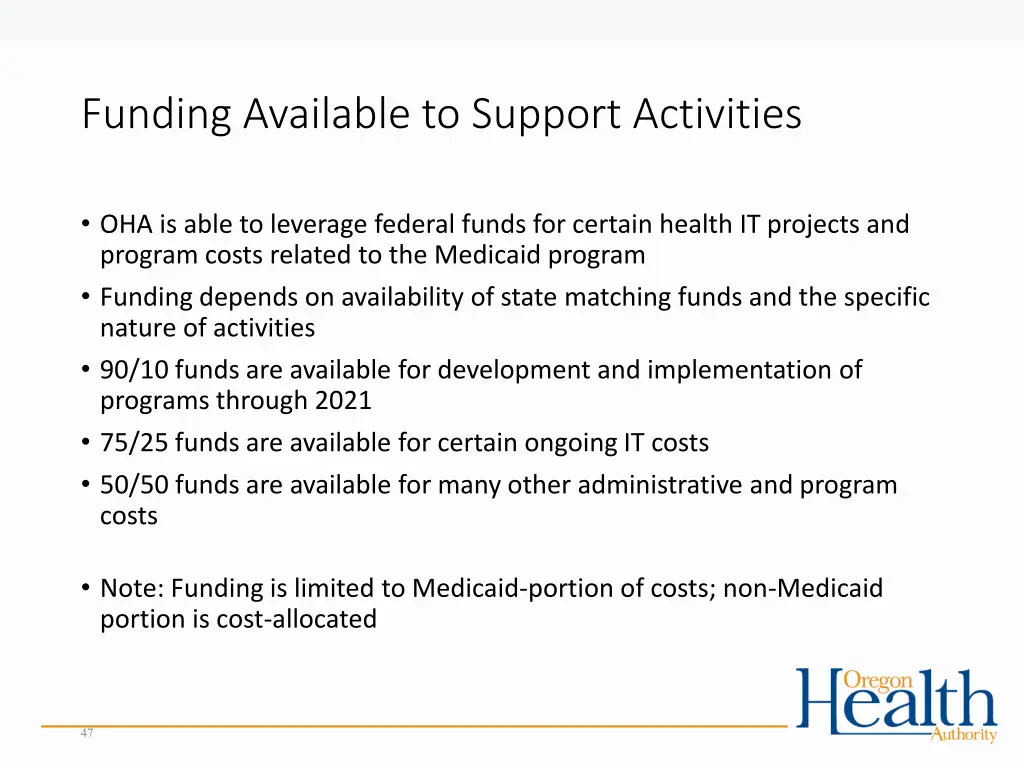

Funding Available to Support Activities OHA is able to leverage federal funds for certain health IT projects and program costs related to the Medicaid program Funding depends on availability of state matching funds and the specific nature of activities 90/10 funds are available for development and implementation of programs through 2021 75/25 funds are available for certain ongoing IT costs 50/50 funds are available for many other administrative and program costs Note: Funding is limited to Medicaid-portion of costs; non-Medicaid portion is cost-allocated 47

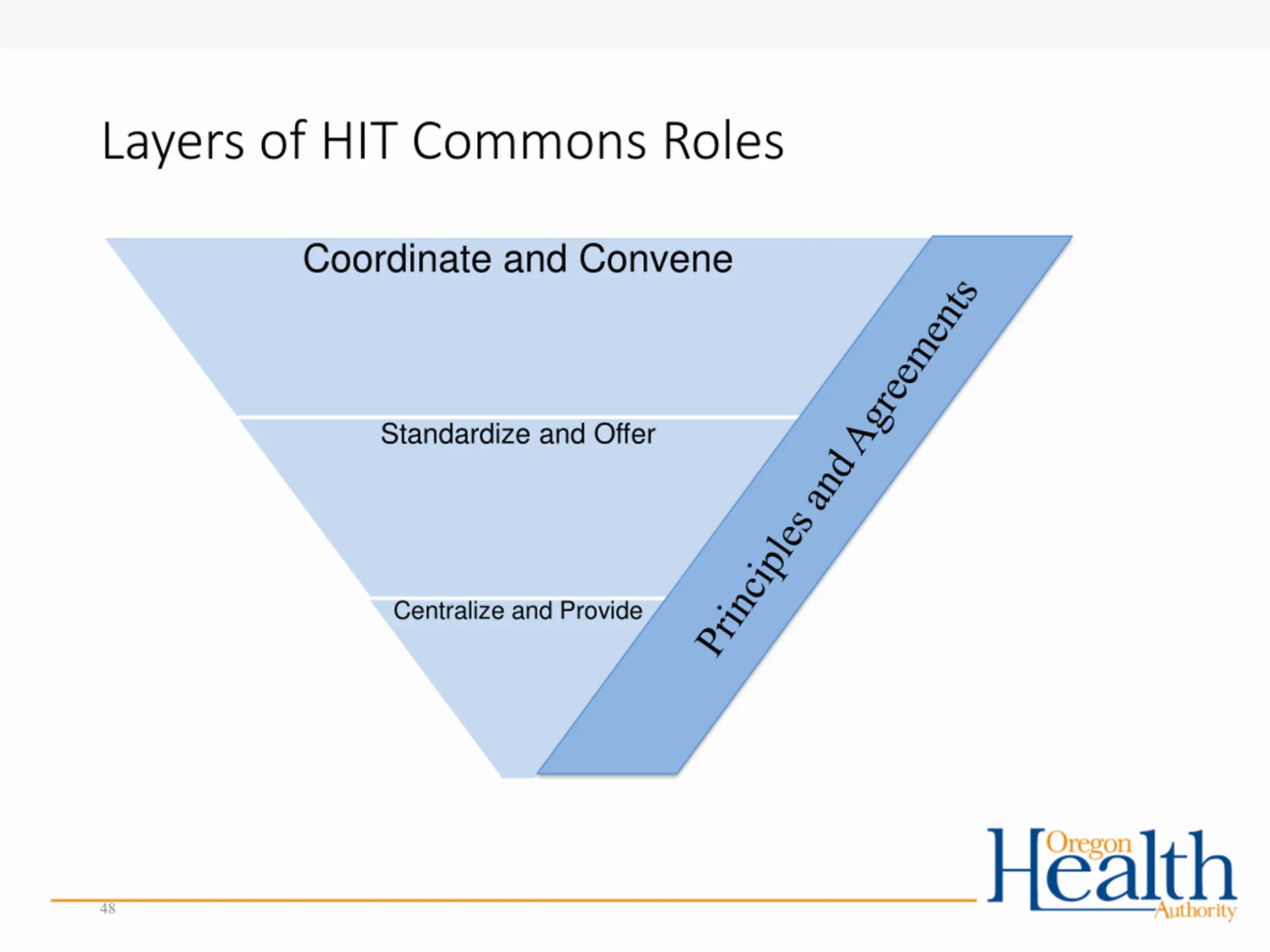

Layers of HIT Commons Roles Coordinate and Convene Standardize and Offer Centralize and Provide 48

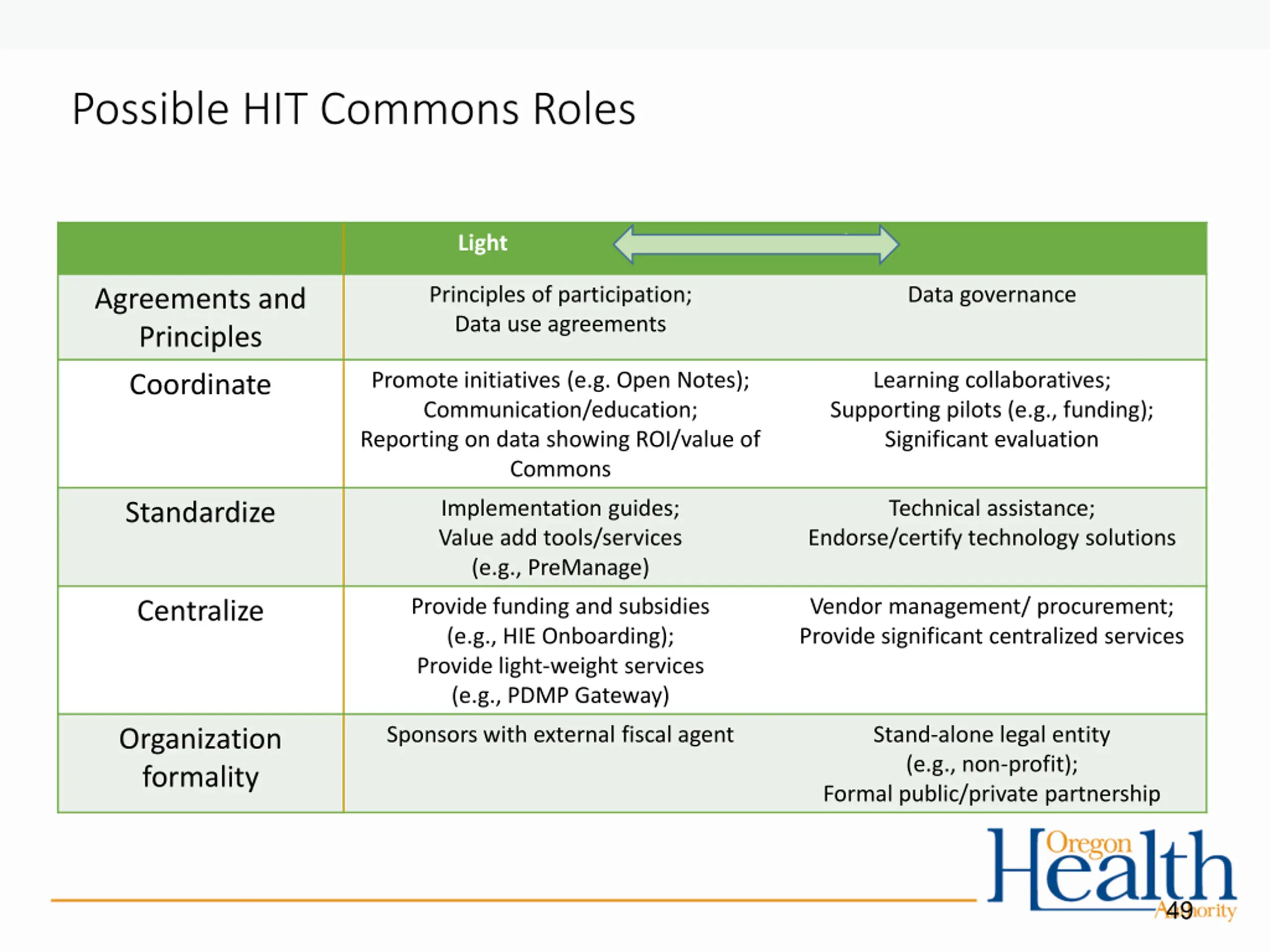

Possible HIT Commons Roles Light Robust Principles of participation; Data use agreements Data governance Agreements and Principles Coordinate Promote initiatives (e.g. Open Notes); Communication/education; Reporting on data showing ROI/value of Commons Learning collaboratives; Supporting pilots (e.g., funding); Significant evaluation Implementation guides; Value add tools/services (e.g., PreManage) Technical assistance; Endorse/certify technology solutions Standardize Provide funding and subsidies (e.g., HIE Onboarding); Provide light-weight services (e.g., PDMP Gateway) Vendor management/ procurement; Provide significant centralized services Centralize Sponsors with external fiscal agent Stand-alone legal entity (e.g., non-profit); Formal public/private partnership Organization formality 49

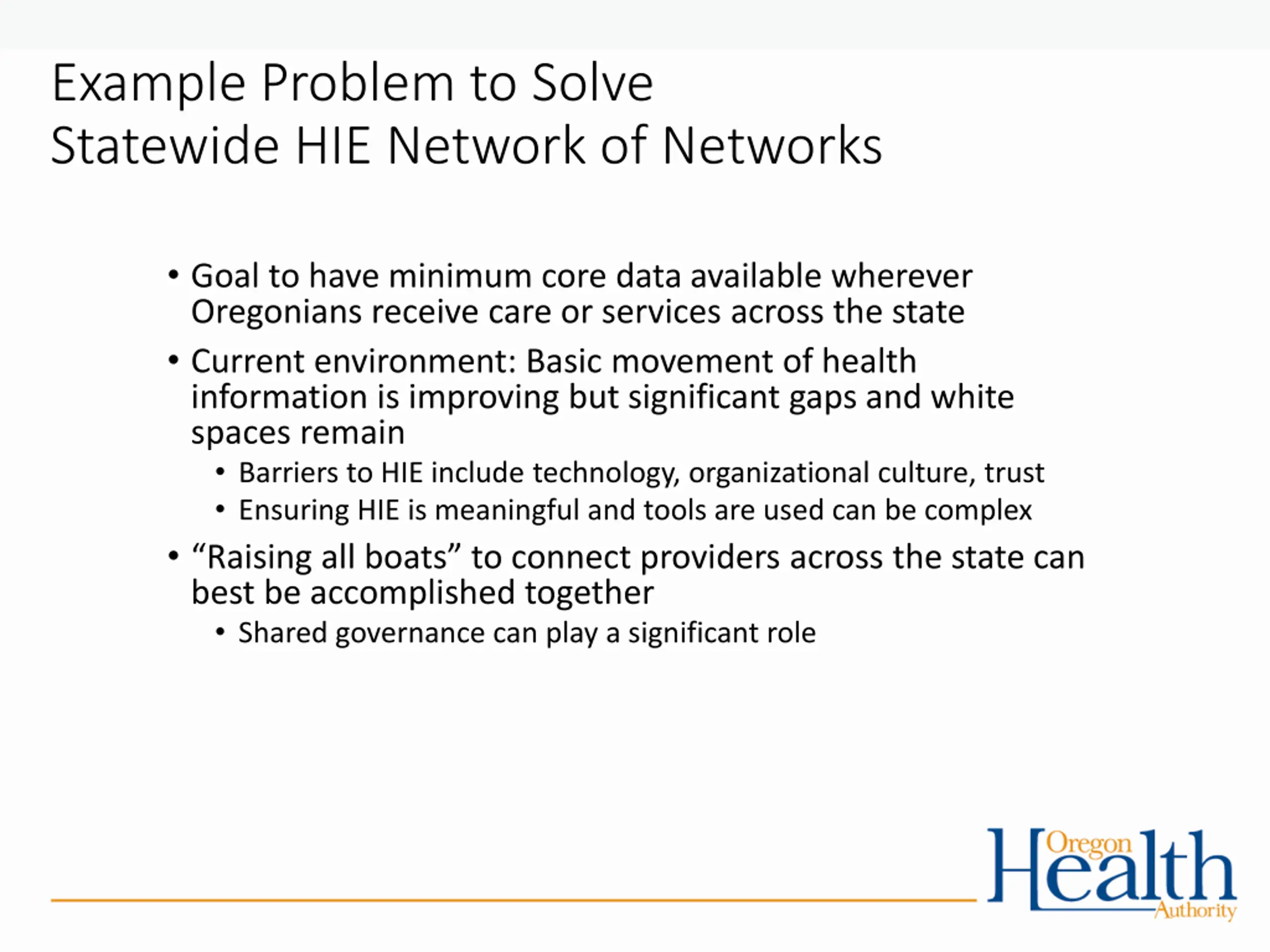

Example Problem to Solve Statewide HIE Network of Networks Goal to have minimum core data available wherever Oregonians receive care or services across the state Current environment: Basic movement of health information is improving but significant gaps and white spaces remain Barriers to HIE include technology, organizational culture, trust Ensuring HIE is meaningful and tools are used can be complex Raising all boats to connect providers across the state can best be accomplished together Shared governance can play a significant role
