PUBLIC CONSULTATION ON SOLAR PV SYSTEM INSTALLATION

PUBLIC CONSULTATION ON SOLAR PV SYSTEM INSTALLATION
Slide Note
Embed
Share

This content delves into technical limitations, grid harmonics issues, and possible solutions in the installation of solar PV systems, highlighting challenges faced by stakeholders and proposing strategies for improvement.

  • Solar PV
  • Installation
  • Challenges
  • Solutions
  • Grid Harmonics

Uploaded on Mar 12, 2025 | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. PUBLIC CONSULTATION ON SOLAR PV SYSTEM INSTALLATION Organized by; Presentation by; Solar Industries Association Roshane Perera 06/12/2017 Public & Utilities Commission Sri Lanka

  2. TECHNICAL LIMITATIONS (CEB /LECO) TECHNICAL LIMITATIONS (CEB /LECO) Measurement of grid harmonics emission from inverters

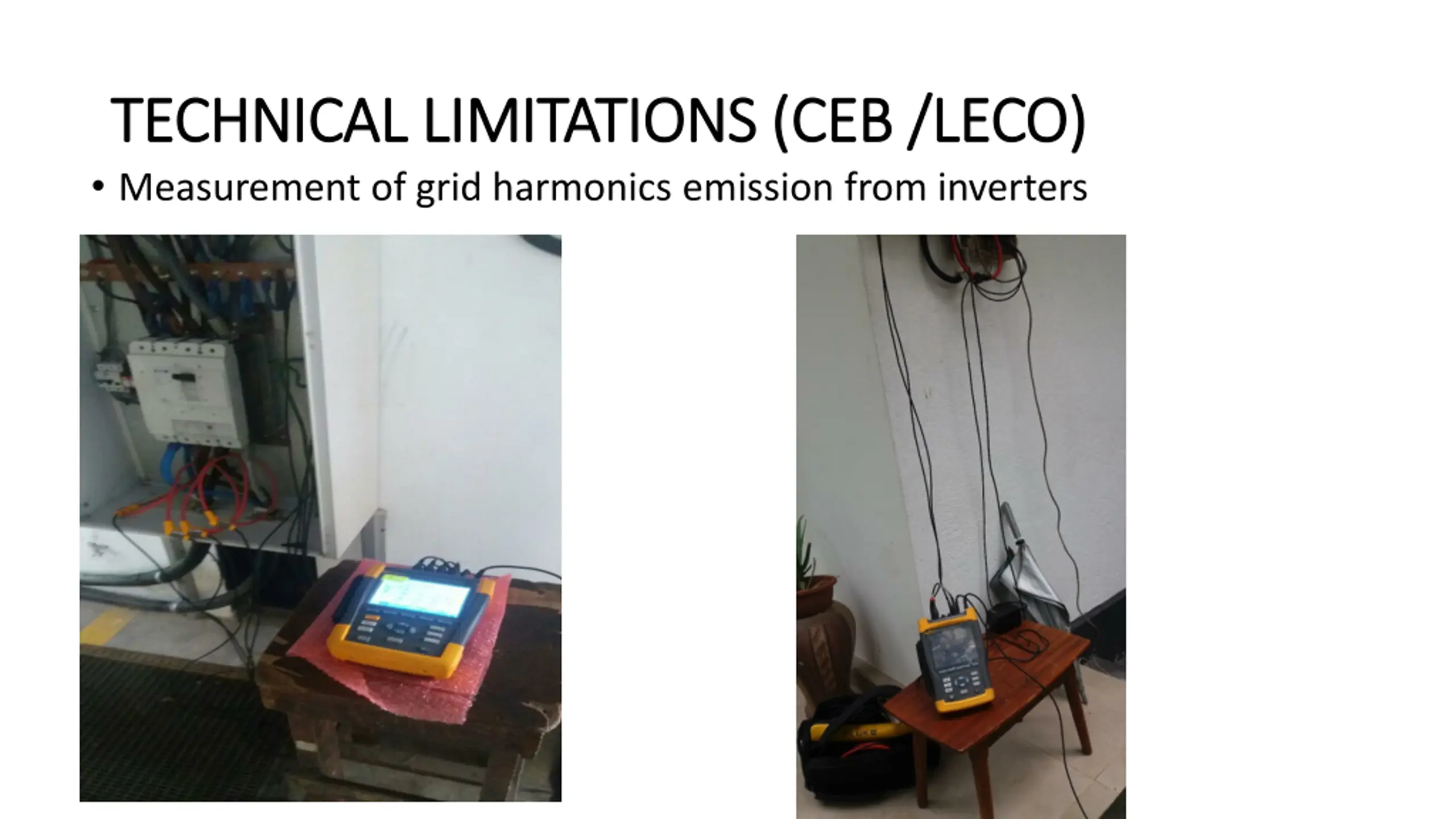

  3. Grid Harmonics Grid Harmonics - - Issues Issues Not possible to filter the grid harmonics Test results dependent on weather Test result dependent on the panel orientations One test unit available per area office Test requires 4-5 hours Waste of time of CEB personnel, Installers and investor Not done as per international standards

  4. Grid Harmonics Grid Harmonics Possible solutions Possible solutions Easiest way is to accept the international test certificates Test one unit and approval certificate to be issued by UOM or any other facility Site level testing is impractical, wrong and further more Delays the installation time by months Discourages the investor / customer Negative feedback given to the investor / customer on installation company Word of mouth references are lost Possible new clients are discouraged

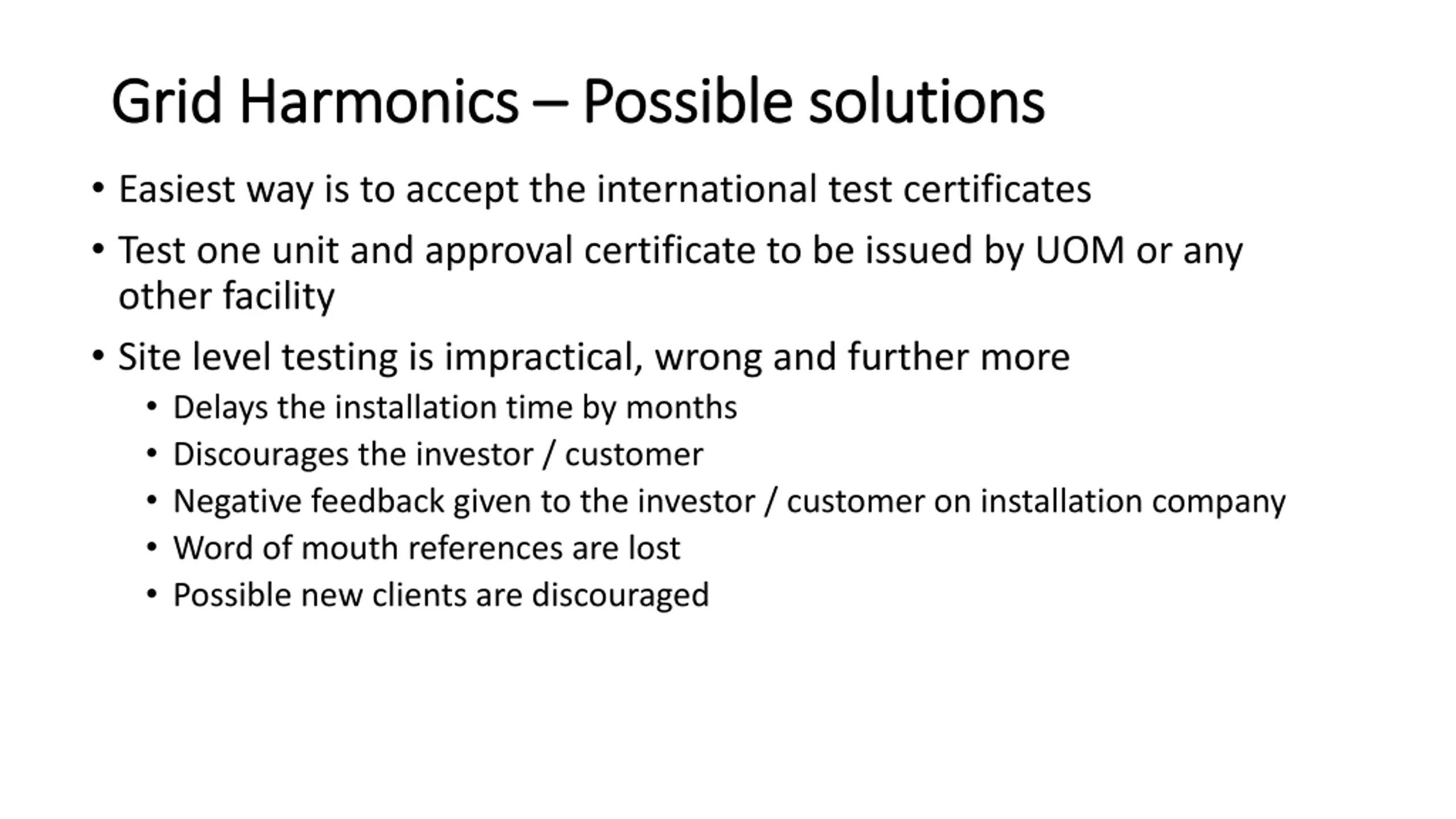

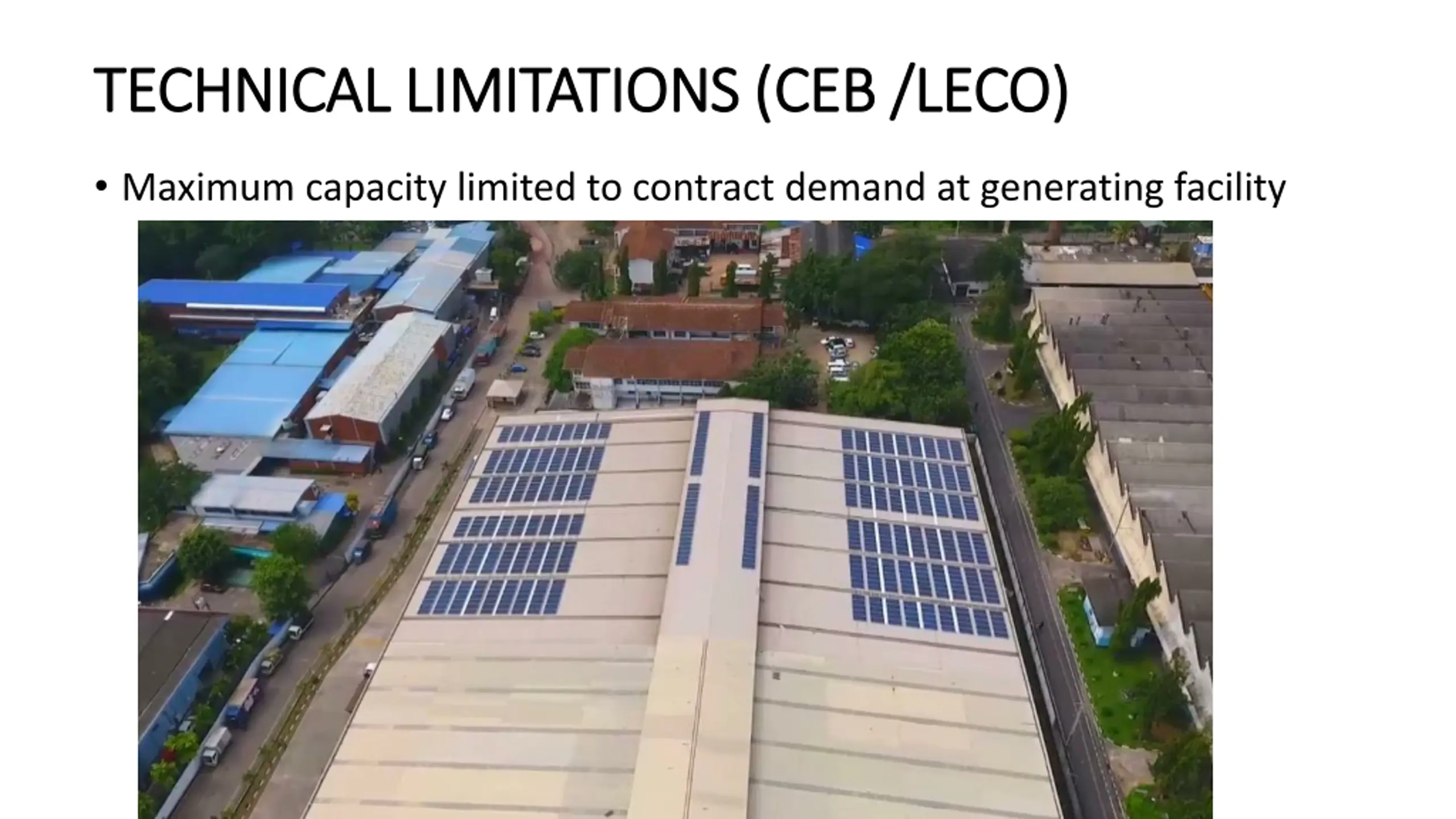

  5. TECHNICAL LIMITATIONS (CEB /LECO) TECHNICAL LIMITATIONS (CEB /LECO) Maximum capacity limited to contract demand at generating facility

  6. Maximum capacity limitation Maximum capacity limitation Possible Solutions Possible Solutions Allow to increase the contract demand or the transformer capacity to develop the maximum possible solar PV system

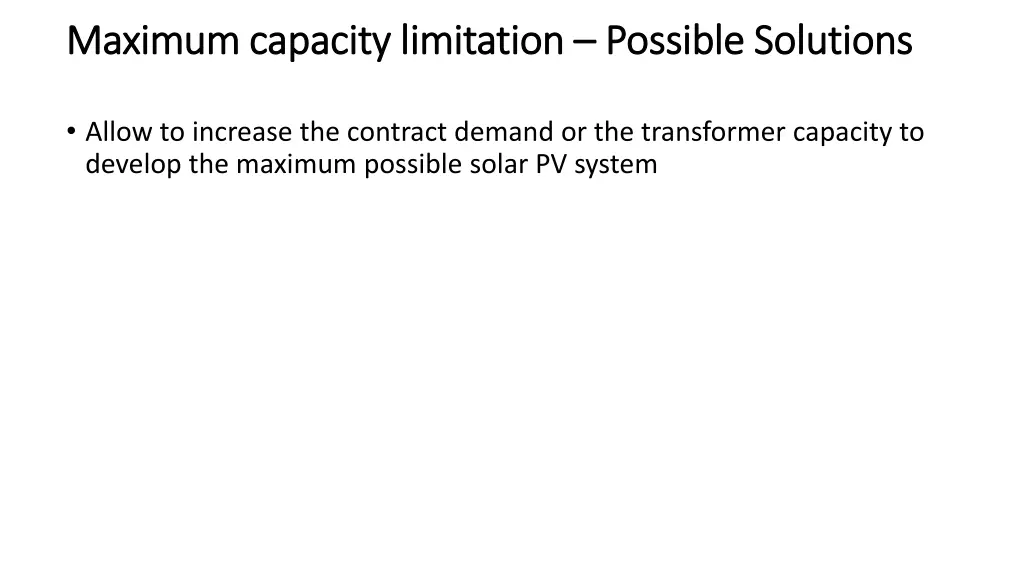

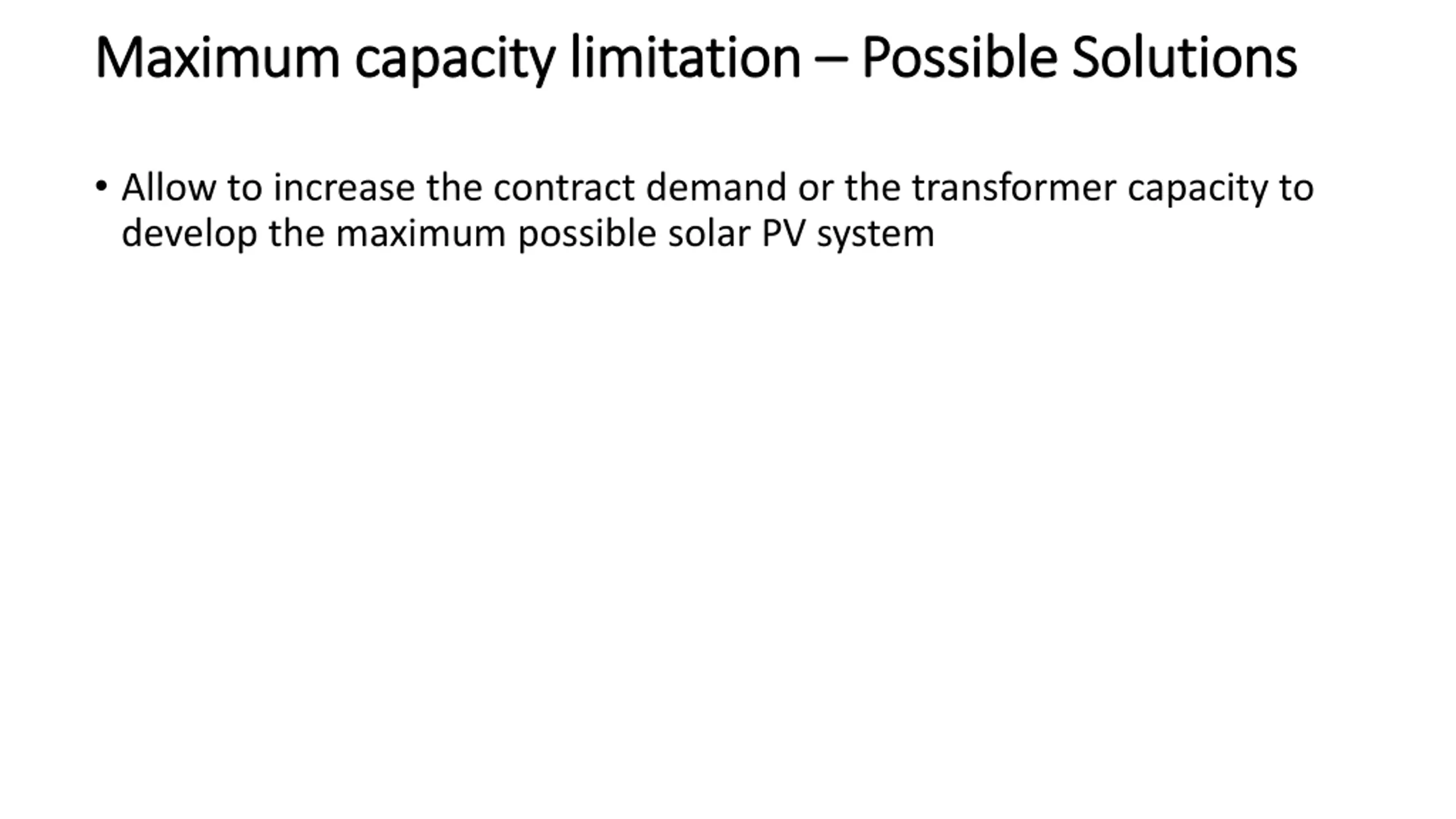

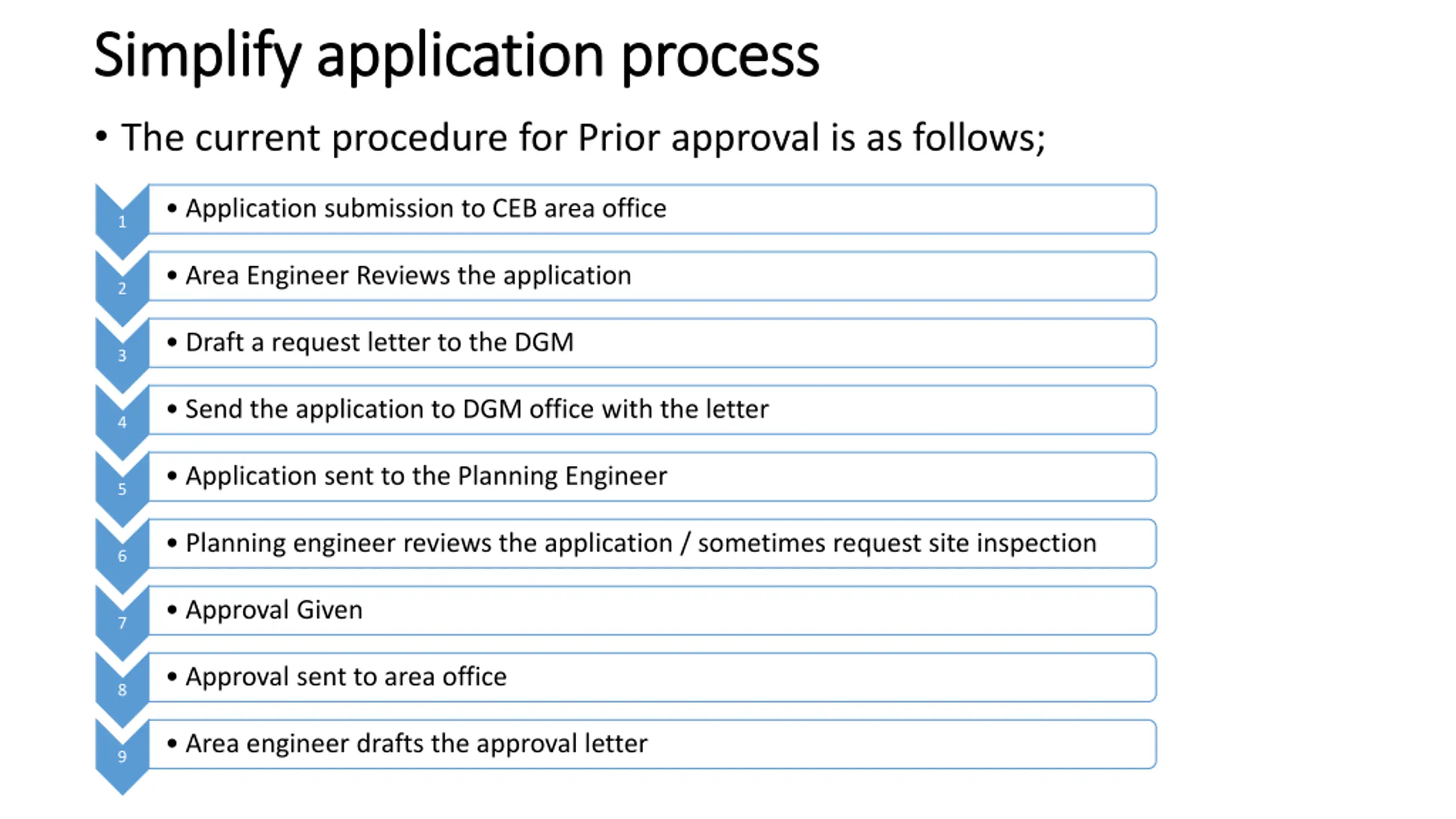

  7. Simplify application process Simplify application process The current procedure for Prior approval is as follows; Application submission to CEB area office 1 Area Engineer Reviews the application 2 Draft a request letter to the DGM 3 Send the application to DGM office with the letter 4 Application sent to the Planning Engineer 5 Planning engineer reviews the application / sometimes request site inspection 6 Approval Given 7 Approval sent to area office 8 Area engineer drafts the approval letter 9

  8. Simplify application process Simplify application process The current connection procedure for over 50kW systems are as follows; Application submission to CEB area office 1 Area Engineer Reviews the application 2 Drafts a request letter to the DGM 3 Send the application to DGM office with the letter 4 Application sent to the Commercial Engineer 5 Commercial engineer reviews the application 6 Usually forward the application to construction branch 7 Construction engineer makes a site inspection 8 Prepare the estimate 9 Estimate is sent to the area office 10 Area office issue the payment voucher and payment is made at area office 11 File is sent back from area office back to construction branch 12 Construction Engineer seeks stocks availability 13 New meter is installed and connection given, However not allowed to commission the system until harmonic test is done 14 File is sent back to the area office confirming the work complete job card 15 Area office requests for agreement signing 16 Allocate a date for harmonic testing and if passed allowed to commission the system 17

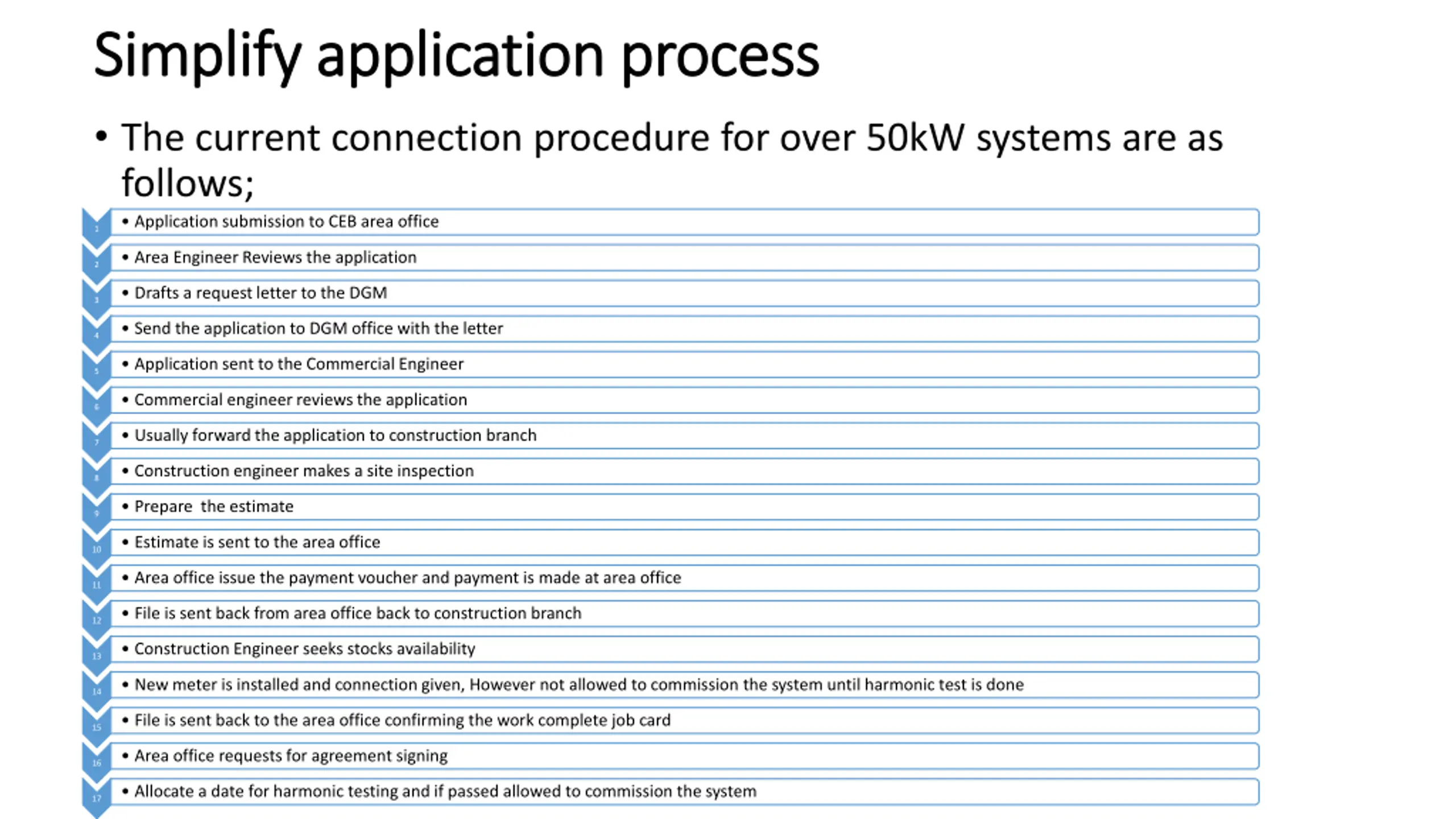

  9. Application Process Application Process Possible Solutions Possible Solutions Over 50kW system approval applications to be directly handled by planning engineer of DGM office Over 50kW connections and payments to be directly handled by construction branch of DGM office Payments for solar earnings are also handled by DGM office (over 300,000.00 payments to be approved by DGM) Therefore all connections above 50kW to be directly handled by the DGM office Modify the online payment tool for payment of estimates

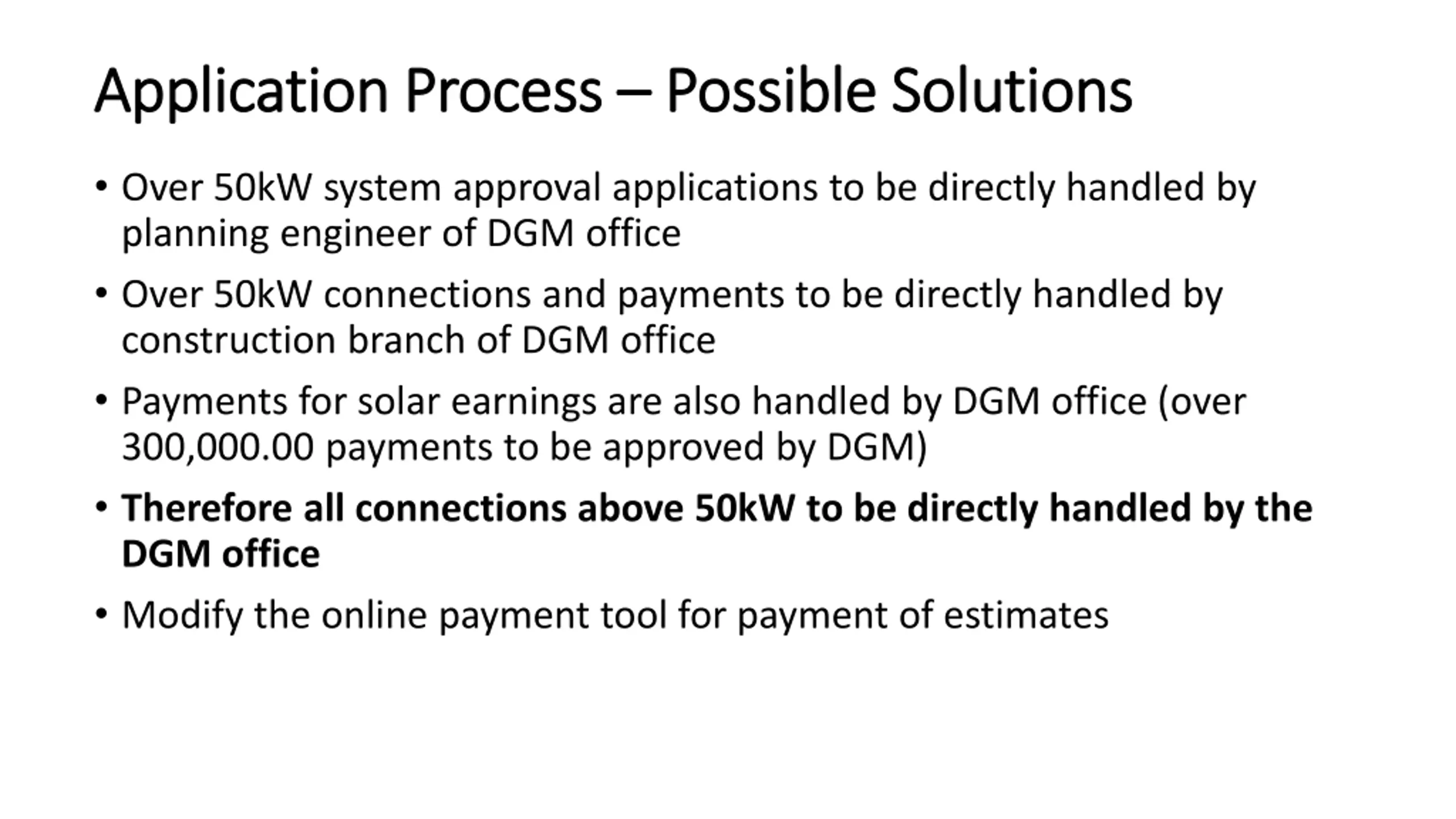

  10. Other Issues Other Issues Unavailability of Meters Different processes at different offices Require wiring certificate from chartered engineer Visiting of sites without informing the client or installation company

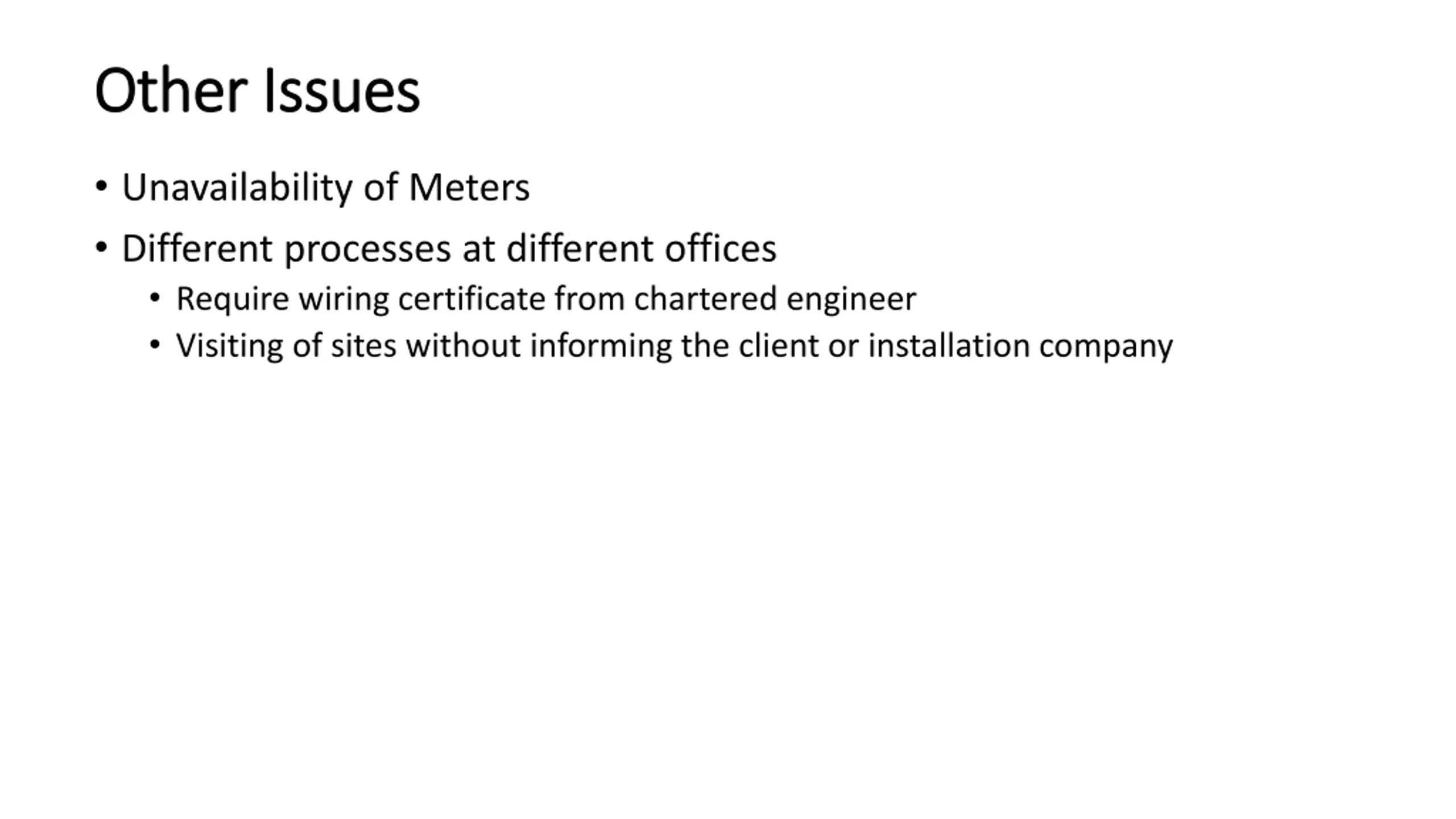

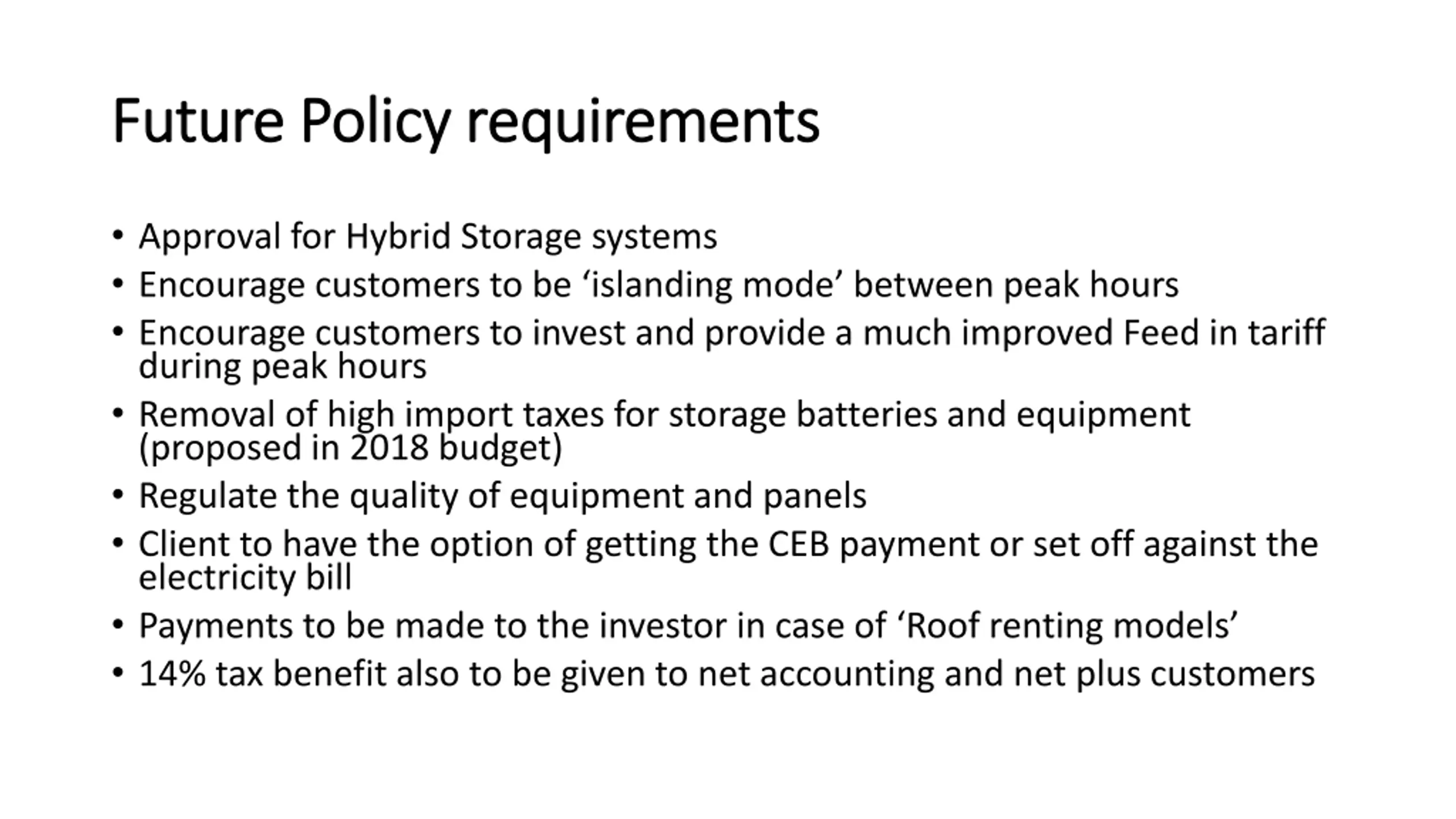

  11. Future Policy requirements Future Policy requirements Approval for Hybrid Storage systems Encourage customers to be islanding mode between peak hours Encourage customers to invest and provide a much improved Feed in tariff during peak hours Removal of high import taxes for storage batteries and equipment (proposed in 2018 budget) Regulate the quality of equipment and panels Client to have the option of getting the CEB payment or set off against the electricity bill Payments to be made to the investor in case of Roof renting models 14% tax benefit also to be given to net accounting and net plus customers

  12. THANK YOU Solar Industries Association
