Ride-Through Capabilities Data Submission Process Overview
Explore the data submittal process for ride-through capabilities, extensions, and exemptions, including details on collecting information for the April 1st deadline using DocuSign and RIOO. Learn about the DocuSign process and workflow, as well as the RIOO process for projects in the interconnection queue without approved Production Load Date. Stay informed about upcoming developments related to Ride-Through Capability templates by ERCOT.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
Data Submittal Process for Ride- Through Capabilities, Extensions, and Exemptions Joel Koepke Sr. Manager Grid Coordination 2/10/25

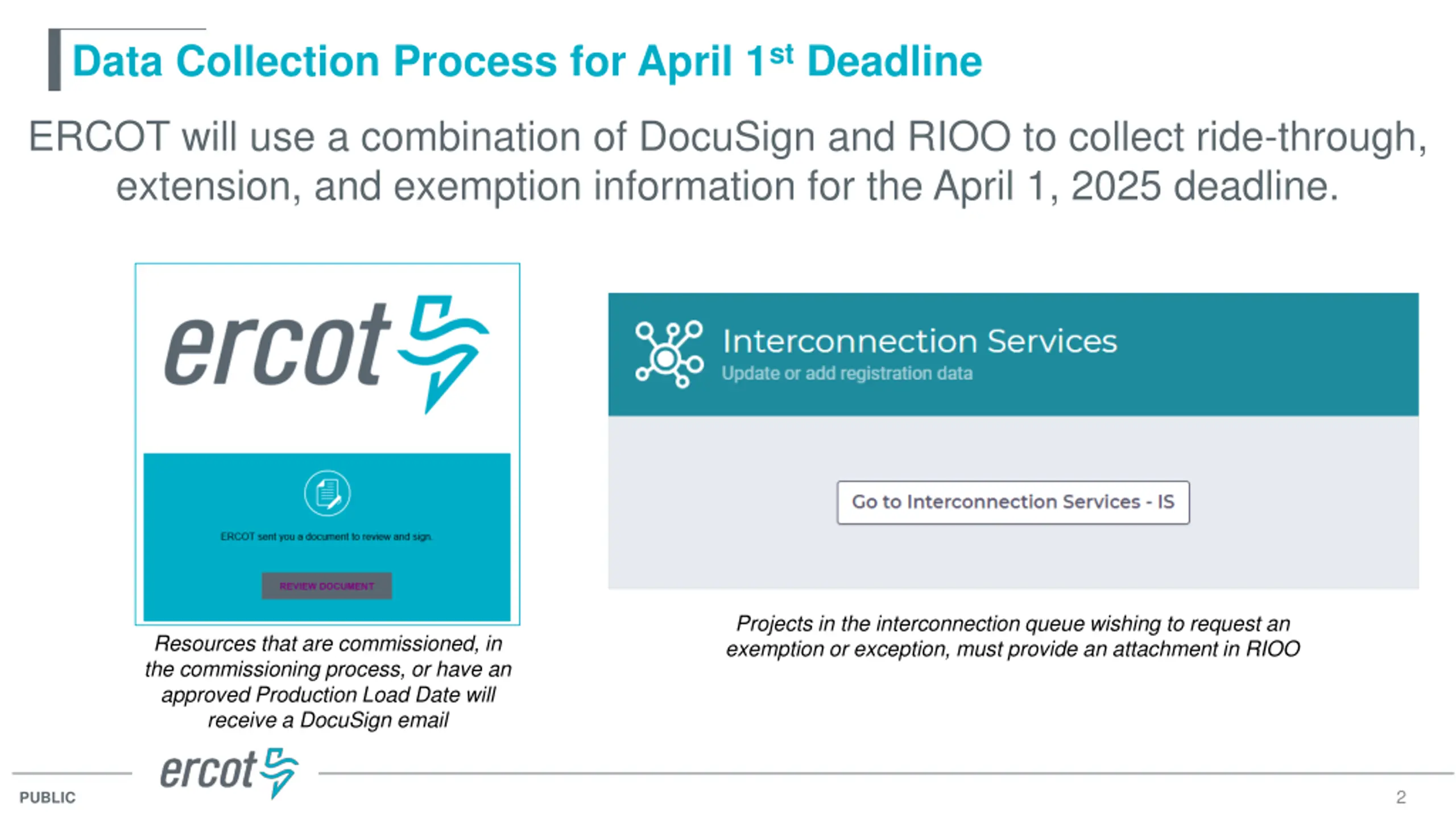

Data Collection Process for April 1st Deadline ERCOT will use a combination of DocuSign and RIOO to collect ride-through, extension, and exemption information for the April 1, 2025 deadline. Projects in the interconnection queue wishing to request an exemption or exception, must provide an attachment in RIOO Resources that are commissioned, in the commissioning process, or have an approved Production Load Date will receive a DocuSign email 2 PUBLIC

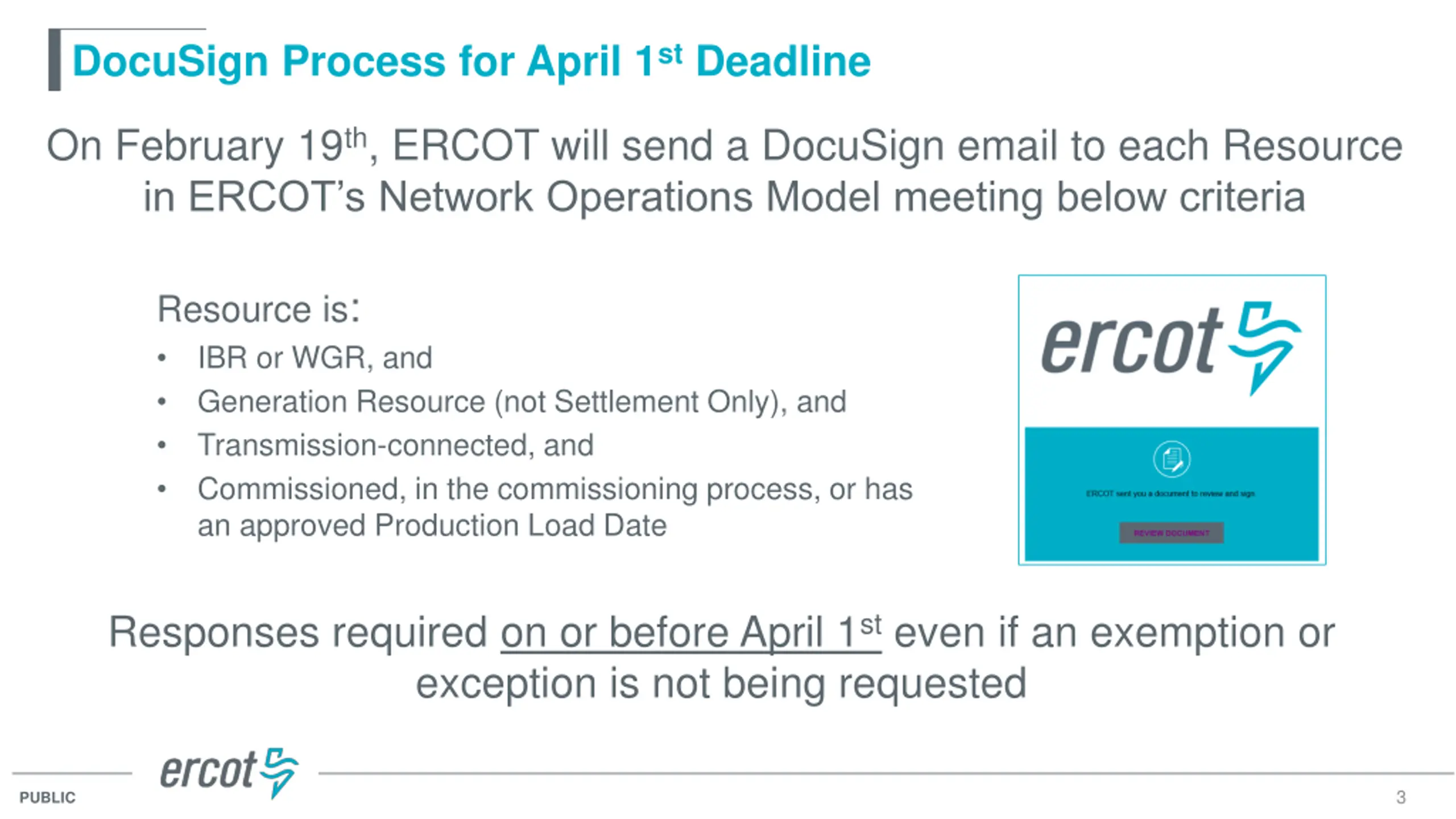

DocuSign Process for April 1st Deadline On February 19th, ERCOT will send a DocuSign email to each Resource in ERCOT s Network Operations Model meeting below criteria Resource is: IBR or WGR, and Generation Resource (not Settlement Only), and Transmission-connected, and Commissioned, in the commissioning process, or has an approved Production Load Date Responses required on or before April 1st even if an exemption or exception is not being requested 3 PUBLIC

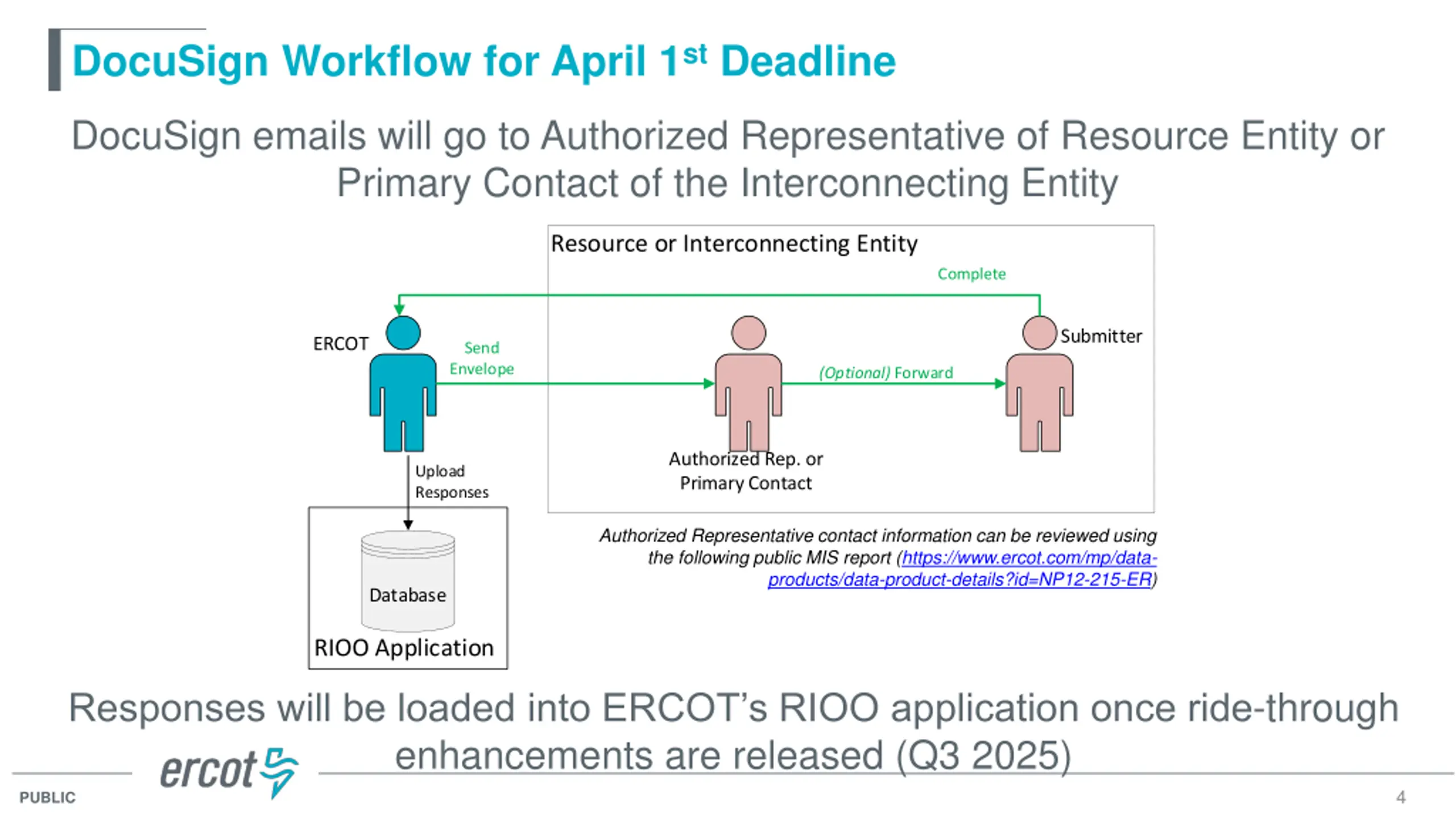

DocuSign Workflow for April 1st Deadline DocuSign emails will go to Authorized Representative of Resource Entity or Primary Contact of the Interconnecting Entity Resource or Interconnecting Entity Complete Submitter ERCOT Send Envelope (Optional) Forward Authorized Rep. or Primary Contact Upload Responses Authorized Representative contact information can be reviewed using the following public MIS report (https://www.ercot.com/mp/data- products/data-product-details?id=NP12-215-ER) Database RIOO Application Responses will be loaded into ERCOT s RIOO application once ride-through enhancements are released (Q3 2025) 4 PUBLIC

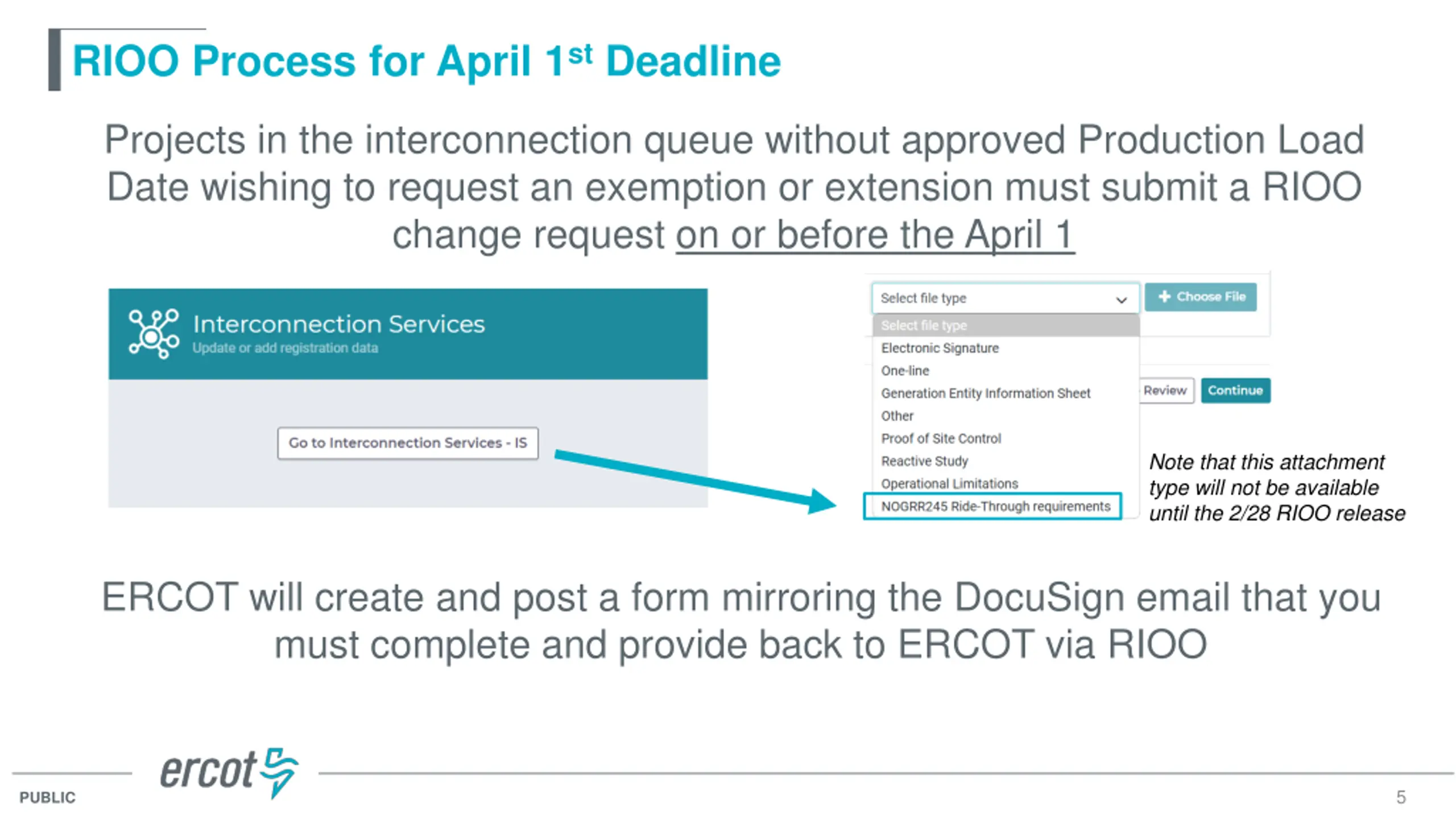

RIOO Process for April 1st Deadline Projects in the interconnection queue without approved Production Load Date wishing to request an exemption or extension must submit a RIOO change request on or before the April 1 Note that this attachment type will not be available until the 2/28 RIOO release ERCOT will create and post a form mirroring the DocuSign email that you must complete and provide back to ERCOT via RIOO 5 PUBLIC

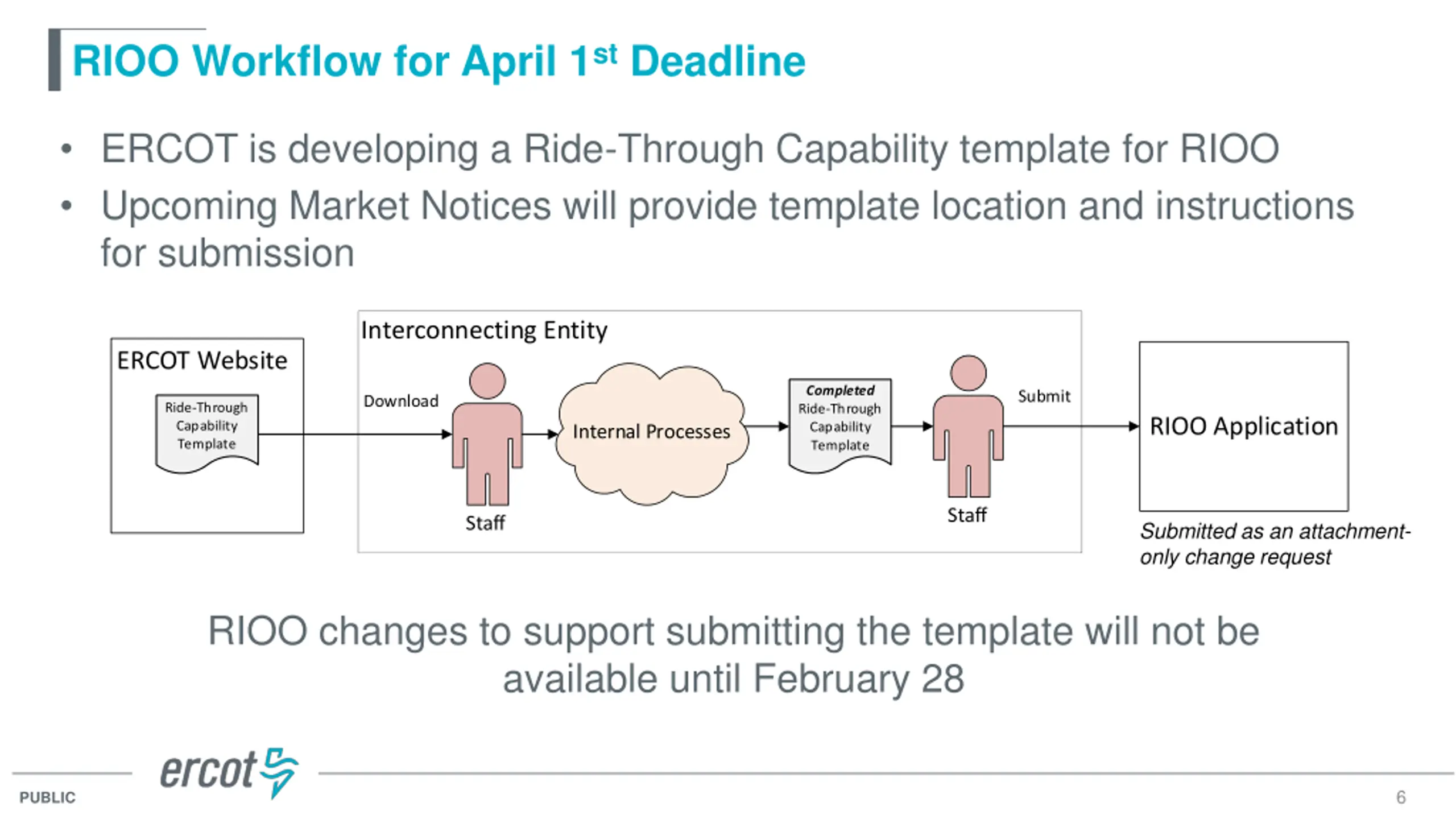

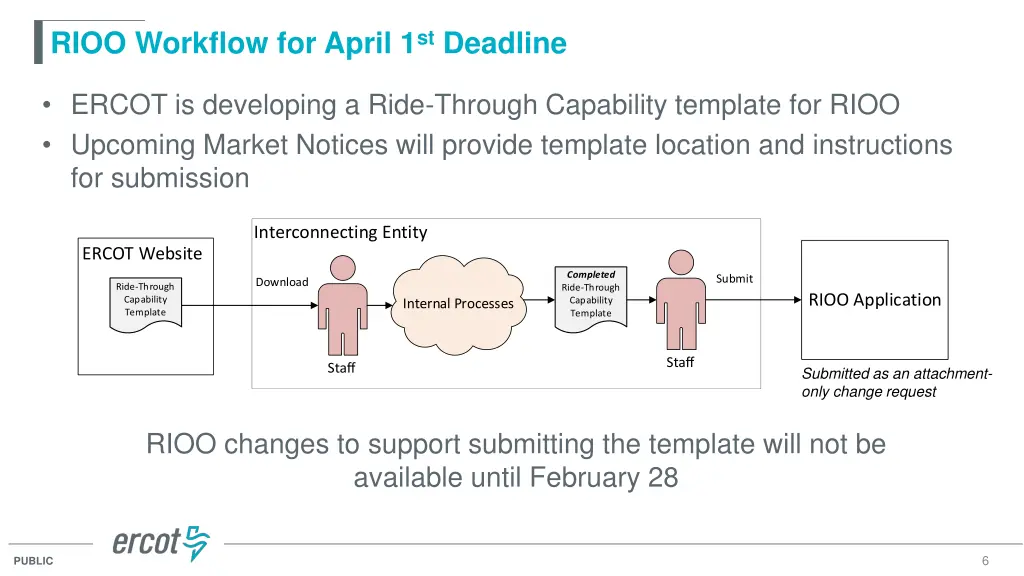

RIOO Workflow for April 1st Deadline ERCOT is developing a Ride-Through Capability template for RIOO Upcoming Market Notices will provide template location and instructions for submission Interconnecting Entity ERCOT Website Completed Ride-Through Capability Template Submit Download Ride-Through Capability Template RIOO Application Internal Processes Staff Staff Submitted as an attachment- only change request RIOO changes to support submitting the template will not be available until February 28 6 PUBLIC

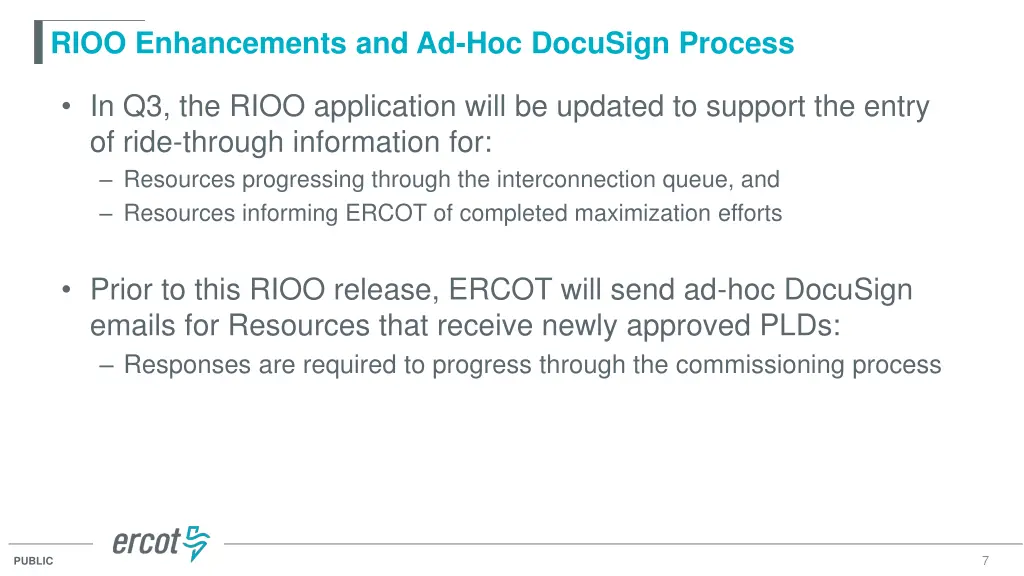

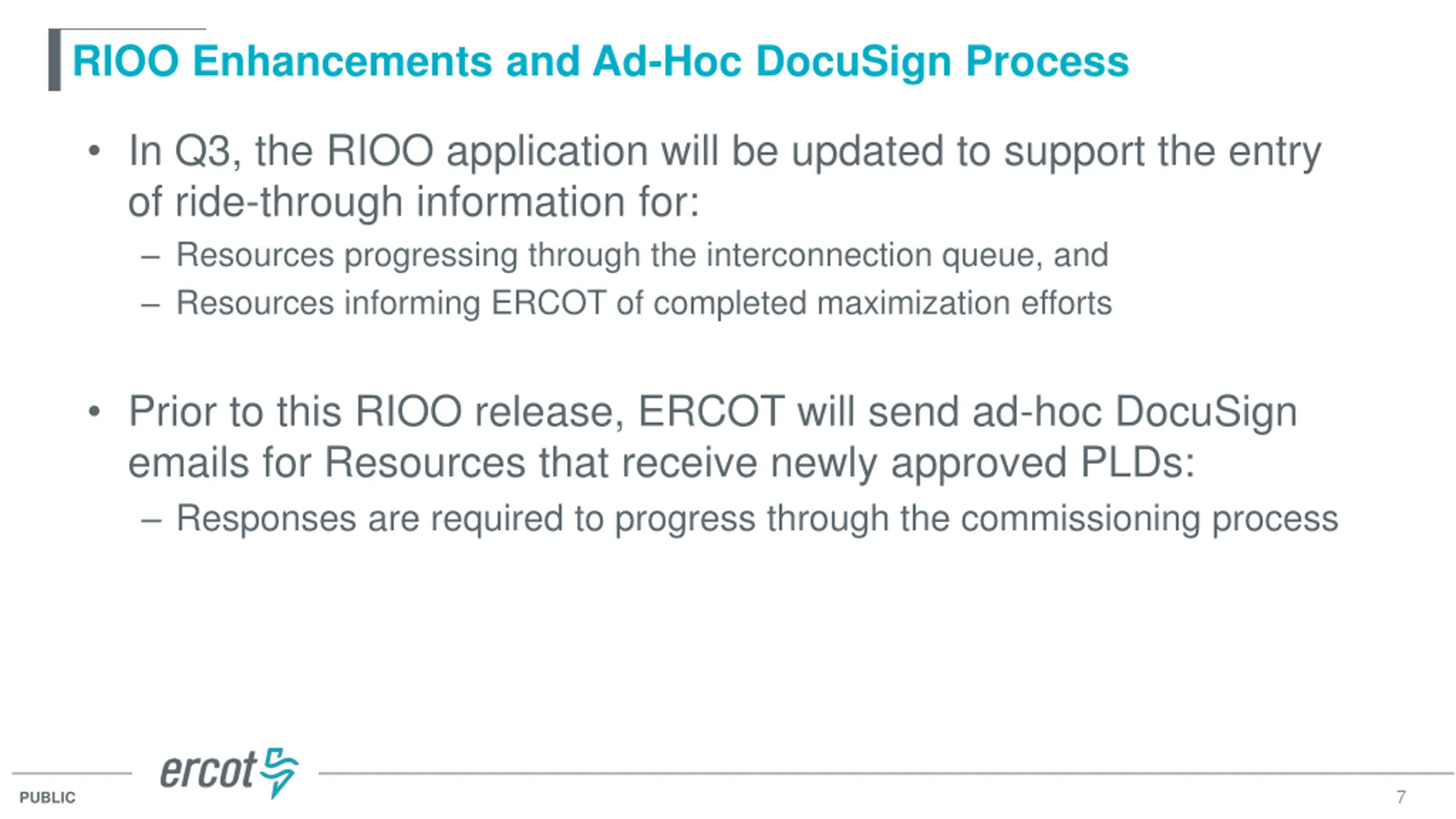

RIOO Enhancements and Ad-Hoc DocuSign Process In Q3, the RIOO application will be updated to support the entry of ride-through information for: Resources progressing through the interconnection queue, and Resources informing ERCOT of completed maximization efforts Prior to this RIOO release, ERCOT will send ad-hoc DocuSign emails for Resources that receive newly approved PLDs: Responses are required to progress through the commissioning process 7 PUBLIC

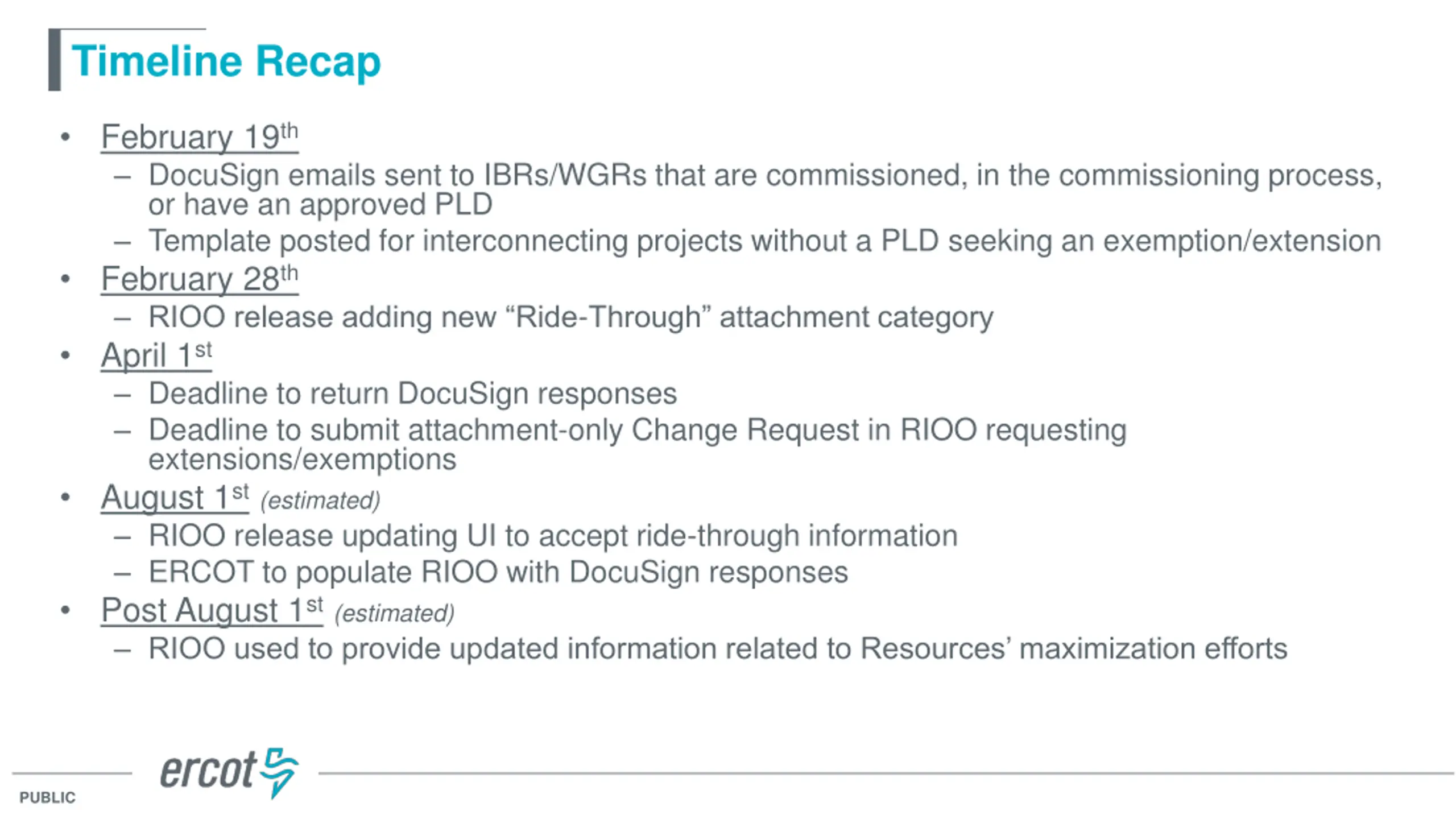

Timeline Recap February 19th DocuSign emails sent to IBRs/WGRs that are commissioned, in the commissioning process, or have an approved PLD Template posted for interconnecting projects without a PLD seeking an exemption/extension February 28th RIOO release adding new Ride-Through attachment category April 1st Deadline to return DocuSign responses Deadline to submit attachment-only Change Request in RIOO requesting extensions/exemptions August 1st(estimated) RIOO release updating UI to accept ride-through information ERCOT to populate RIOO with DocuSign responses Post August 1st(estimated) RIOO used to provide updated information related to Resources maximization efforts PUBLIC

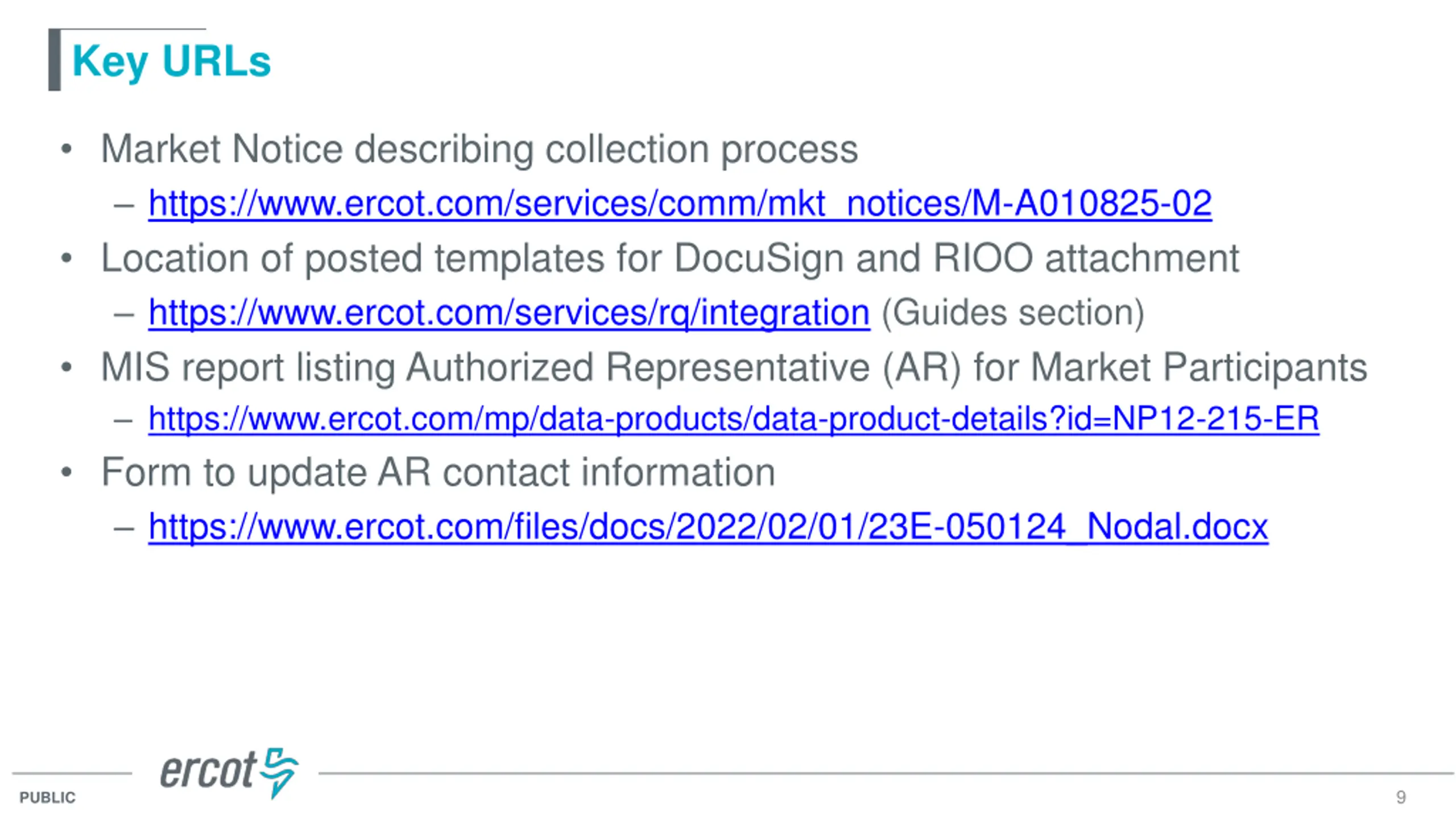

Key URLs Market Notice describing collection process https://www.ercot.com/services/comm/mkt_notices/M-A010825-02 Location of posted templates for DocuSign and RIOO attachment https://www.ercot.com/services/rq/integration (Guides section) MIS report listing Authorized Representative (AR) for Market Participants https://www.ercot.com/mp/data-products/data-product-details?id=NP12-215-ER Form to update AR contact information https://www.ercot.com/files/docs/2022/02/01/23E-050124_Nodal.docx 9 PUBLIC
Questions? 10 PUBLIC
