SABRE North Meeting Funding and Management Overview
Explore the detailed breakdown of funding allocation and crucial milestones for SABRE North in 2025, along with assigned responsibilities and considerations for funding utilization. Get insights into the planned crystal growth, underground site refurbishments, and key tasks assigned to team members.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
SABRE North meeting Funding and management Aldo Ianni Lecce, Nov 27th, 2024

Budget 2025 SABRE North approved for 3 years (2025-2027) Funding allocated for end of 2024 and 2025 mainly for: Astro Grande powder procurement and ZR Funding for crystal production in 2026 (or maybe an advancemet request in 2025) 2
Funding breakdown (no travelling costs) Underground site CR maintenance PE Powder ZR Consumables Consulting Transportation and porterage 15k + 10k SJ Gas system, ventilation, fluid handling 7k 25k 342k 145k (2024) 5k 10k 5k + 15k LNGS copper Consumables Transportation 35k 5.5k 1.5 RM1 Consumables for PMT tests Inventory Transportation 3k 3k SJ for calibration source PMT tests 1.5k LE MI 3
Considerations on funding LNGS supports ventilation and electrical system update more from Chiara LNGS supports refurbishment of floor levelling and resin coating more from Chiara We can use funding for copper and underground site (order of 75k) for other items on the detector s area 4

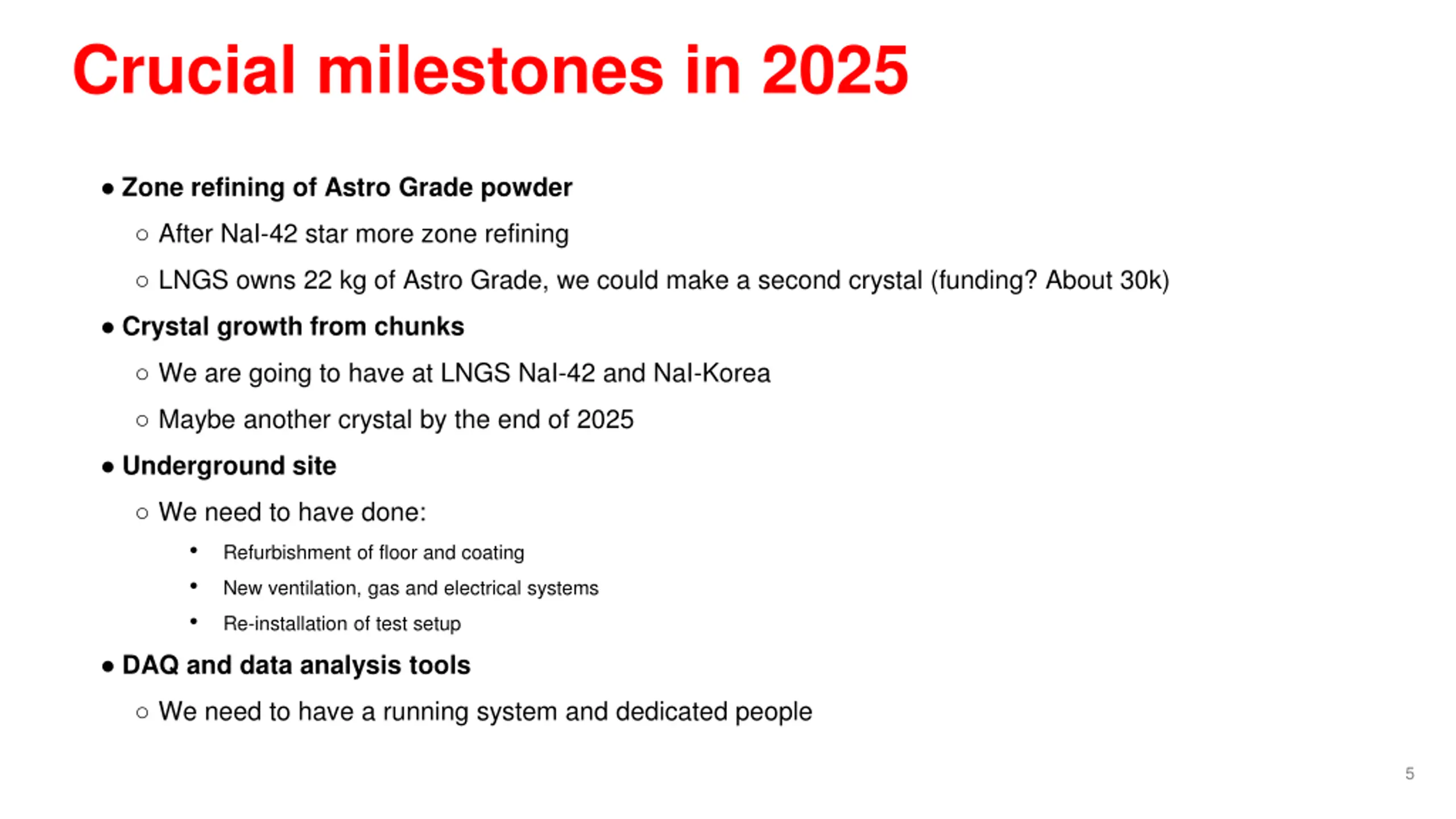

Crucial milestones in 2025 Zone refining of Astro Grade powder After NaI-42 star more zone refining LNGS owns 22 kg of Astro Grade, we could make a second crystal (funding? About 30k) Crystal growth from chunks We are going to have at LNGS NaI-42 and NaI-Korea Maybe another crystal by the end of 2025 Underground site We need to have done: Refurbishment of floor and coating New ventilation, gas and electrical systems Re-installation of test setup DAQ and data analysis tools We need to have a running system and dedicated people 5
Assignment of responsibilities 1. Detector s design and Underground site Chiara, Giuseppe, Alessandro, Valerio P., Valreio T, Edoardo 2. Calibrations Giuseppe, Alessandro, Ambra, Chiara 3. Slow control Chiara, Giuseppe, Lidio, Krzysztof, Attilio 4. Crystal growth Aldo, Claudia, Sanagul, Gabriella, Chiara 5. MC Giulia, Claudia, Sanagul, Chemsedinne, Ambra 6. DAQ and electronics Davide, Krzysztof, Fabrizio, Valerio T, Edoardo, Giuseppe, Marcin 7. Analysis tools and data storage Krzysztof, Sanagul, Chemsedinne, Ambra, Giuseppe, Aldo, Marcin, Claudia 8. Test of materials and PMTs Gabriella, Maria Luisa, Aldo 9. Glove box Valerio P, Marco, Giulia, Manlio, Claudia, Giacomo Chiodi 10.Enclosure Attilio, Alessandro, Valreio P 6
