South Watt Avenue Improvement Project Details

south watt avenue improvement project n.w
1 / 7
Embed
Share

Get detailed insights into the South Watt Avenue Improvement Project, including project background, key features, complete street improvements, funding details, status/schedule, and more. Stay informed about the construction progress and scheduled completion date.

  • Improvement Project
  • Avenue
  • Construction
  • Funding
  • Schedule

Uploaded on | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. South Watt Avenue Improvement Project March 27, 2025

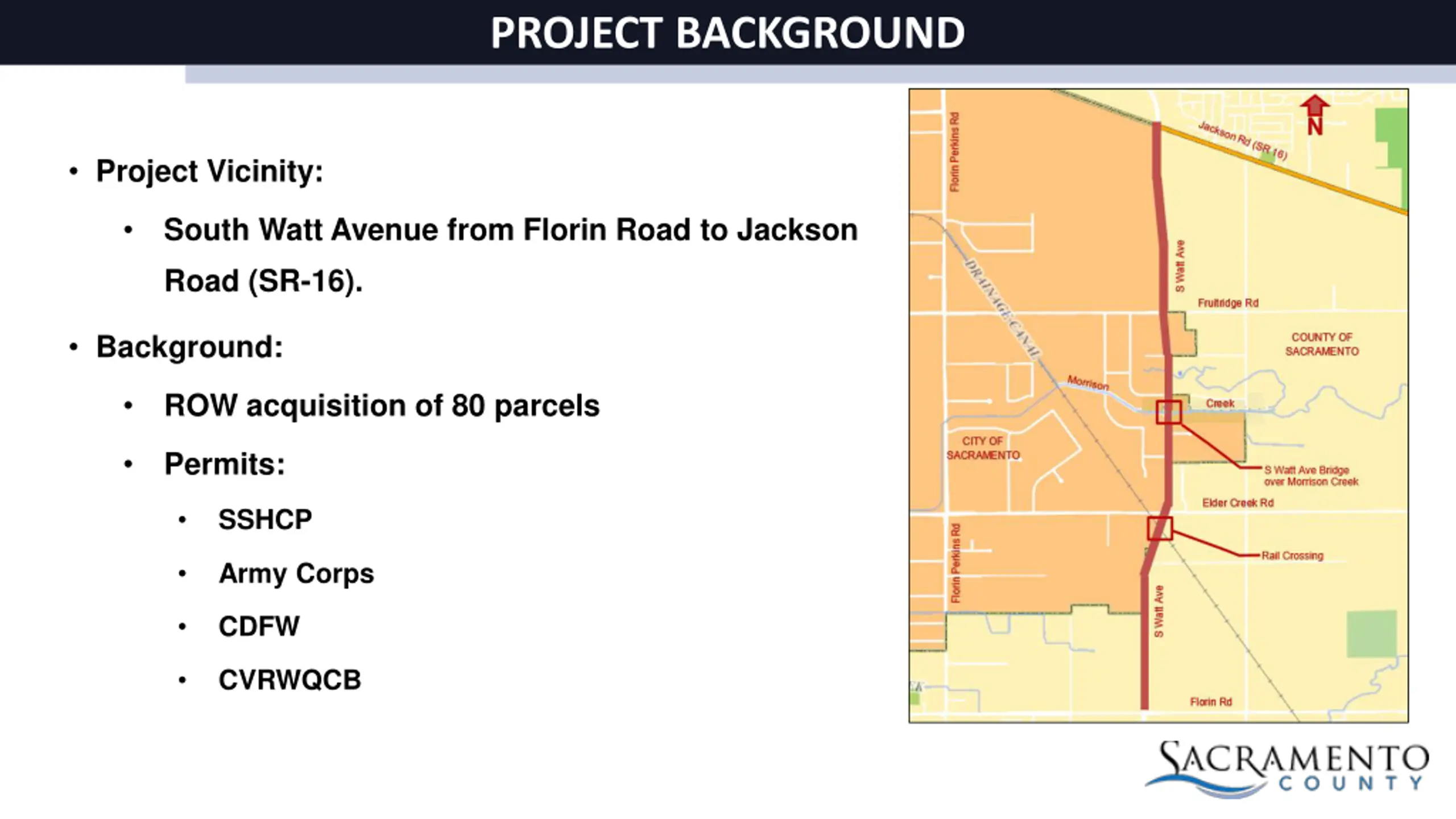

  2. PROJECT BACKGROUND Project Vicinity: South Watt Avenue from Florin Road to Jackson Road (SR-16). Background: ROW acquisition of 80 parcels Permits: SSHCP Army Corps CDFW CVRWQCB

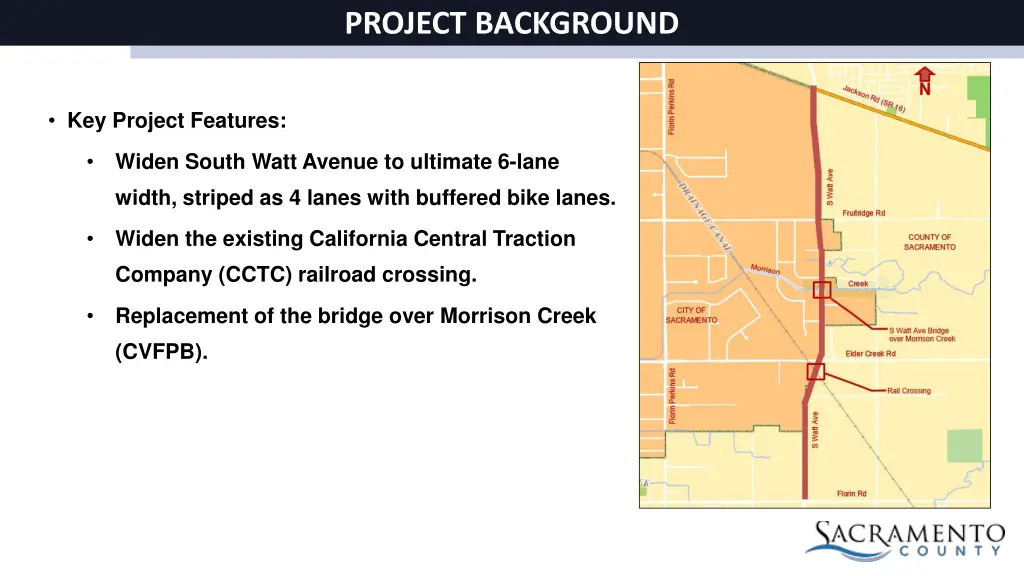

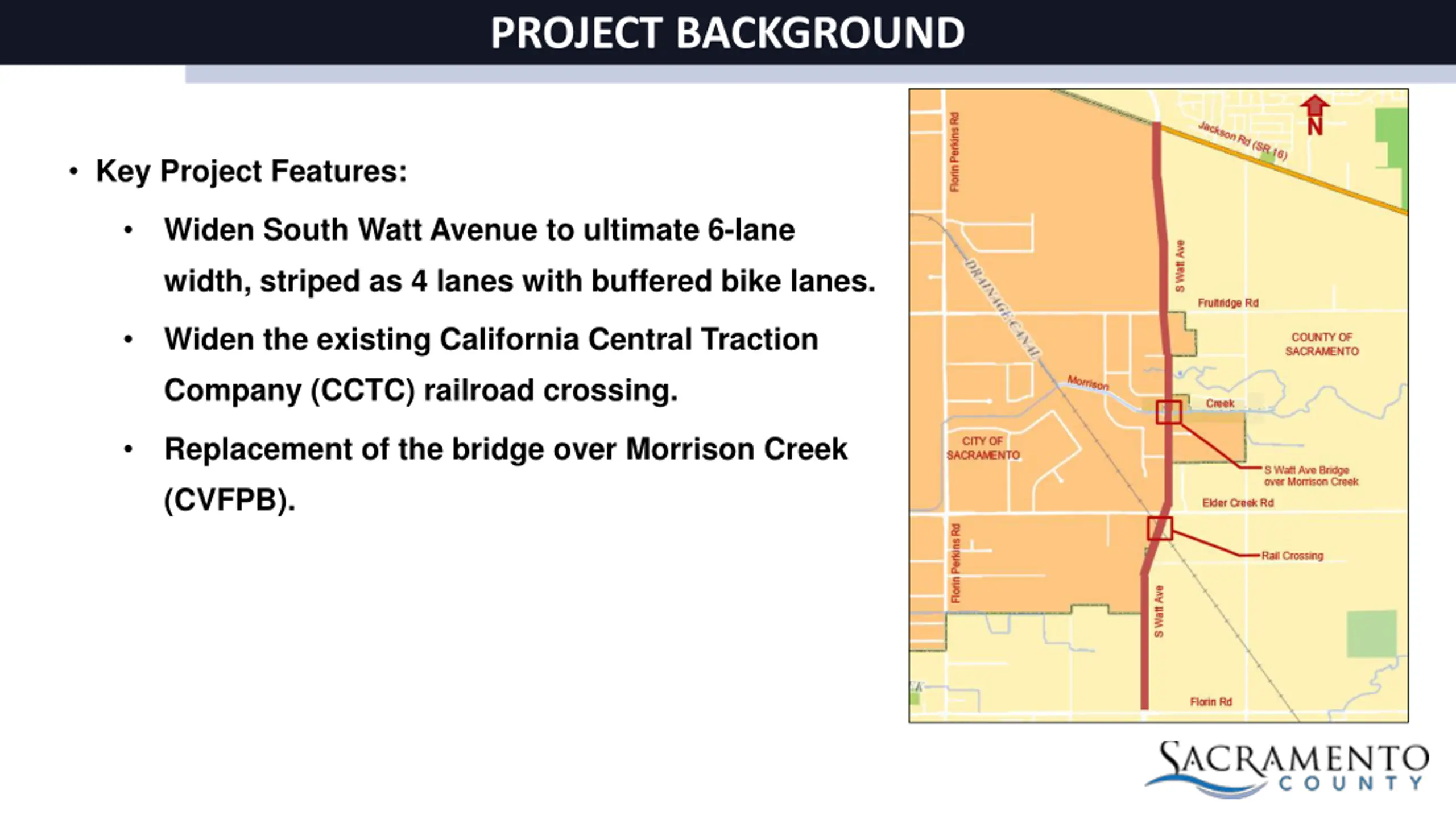

  3. PROJECT BACKGROUND Key Project Features: Widen South Watt Avenue to ultimate 6-lane width, striped as 4 lanes with buffered bike lanes. Widen the existing California Central Traction Company (CCTC) railroad crossing. Replacement of the bridge over Morrison Creek (CVFPB).

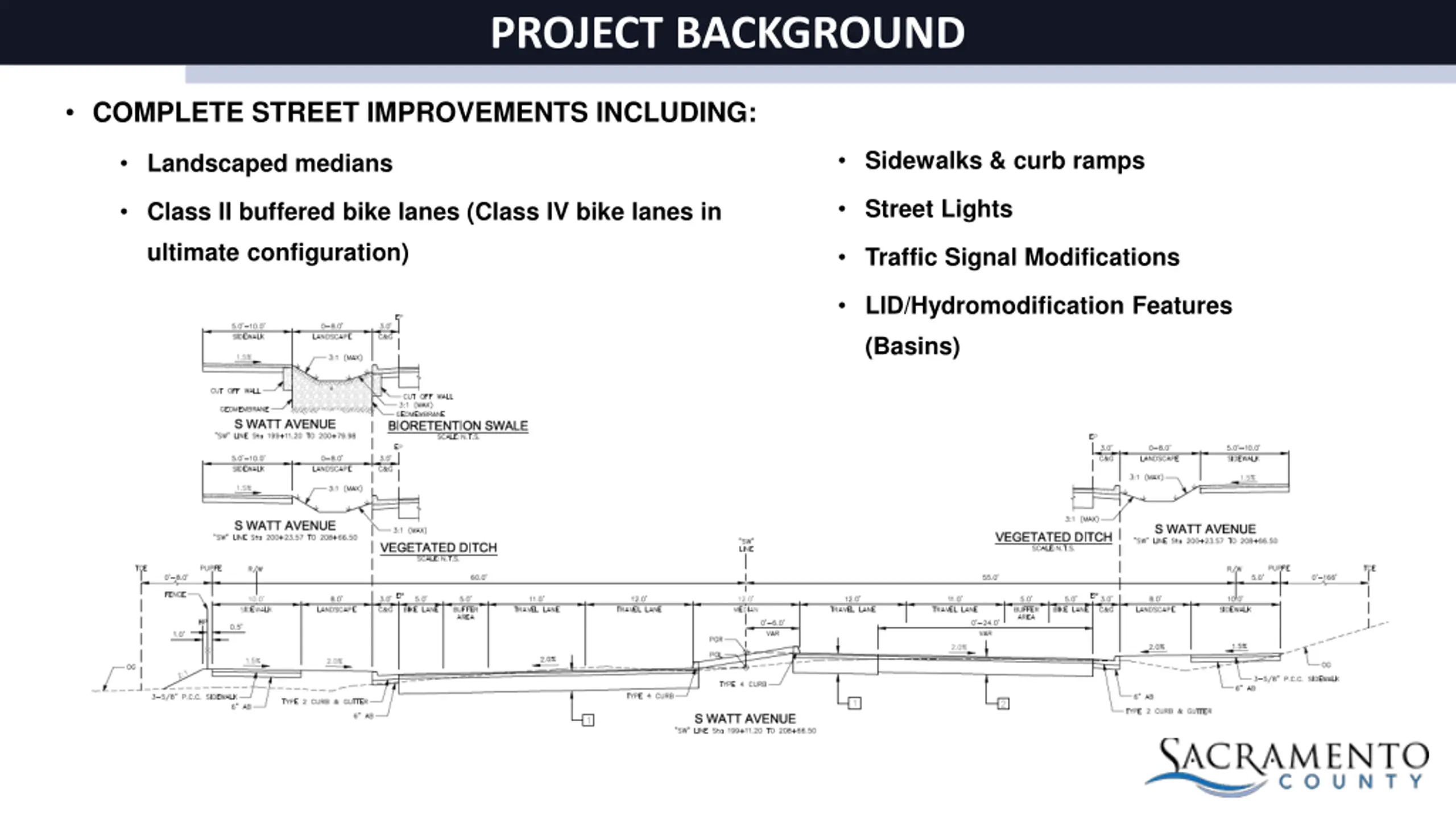

  4. PROJECT BACKGROUND COMPLETE STREET IMPROVEMENTS INCLUDING: Sidewalks & curb ramps Landscaped medians Street Lights Class II buffered bike lanes (Class IV bike lanes in ultimate configuration) Traffic Signal Modifications LID/Hydromodification Features (Basins)

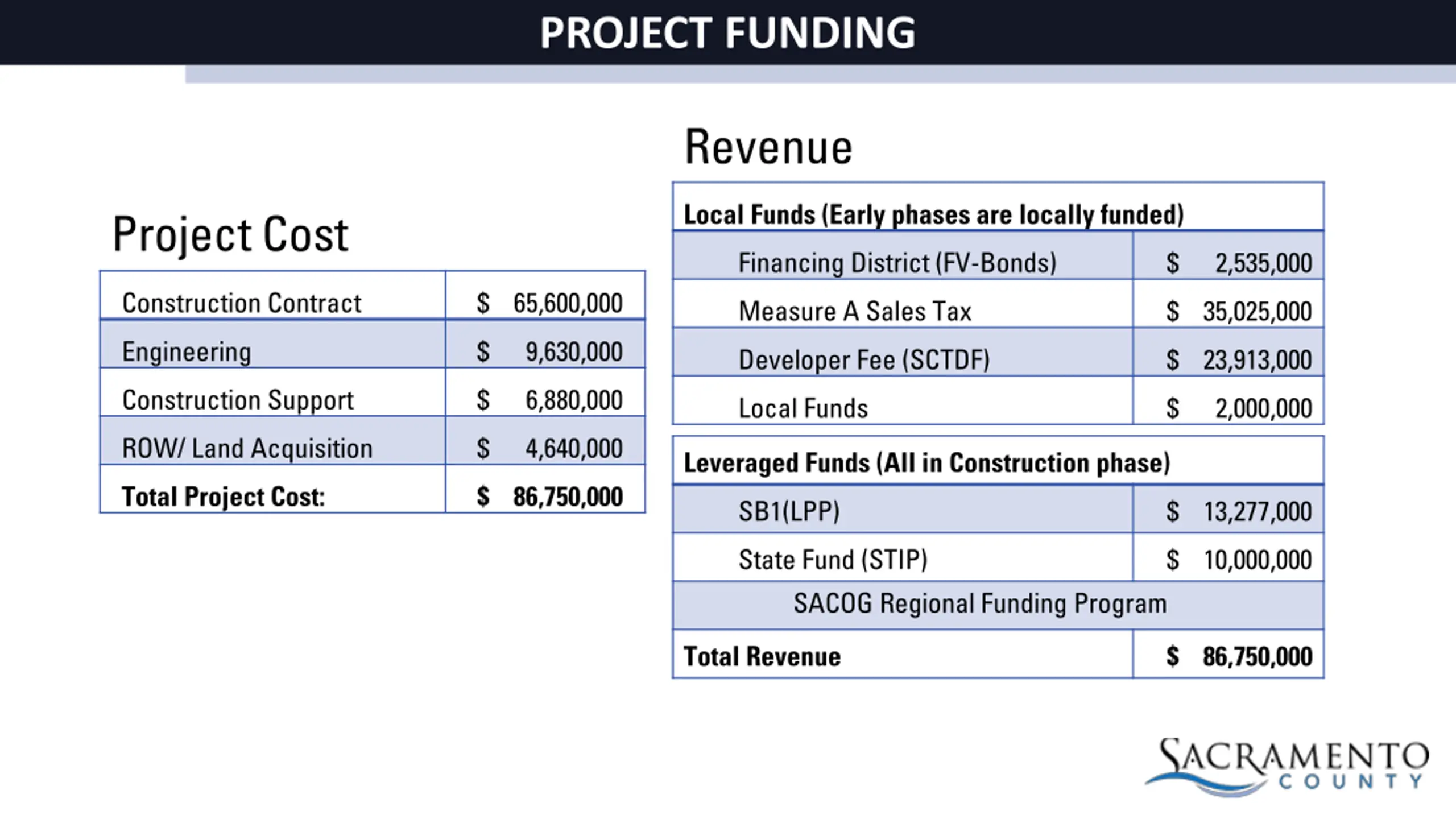

  5. PROJECT FUNDING Revenue Local Funds (Early phases are locally funded) Project Cost Financing District (FV-Bonds) $ 2,535,000 Construction Contract $ 65,600,000 Measure A Sales Tax $ 35,025,000 Engineering $ 9,630,000 Developer Fee (SCTDF) $ 23,913,000 Construction Support $ 6,880,000 Local Funds $ 2,000,000 ROW/ Land Acquisition $ 4,640,000 Leveraged Funds (All in Construction phase) Total Project Cost: $ 86,750,000 SB1(LPP) $ 13,277,000 State Fund (STIP) SACOG Regional Funding Program $ 10,000,000 Total Revenue $ 86,750,000

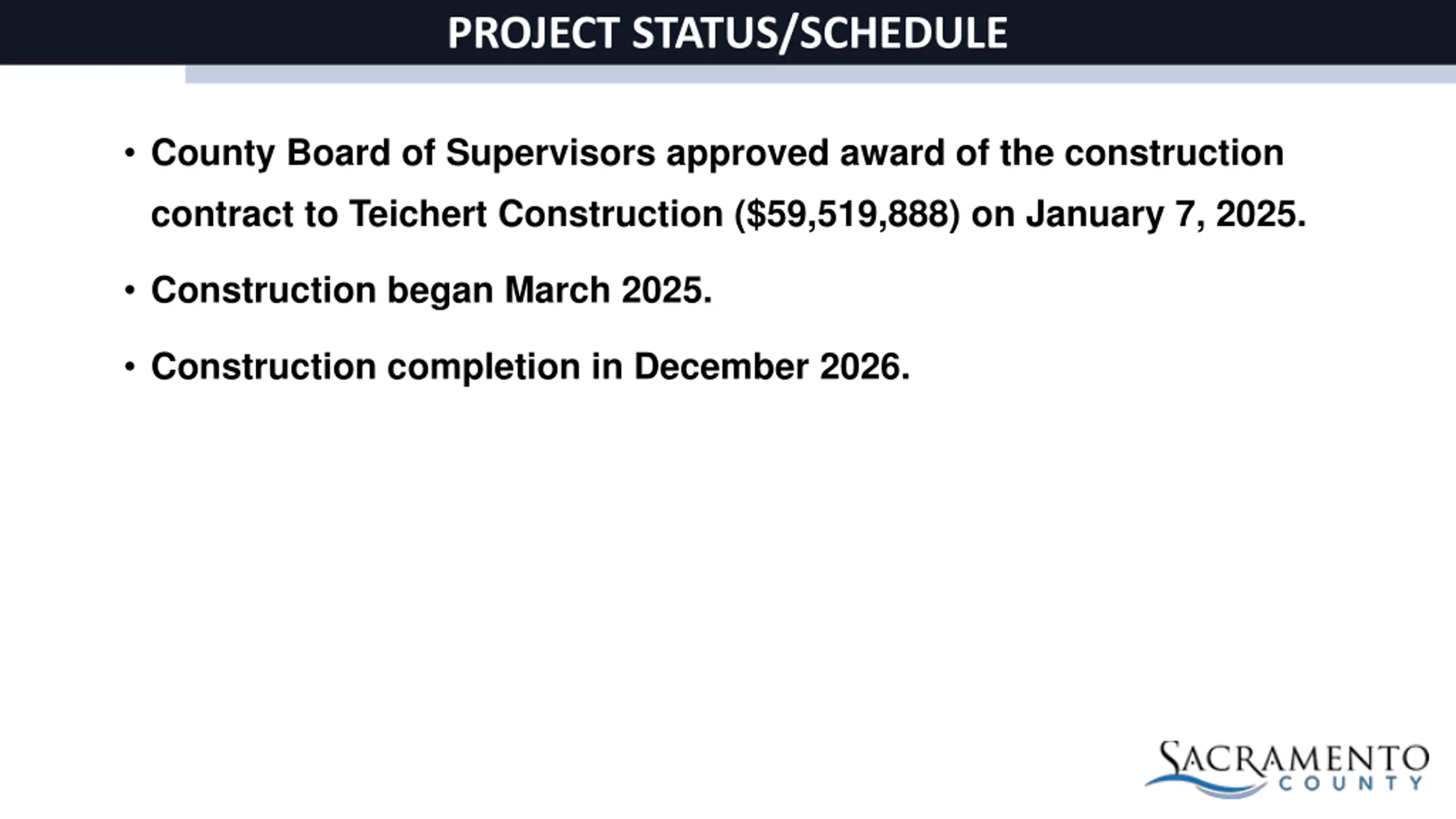

  6. PROJECT STATUS/SCHEDULE County Board of Supervisors approved award of the construction contract to Teichert Construction ($59,519,888) on January 7, 2025. Construction began March 2025. Construction completion in December 2026.

  7. South Watt Avenue Improvement Project QUESTIONS?
