Submission Process for Ride-Through Capabilities via RIOO
Learn about the submission process for ride-through capabilities, extensions, and exemptions using RIOO for the deadline on April 1, 2025, as per ERCOT requirements. Find out who must submit the GIM template and how to complete the template with referenced files to create a combined Zip file for submission. Additional information on creating change requests and attaching Zip files is also provided.
Download Presentation

Please find below an Image/Link to download the presentation.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.
You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.
The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.
E N D
Presentation Transcript
GIM Template: Submittal Process for Ride-Through Capabilities, Extensions, and Exemptions Via RIOO Joel Koepke Sr. Manager Grid Coordination 3/10/25

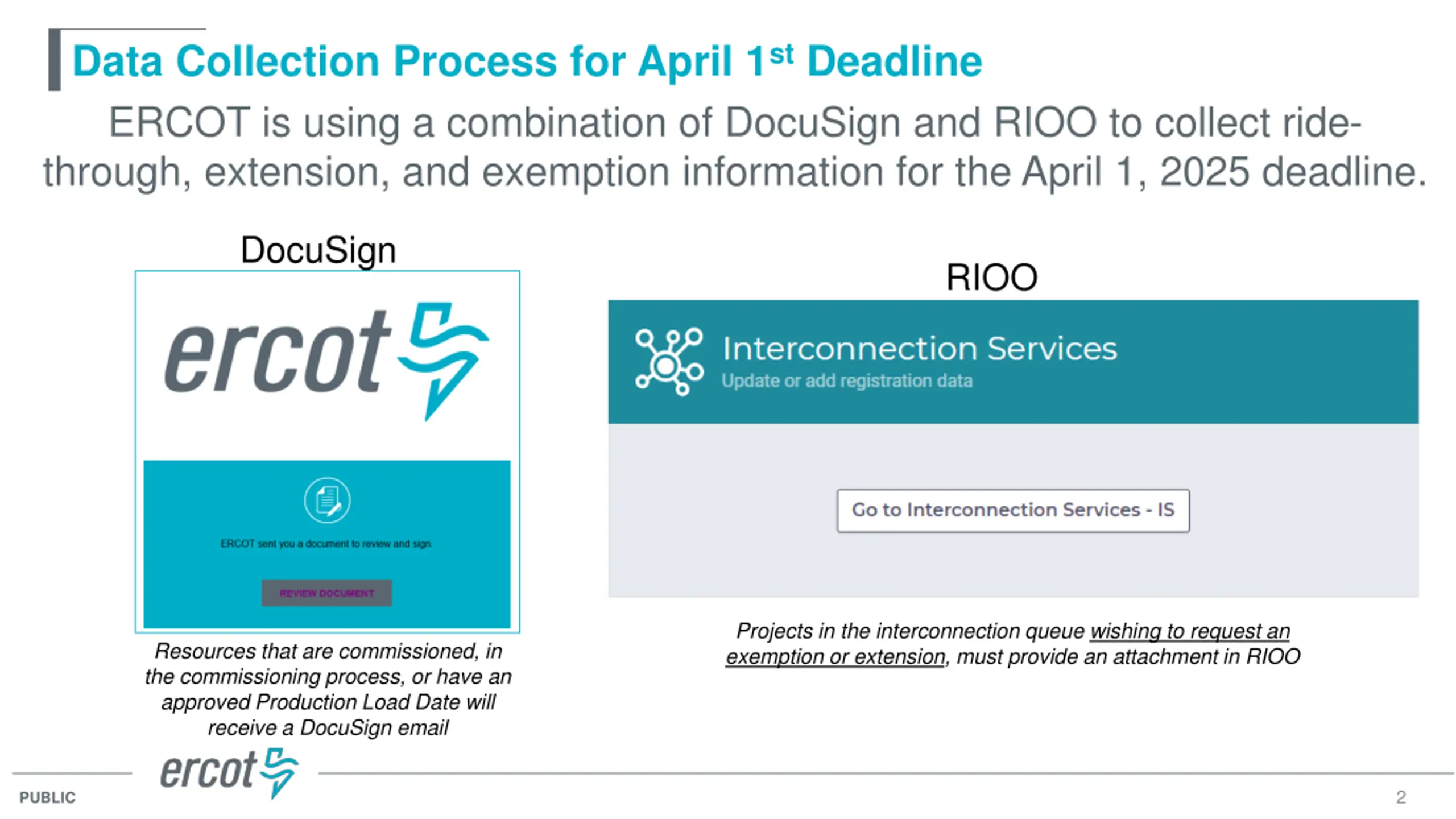

Data Collection Process for April 1st Deadline ERCOT is using a combination of DocuSign and RIOO to collect ride- through, extension, and exemption information for the April 1, 2025 deadline. DocuSign RIOO Projects in the interconnection queue wishing to request an exemption or extension, must provide an attachment in RIOO Resources that are commissioned, in the commissioning process, or have an approved Production Load Date will receive a DocuSign email 2 PUBLIC

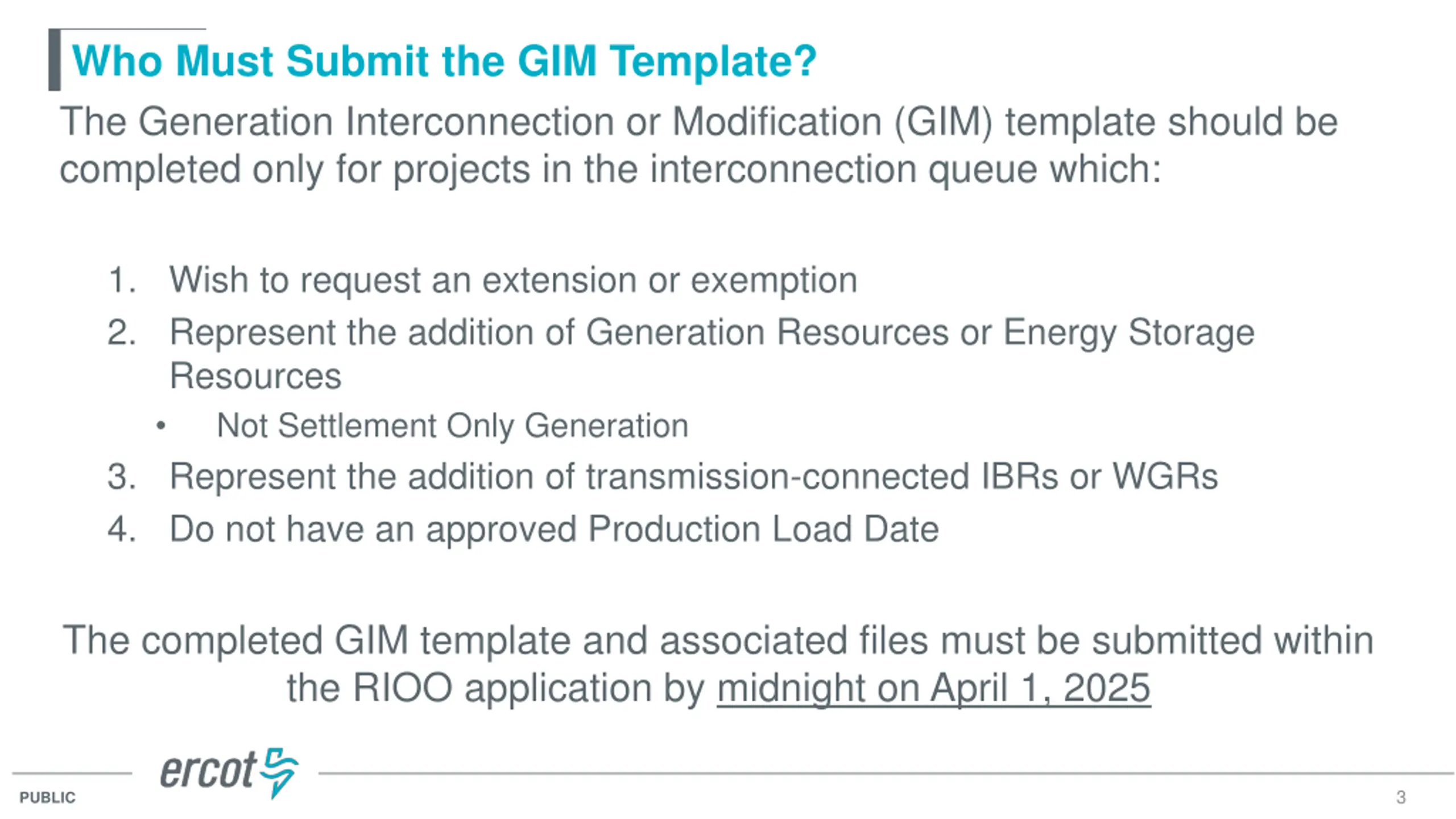

Who Must Submit the GIM Template? The Generation Interconnection or Modification (GIM) template should be completed only for projects in the interconnection queue which: 1. Wish to request an extension or exemption 2. Represent the addition of Generation Resources or Energy Storage Resources Not Settlement Only Generation 3. Represent the addition of transmission-connected IBRs or WGRs 4. Do not have an approved Production Load Date The completed GIM template and associated files must be submitted within the RIOO application by midnight on April 1, 2025 3 PUBLIC

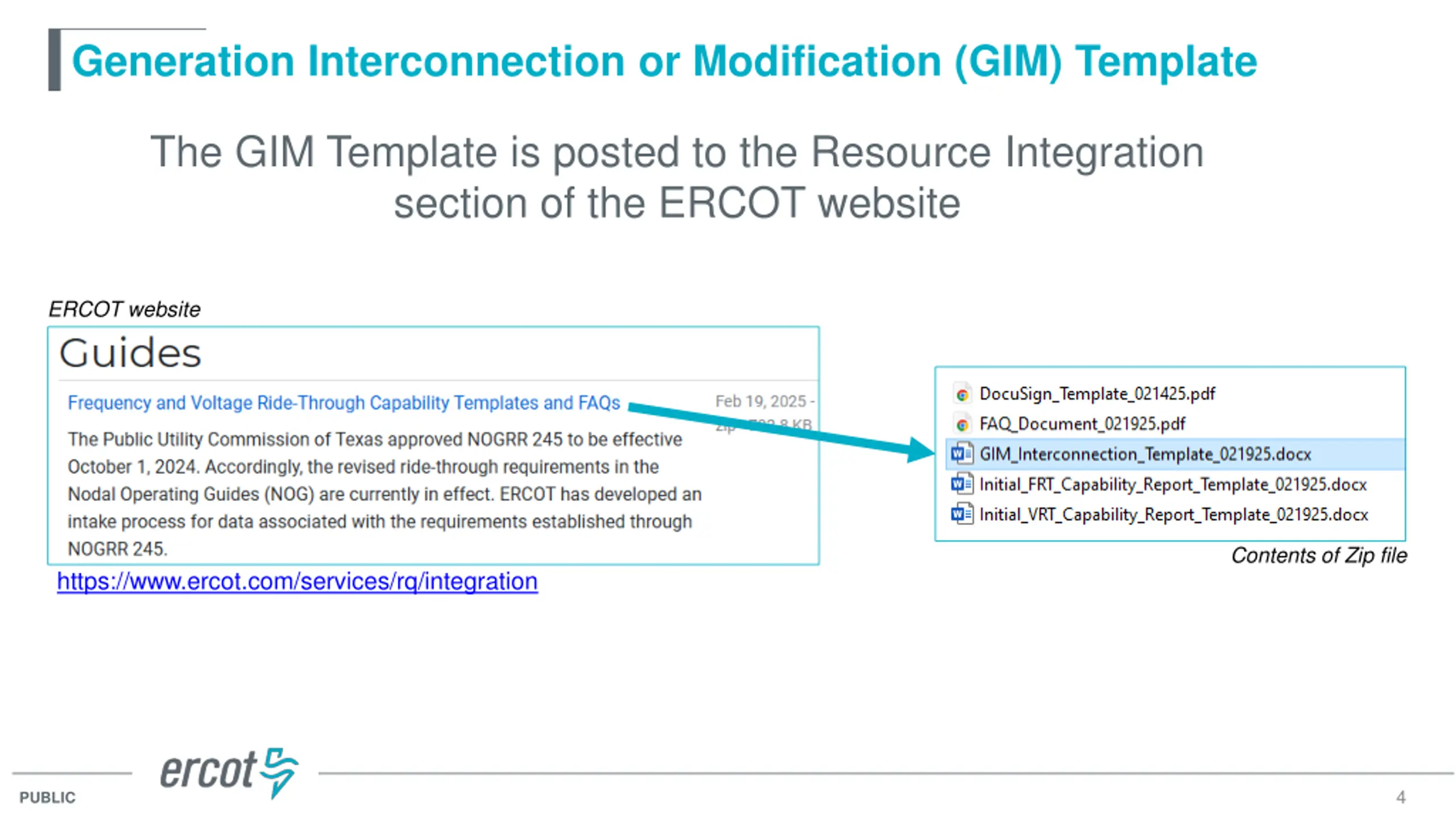

Generation Interconnection or Modification (GIM) Template The GIM Template is posted to the Resource Integration section of the ERCOT website ERCOT website Contents of Zip file https://www.ercot.com/services/rq/integration 4 PUBLIC
Complete the GIM Template Responses can only be provided in specific locations Files cannot be attached within the Word document. Instead, they are referenced by file name. 5 PUBLIC

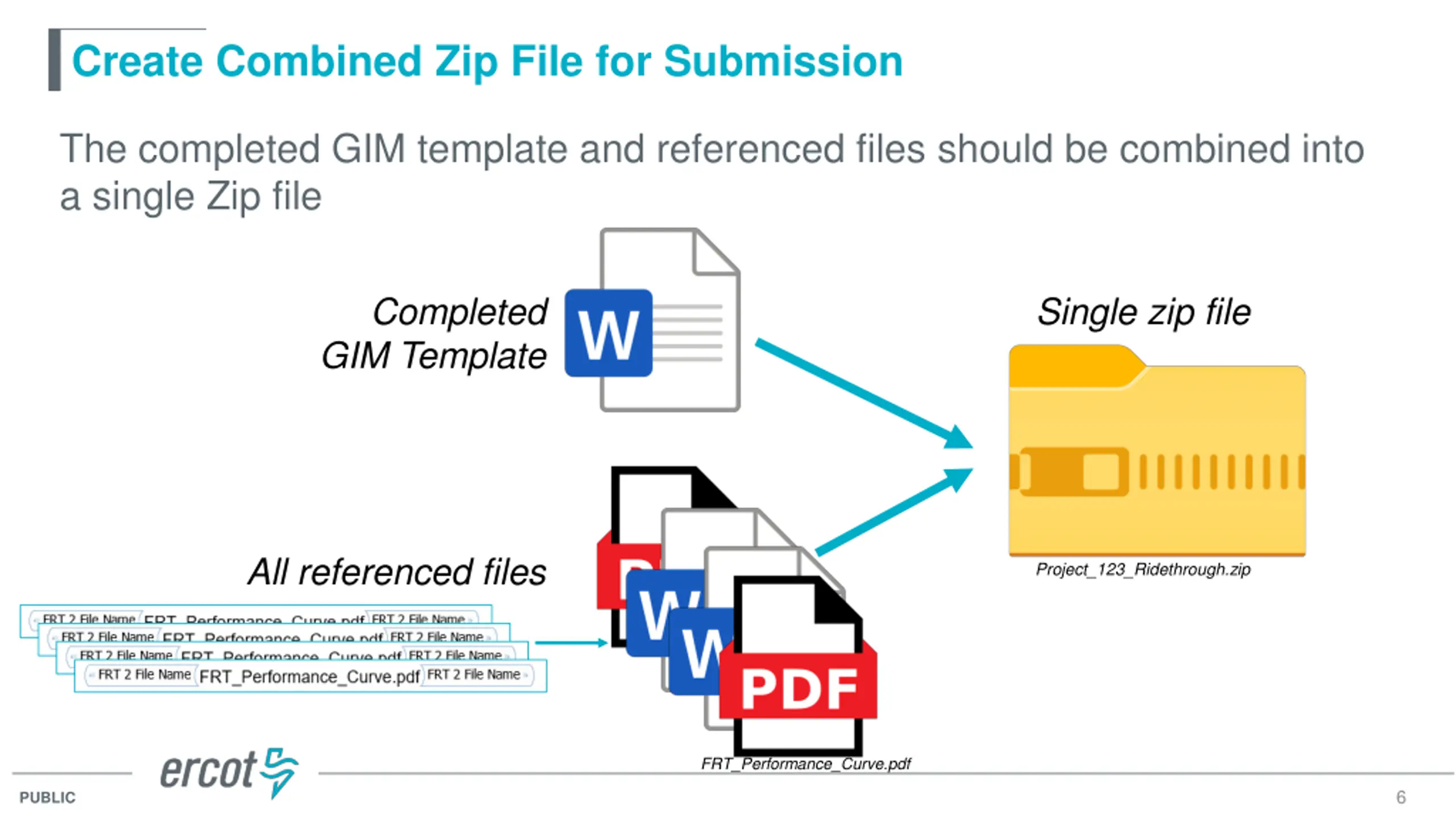

Create Combined Zip File for Submission The completed GIM template and referenced files should be combined into a single Zip file Completed GIM Template Single zip file All referenced files Project_123_Ridethrough.zip FRT_Performance_Curve.pdf 6 PUBLIC

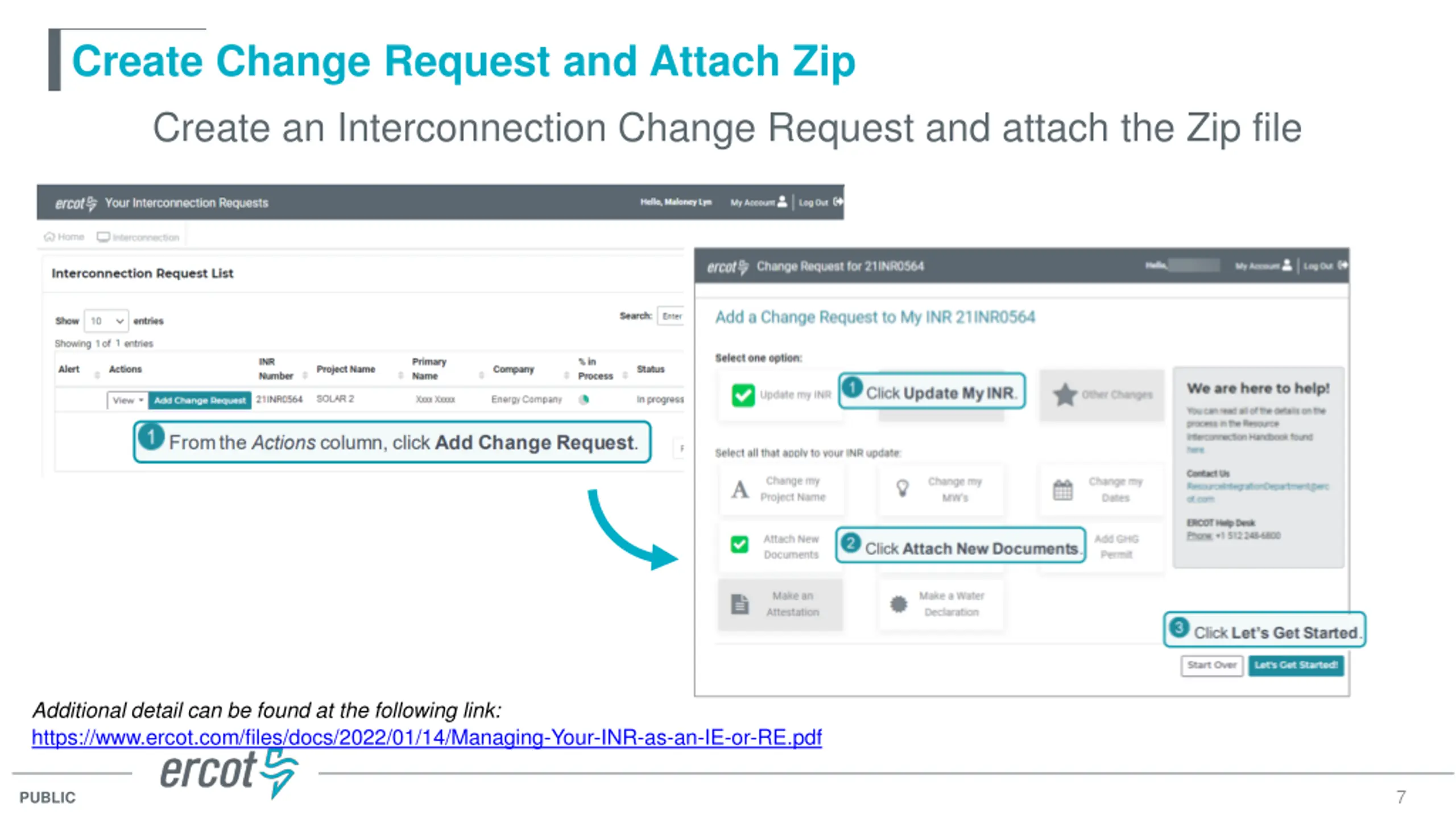

Create Change Request and Attach Zip Create an Interconnection Change Request and attach the Zip file Additional detail can be found at the following link: https://www.ercot.com/files/docs/2022/01/14/Managing-Your-INR-as-an-IE-or-RE.pdf https://www.ercot.com/files/docs/2022/01/14/Managing-Your-INR-as-an-IE-or-RE.pdf 7 PUBLIC

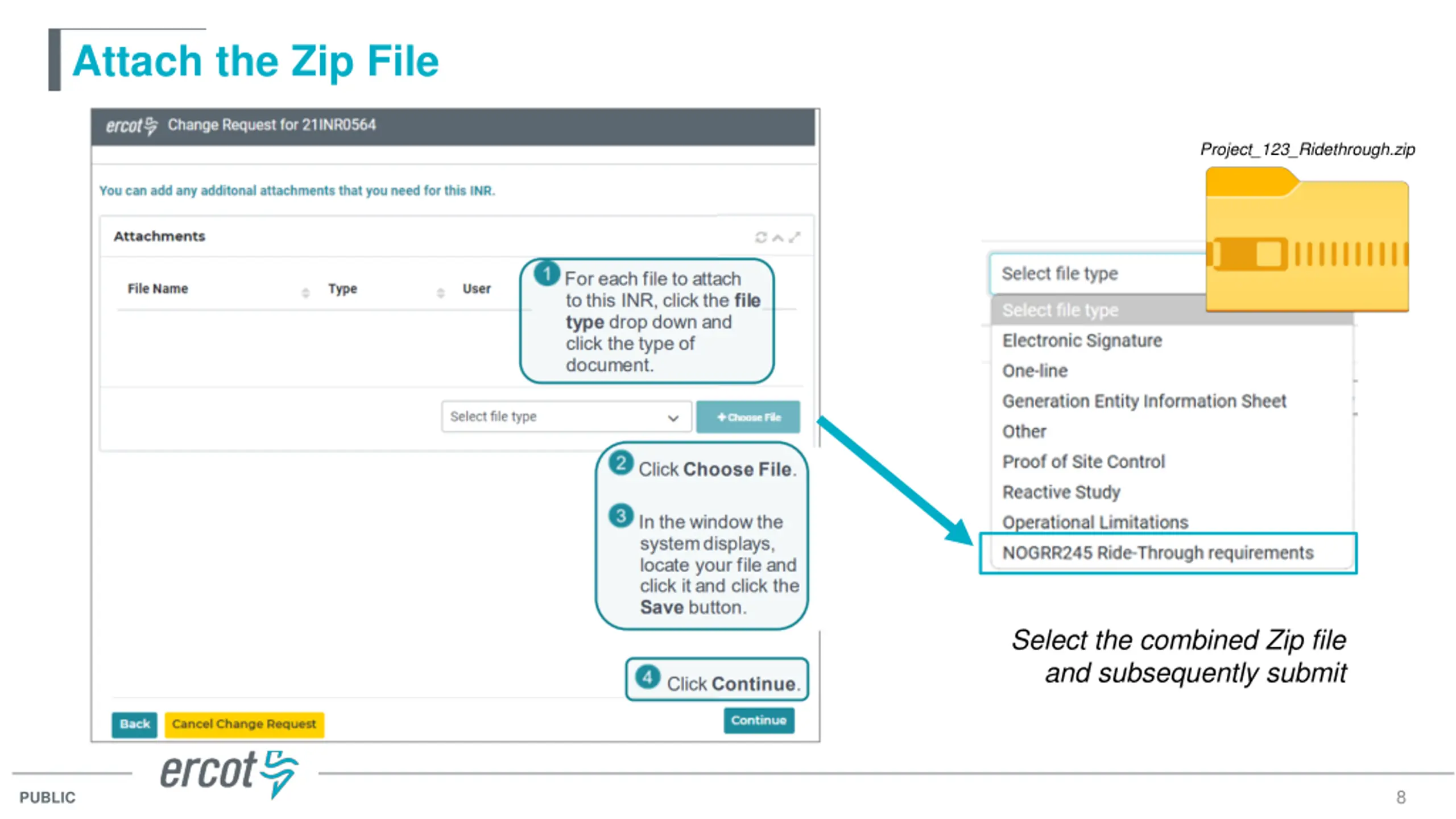

Attach the Zip File Project_123_Ridethrough.zip Select the combined Zip file and subsequently submit 8 PUBLIC

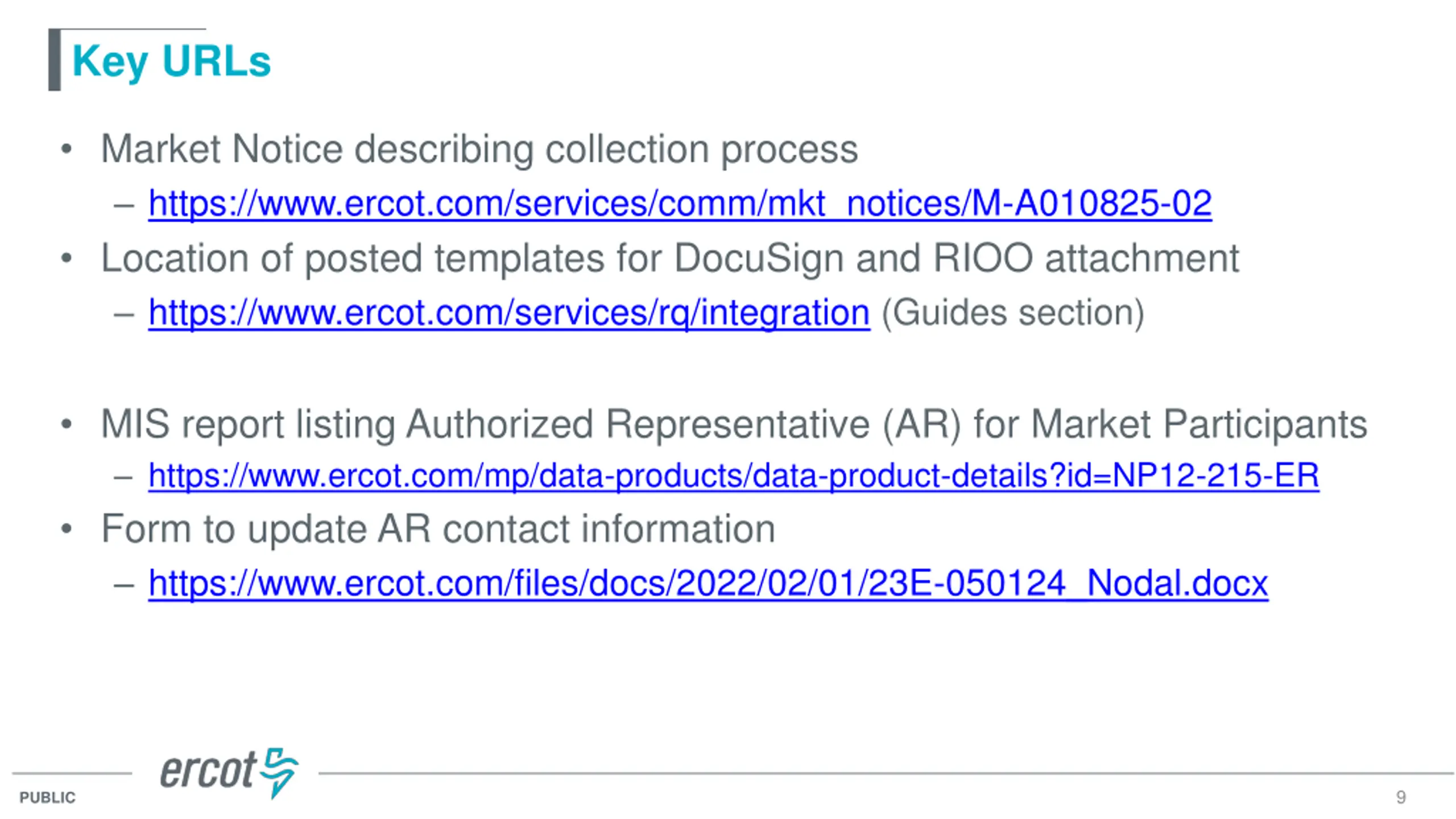

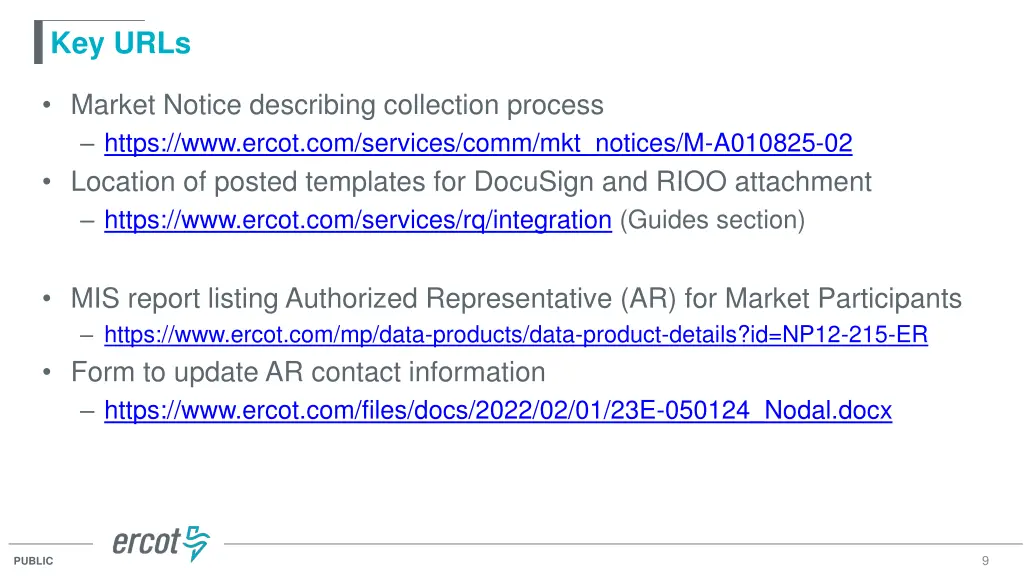

Key URLs Market Notice describing collection process https://www.ercot.com/services/comm/mkt_notices/M-A010825-02 Location of posted templates for DocuSign and RIOO attachment https://www.ercot.com/services/rq/integration (Guides section) MIS report listing Authorized Representative (AR) for Market Participants https://www.ercot.com/mp/data-products/data-product-details?id=NP12-215-ER Form to update AR contact information https://www.ercot.com/files/docs/2022/02/01/23E-050124_Nodal.docx 9 PUBLIC
Questions? 10 PUBLIC
