2017 RTP Scope Update and Process Highlights

2017 rtp scope update n.w
1 / 13
Embed
Share

Explore the key updates and processes discussed in the 2017 RTP Scope Update and Process document, including input assumptions, methodology, and the load review process. Stakeholders are encouraged to review and provide feedback on the upcoming RTP start cases.

  • RTP Scope Update
  • Process Highlights
  • Load Review Process
  • Stakeholder Feedback
  • Methodology

Uploaded on | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. 2017 RTP Scope Update November, 2016 RPG Meeting

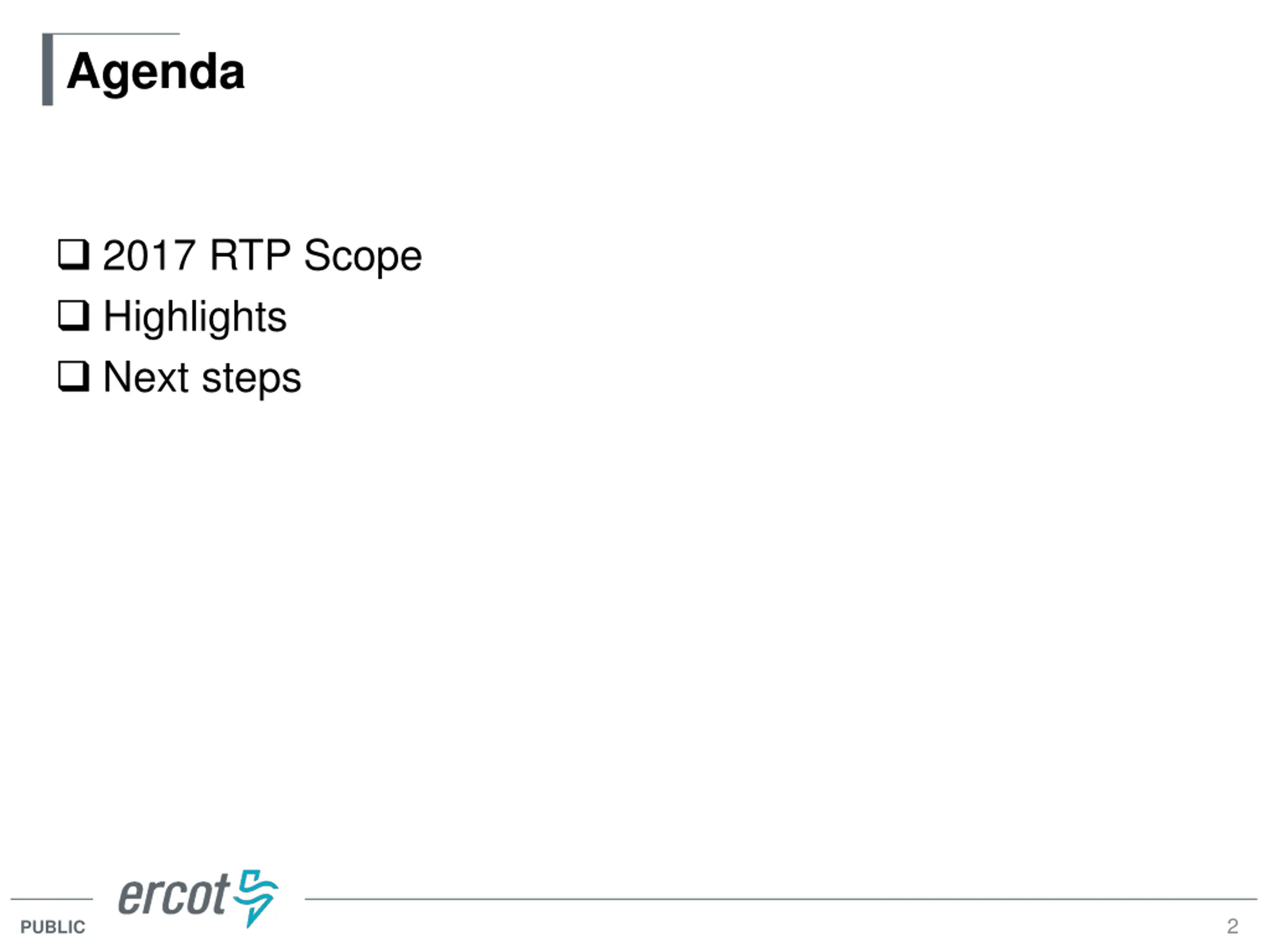

  2. Agenda 2017 RTP Scope Highlights Next steps 2 PUBLIC

  3. 2017 RTP Scope and Process Document 2017 RTP Scope was shared with RPG for comments and feedback on October 21, 2016 The document is also available on the November RPG meeting page : (http://www.ercot.com/content/wcm/key_documents_lists/77750/2017_RTP_Scope_and_Pro cess_draft_v1.docx) 3 PUBLIC

  4. Highlight: Addendum for input assumptions 2017 RTP scope and process document will be supplemented by an Addendum Addendum shall have specifics about the input assumptions for 2017 RTP 4 PUBLIC

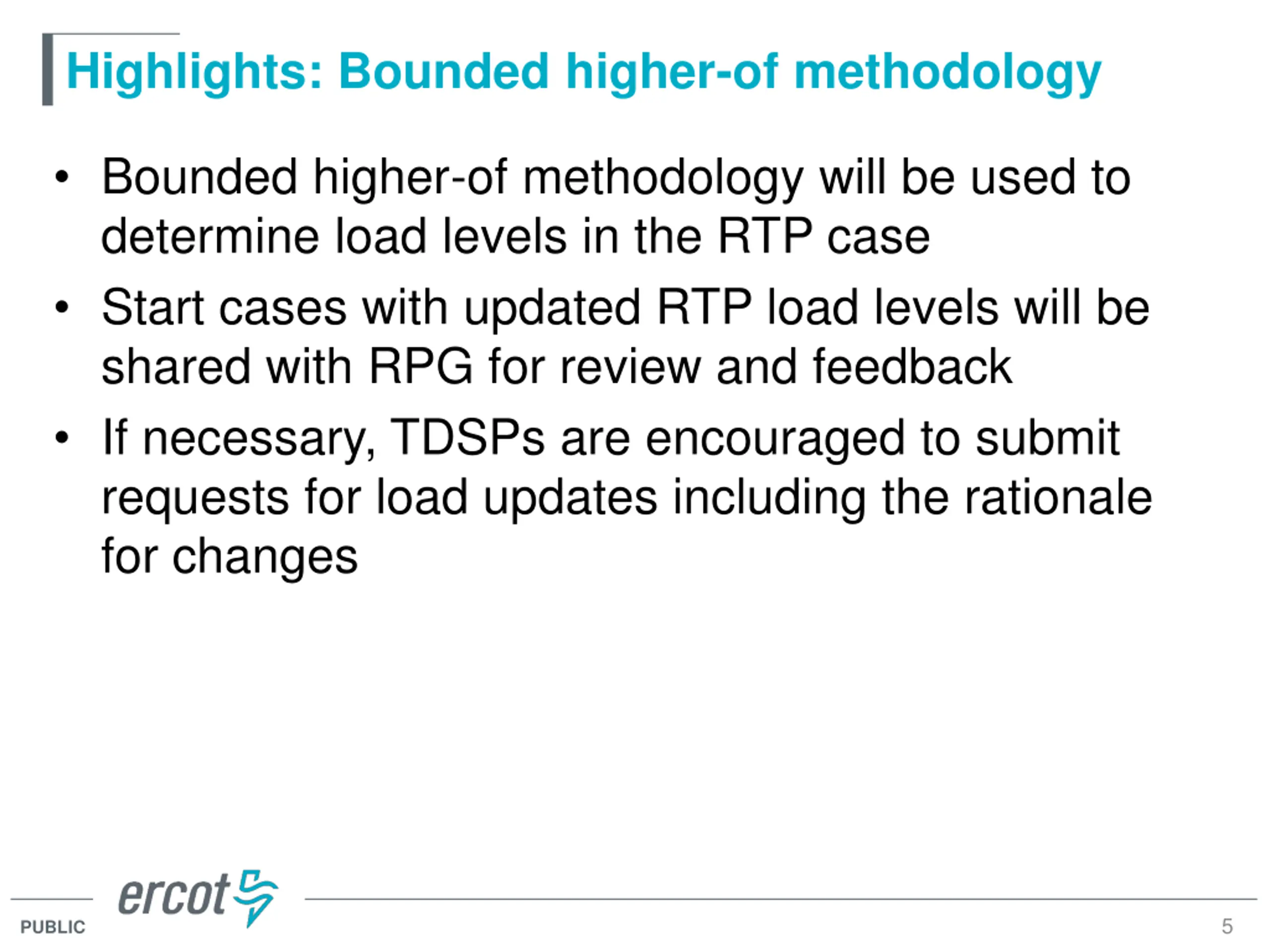

  5. Highlights: Bounded higher-of methodology Bounded higher-of methodology will be used to determine load levels in the RTP case Start cases with updated RTP load levels will be shared with RPG for review and feedback If necessary, TDSPs are encouraged to submit requests for load updates including the rationale for changes 5 PUBLIC

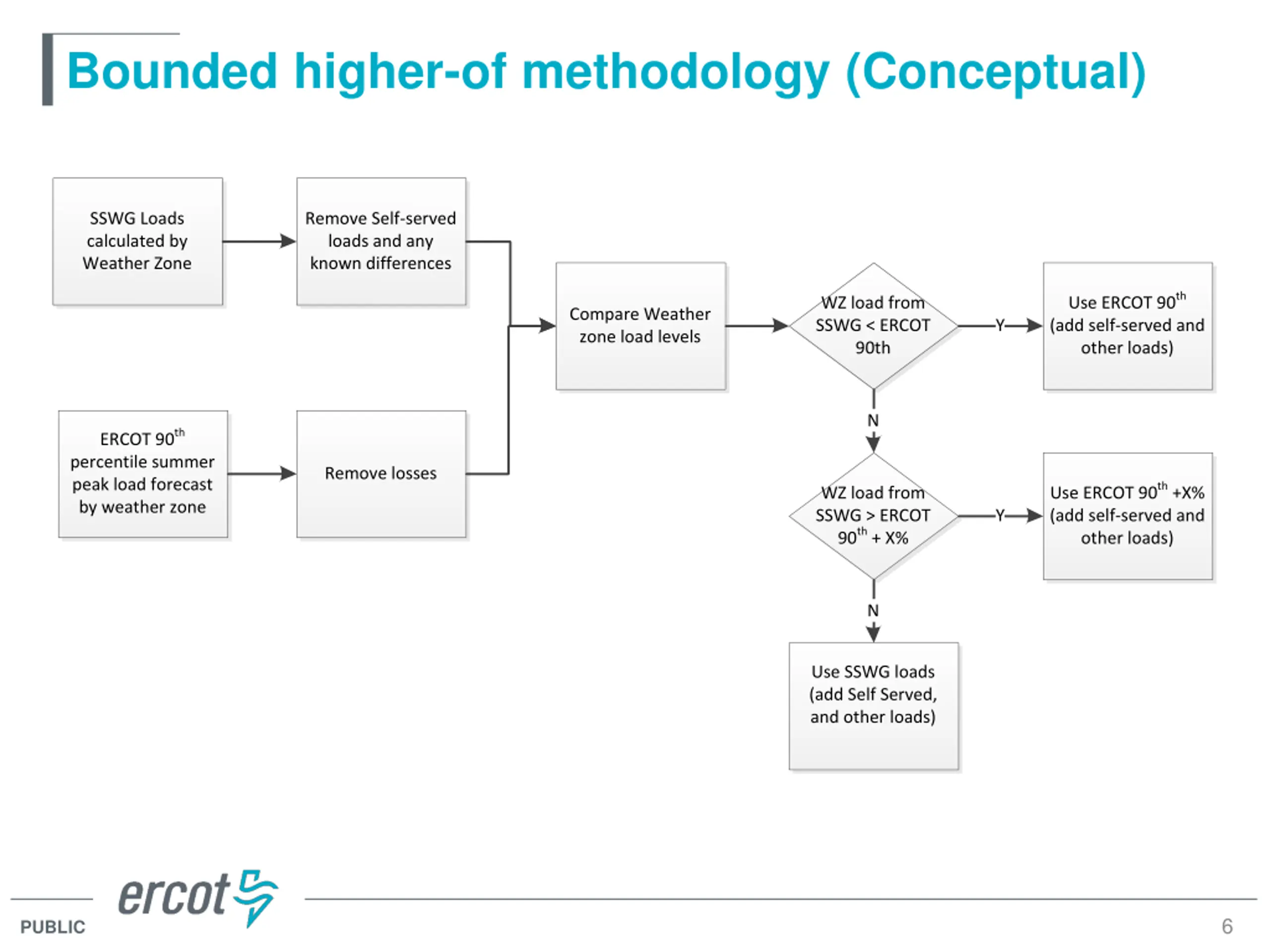

  6. Bounded higher-of methodology (Conceptual) SSWG Loads calculated by Weather Zone Remove Self-served loads and any known differences Use ERCOT 90th (add self-served and other loads) WZ load from SSWG < ERCOT 90th Compare Weather zone load levels Y N ERCOT 90th percentile summer peak load forecast by weather zone Remove losses Use ERCOT 90th +X% (add self-served and other loads) WZ load from SSWG > ERCOT 90th + X% Y N Use SSWG loads (add Self Served, and other loads) 6 PUBLIC

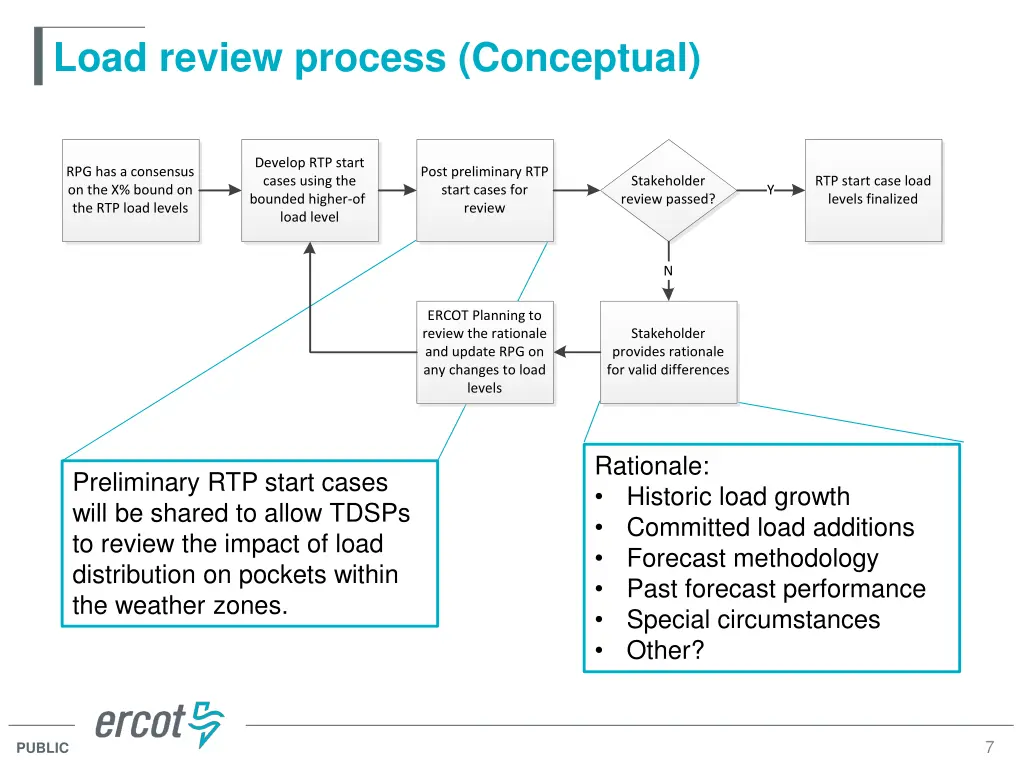

  7. Load review process (Conceptual) Develop RTP start cases using the bounded higher-off load level RPG has a consensus on the X% bound on the RTP load levels Post preliminary RTP start cases for review Stakeholder review passed? RTP start case load levels finalized Y N ERCOT Planning to review the rationale and update RPG on any changes to load levels Stakeholder provides rationale for valid differences Rationale: Historic load growth Committed load additions Forecast methodology Past forecast performance Special circumstances Other? Preliminary RTP start cases will be shared to allow TDSPs to review the impact of load distribution on pockets within the weather zones. 7 PUBLIC

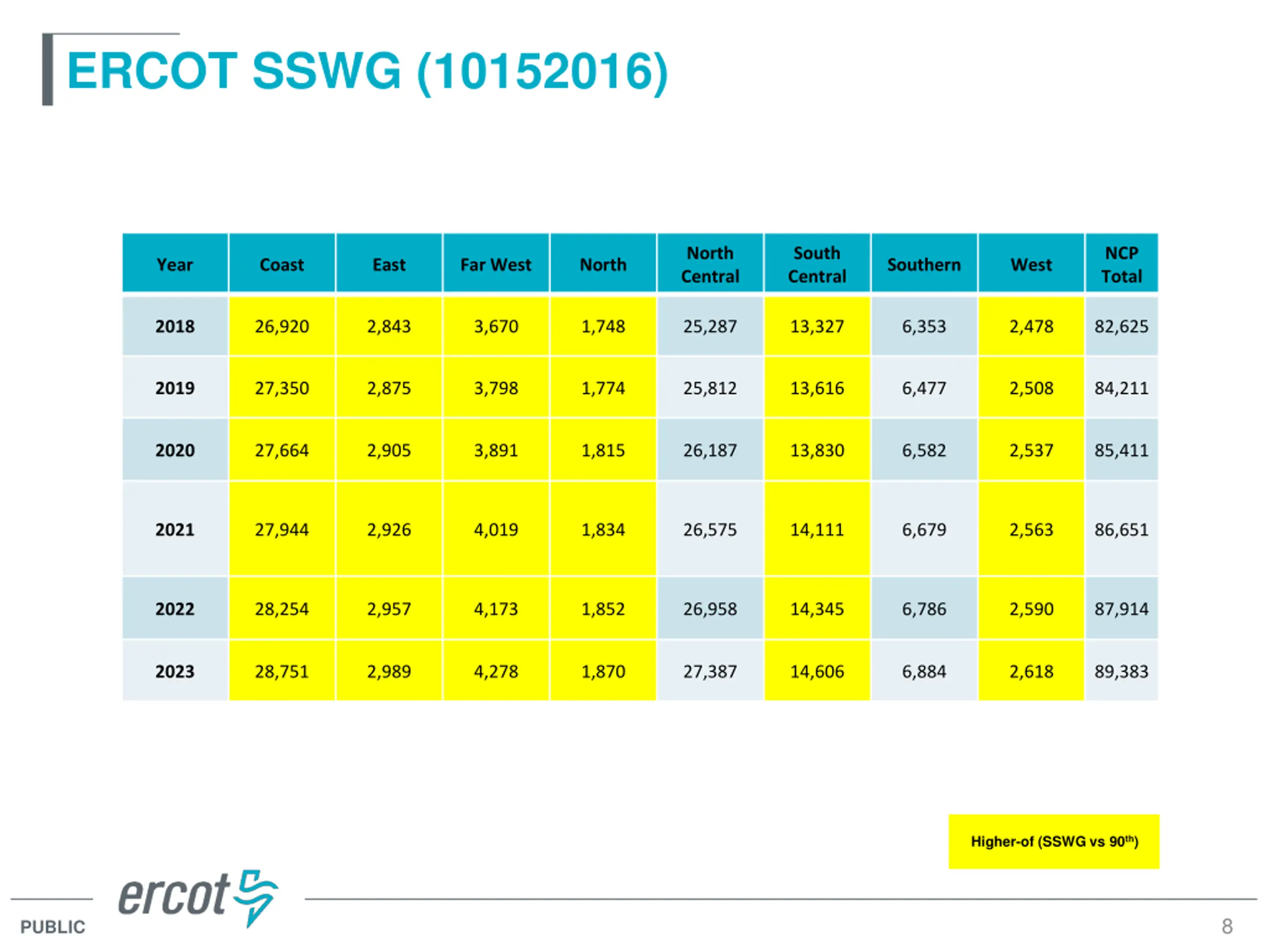

  8. ERCOT SSWG (10152016) North Central South Central NCP Total Year Coast East Far West North Southern West 2018 26,920 2,843 3,670 1,748 25,287 13,327 6,353 2,478 82,625 2019 27,350 2,875 3,798 1,774 25,812 13,616 6,477 2,508 84,211 2020 27,664 2,905 3,891 1,815 26,187 13,830 6,582 2,537 85,411 2021 27,944 2,926 4,019 1,834 26,575 14,111 6,679 2,563 86,651 2022 28,254 2,957 4,173 1,852 26,958 14,345 6,786 2,590 87,914 2023 28,751 2,989 4,278 1,870 27,387 14,606 6,884 2,618 89,383 Higher-of (SSWG vs 90th) 8 PUBLIC

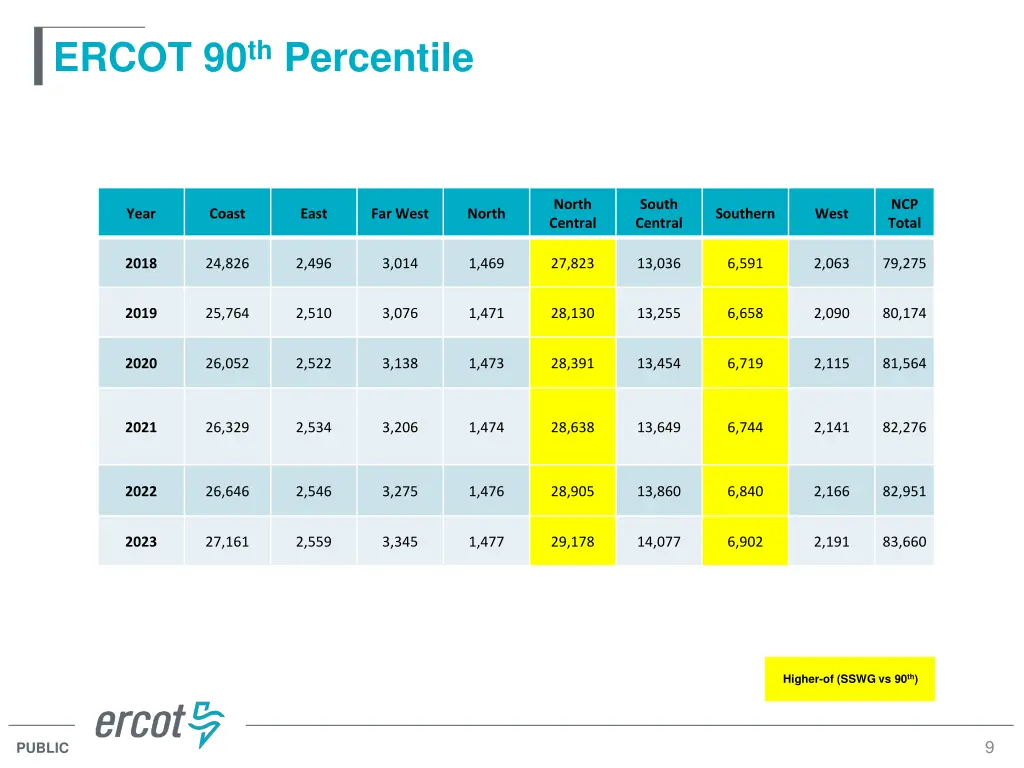

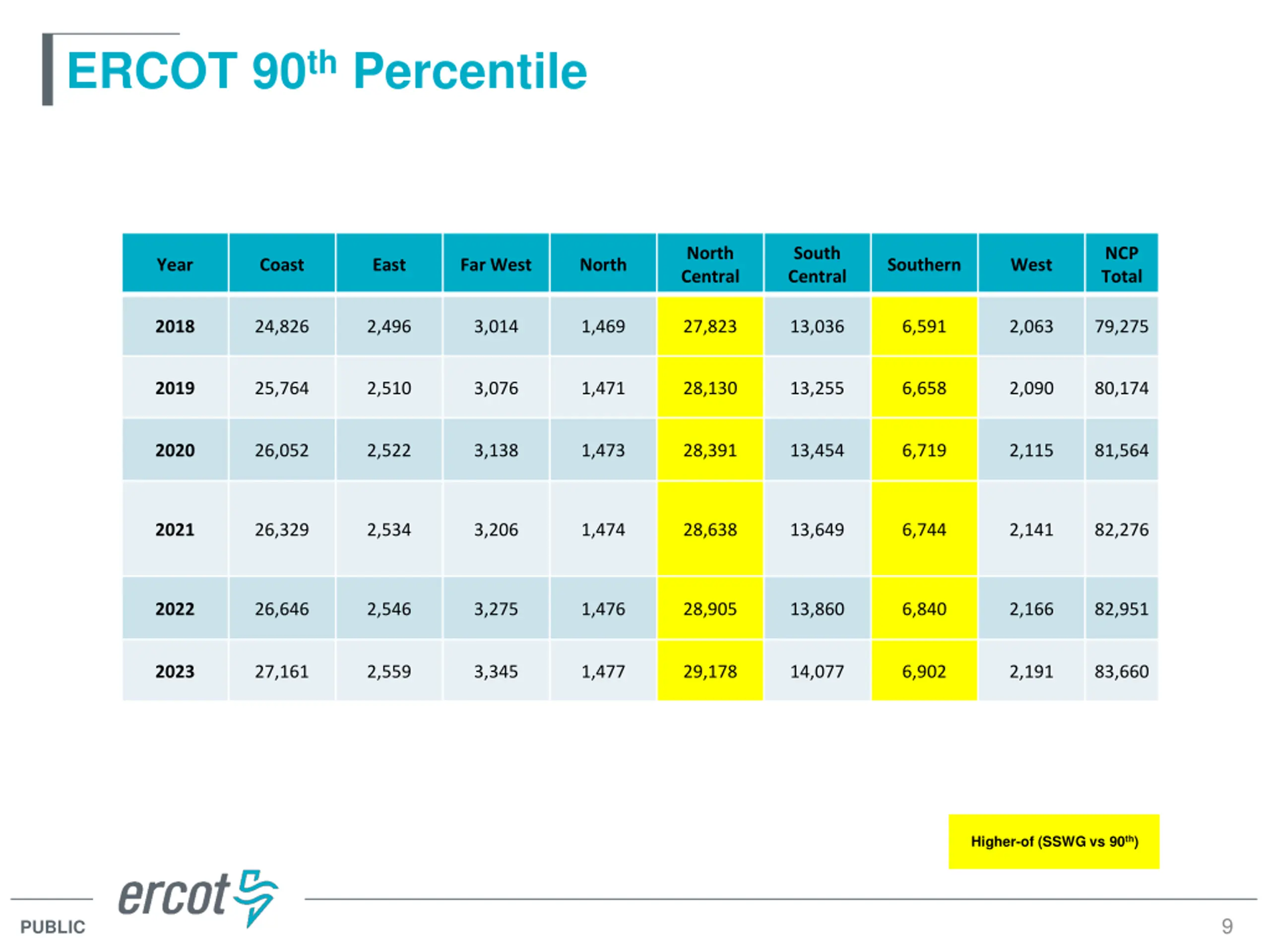

  9. ERCOT 90th Percentile North Central South Central NCP Total Year Coast East Far West North Southern West 2018 24,826 2,496 3,014 1,469 27,823 13,036 6,591 2,063 79,275 2019 25,764 2,510 3,076 1,471 28,130 13,255 6,658 2,090 80,174 2020 26,052 2,522 3,138 1,473 28,391 13,454 6,719 2,115 81,564 2021 26,329 2,534 3,206 1,474 28,638 13,649 6,744 2,141 82,276 2022 26,646 2,546 3,275 1,476 28,905 13,860 6,840 2,166 82,951 2023 27,161 2,559 3,345 1,477 29,178 14,077 6,902 2,191 83,660 Higher-of (SSWG vs 90th) 9 PUBLIC

  10. 2017RTP Load - Using Pure Higher-Of North Central South Central NCP Total Year Coast East Far West North Southern West 2018 26,920 2,843 3,670 1,748 27,823 13,327 6,591 2,478 85,400 2019 27,350 2,875 3,798 1,774 28,130 13,616 6,658 2,508 86,710 2020 27,664 2,905 3,891 1,815 28,391 13,830 6,719 2,537 87,752 2021 27,944 2,926 4,019 1,834 28,638 14,111 6,744 2,563 88,779 2022 28,254 2,957 4,173 1,852 28,905 14,345 6,840 2,590 89,915 2023 28,751 2,989 4,278 1,870 29,178 14,606 6,902 2,618 91,191 90th 90th SOURCE SSWG SSWG SSWG SSWG SSWG SSWG 10 PUBLIC

  11. 2017RTP Load - Using 5% Bounded Threshold North Central South Central Year Coast East Far West North Southern West NCP Total (2016RTP) (2017RTP - *OLD*) 2018 26,068 2,620 3,164 1,543 27,823 13,327 6,591 2,166 83,303 -1,507 -2,097 2019 27,052 2,636 3,230 1,545 28,130 13,616 6,658 2,194 85,061 -988 -1,649 2020 27,355 2,649 3,295 1,546 28,391 13,830 6,719 2,221 86,006 -1,152 -1,747 2021 27,645 2,661 3,366 1,548 28,638 14,111 6,744 2,248 86,961 -1,228 -1,818 2022 27,978 2,674 3,439 1,550 28,905 14,345 6,840 2,274 88,004 -1,251 -1,911 2023 28,519 2,686 3,512 1,551 29,178 14,606 6,902 2,300 89,254 - -1,937 90th 90th SOURCE Bounded Bounded Bounded Bounded SSWG Bounded 11 PUBLIC

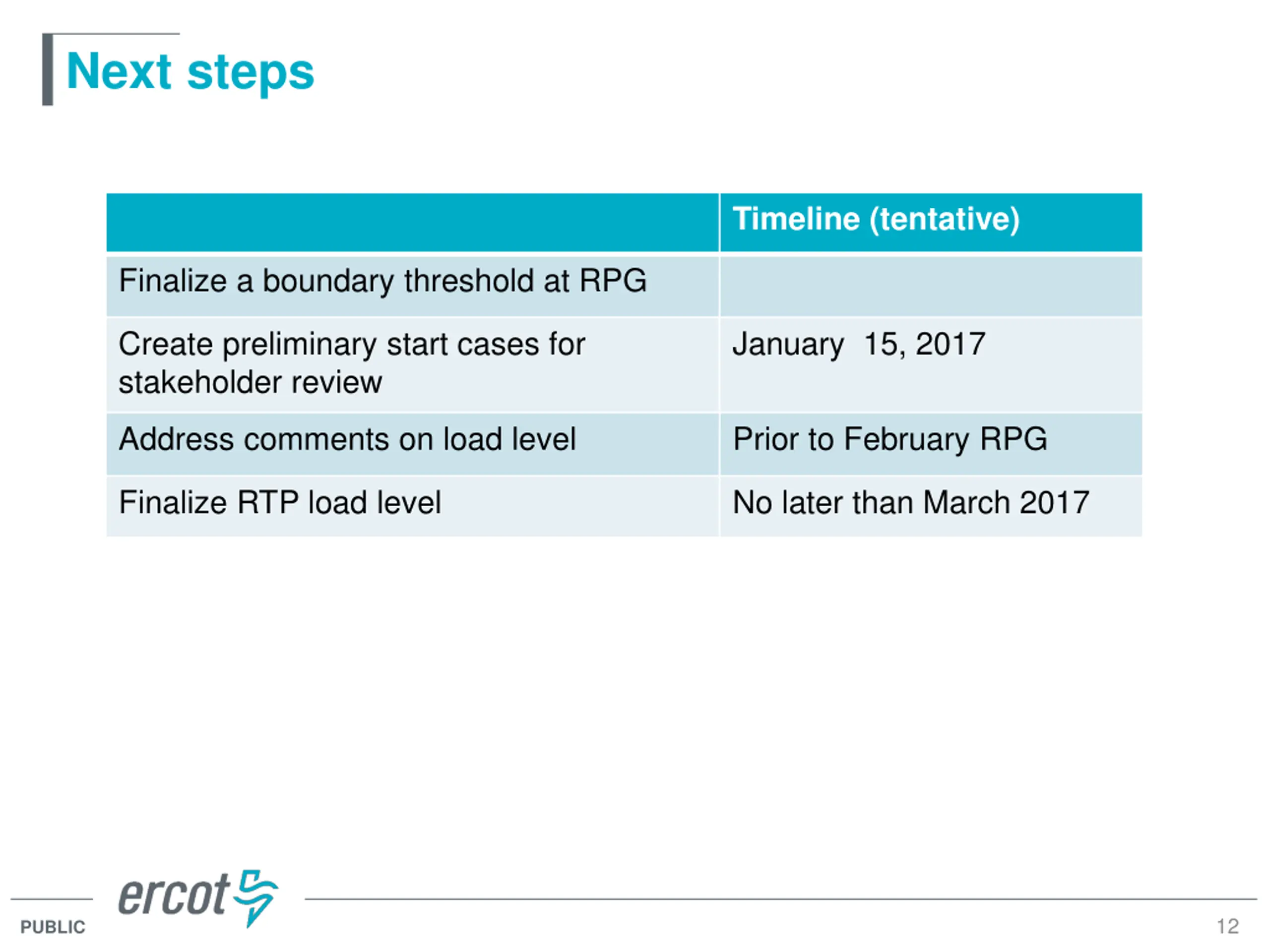

  12. Next steps Timeline (tentative) Finalize a boundary threshold at RPG Create preliminary start cases for stakeholder review January 15, 2017 Address comments on load level Prior to February RPG Finalize RTP load level No later than March 2017 12 PUBLIC

  13. Question 1 3 PUBLIC
