Status of QUBIC Sub-system for Technological Demonstrator and Final Instrument

Status of QUBIC Sub-system for Technological Demonstrator and Final Instrument
Slide Note
Embed
Share

This document provides updates on the design, manufacturing, assembly, and testing status of the sub-system for QUBIC's Technological Demonstrator and Final Instrument. It outlines key points such as blocking issues, schedule, interfaces with other systems, test procedures, delivery logistics, assembly operations, calibration processes, and documentation requirements for the collaboration meeting.

  • QUBIC
  • Sub-system
  • Collaboration
  • Meeting
  • Status

Uploaded on Apr 13, 2025 | 1 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. xxxxxx sub-system for QUBIC For Technological Demonstrator (T.D.) And For Final Instrument (F.I.) QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 1

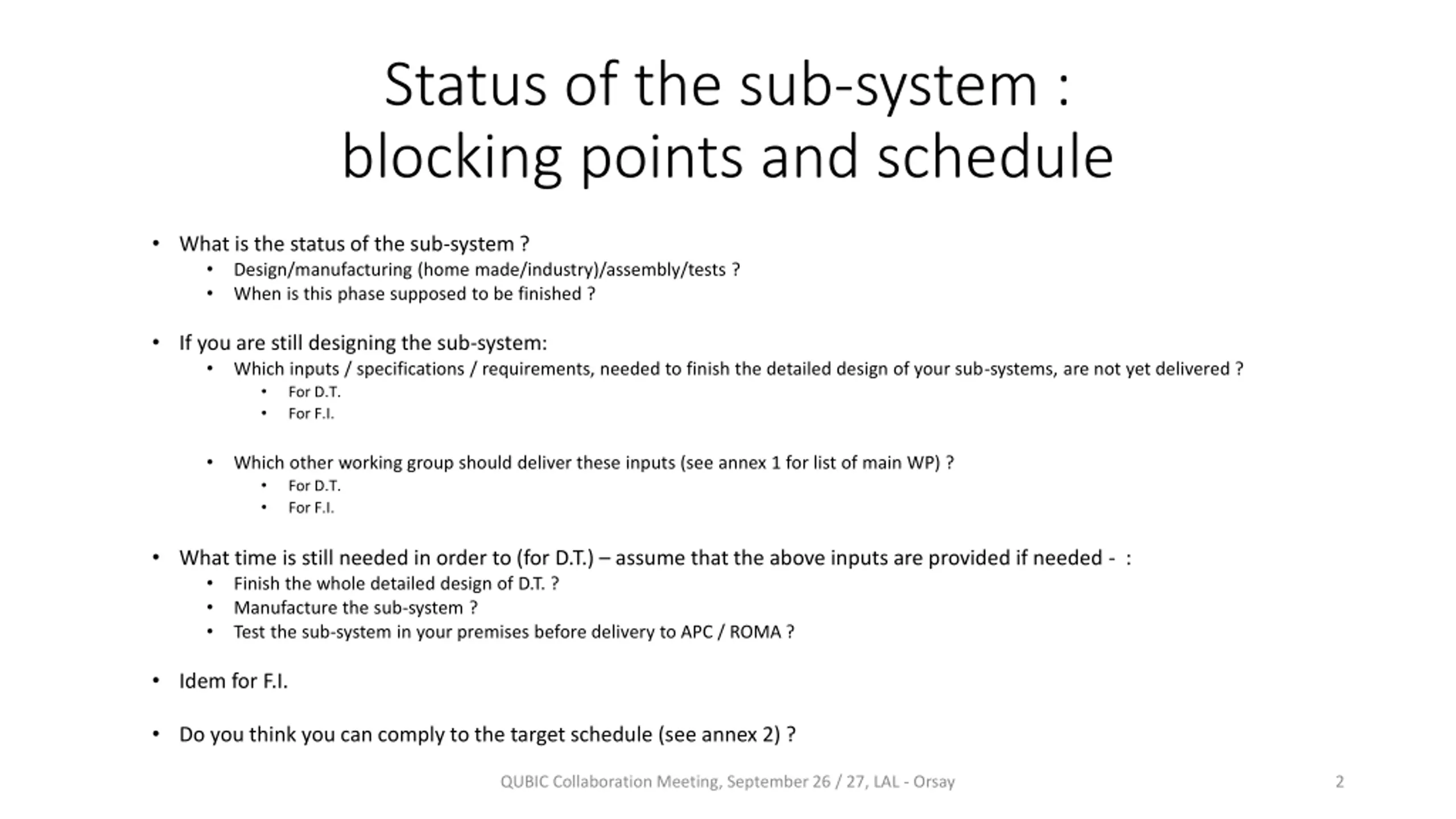

  2. Status of the sub-system : blocking points and schedule What is the status of the sub-system ? Design/manufacturing (home made/industry)/assembly/tests ? When is this phase supposed to be finished ? If you are still designing the sub-system: Which inputs / specifications / requirements, needed to finish the detailed design of your sub-systems, are not yet delivered ? For D.T. For F.I. Which other working group should deliver these inputs (see annex 1 for list of main WP) ? For D.T. For F.I. What time is still needed in order to (for D.T.) assume that the above inputs are provided if needed - : Finish the whole detailed design of D.T. ? Manufacture the sub-system ? Test the sub-system in your premises before delivery to APC / ROMA ? Idem for F.I. Do you think you can comply to the target schedule (see annex 2) ? QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 2

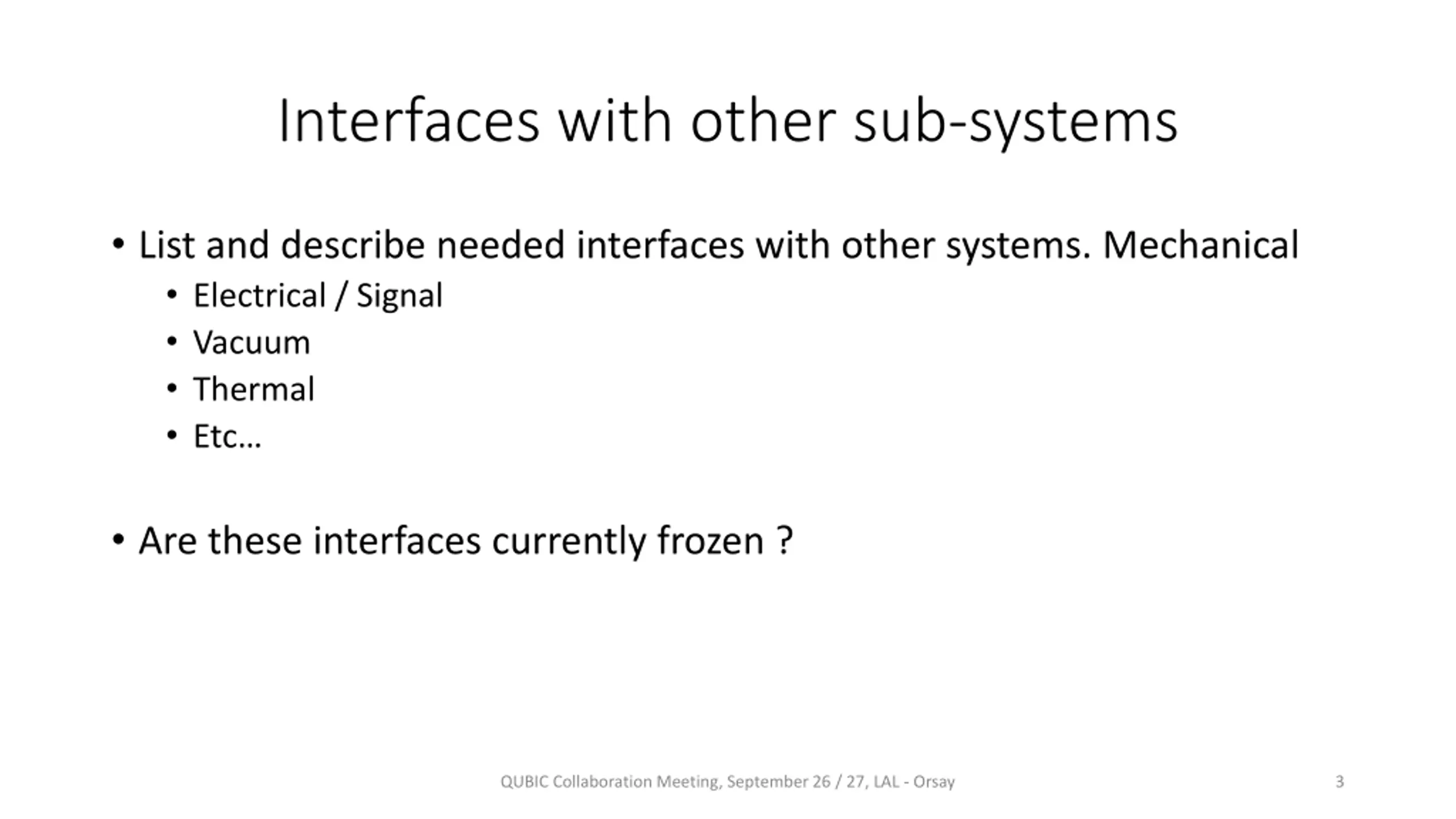

  3. Interfaces with other sub-systems List and describe needed interfaces with other systems. Mechanical Electrical / Signal Vacuum Thermal Etc Are these interfaces currently frozen ? QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 3

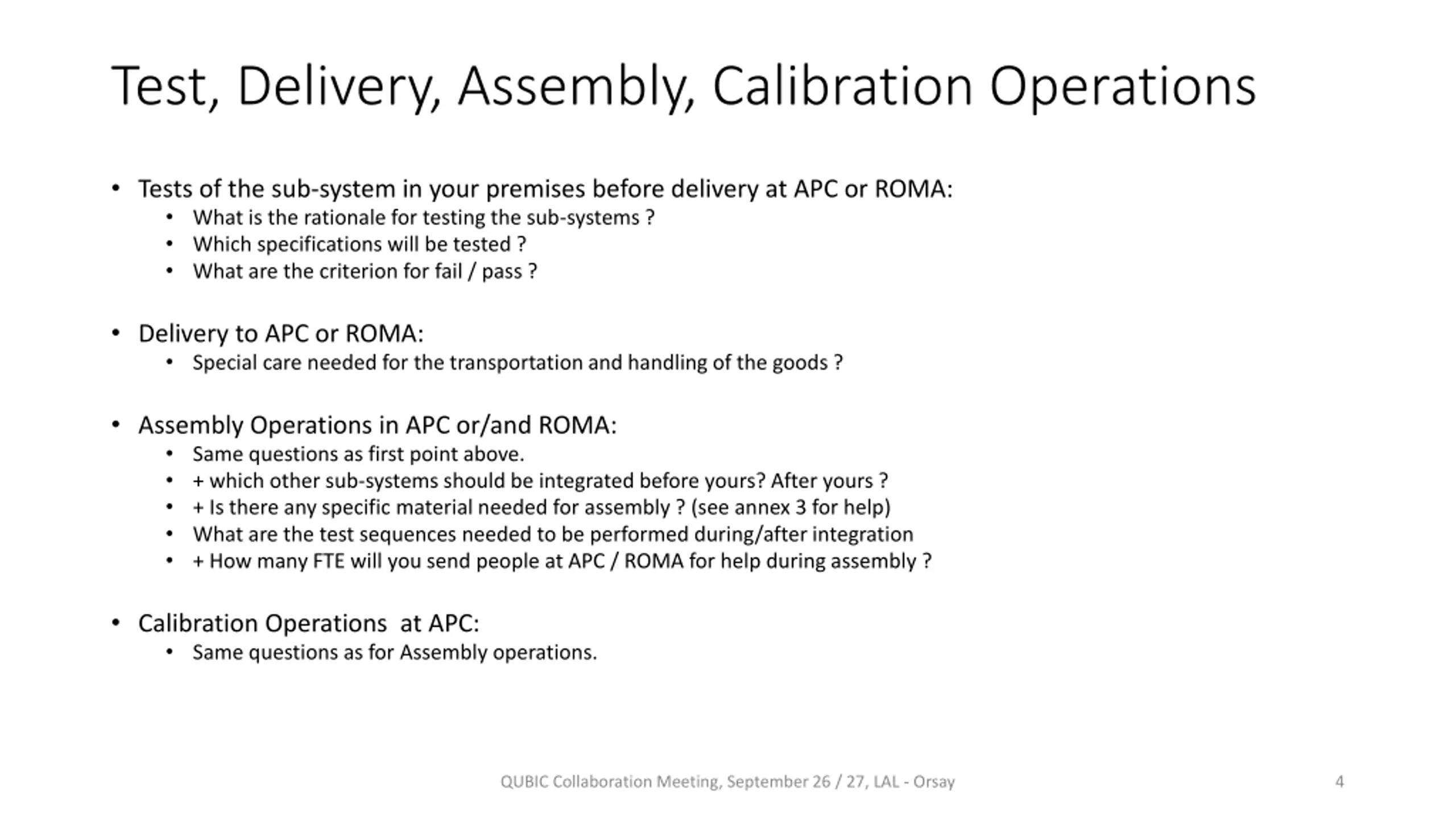

  4. Test, Delivery, Assembly, Calibration Operations Tests of the sub-system in your premises before delivery at APC or ROMA: What is the rationale for testing the sub-systems ? Which specifications will be tested ? What are the criterion for fail / pass ? Delivery to APC or ROMA: Special care needed for the transportation and handling of the goods ? Assembly Operations in APC or/and ROMA: Same questions as first point above. + which other sub-systems should be integrated before yours? After yours ? + Is there any specific material needed for assembly ? (see annex 3 for help) What are the test sequences needed to be performed during/after integration + How many FTE will you send people at APC / ROMA for help during assembly ? Calibration Operations at APC: Same questions as for Assembly operations. QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 4

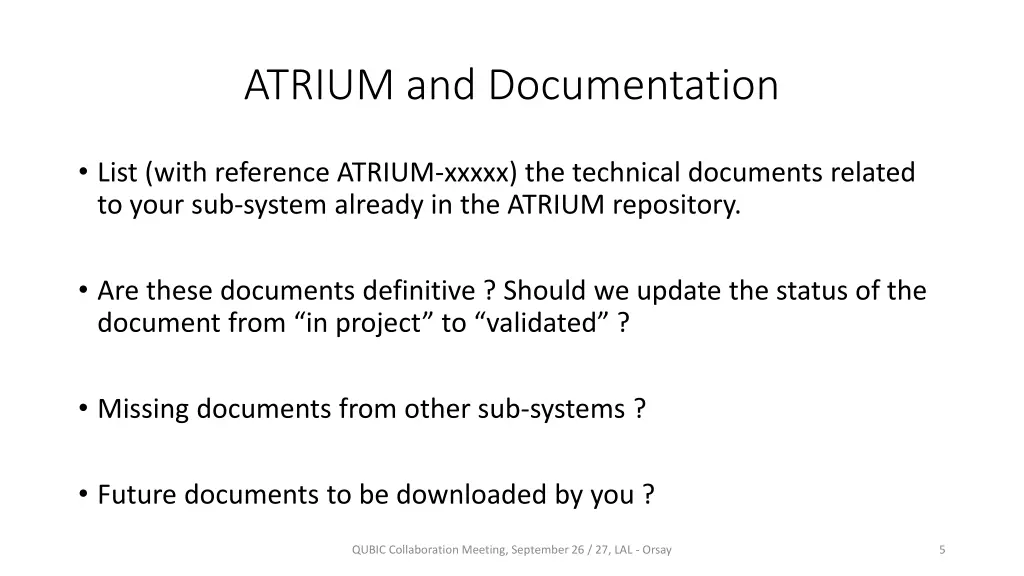

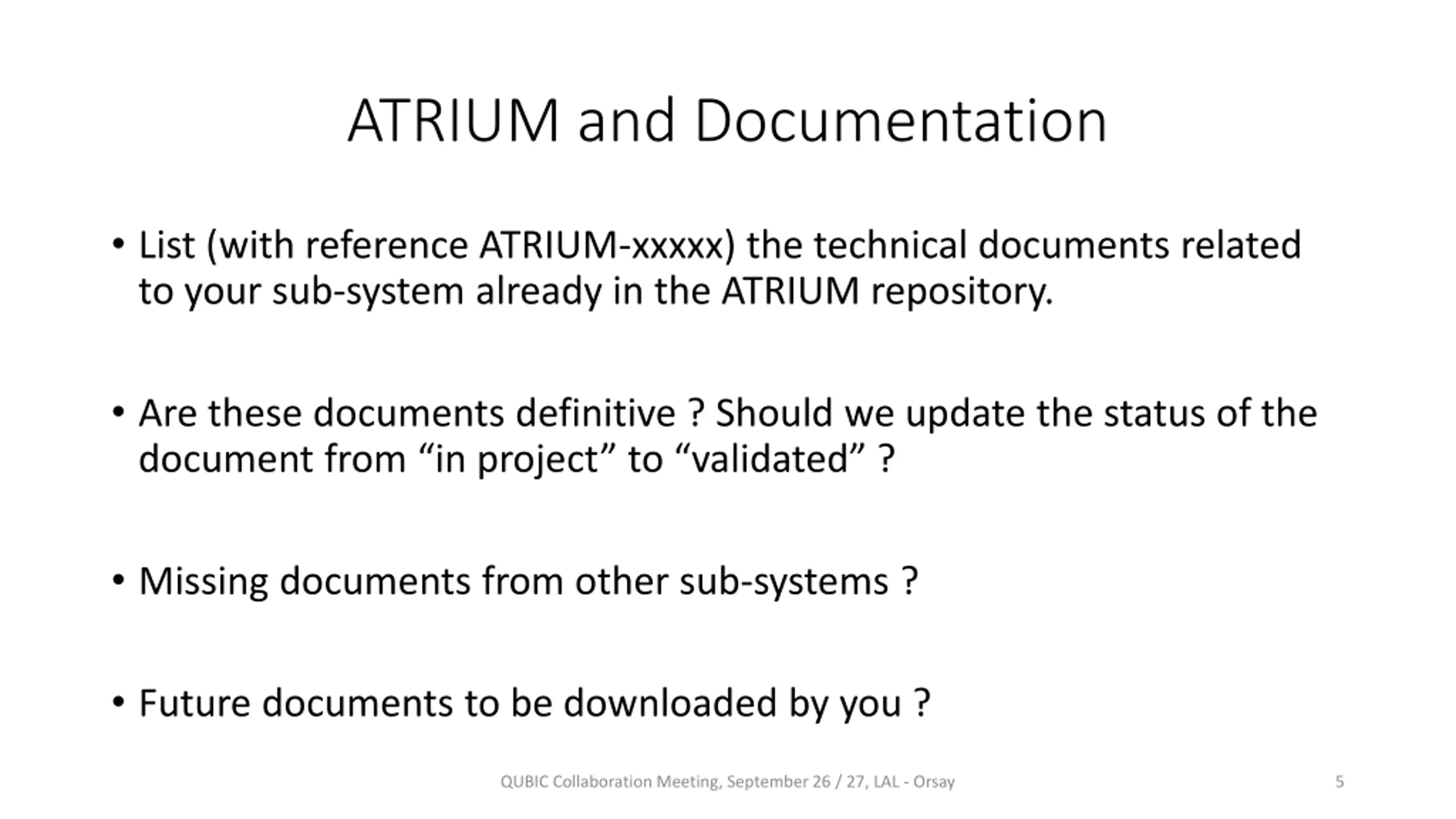

  5. ATRIUM and Documentation List (with reference ATRIUM-xxxxx) the technical documents related to your sub-system already in the ATRIUM repository. Are these documents definitive ? Should we update the status of the document from in project to validated ? Missing documents from other sub-systems ? Future documents to be downloaded by you ? QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 5

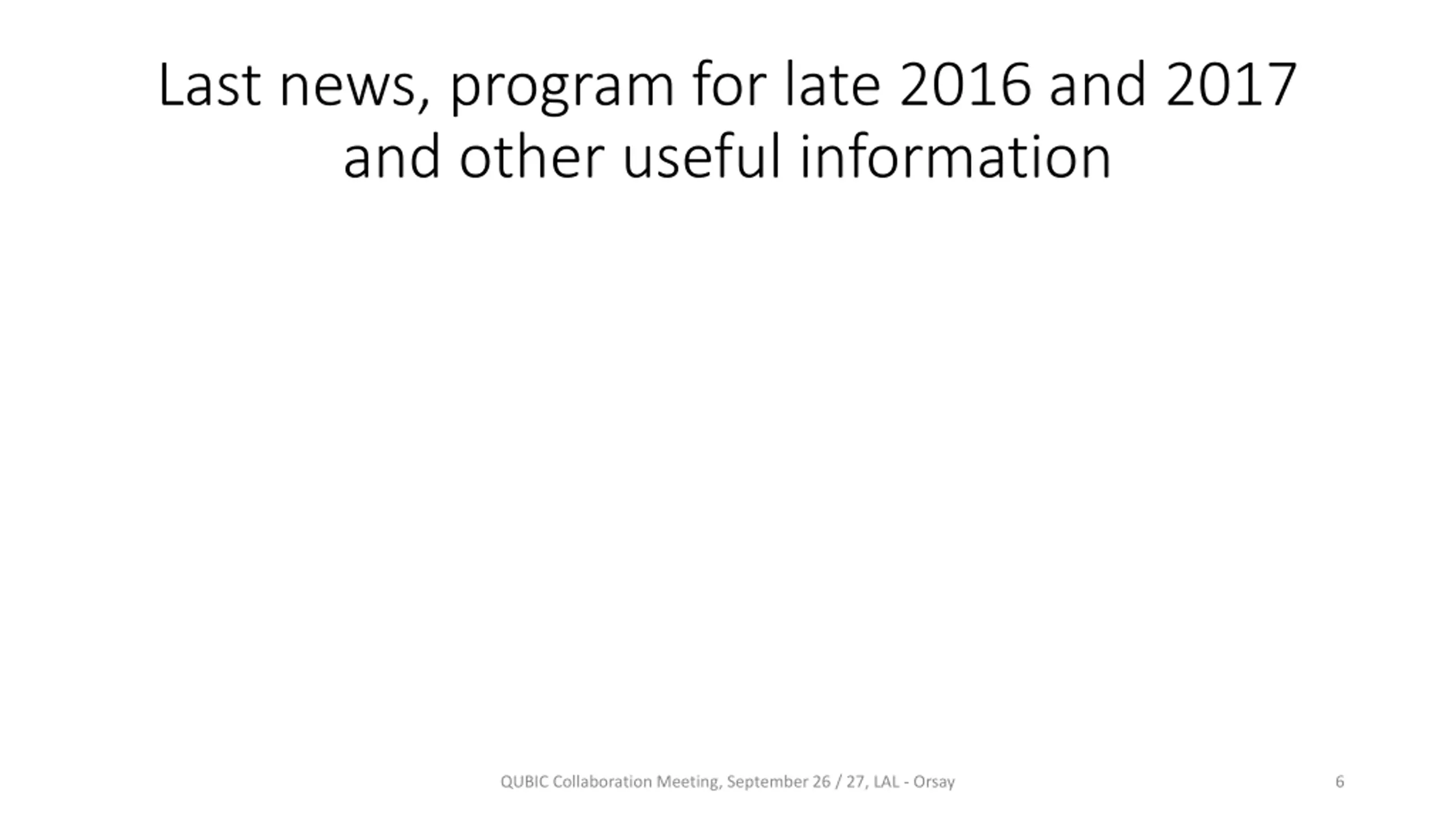

  6. Last news, program for late 2016 and 2017 and other useful information QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 6

  7. Budget (excluding salaries)for T.D. + F.I. Spendings (type and amount) Funding (source and amount) Status of funding (granted / under examination) 2016 2017 2018 QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 7

  8. Manpower Name and responsibility % FTE 2016 % FTE 2017 % FTE 2018 TOTAL FTE QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 8

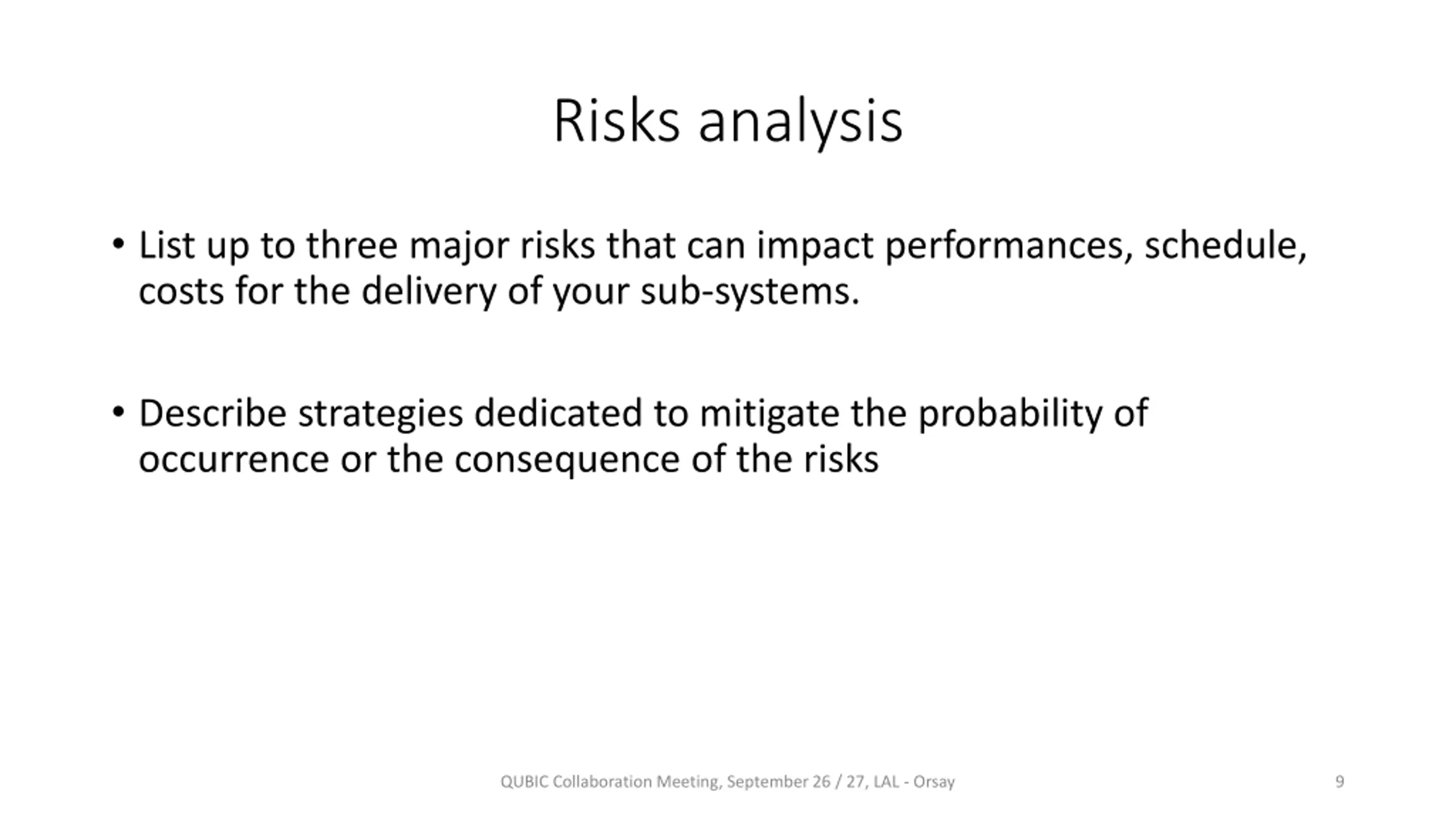

  9. Risks analysis List up to three major risks that can impact performances, schedule, costs for the delivery of your sub-systems. Describe strategies dedicated to mitigate the probability of occurrence or the consequence of the risks QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 9

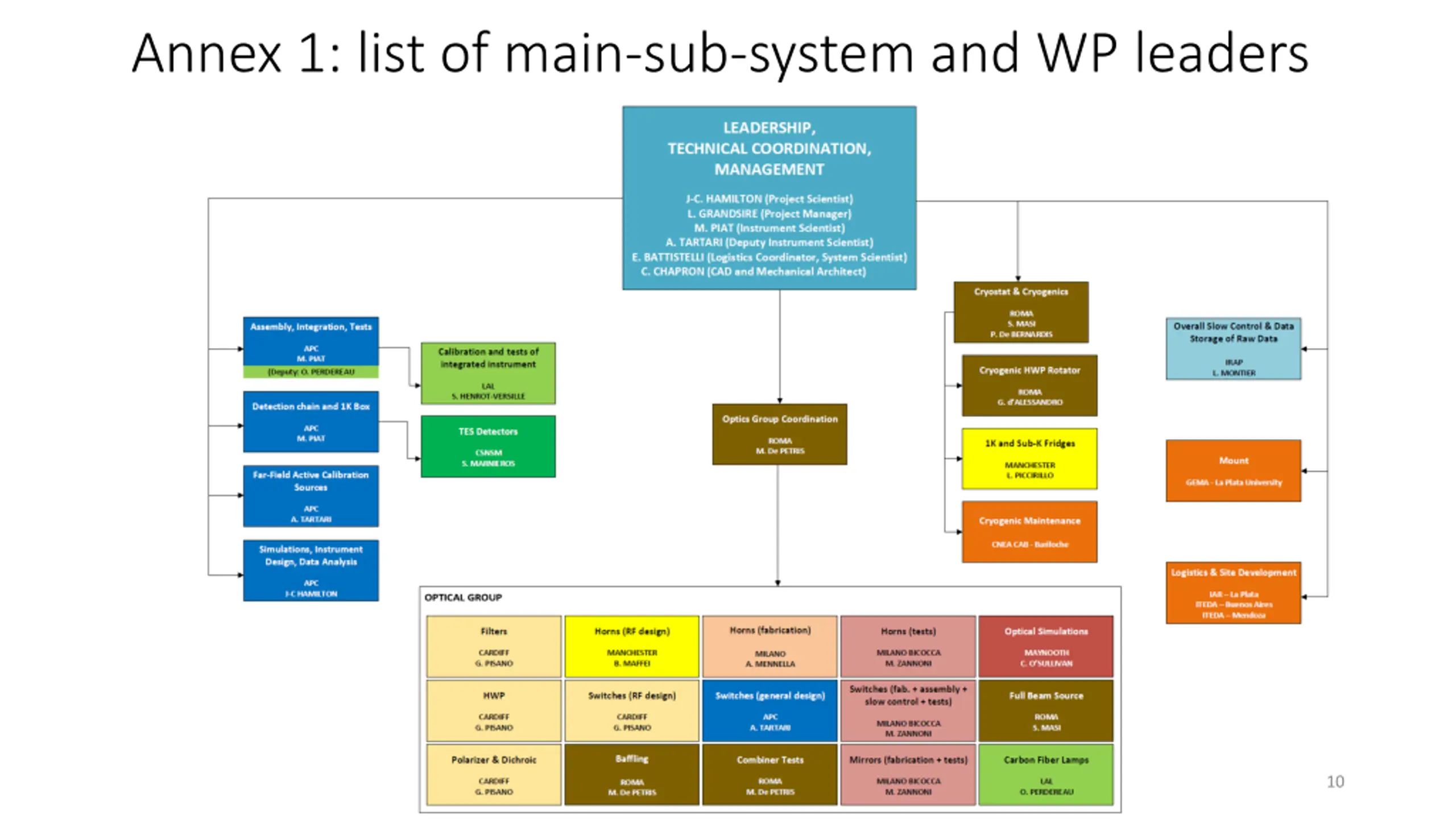

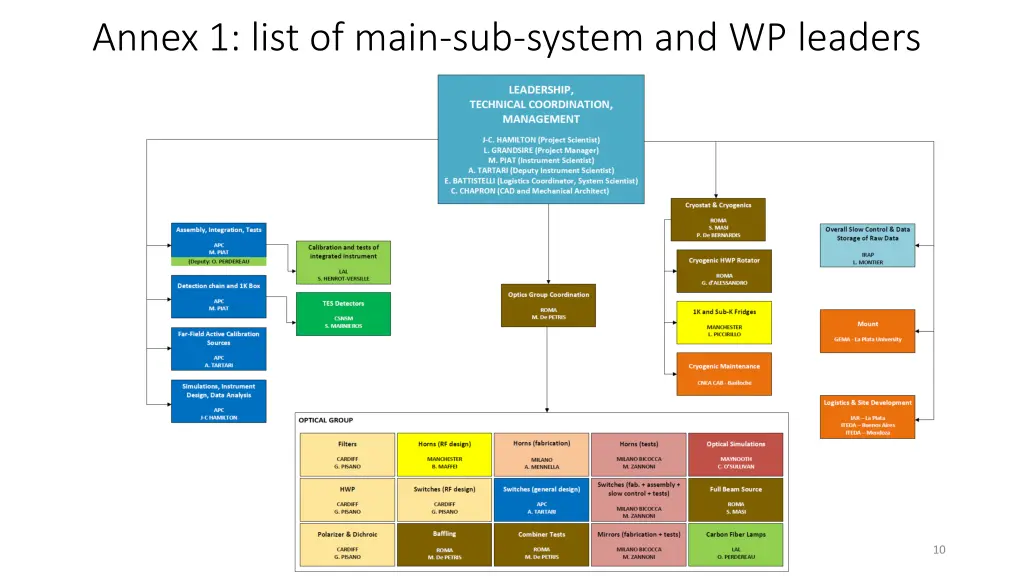

  10. Annex 1: list of main-sub-system and WP leaders 10

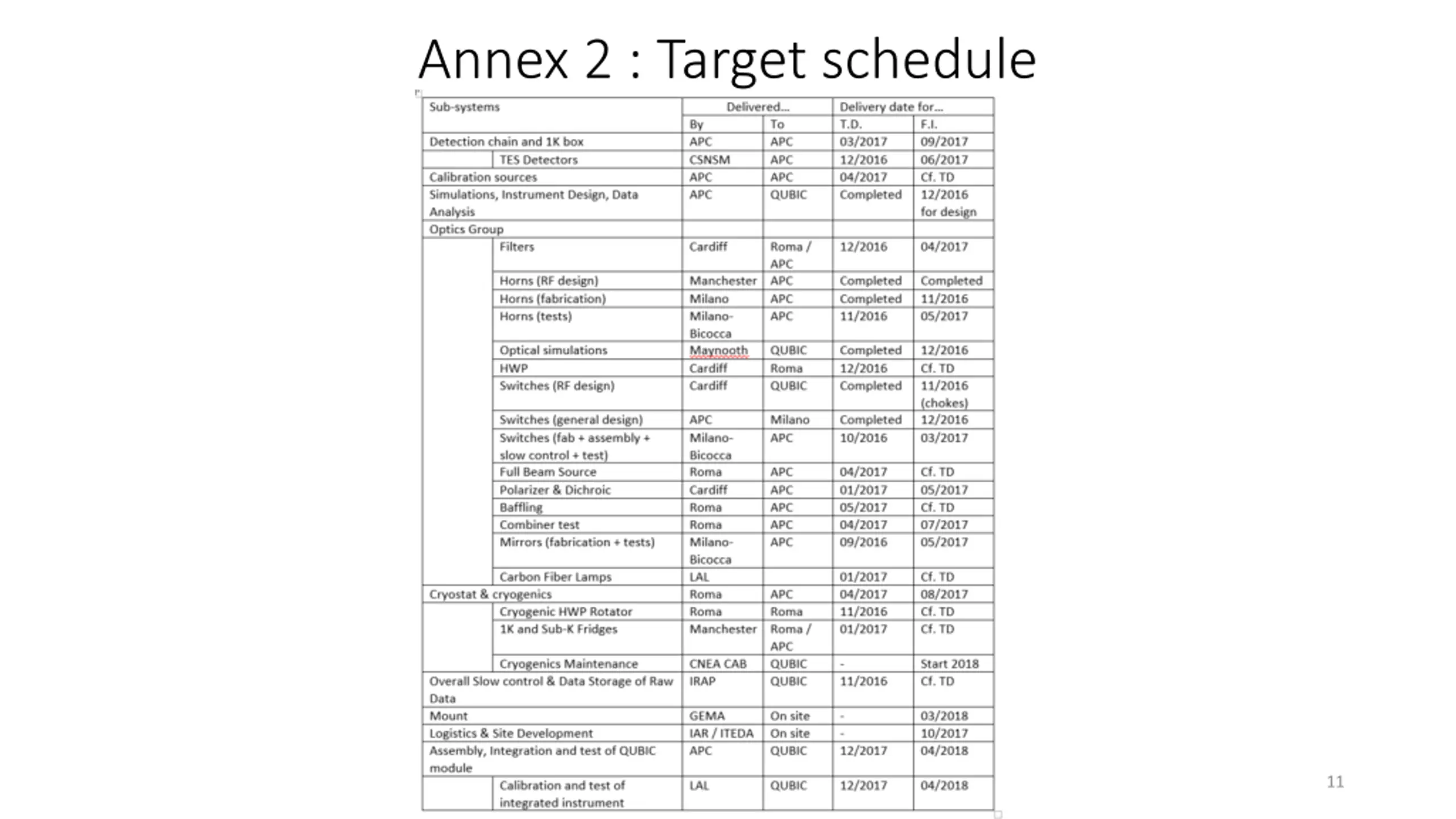

  11. Annex 2 : Target schedule 11

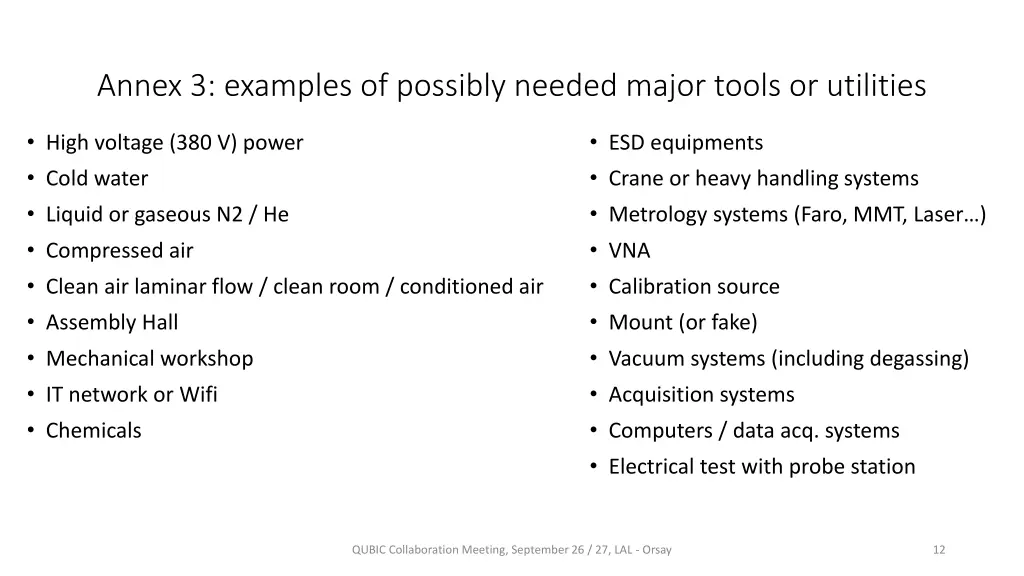

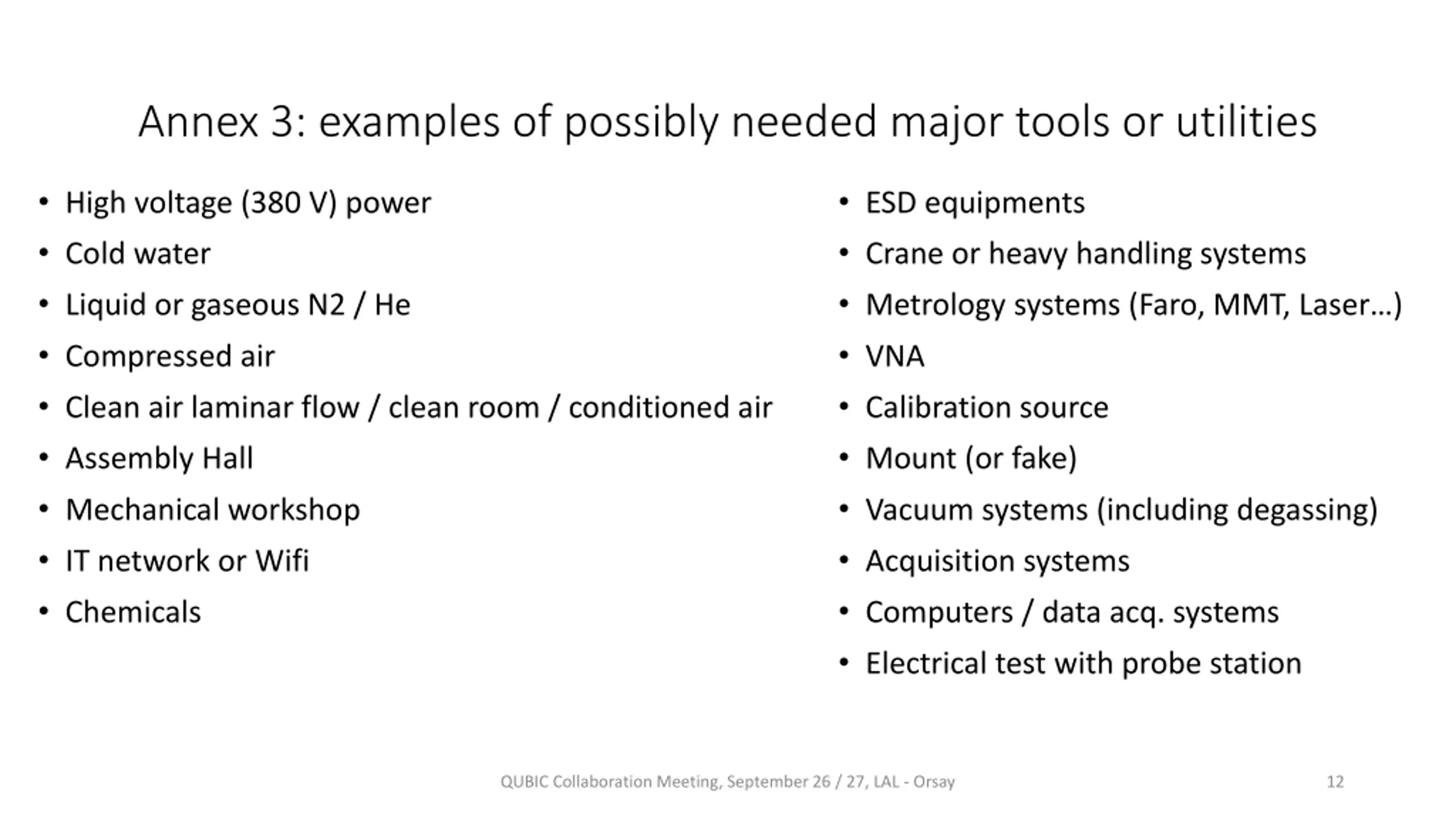

  12. Annex 3: examples of possibly needed major tools or utilities High voltage (380 V) power Cold water Liquid or gaseous N2 / He Compressed air Clean air laminar flow / clean room / conditioned air Assembly Hall Mechanical workshop IT network or Wifi Chemicals ESD equipments Crane or heavy handling systems Metrology systems (Faro, MMT, Laser ) VNA Calibration source Mount (or fake) Vacuum systems (including degassing) Acquisition systems Computers / data acq. systems Electrical test with probe station QUBIC Collaboration Meeting, September 26 / 27, LAL - Orsay 12
